The Gorgeous Mansion
-
06
2024
-

2024/06 FS version decompression well buried -

2024/06 Finally dug out the soil
-
-
07
2024
-

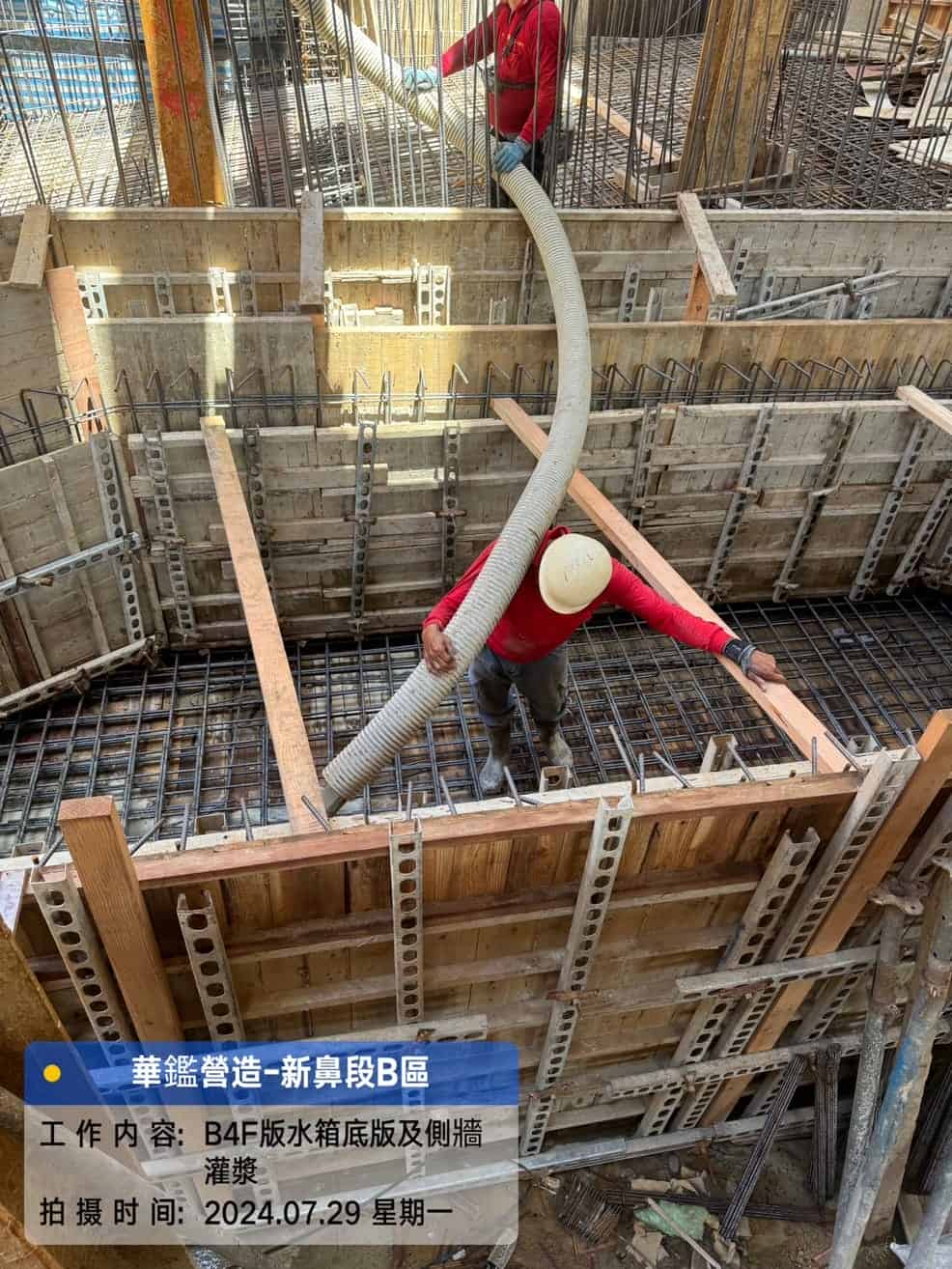

2024/07 B4F version water tank bottom plate and side wall grouting
-
-
08
2024
-

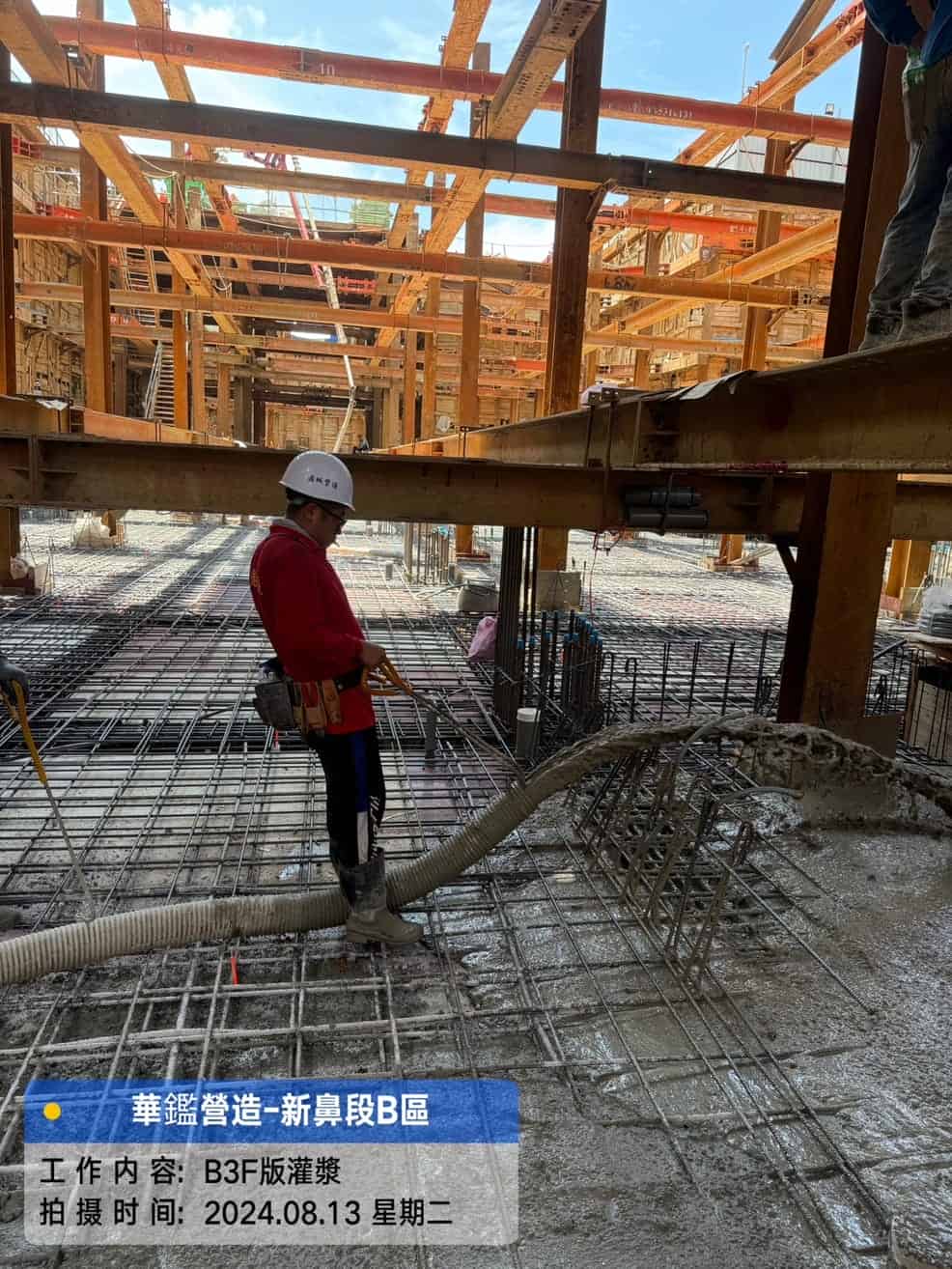

2024/08 B3F bottom plate grouting
-
-
09
2024
-

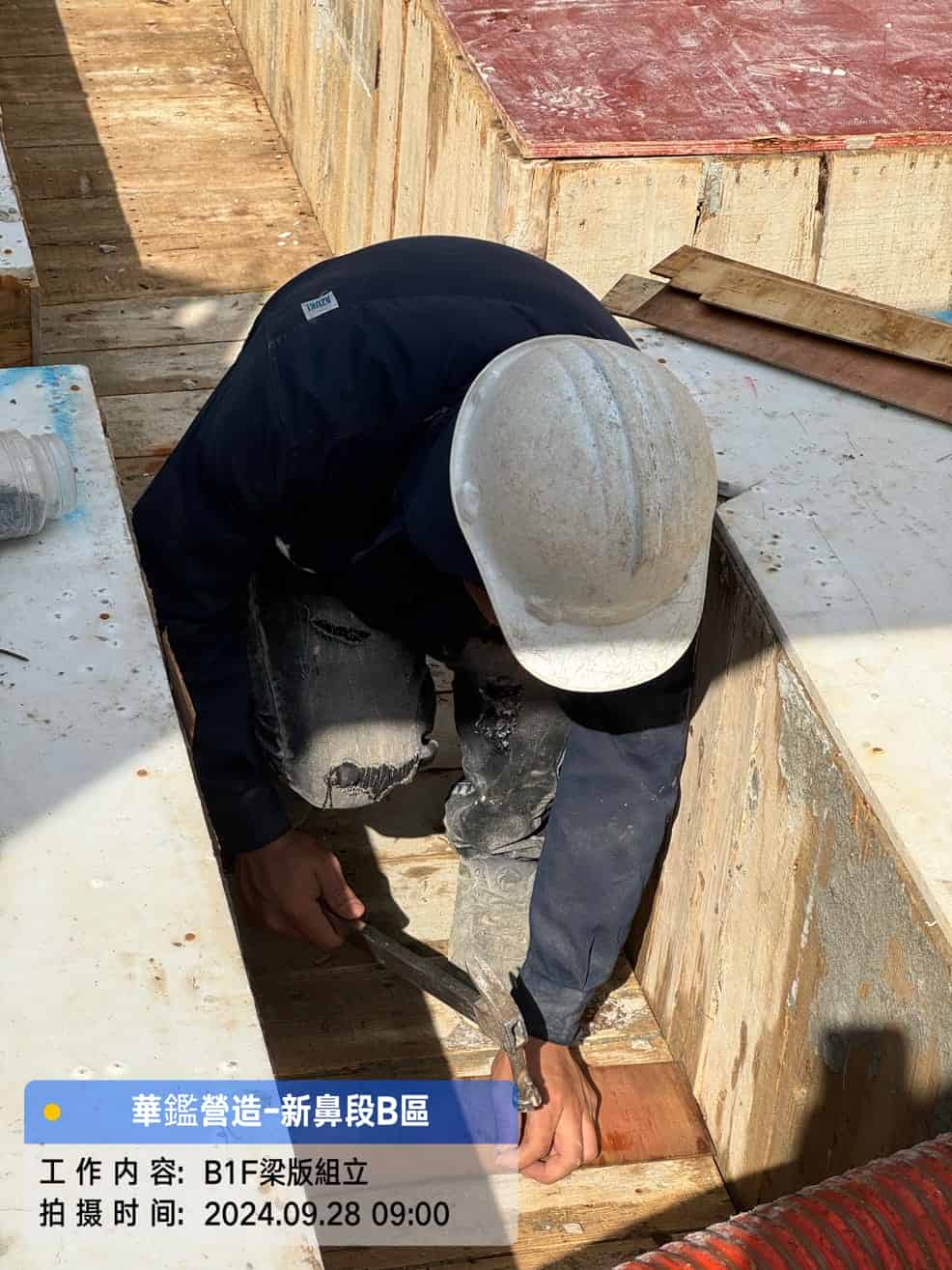

2024/09 B1F beam version assembly -

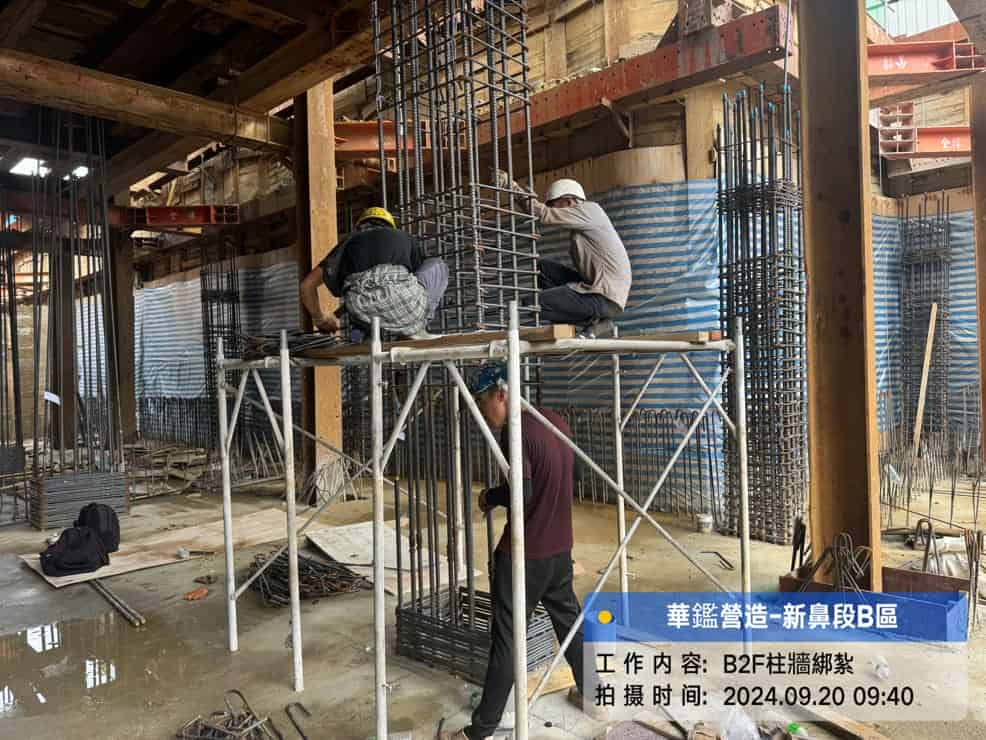

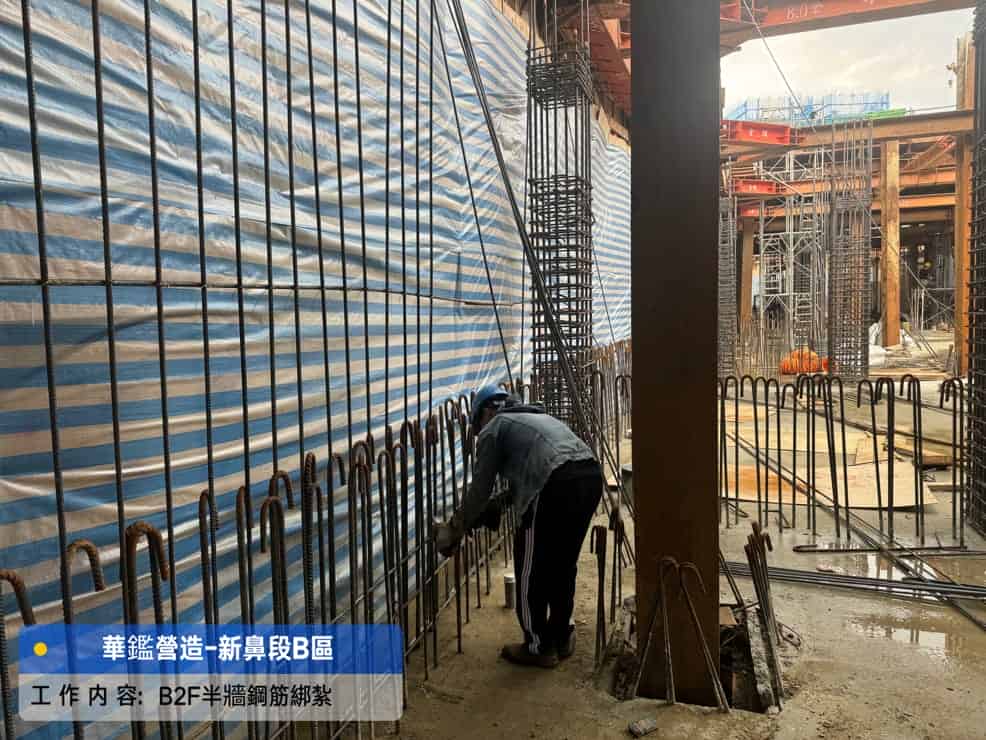

2024/09 B2F column wall lashing -
2024/09 B2F column wall lashing -

2024/09 B2F version elevation device implementation
-
-
10
2024
-

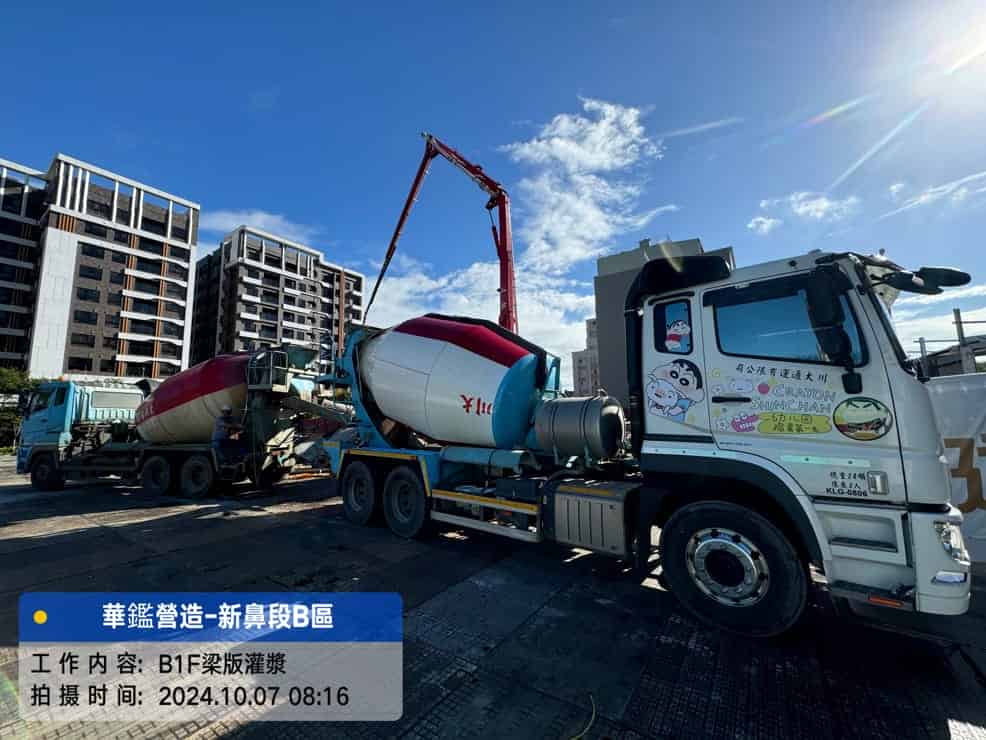

2024/10 B1F beam version grouting -

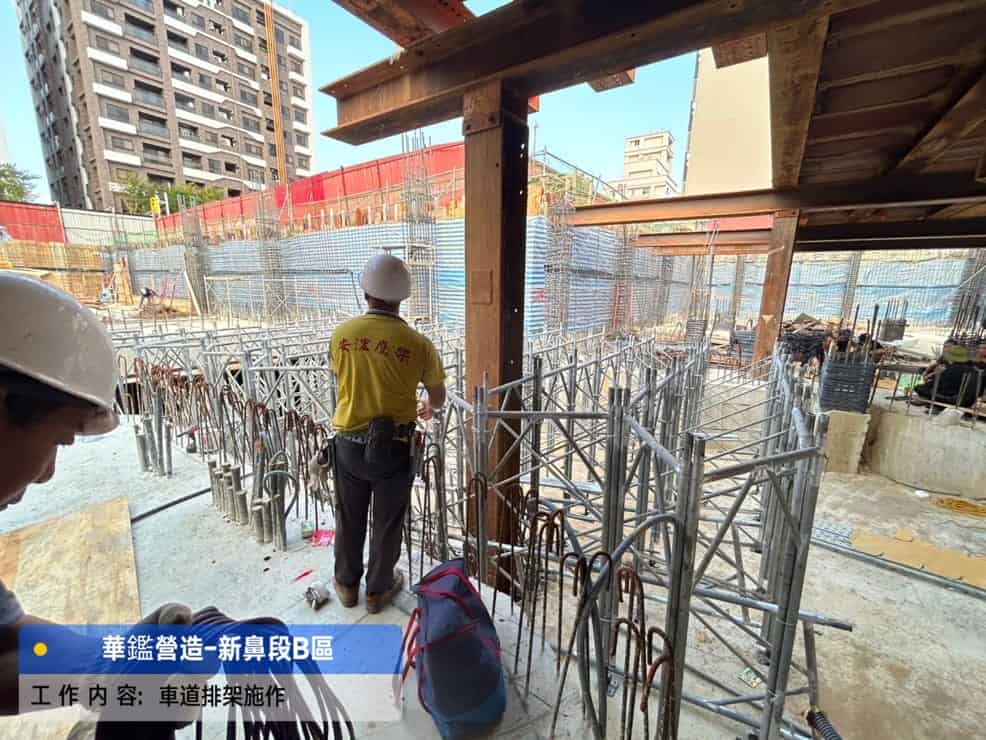

2024/10 B1F lane rack construction
-
-
01
2025
-

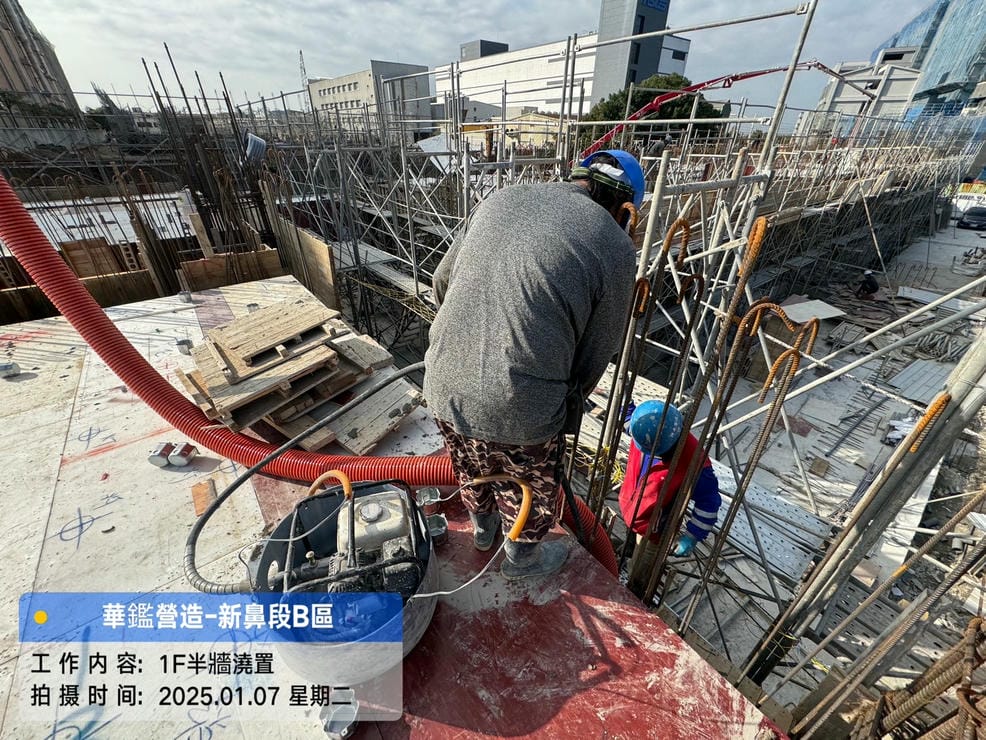

2025/01 1F half wall pouring -

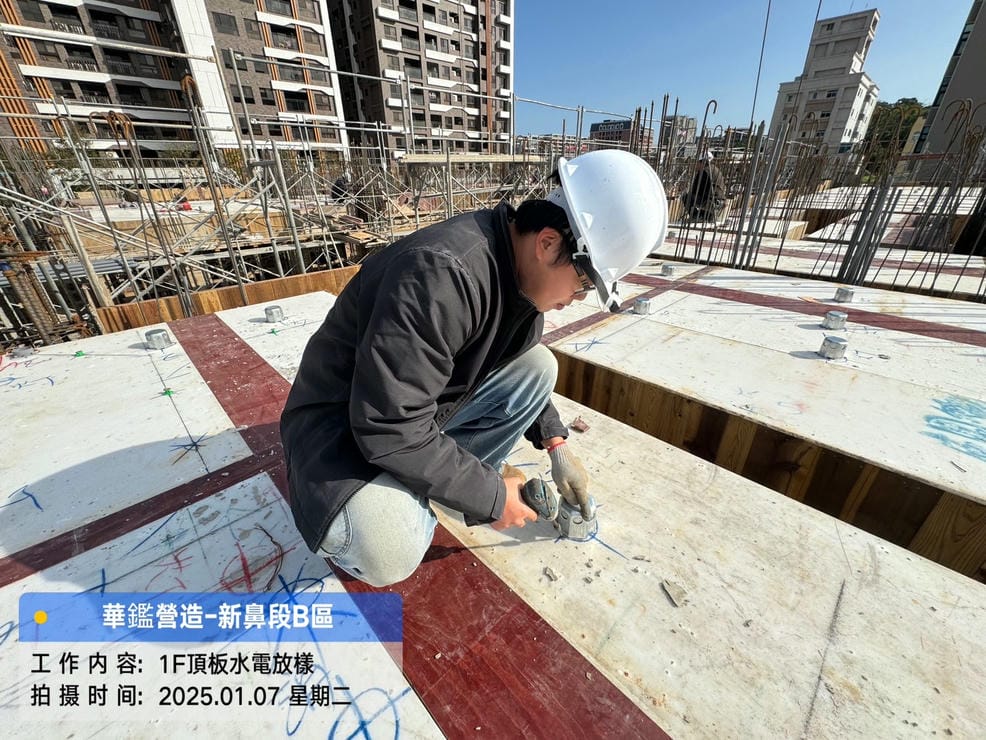

2025/01 1F top water and electricity stakeout -

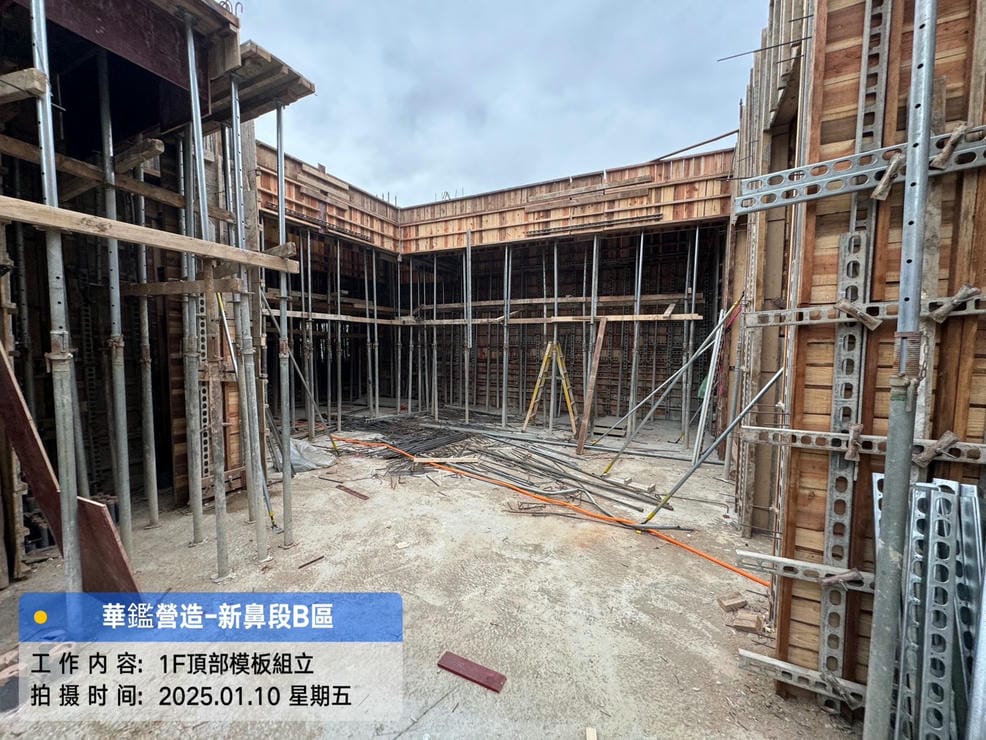

2025/01 1F top template assembly -

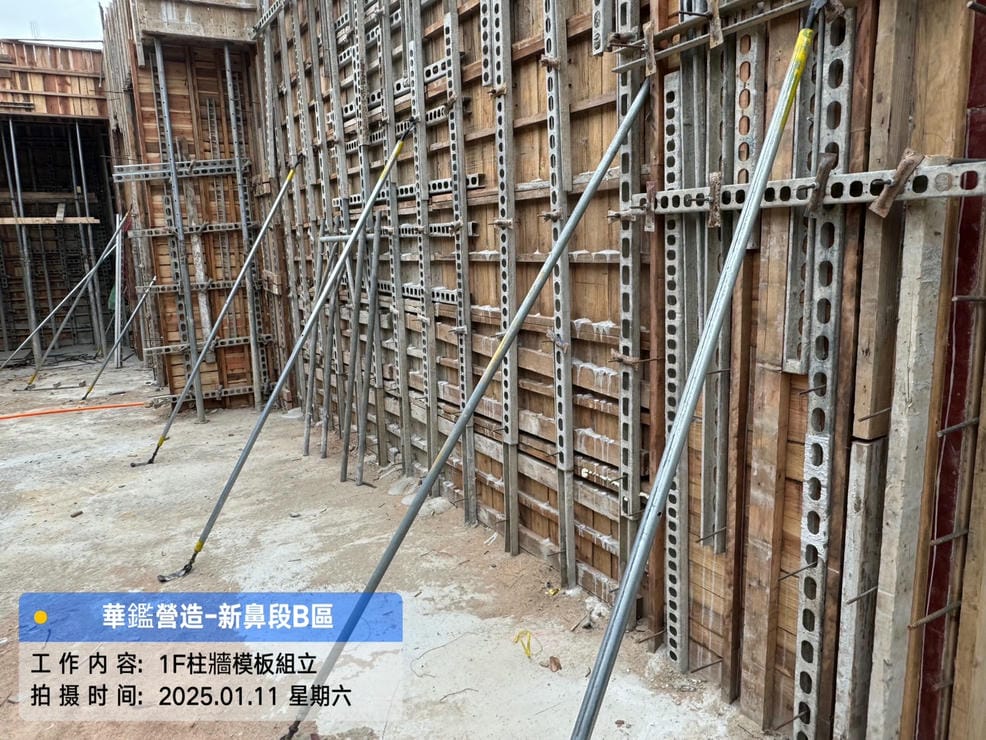

2025/01 1F residential wall formwork assembly -

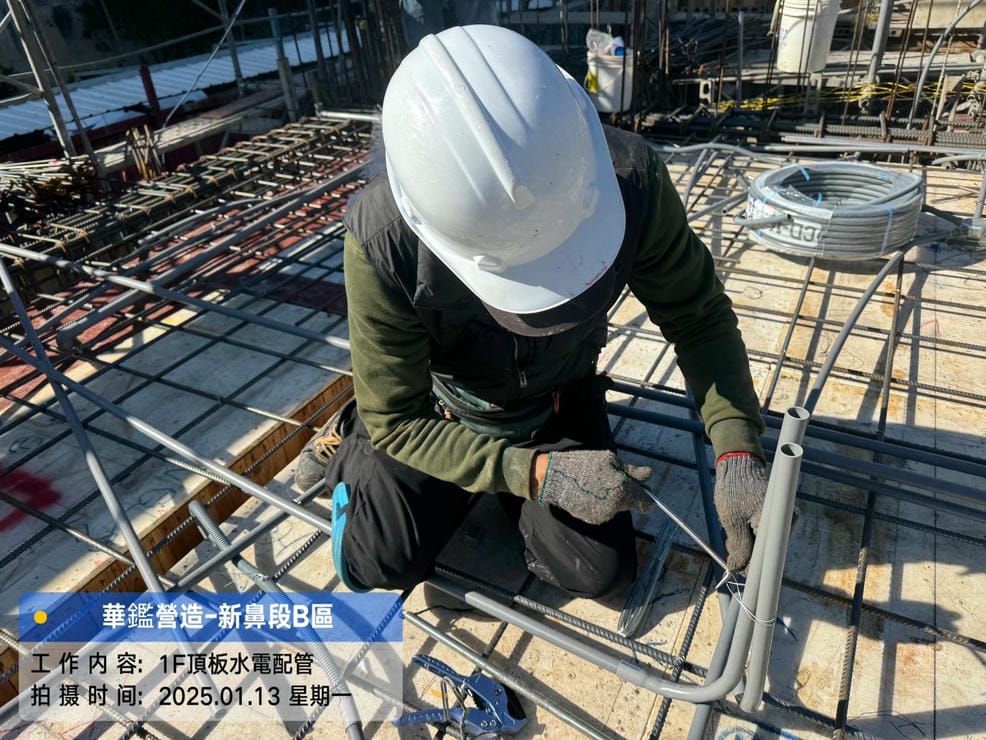

2025/01 1F roof water and electricity piping -

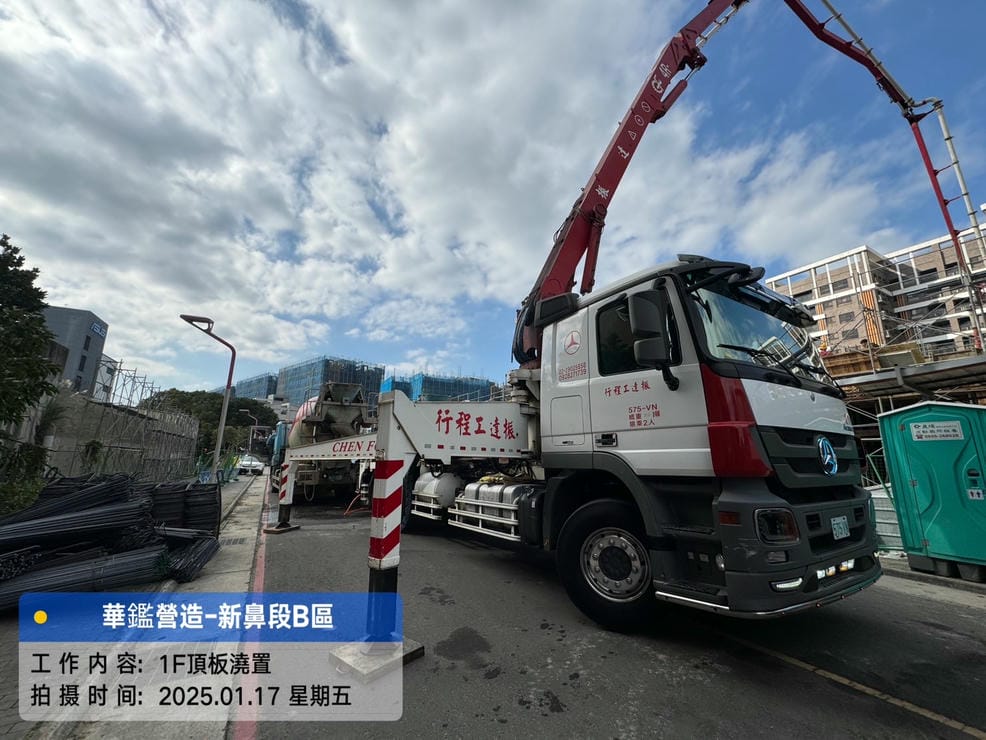

2025/01 1F roof pouring -

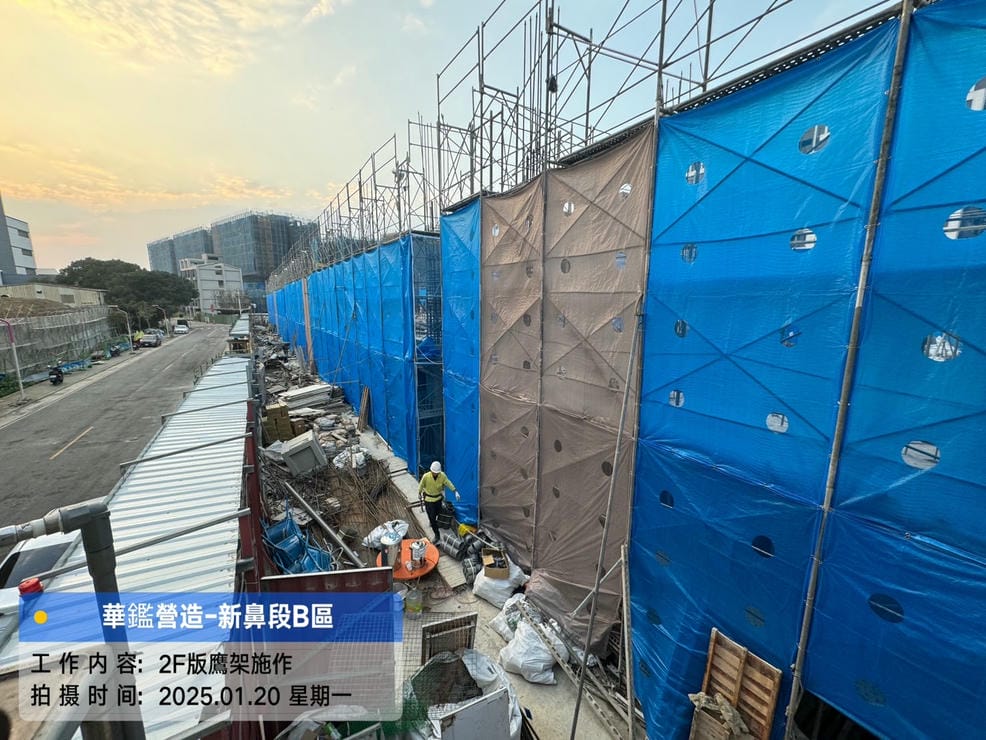

2025/01 2F version of scaffolding installation
-
-
02
2025
-

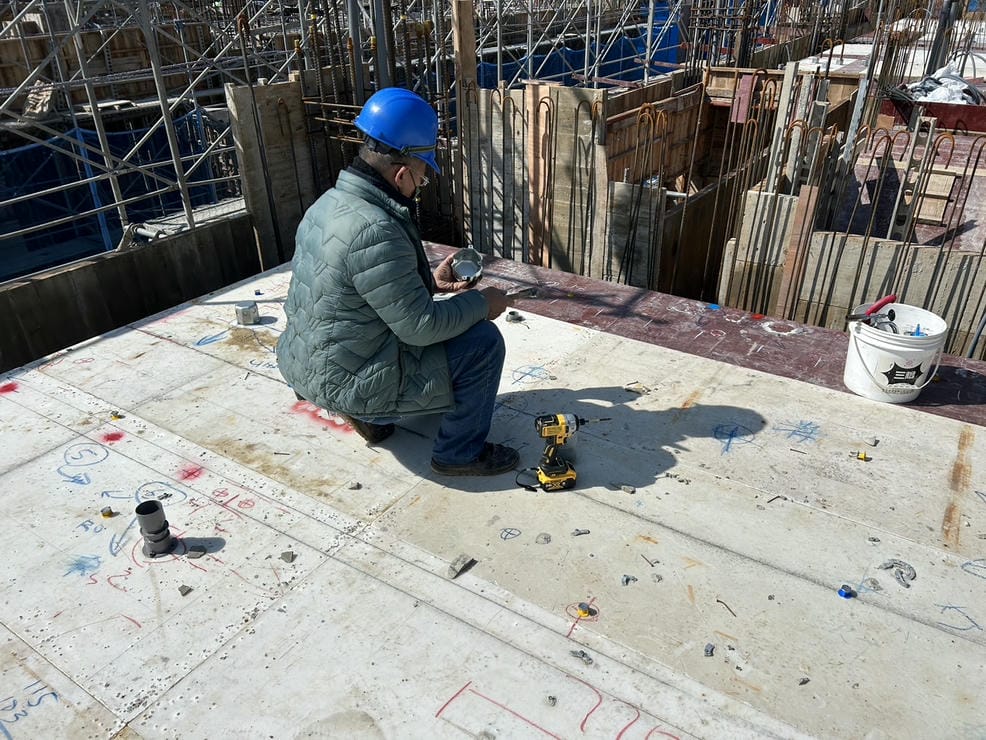

2025/02 2 Floor roof water and electricity stakeout -

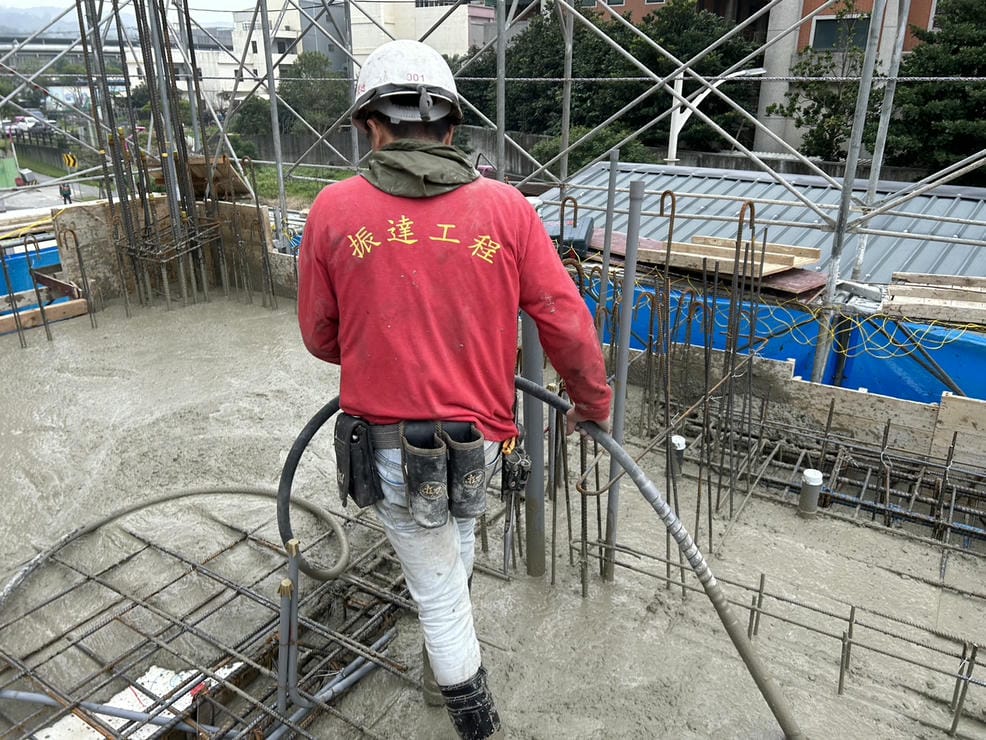

2025/02 3FL grouting -

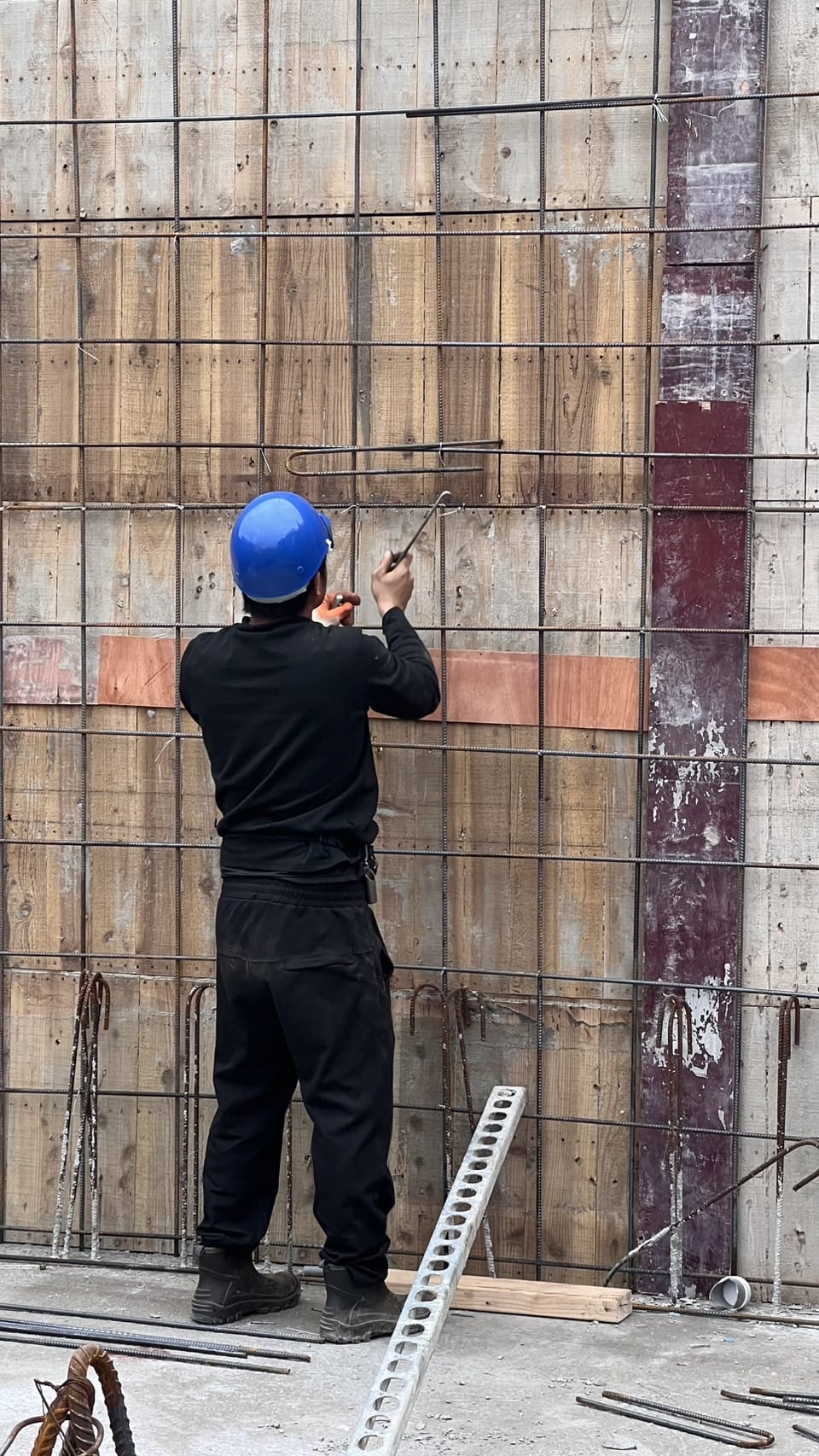

2025/02 3rd floor wall reinforcement binding -

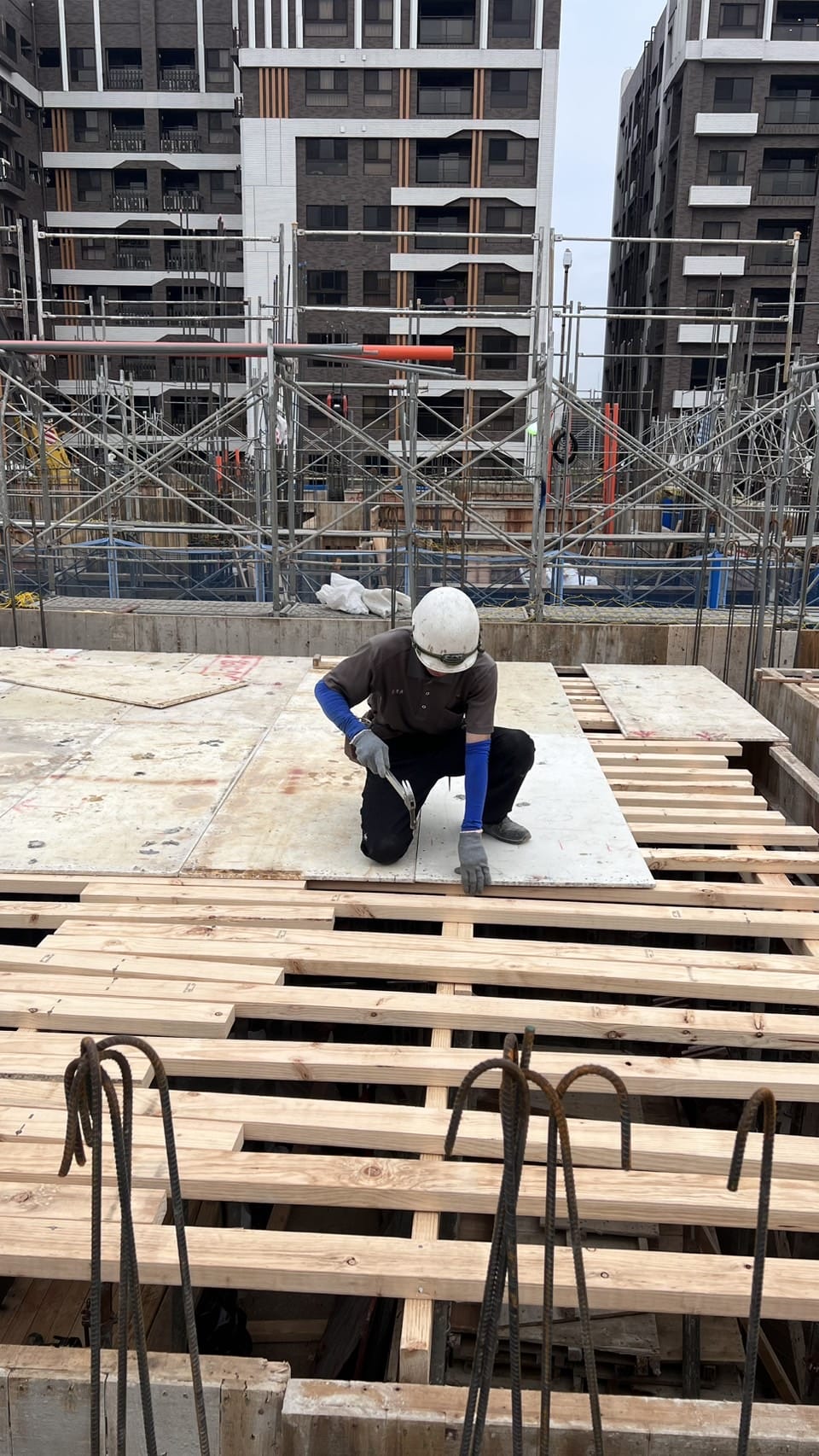

2025/02 3 Floor roof slab construction -

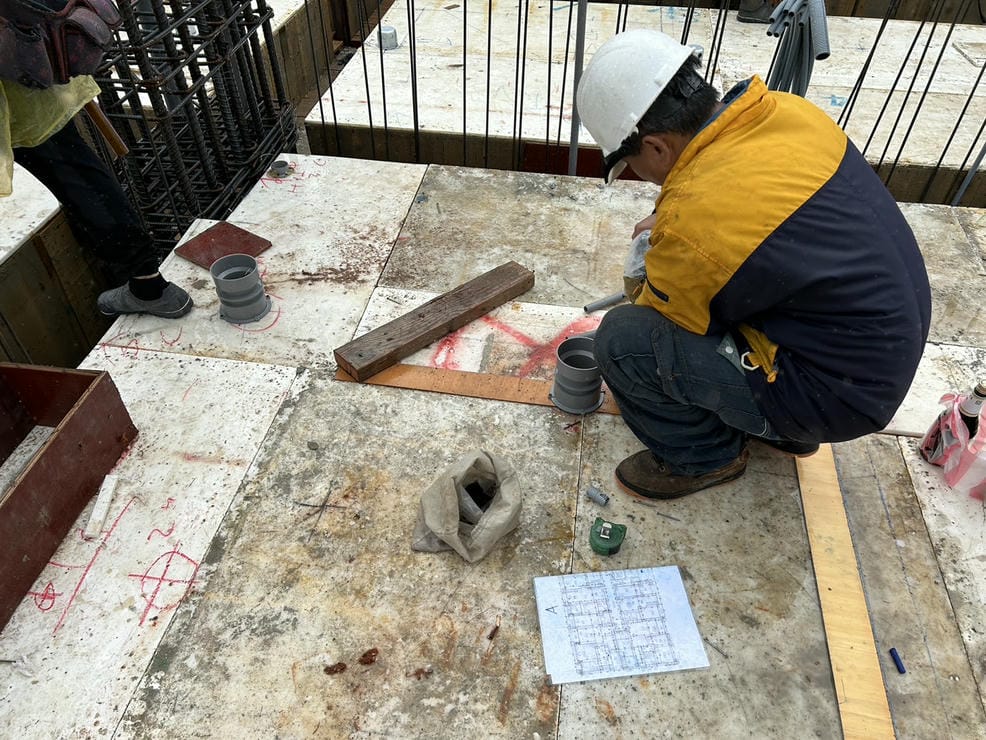

2025/02 3 Floor roof water and electricity stakeout -

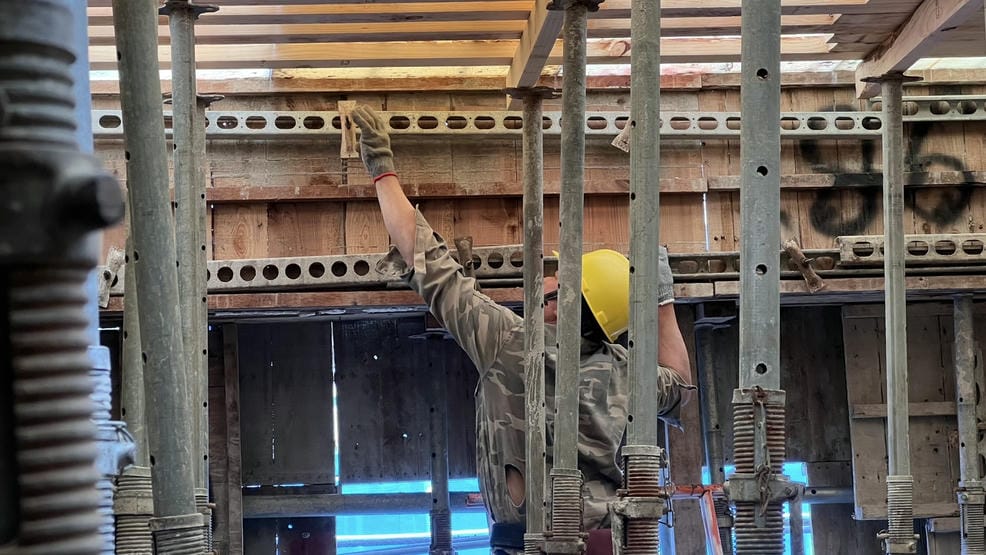

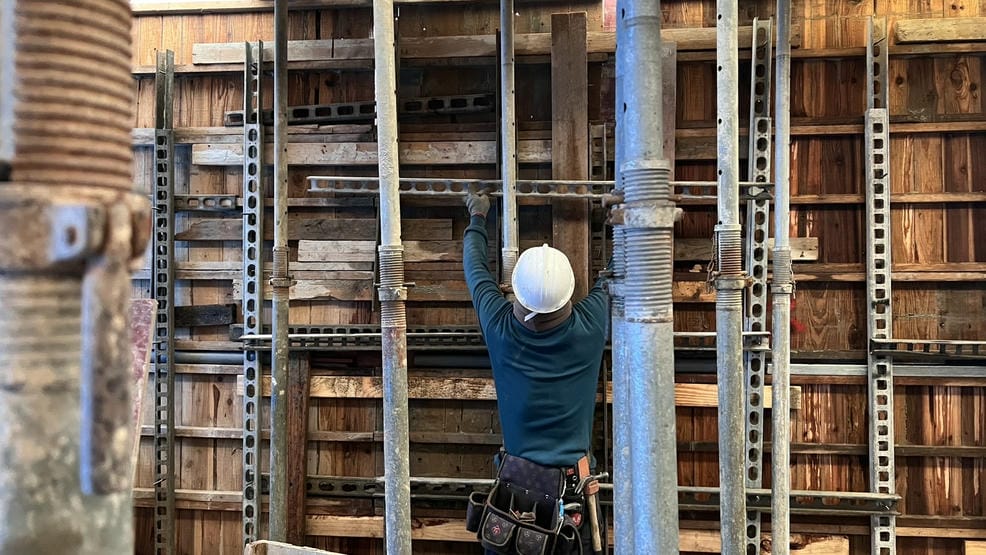

2025/02 3rd floor sealing double-sided mold -
2025/02 3rd floor sealing double-sided mold -

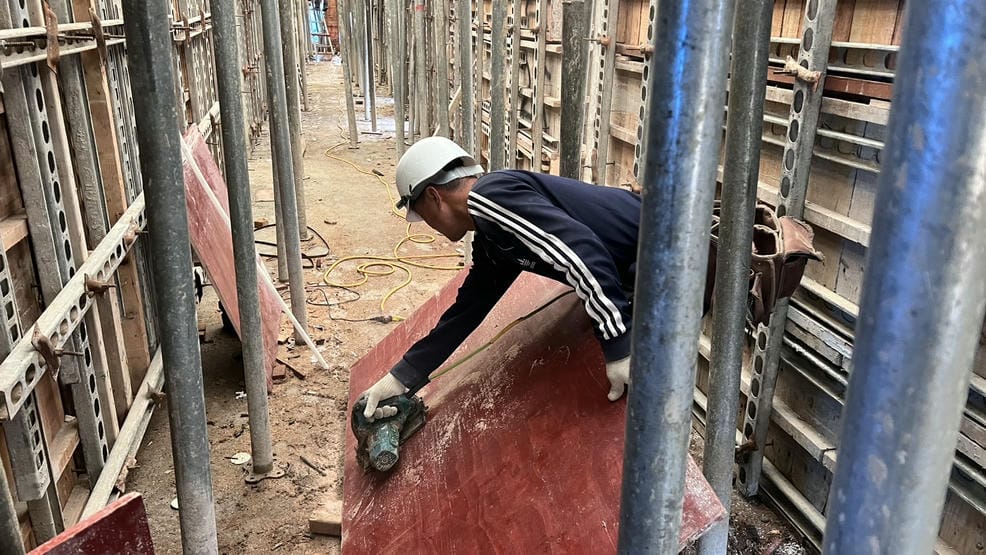

2025/02 3 Floor beam and slab assembly
-
-
03
2025
-

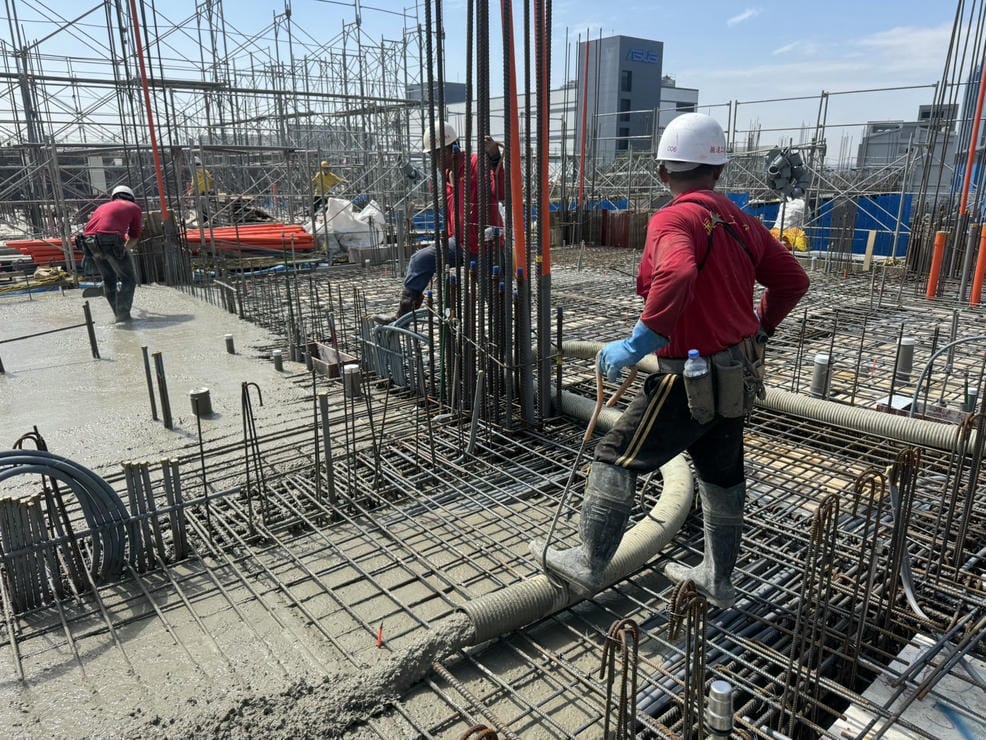

2025/03 4th floor grouting -

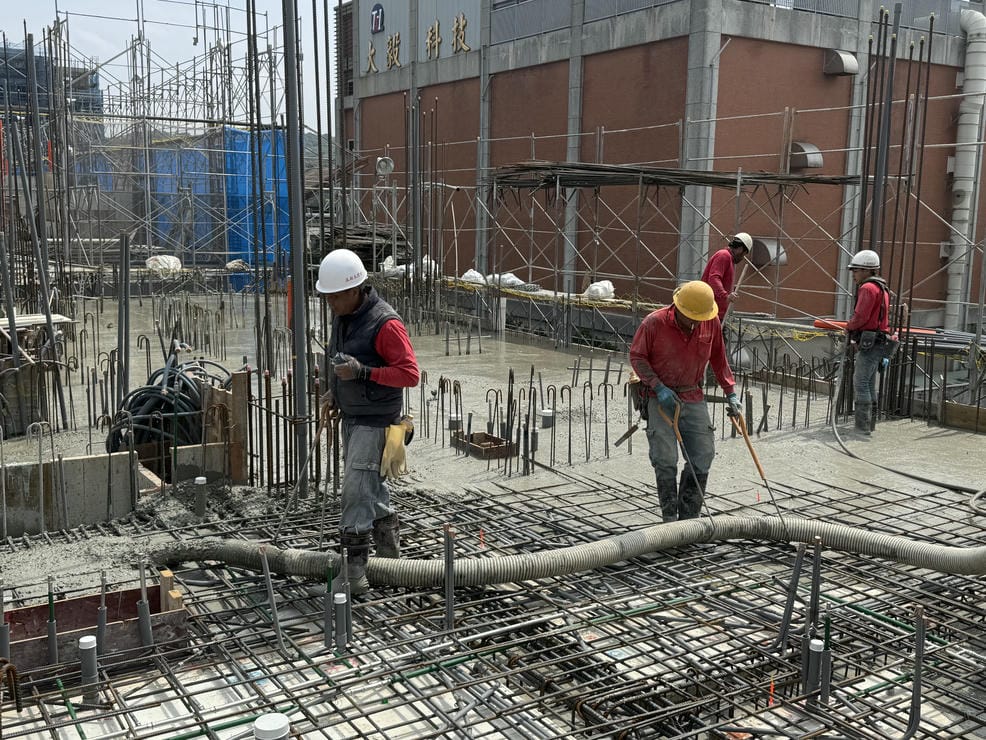

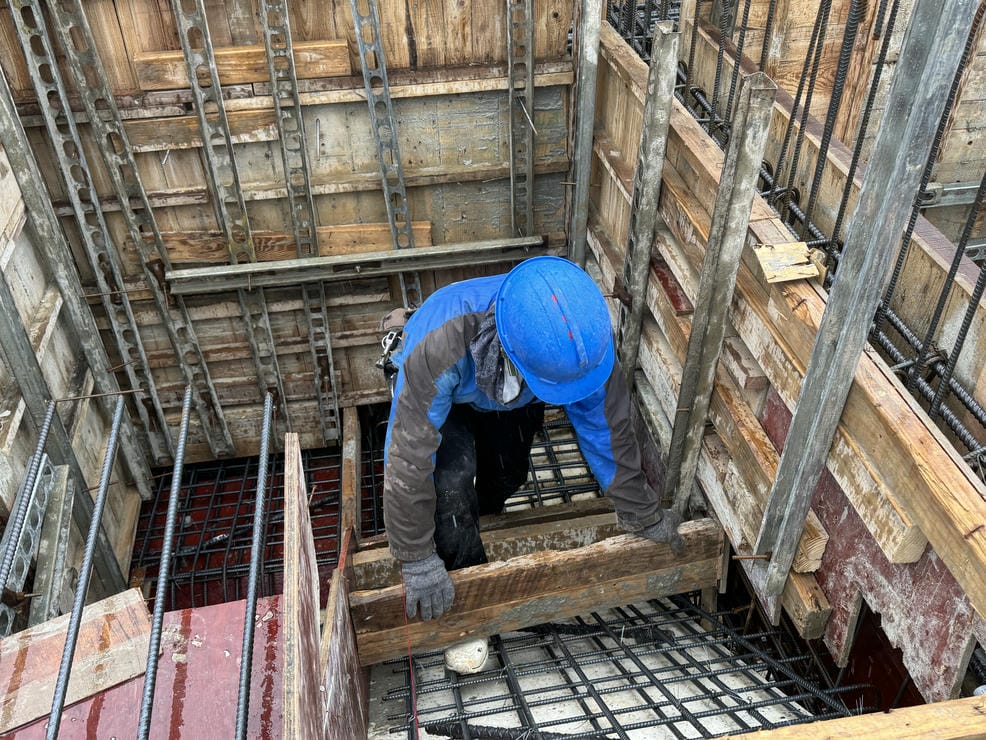

2025/03 5 floor template finalization -

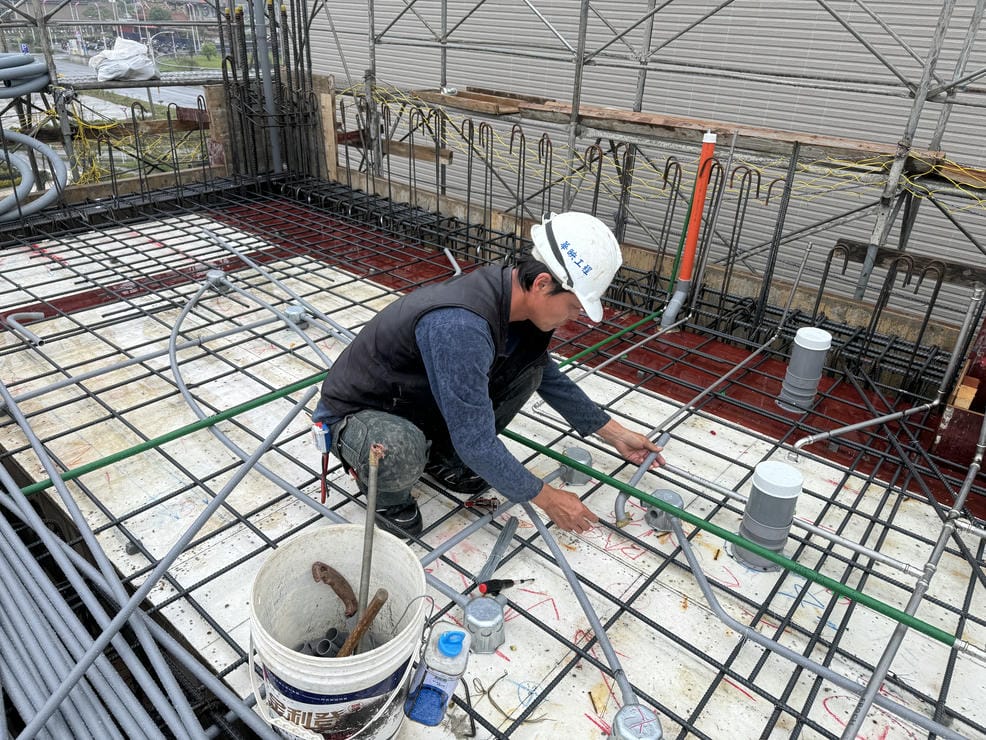

2025/03 5th floor water and electricity piping -

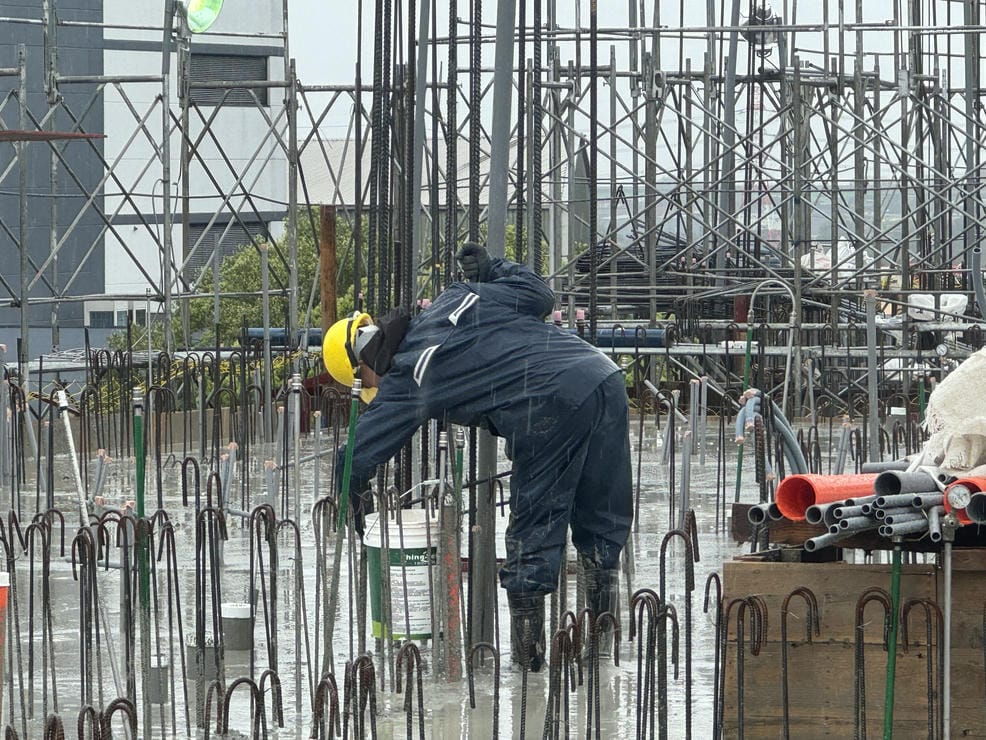

2025/03 5 Floor grouting column reinforcement cleaning -

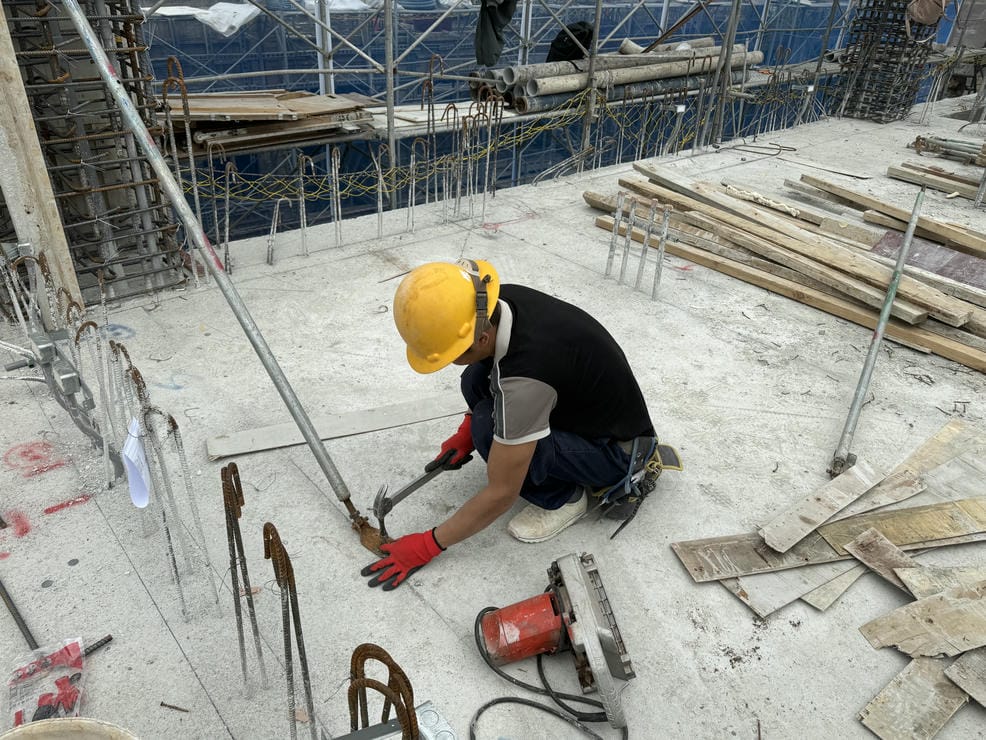

2025/03 3 -

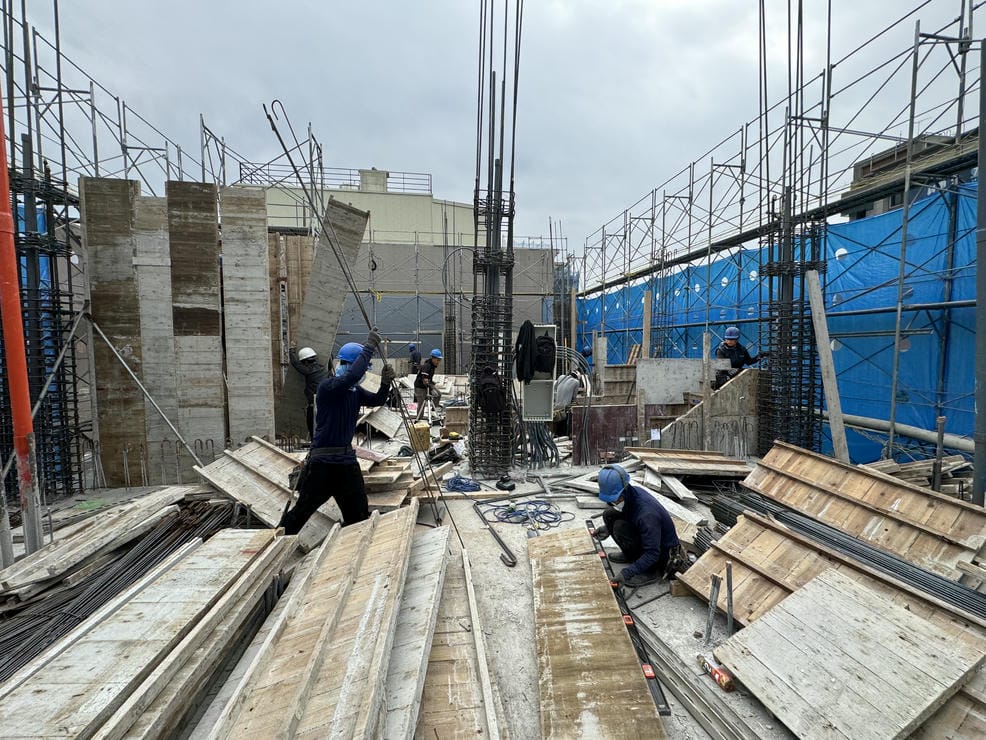

2025/03 5 Floor column wall single-sided formwork assembly -
2025/03 5 floor grouting -

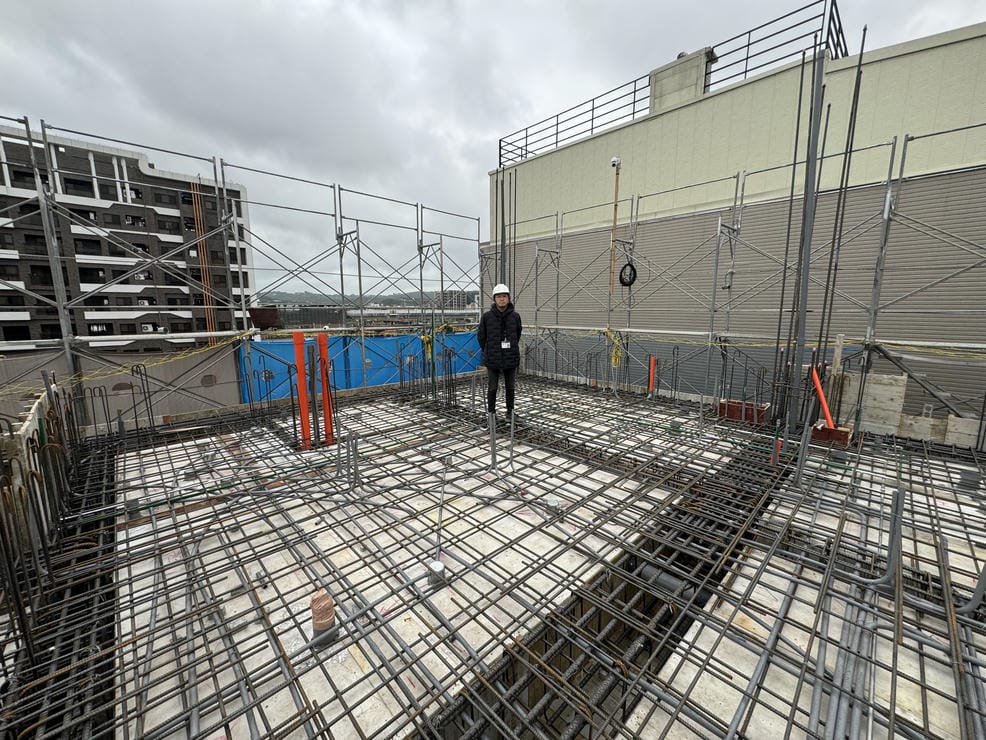

2025/03 6 Floor Architect Survey -

2025/03 Stone cutting on the second underground floor
-
-
04
2025
-

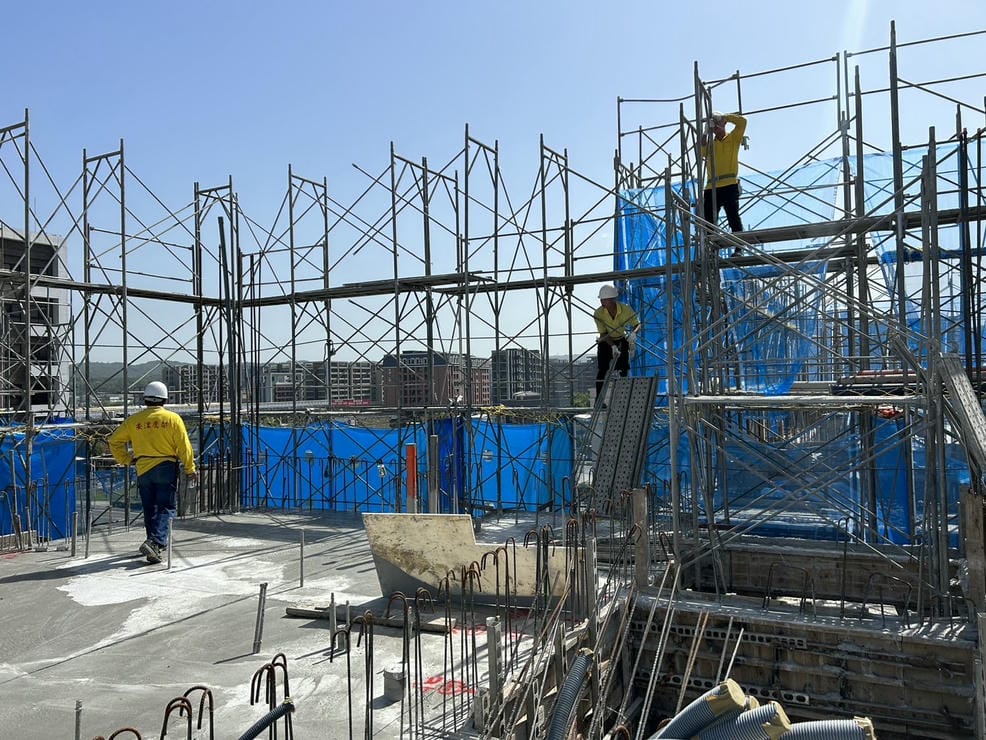

2025/04 Scaffolding lifting -

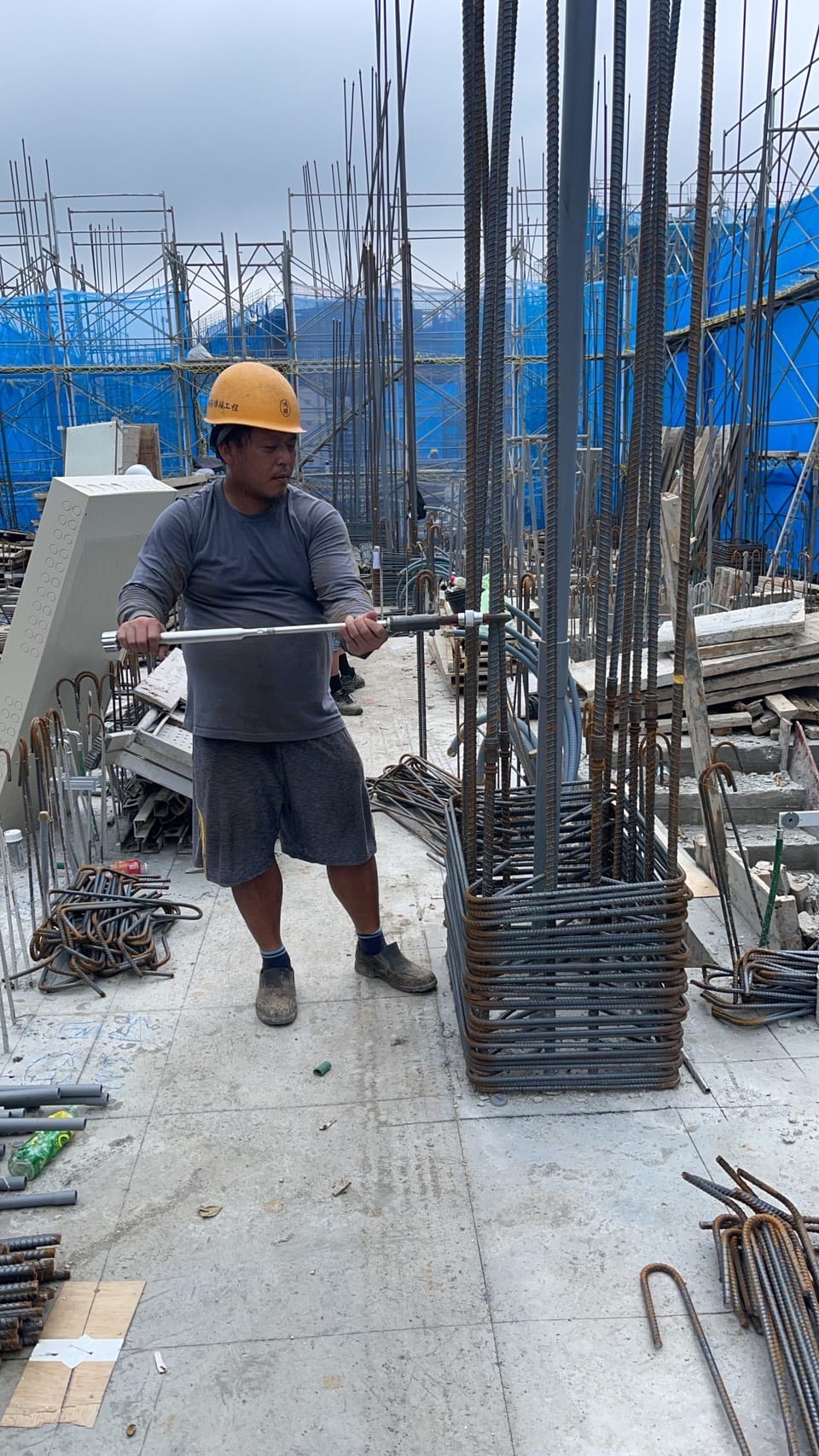

2025/04 6F coupler construction -

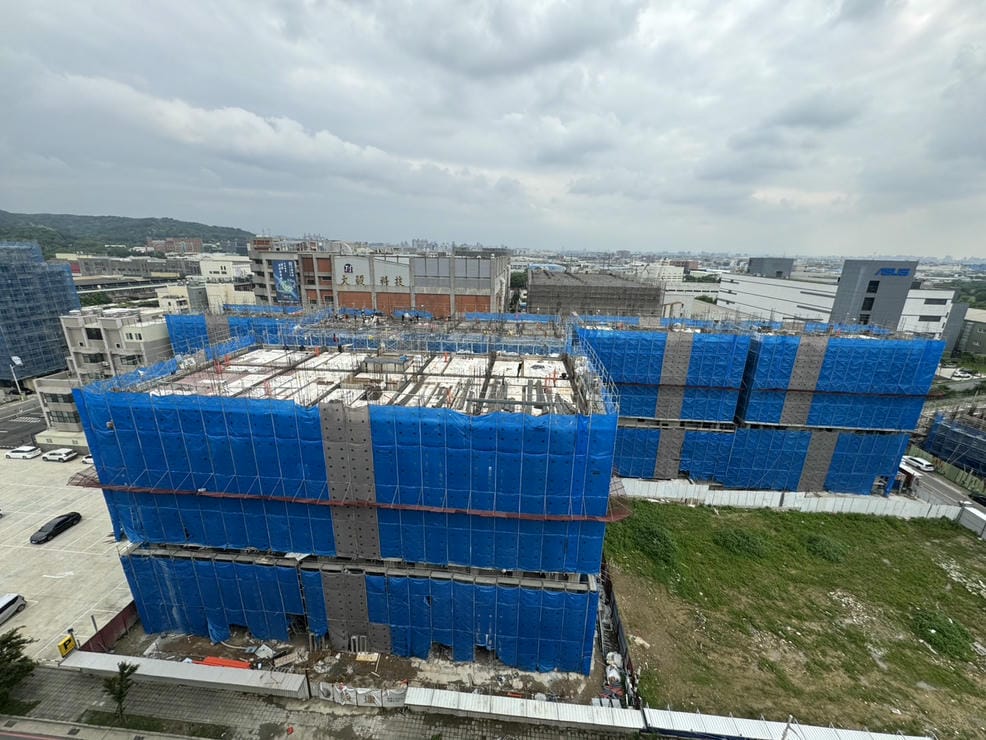

2025/04 Taking photos from the base -

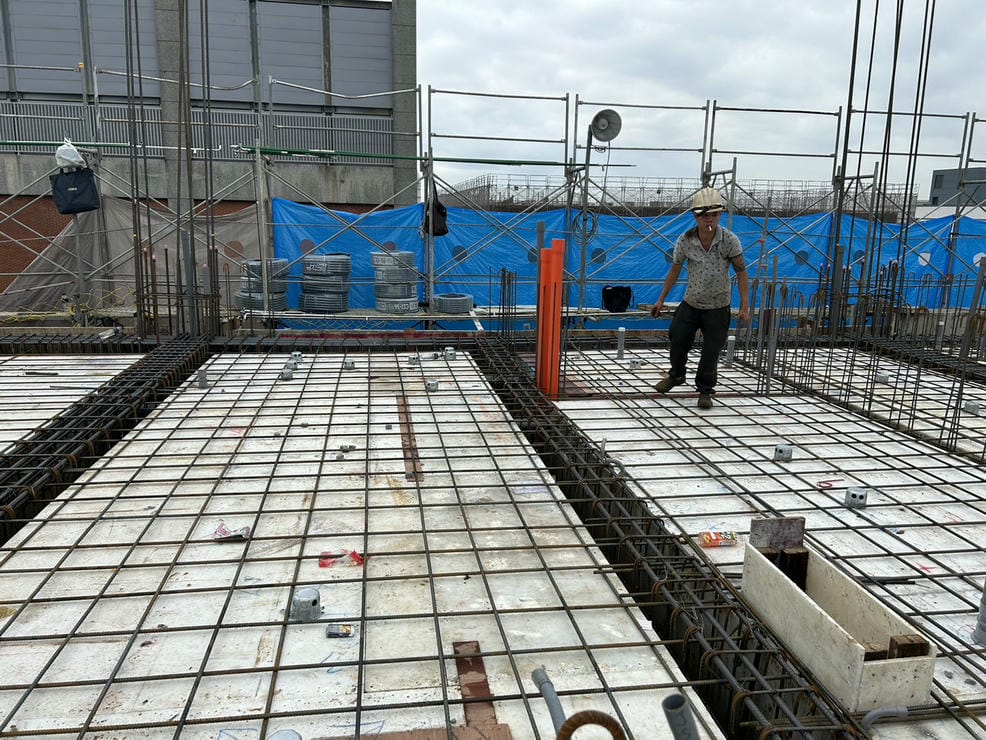

2025/04 20250412-7F梁版綁紮 -

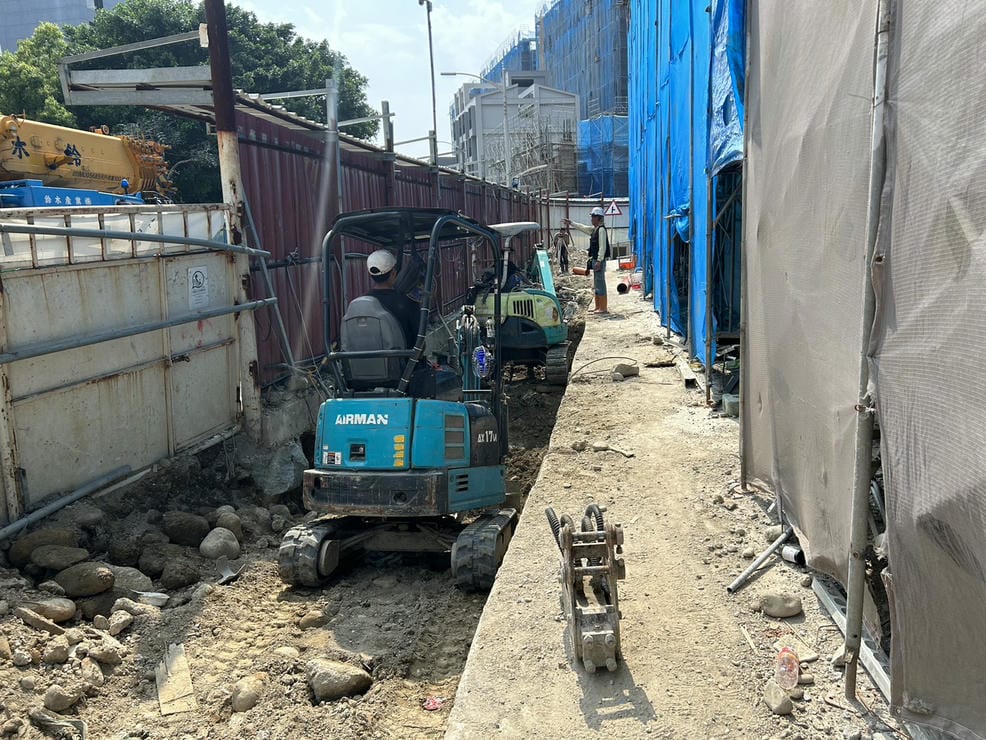

2025/04 South side pavement land leveling -

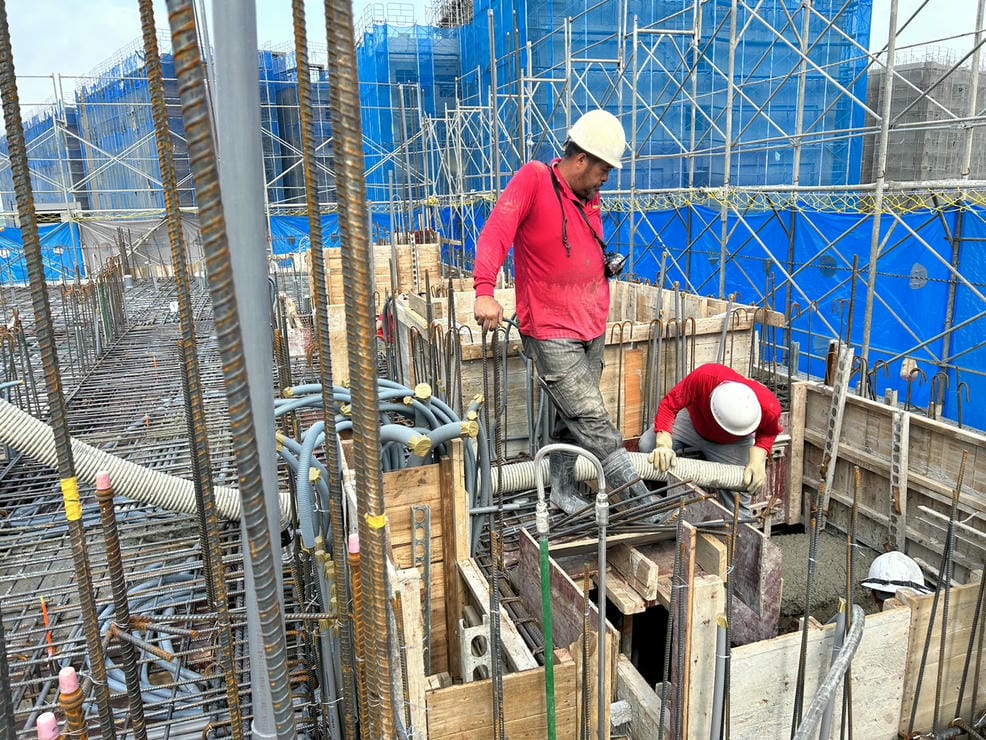

2025/04 7F beam slab grouting -

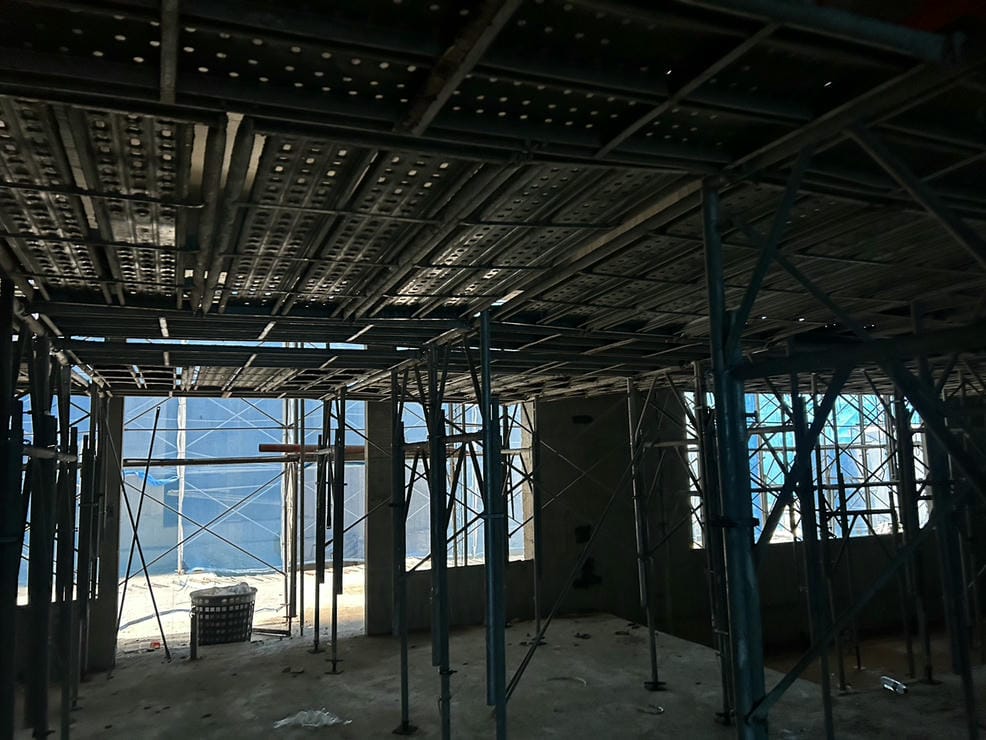

2025/04 Scaffolding construction on the first floor of Building A -

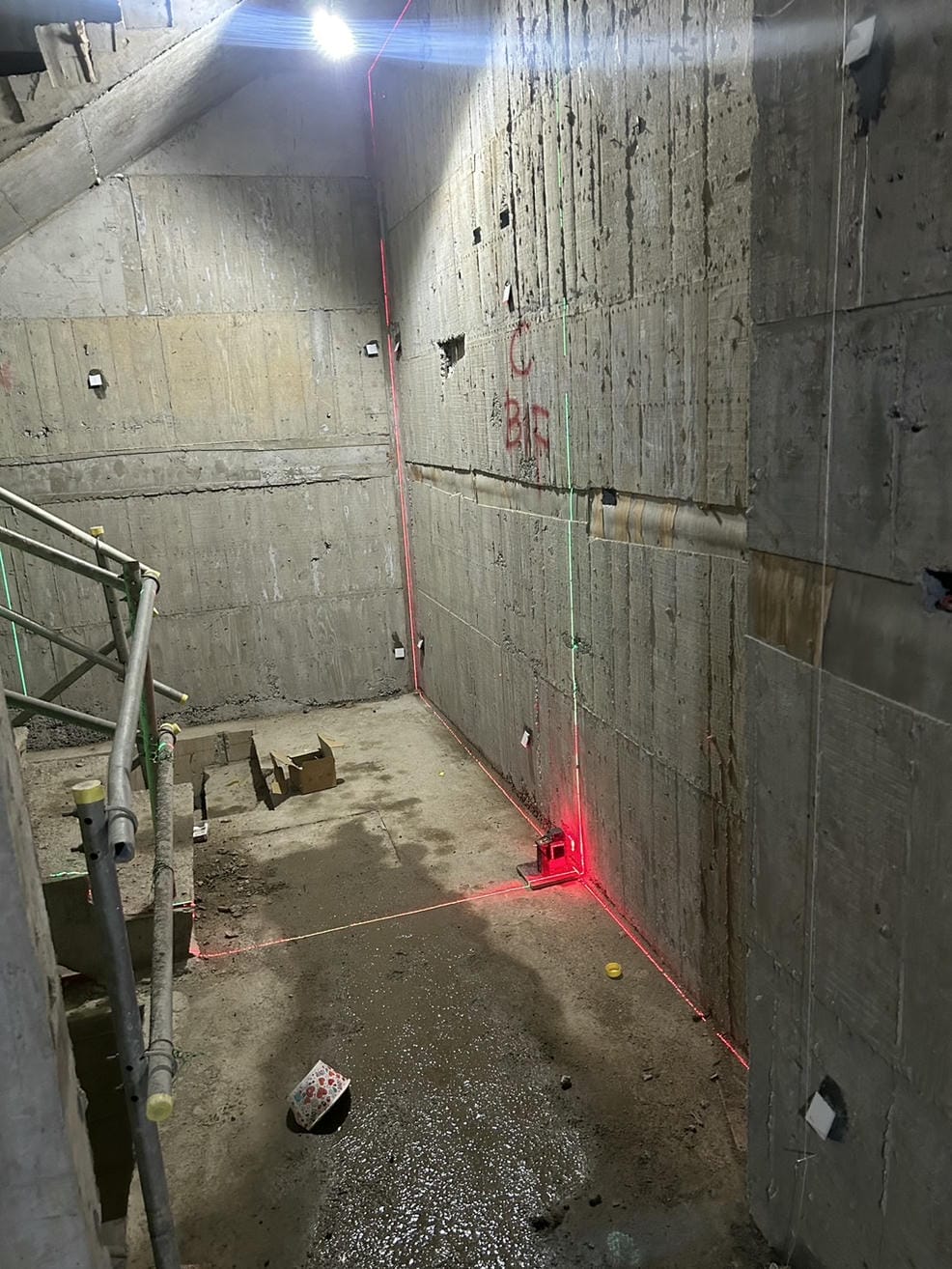

2025/04 Underground elevator hall hanging wire -

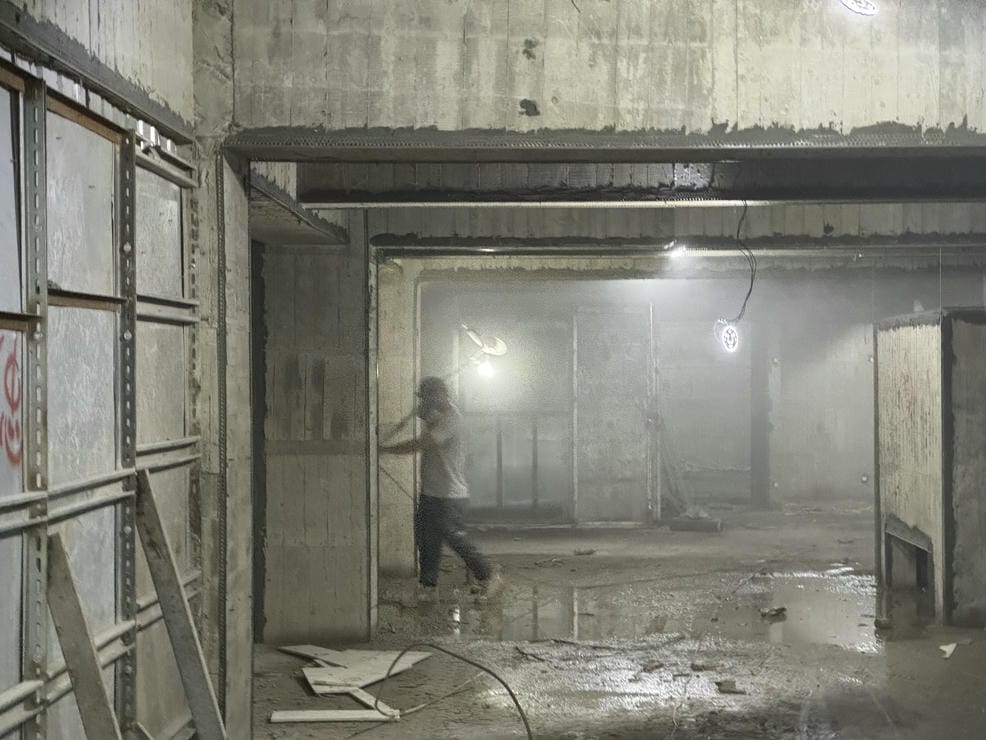

2025/04 Polishing of the underground two-ping roof -

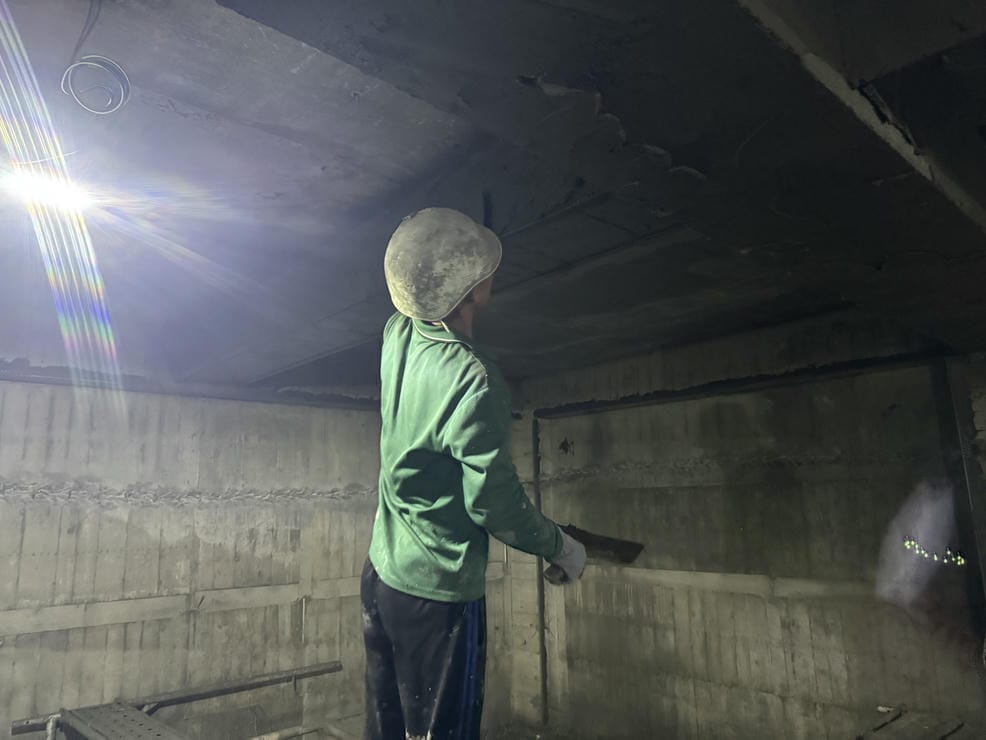

2025/04 The mud on the side of the second underground beam is used as the base
-
-
05
2025
-
2025/05 8F column reinforcement binding -
2025/05 8F single-sided module -
2025/05 8F single-sided module -
2025/05 The ground is covered with mud -
2025/05 9F version beam reinforcement binding -
2025/05 9F version beam reinforcement binding -
2025/05 9F version water and electricity piping -
2025/05 9F version water and electricity piping -
2025/05 9F version pouring -
2025/05 9F version pouring -
2025/05 9F Scaffolding Construction -
2025/05 The ground is covered with mud -
2025/05 Connector torque test
-
-
07
2025
-
2025/07 10F roof slab pouring operation -
2025/07 6F exterior wall tile feed -
2025/07 10F column wall connector construction -
2025/07 Light compartment skeleton hanging material -
2025/07 RF beam reinforcement binding -
2025/07 Construction of light partition frame on 3F of Building A -
2025/07 RF version hanging formwork construction -
2025/07 Building A 4F light partition frame construction -
2025/07 RF version water immersion maintenance
-
-
08
2025
-
2025/08 Building A & B RF roof column & wall concrete casting(3) -
2025/08 Building A & B RF roof column & wall concrete casting(2) -
2025/08 Building A 2F light partition grouting -
2025/08 Building A 5F light partition single-sided board installation -
2025/08 Building A PRF ring beam formwork installation -
2025/08 Building A RF inner ring beam supplementary formwork support -
2025/08 Building C 4F light partition steel plate reinforcement behind washbasin -
2025/08 Building D & E 3F exterior wall window frame waterproofing -
2025/08 Building D & E 4F window frame joint sealing -
2025/08 Building E 4F light partition double-sided board installation -

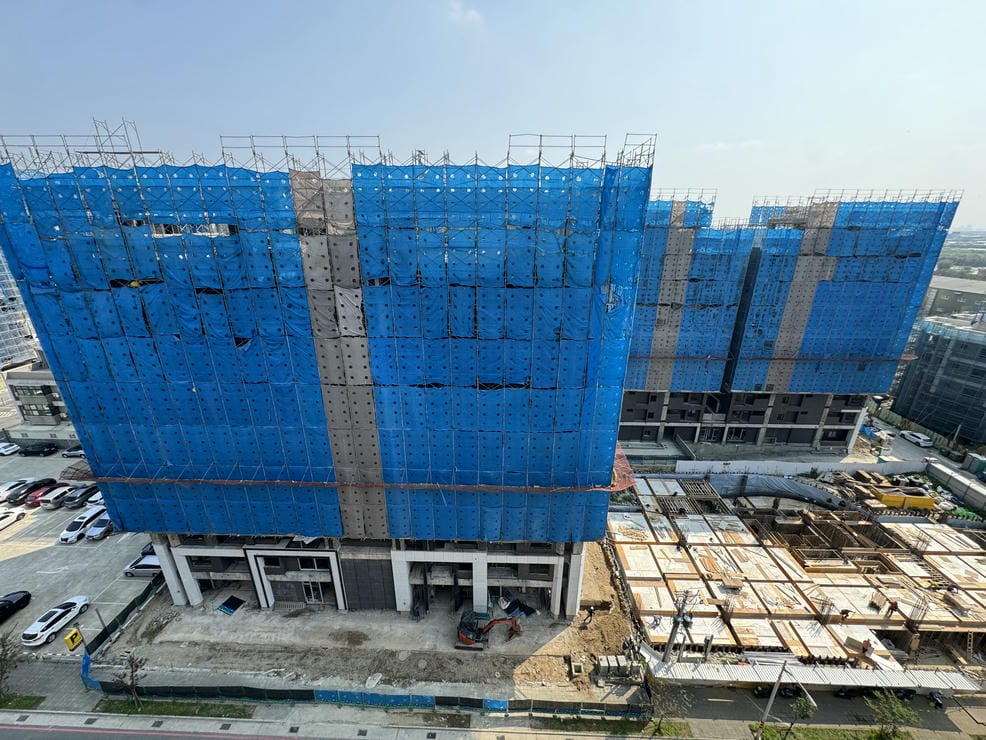

2025/08 Site aerial photos -
2025/08 Generator room foundation construction
-
-
09
2025
-
2025/09 Building A 2F interior masonry base plastering & finishing -
2025/09 Building A 4F light partition double-sided board installation -
2025/09 Building A 6F light partition double-sided board installation -
2025/09 Building A 7F light partition framework installation -
2025/09 B3F basement peripheral exterior wall waterproof plastering -

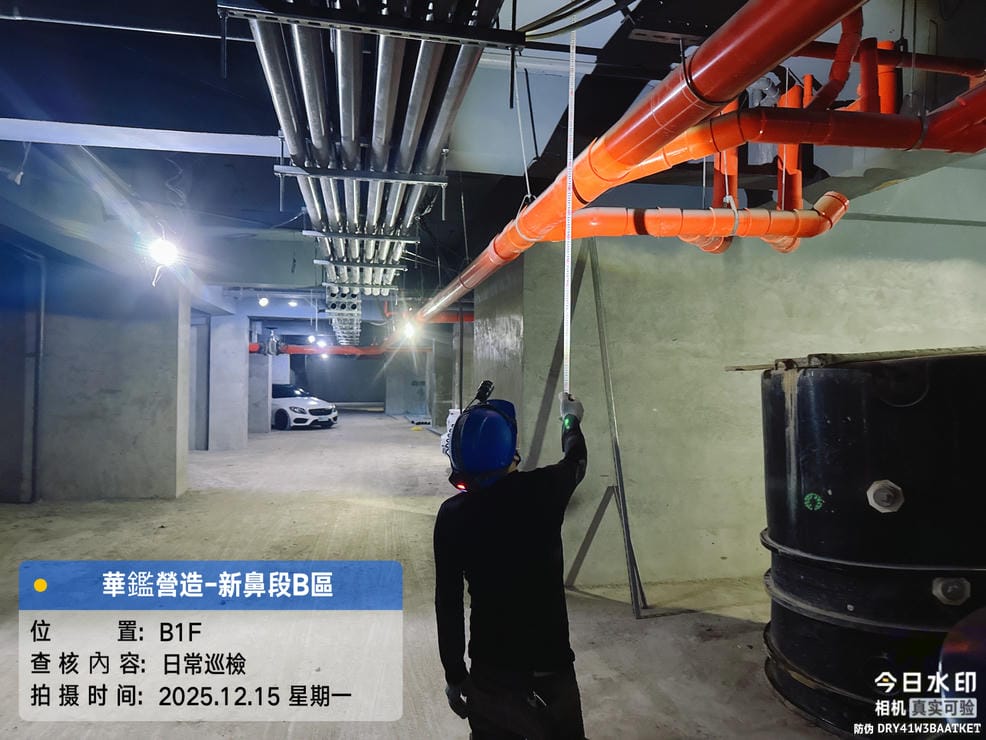

2025/09 B3F fire-fighting overhead piping installation -
2025/09 Building B 9F interior overhead piping installation -
2025/09 Building C 2F interior masonry base plastering -
2025/09 Building C light partition grouting -
2025/09 Building E 2F light partition joint puttying -
2025/09 Site aerial photos
-
-
10
2025
-

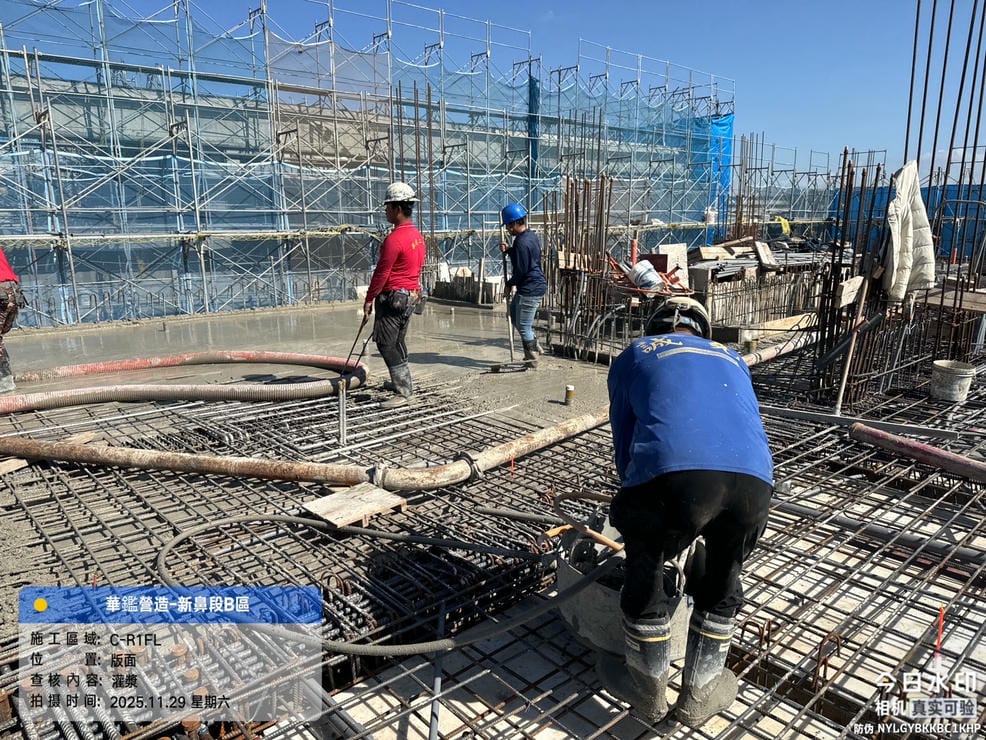

2025/10 8F Slab Concrete Pouring -
2025/10 8F Slab Pouring Inspection (1) -
2025/10 8F Slab Pouring Inspection (2) -
2025/10 8F Slab Pouring Inspection (3) -
2025/10 8F Slab Pouring Inspection (4) -
2025/10 8F Slab Pouring Inspection (6) -
2025/10 Block A 5F Partition Putty Work -
2025/10 Block A 5F Partition Double-Sided Board Installation -
2025/10 Block A 7F Partition Double-Sided Board Installation -
2025/10 Block A 8F Partition Single-Sided Board Installation -
2025/10 Block C 5F Partition Framework Installation -

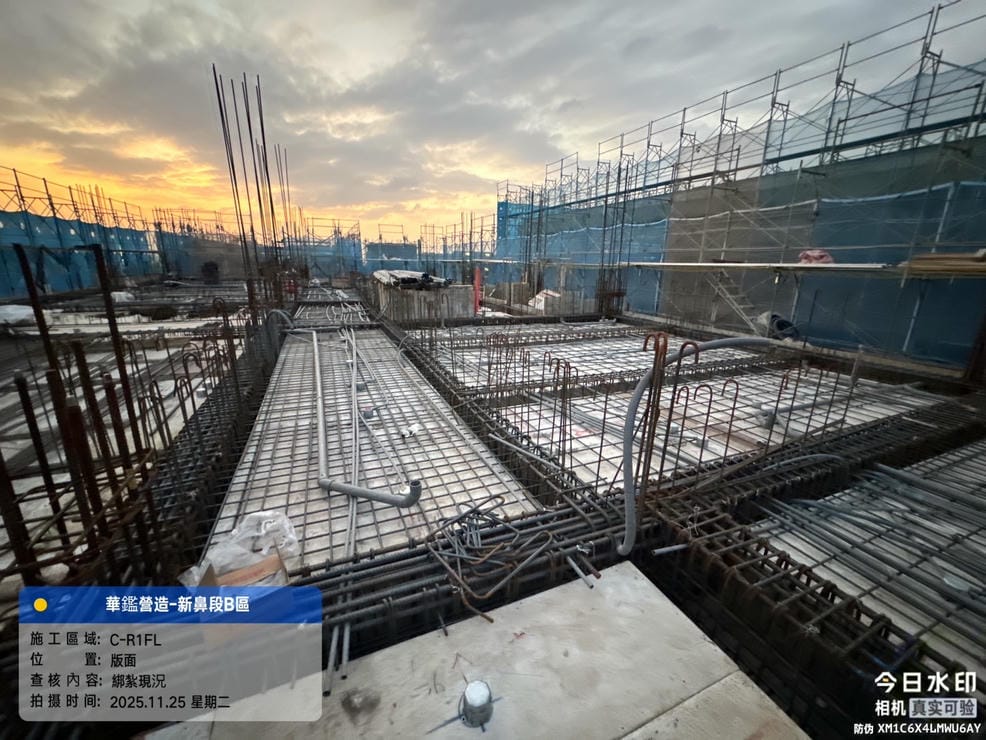

2025/10 Block C 9F Column & Wall Formwork Assembly -
2025/10 Block C 9F Slab MEP Conduit Installation -
2025/10 Block D 9F Beam & Slab Rebar Tying Inspection (1) -
2025/10 Block D 9F Beam & Slab Rebar Tying Inspection (2) -
2025/10 Courtyard Waterproofing Work -
2025/10 Site Exterior View
-
