One and Only
-
03
2022
-

2022/03 PC setup completed -

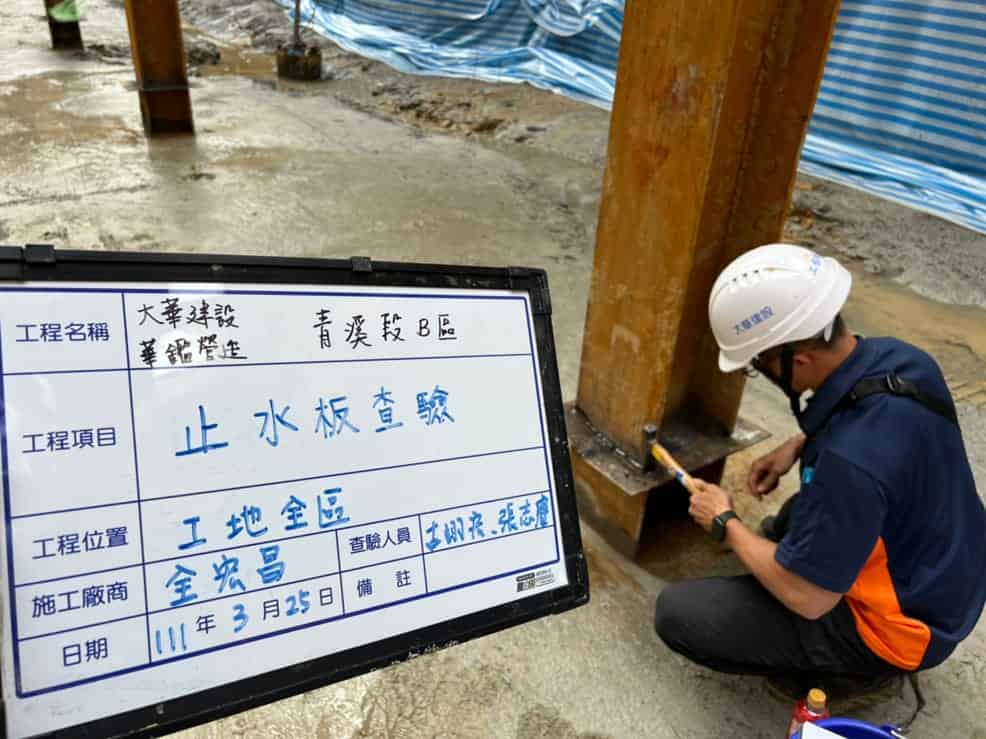

2022/03 Inspection of intermediate pile water stop plate
-
-
04
2022
-

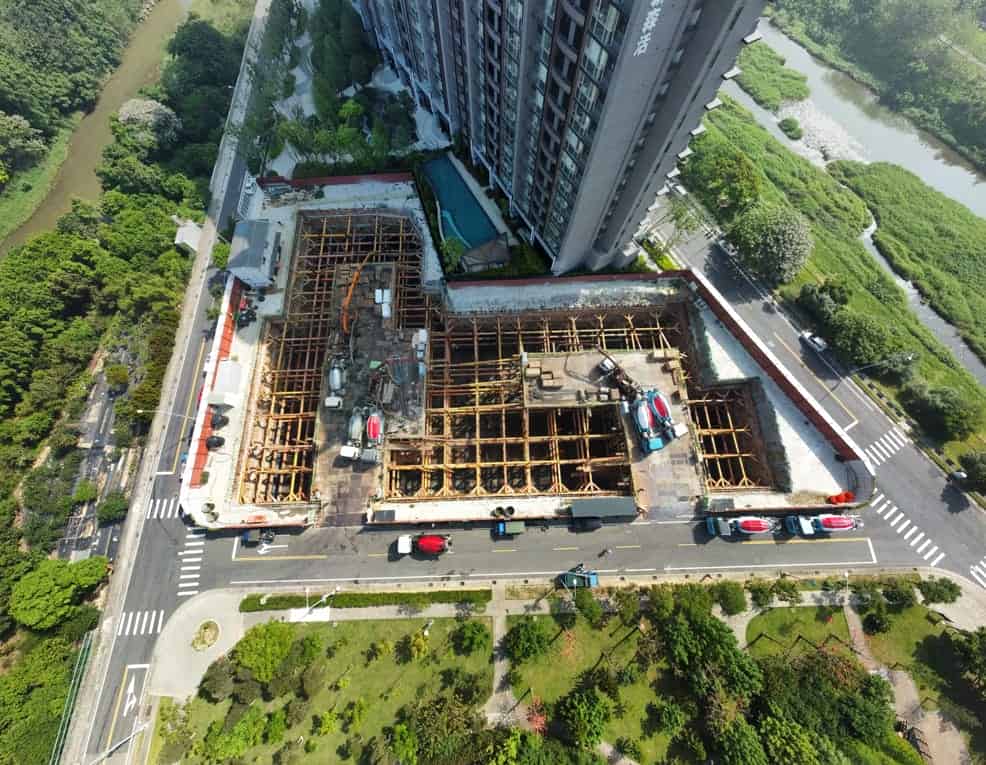

2022/04 B3FL panoramic photo -

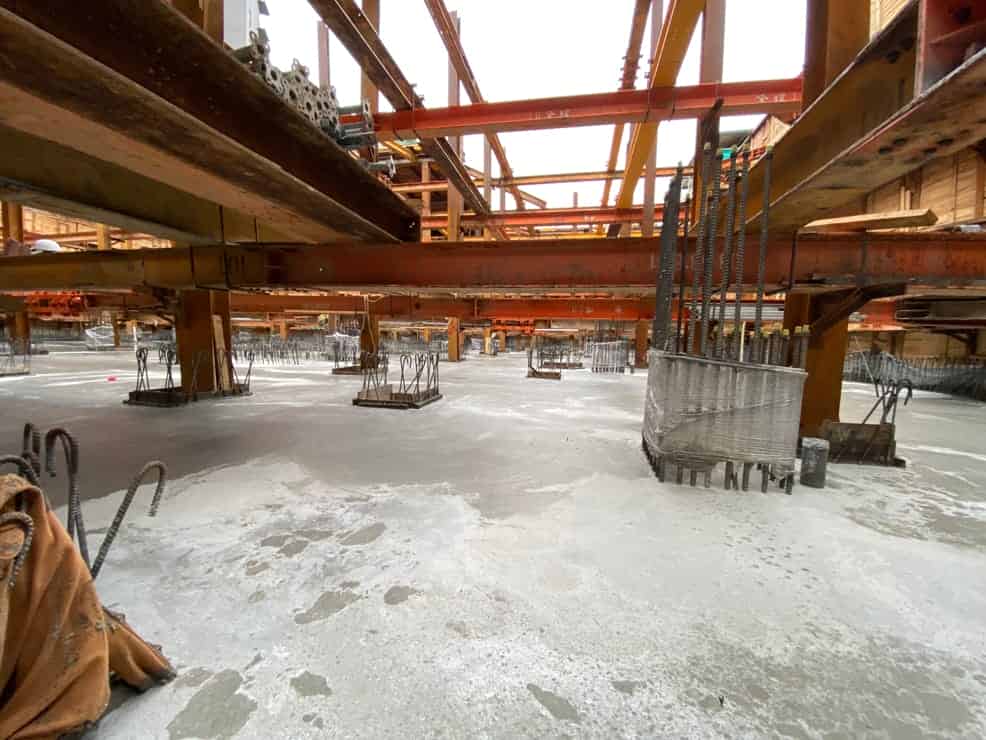

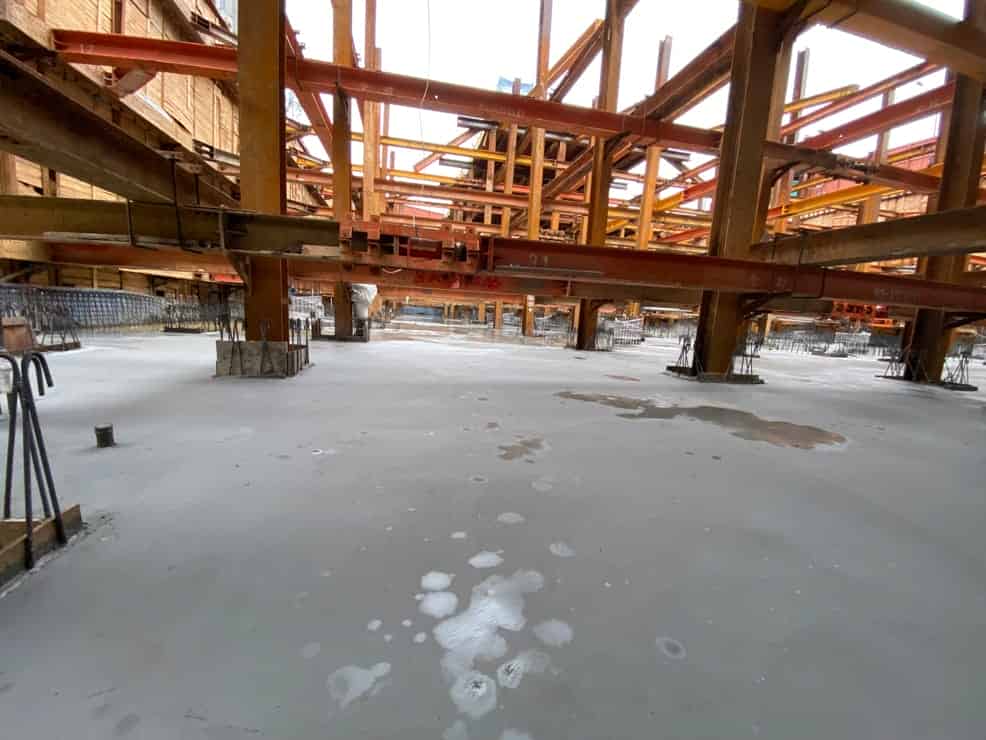

2022/04 B3FL grouting completed -
2022/04 B3FL grouting completed
-
-
05
2022
-

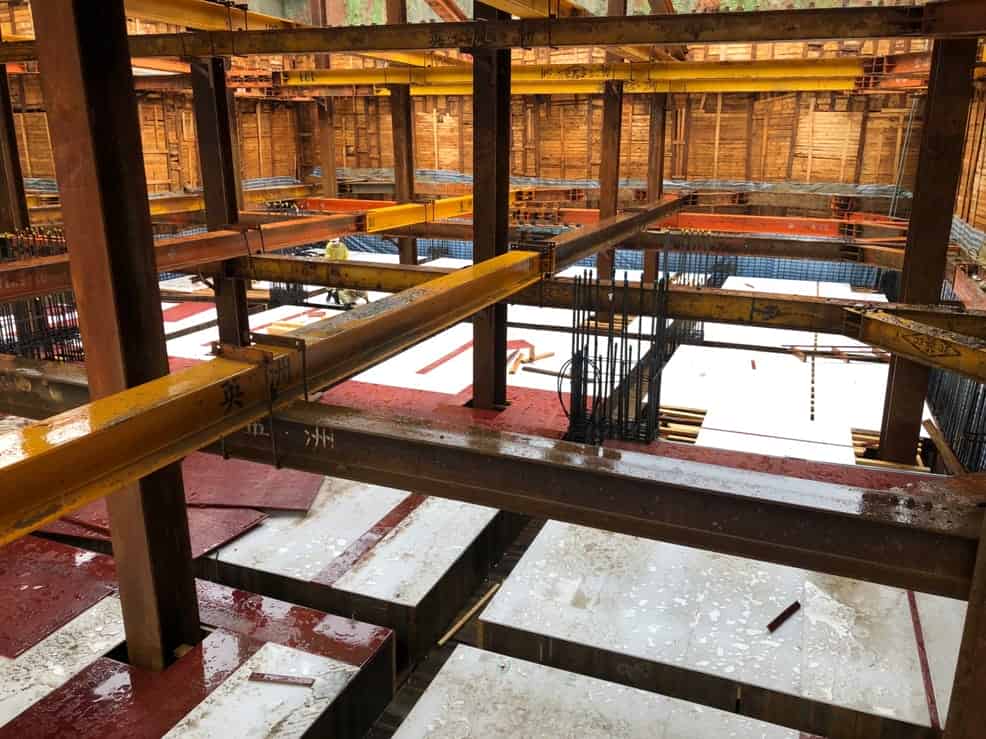

2022/05 B2FL template completed -

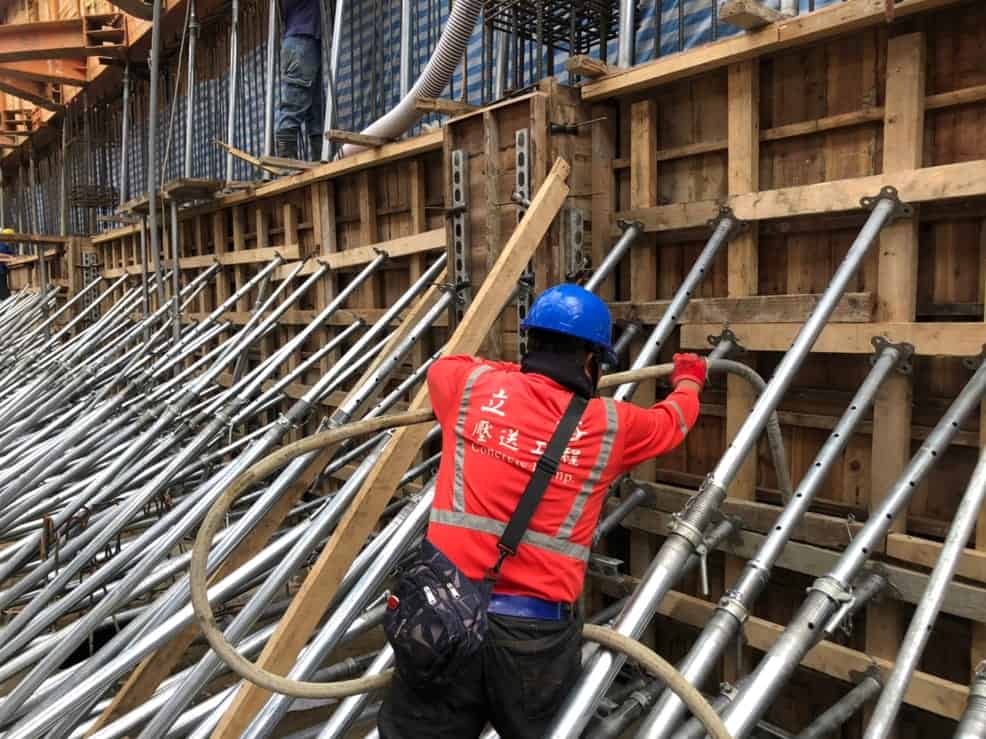

2022/05 B3FL half wall grouting -

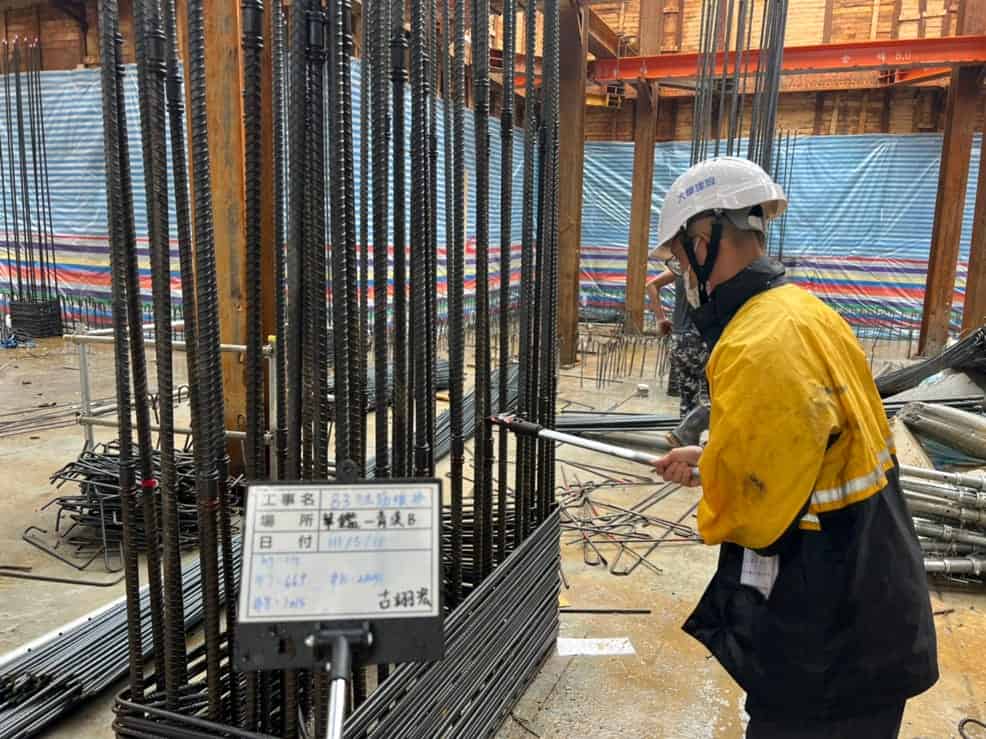

2022/05 B3FL column reinforcement continued inspection
-
-
06
2022
-

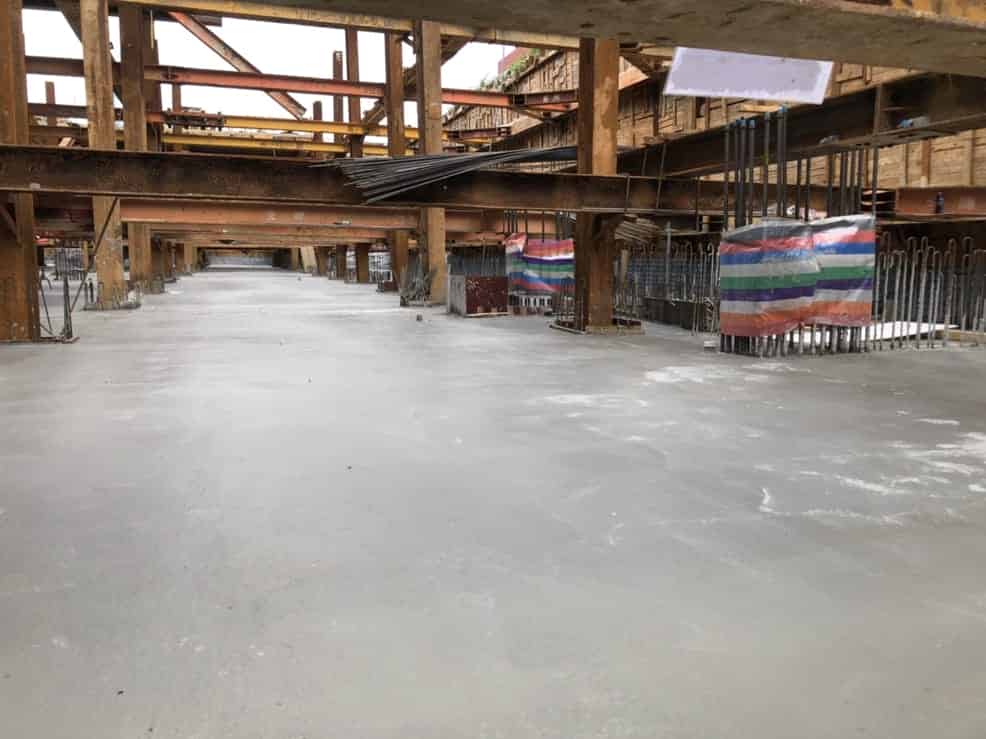

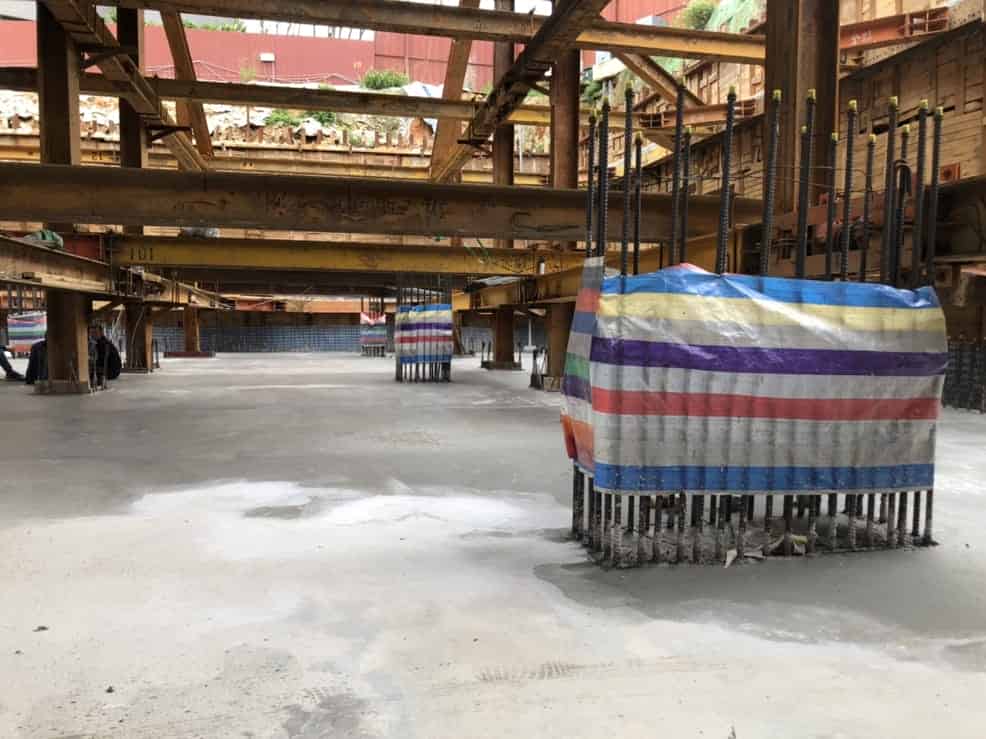

2022/06 B2FL implementation completed -
2022/06 B2FL implementation completed -

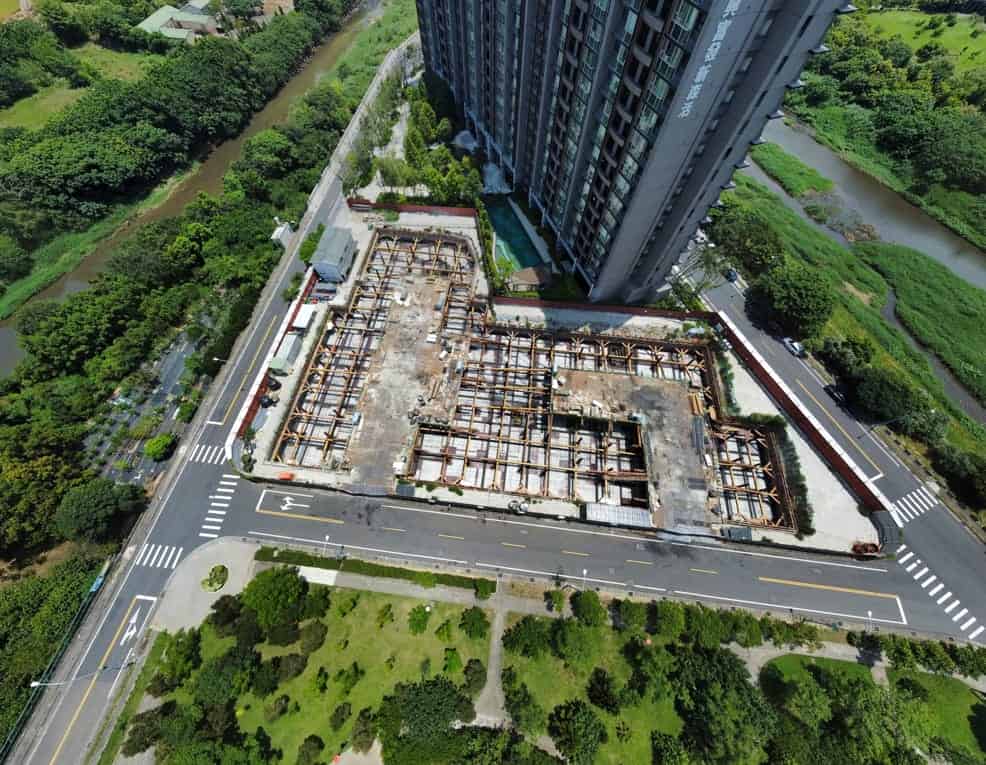

2022/06 B2F panorama
-
-
07
2022
-

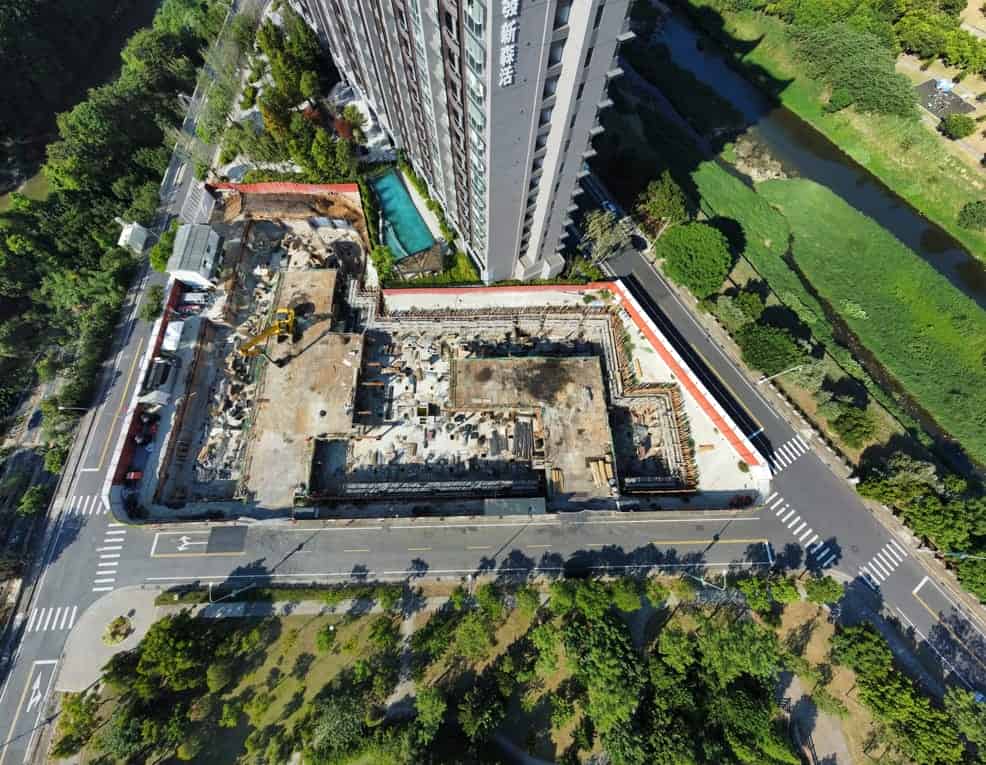

2022/07 B1FL Panorama -

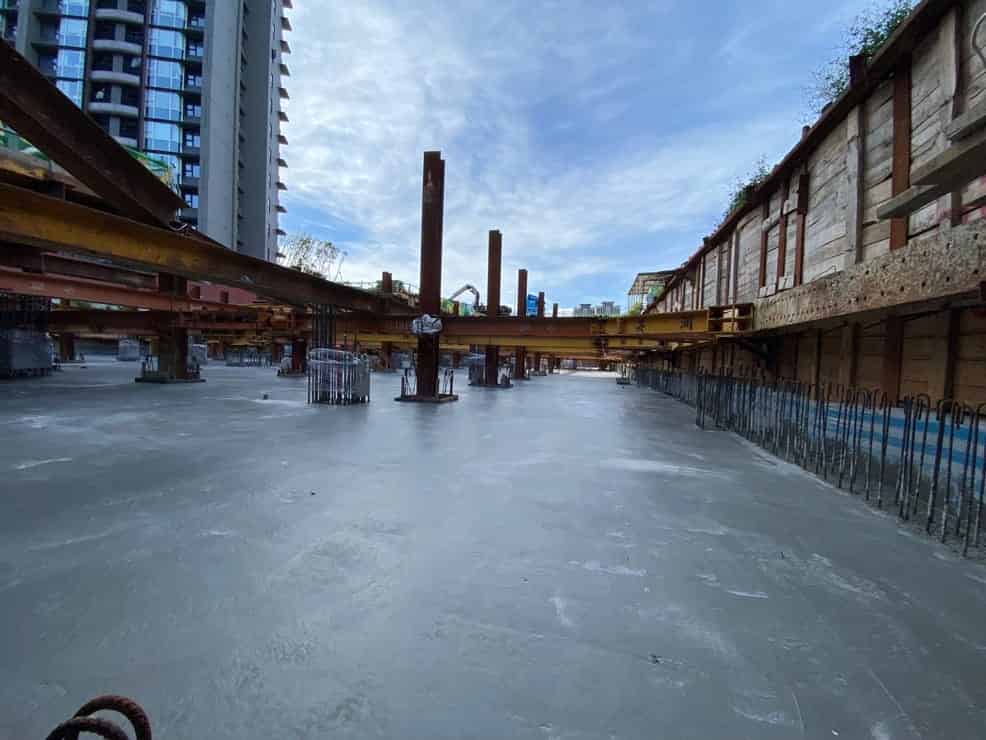

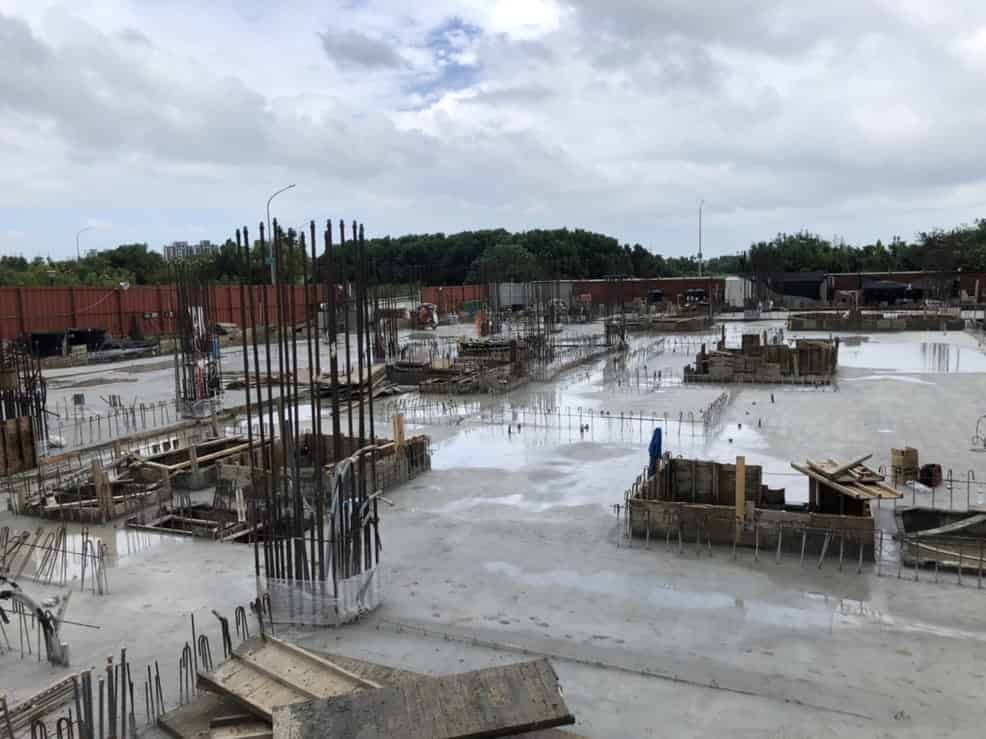

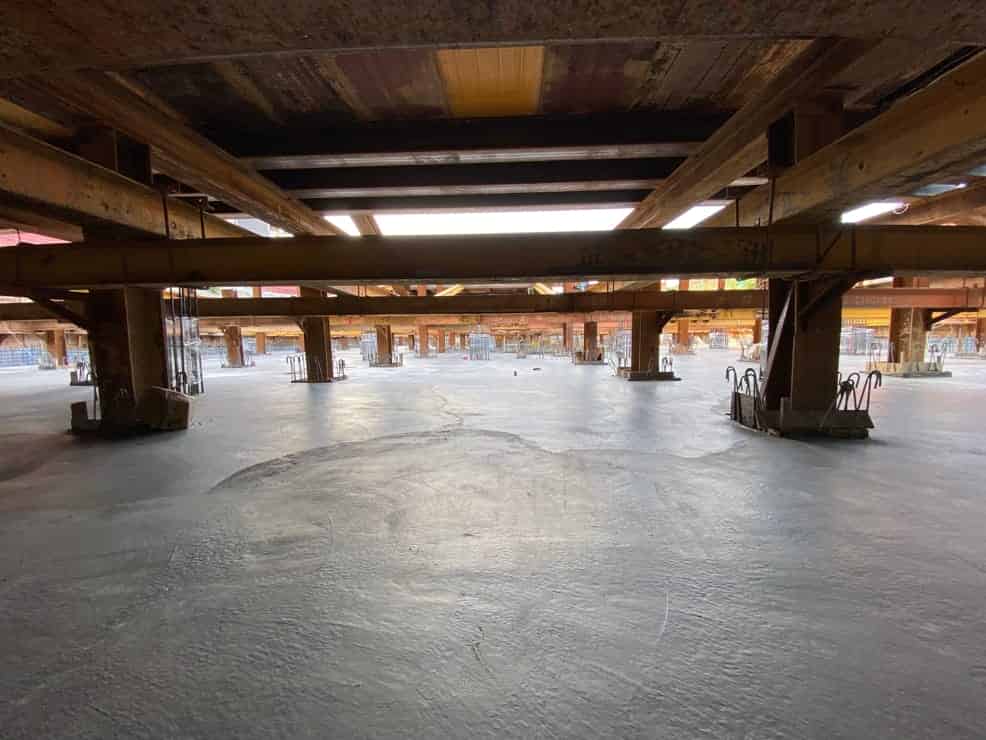

2022/07 B1FL construction completed -
2022/07 B1FL construction completed
-
-
08
2022
-

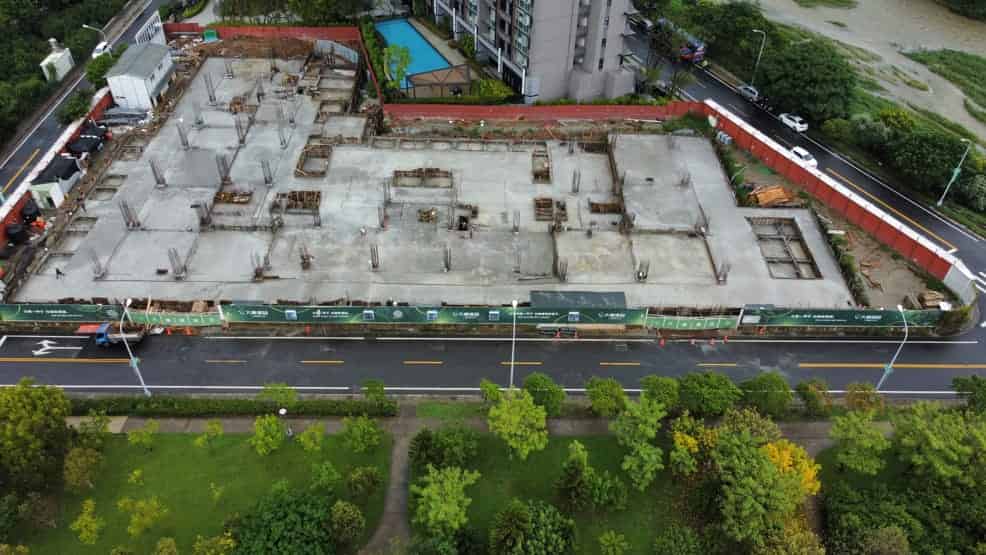

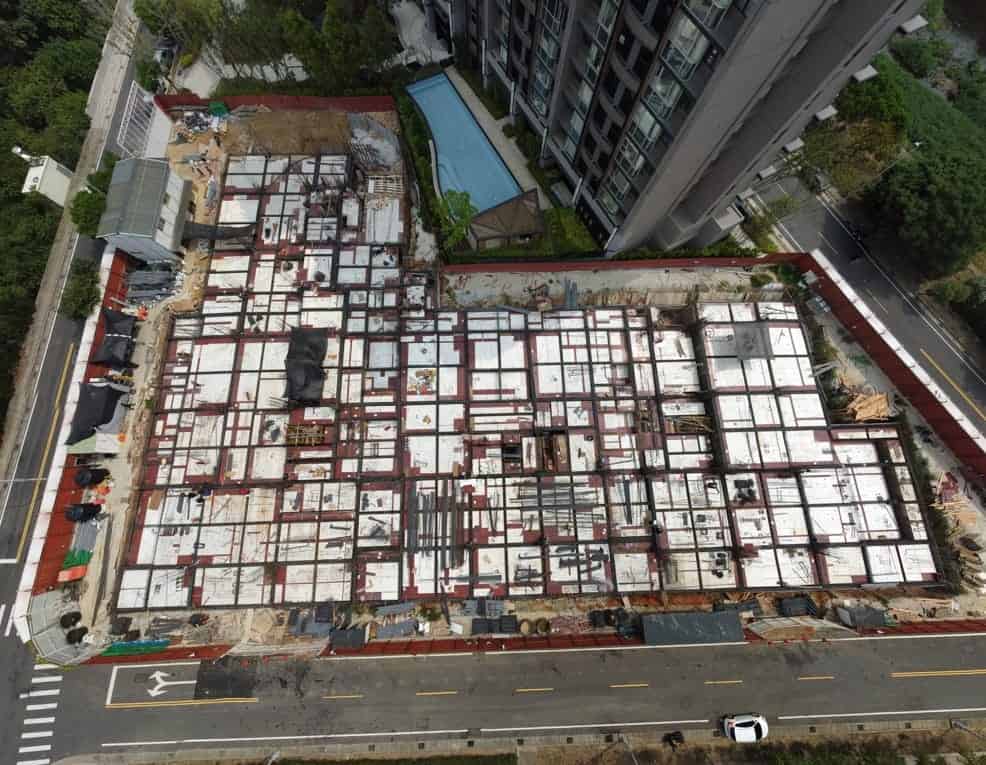

2022/08 1FL panoramic -

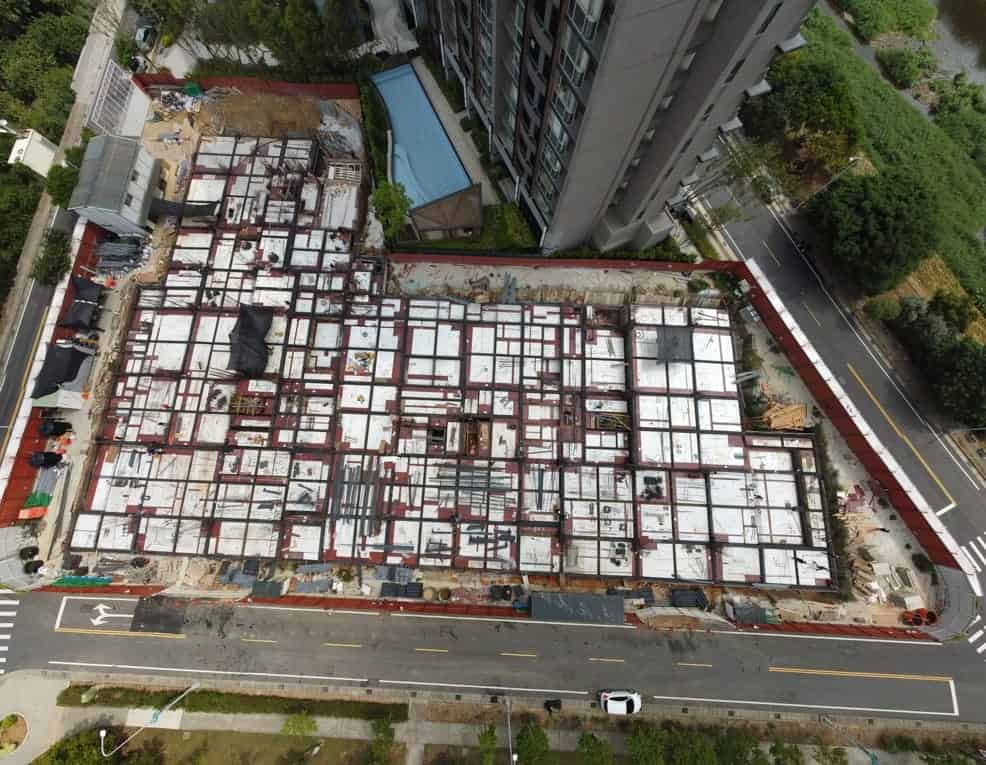

2022/08 1FL template construction completed
-
-
09
2022
-
2022/09 1FL panoramic -
2022/09 1FL grouting completed
-
-
10
2022
-

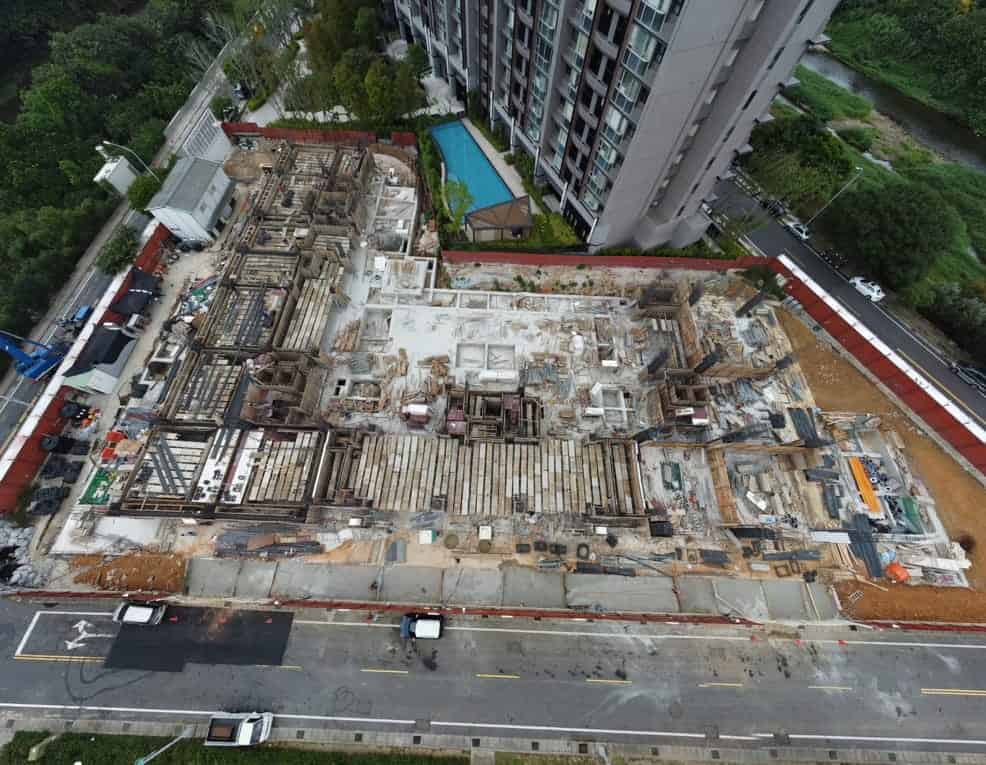

2022/10 1MF panoramic -

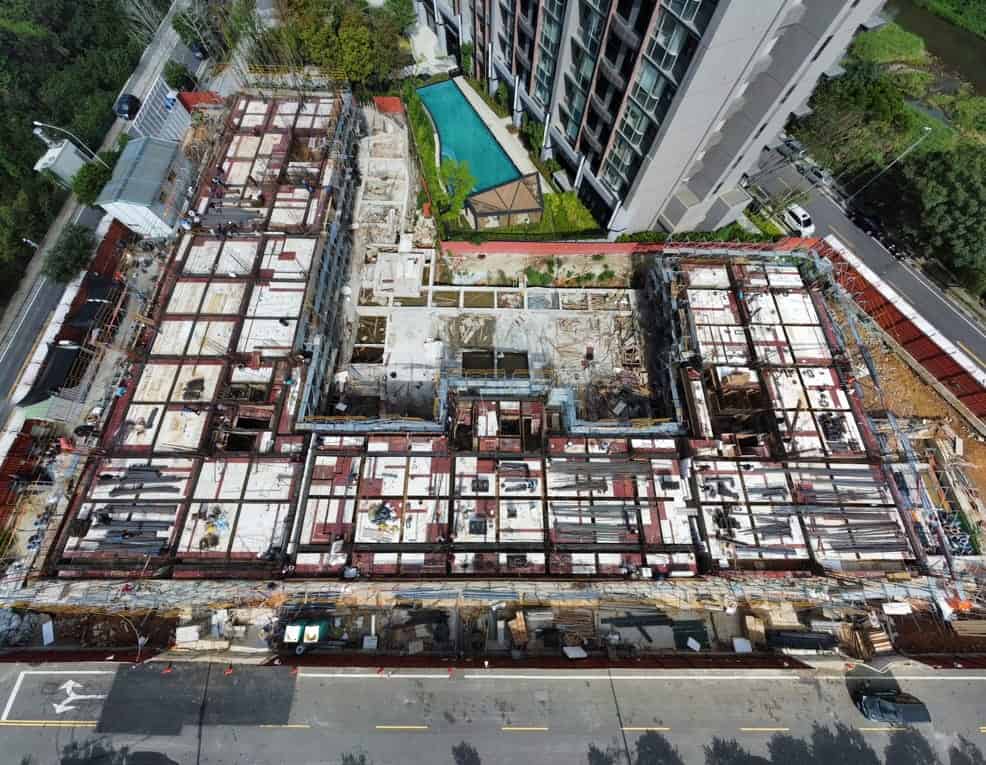

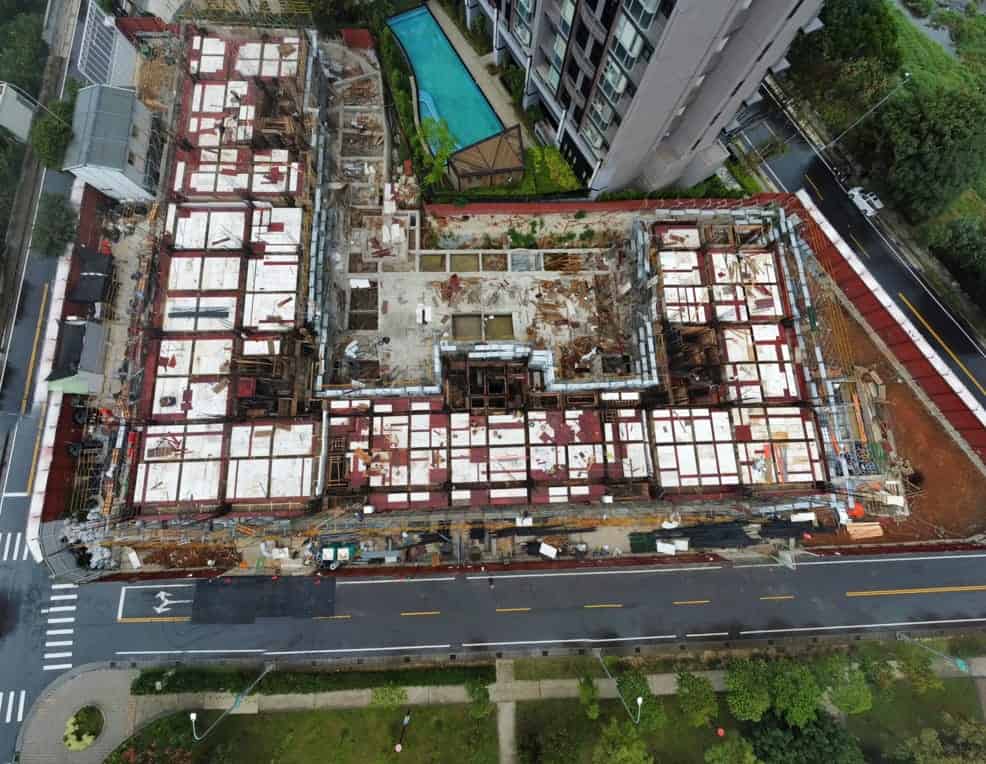

2022/10 2FL panoramic -
2022/10 2FL panoramic
-
-
11
2022
-

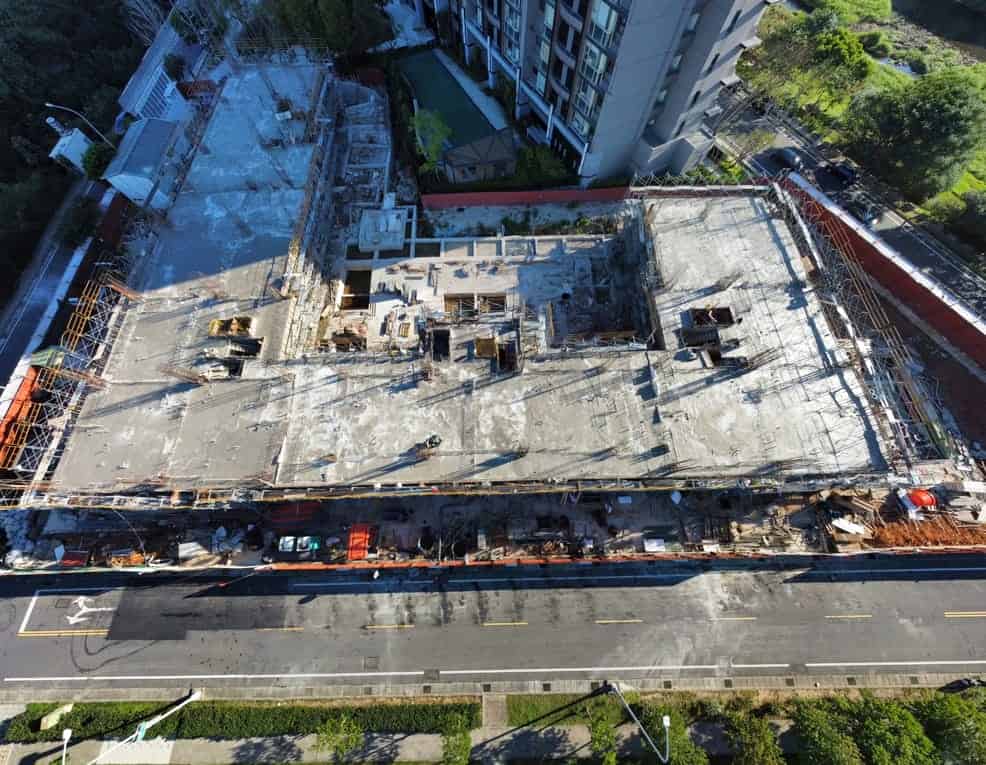

2022/11 2FL grouting completed -

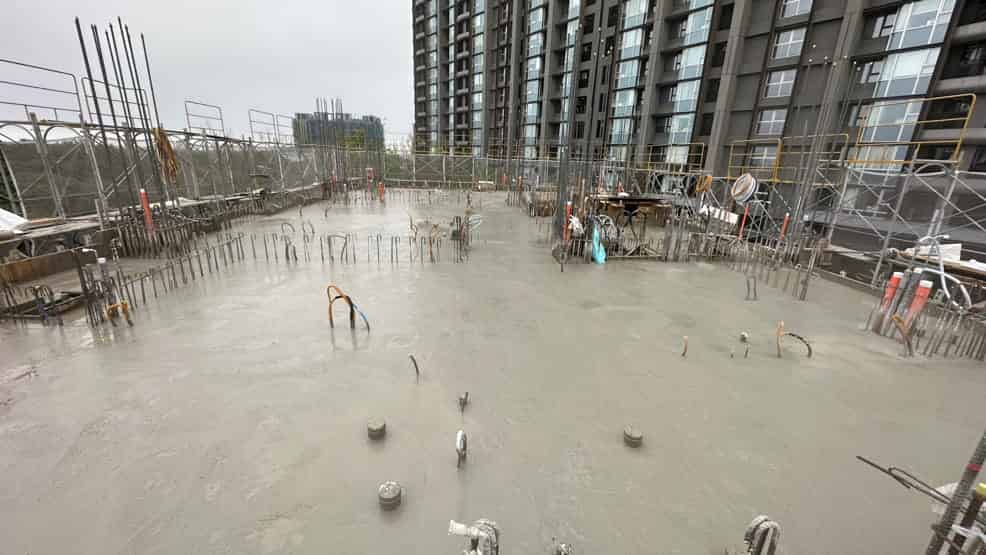

2022/11 3FL grouting
-
-
12
2022
-

2022/12 4FL base aerial shot -

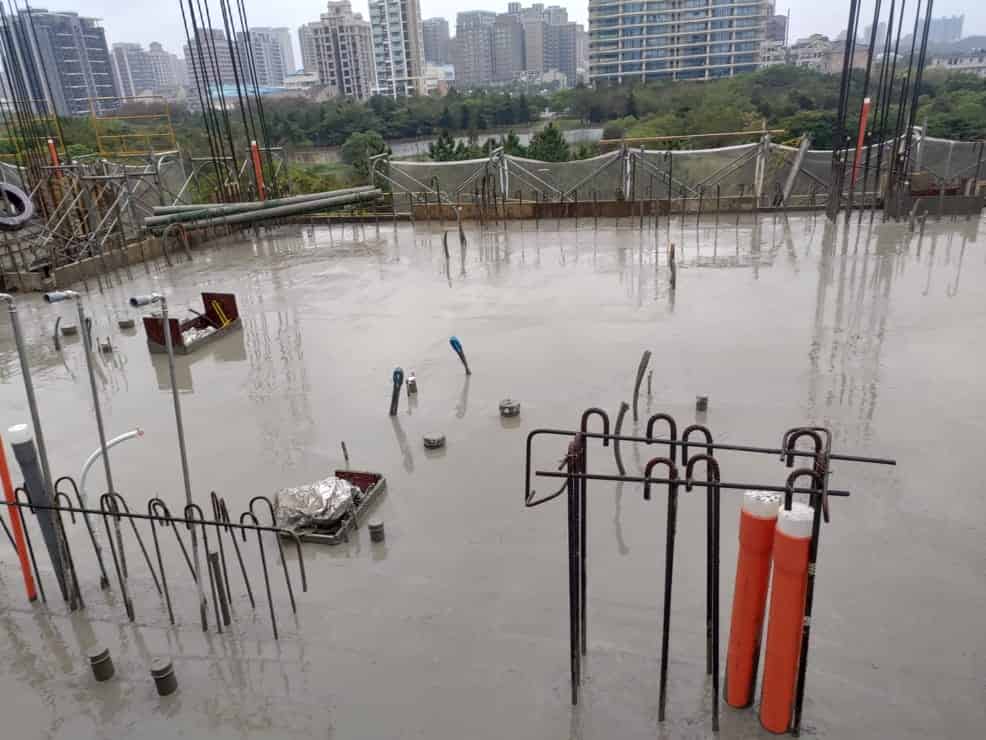

2022/12 4FL base aerial shot -
2022/12 4FL concrete placement
-
-
01
2023
-

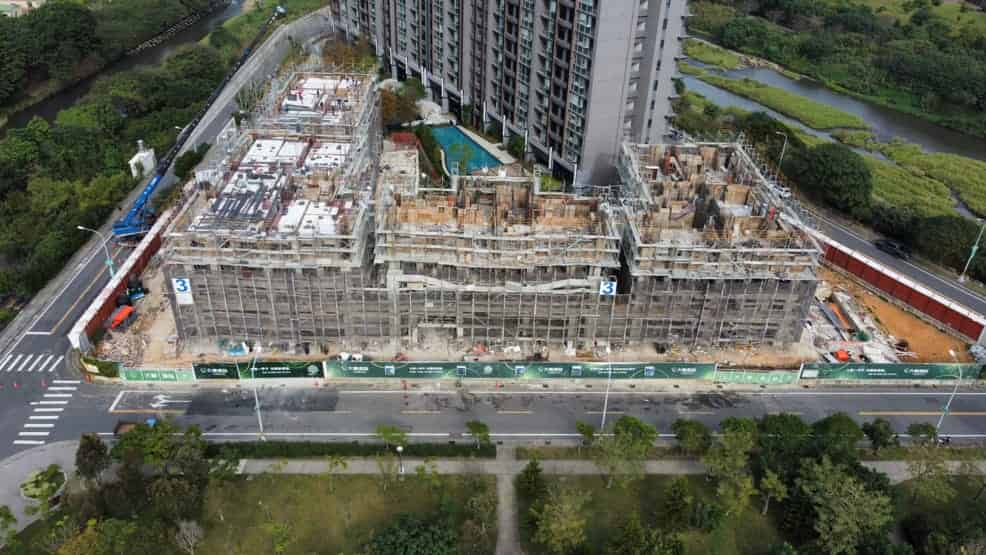

2023/01 5FL template assembly -

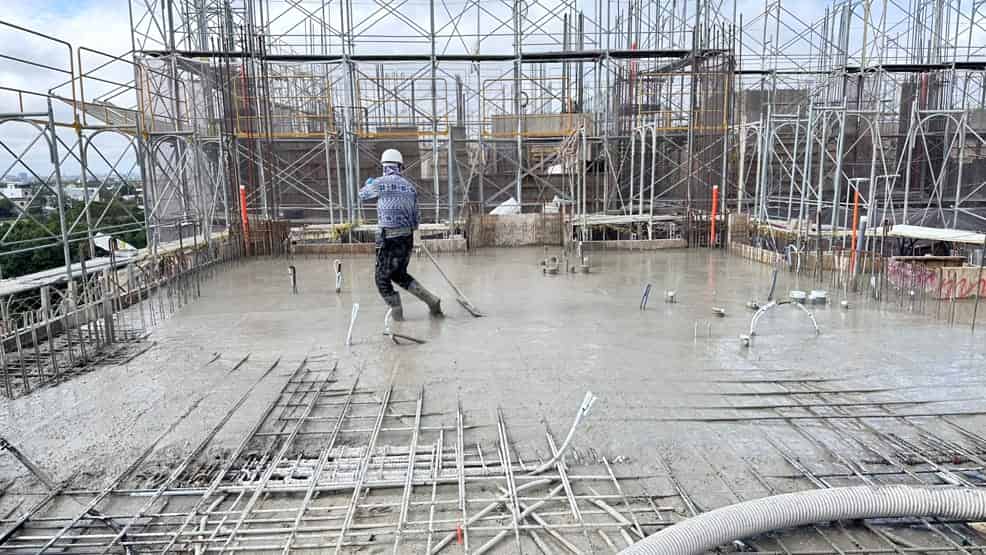

2023/01 5FL concrete pouring -

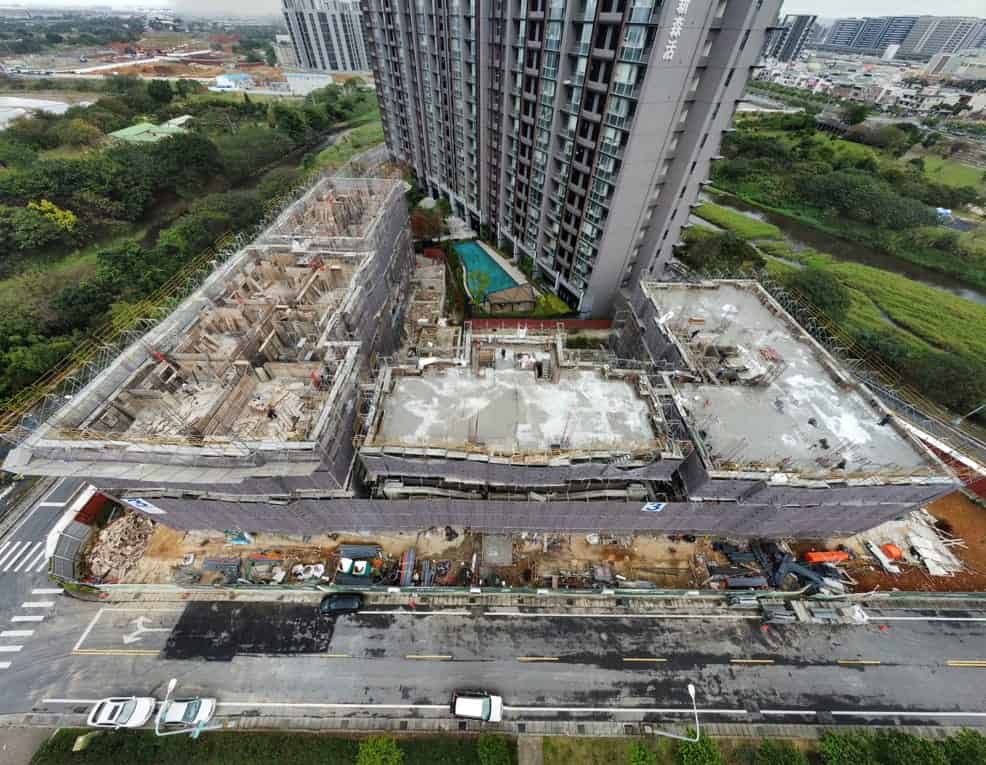

2023/01 5FL aerial grouting -

2023/01 5FL empty photo -

2023/01 5FL steel bar binding
-
-
02
2023
-

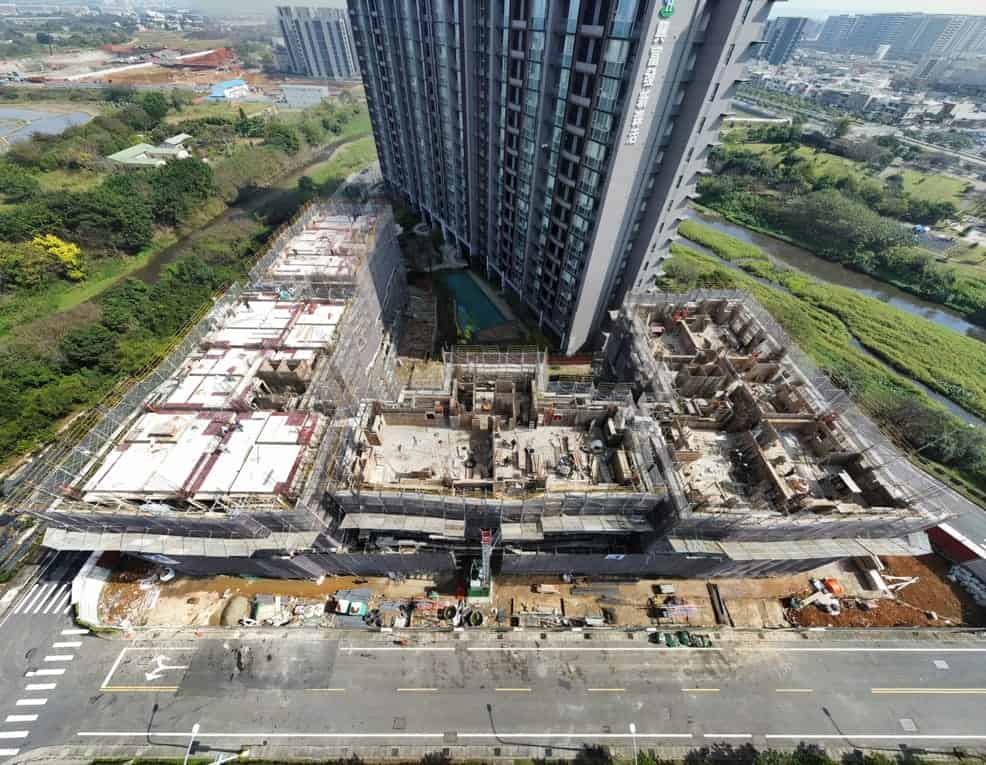

2023/02 7FL panoramic -

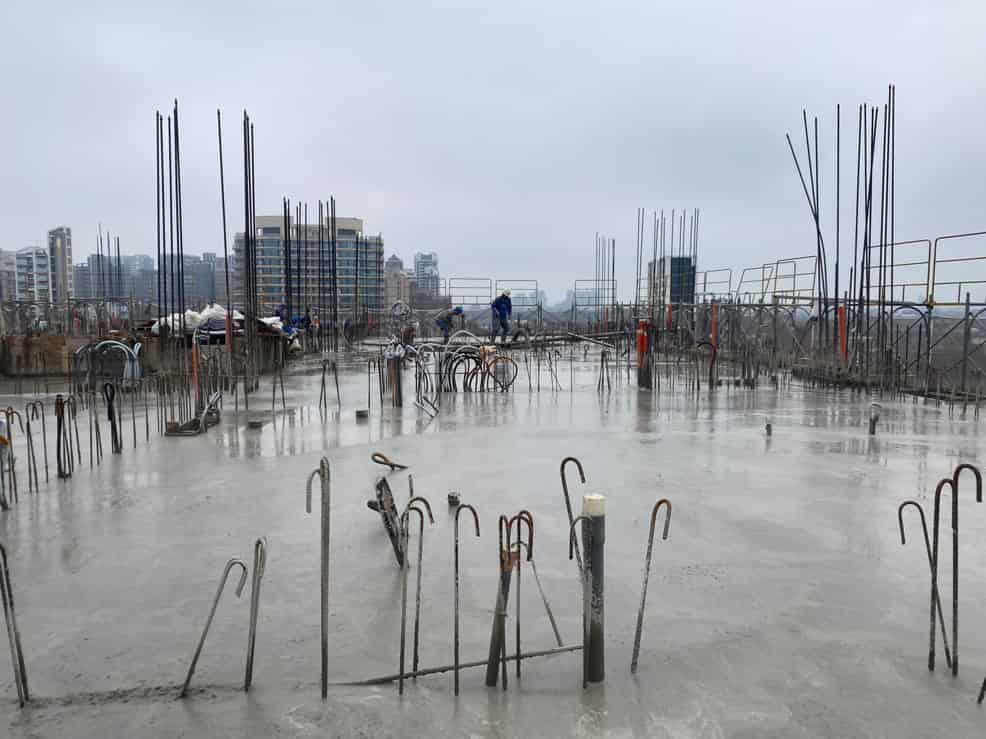

2023/02 7FL grouting -

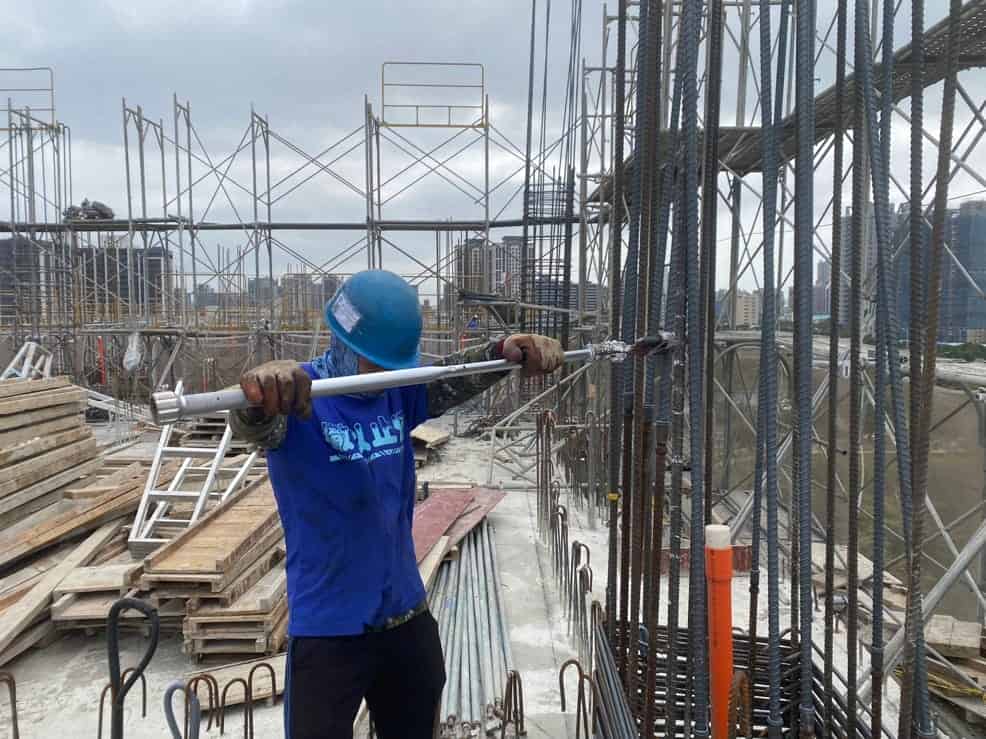

2023/02 7F column continuation inspection
-
-
03
2023
-

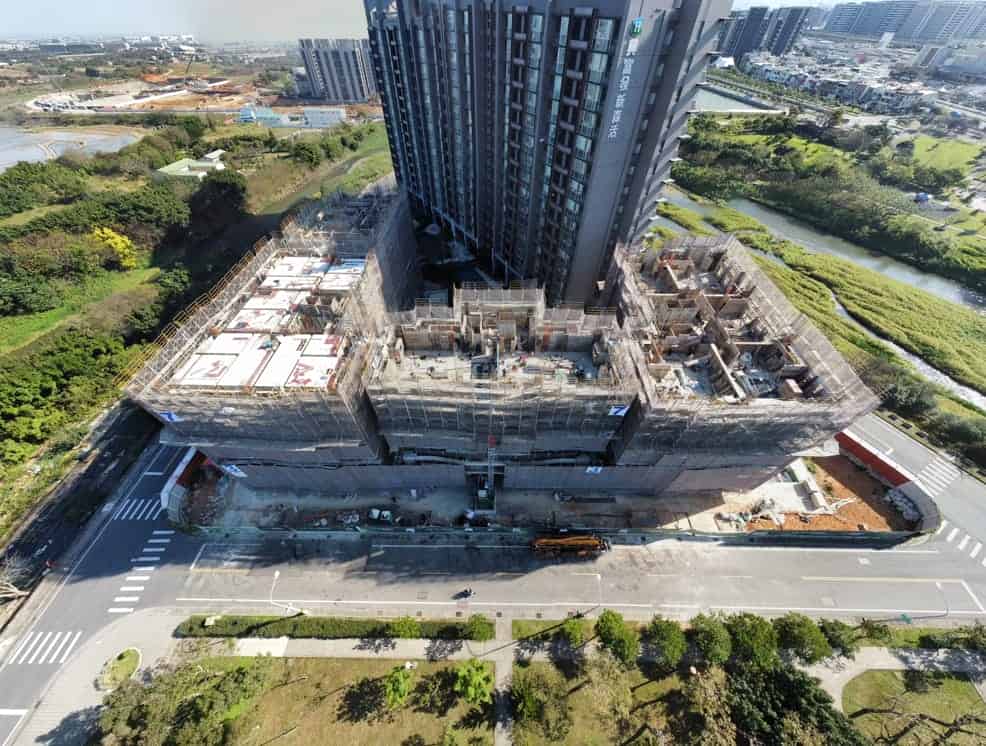

2023/03 8FL panoramic -

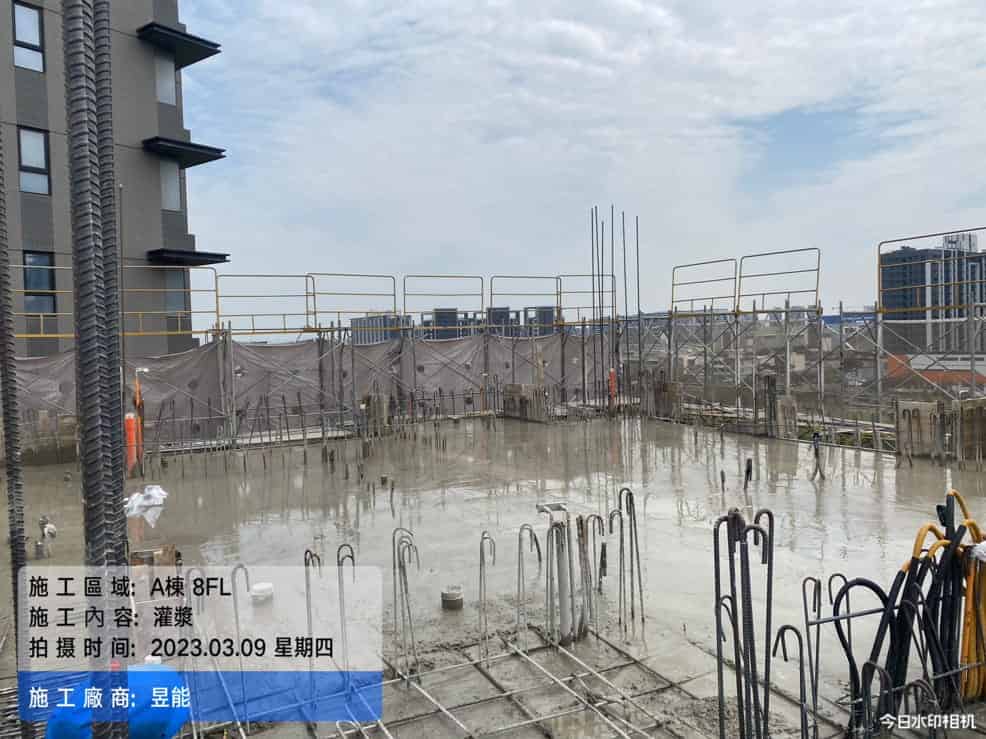

2023/03 8FL grouting -

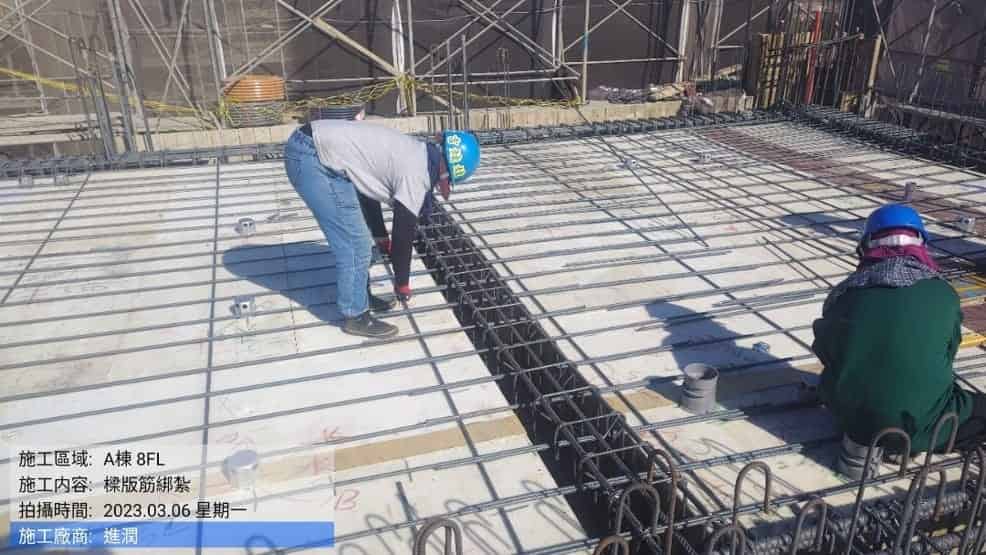

2023/03 8FL steel bar binding
-
-
04
2023
-

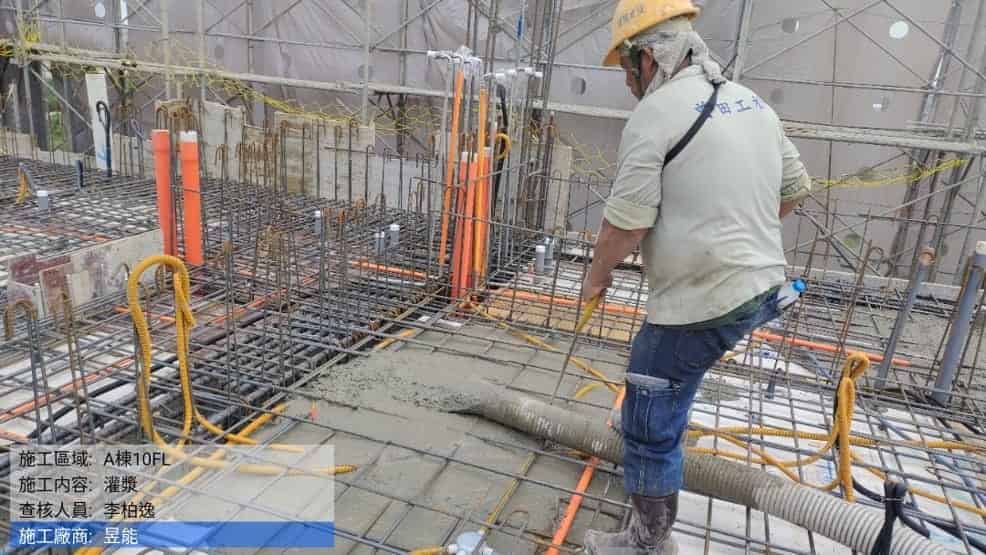

2023/04 10FL grouting operation -

2023/04 Inspection of 10F column reinforcement connection
-
-
05
2023
-

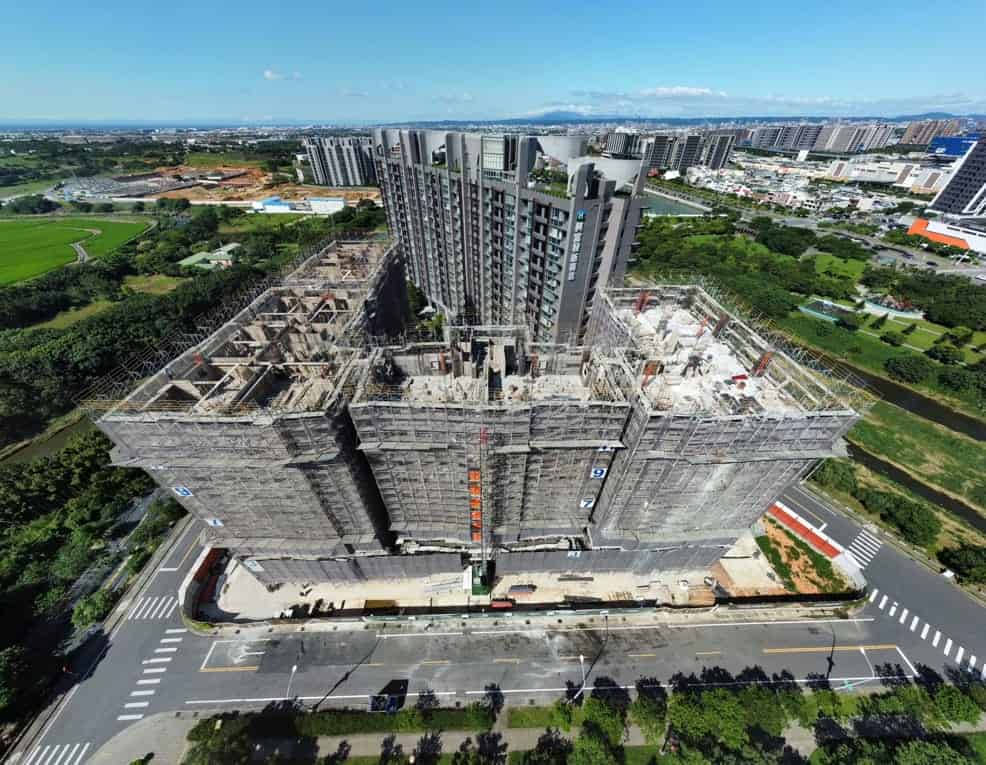

2023/05 12FL panoramic -

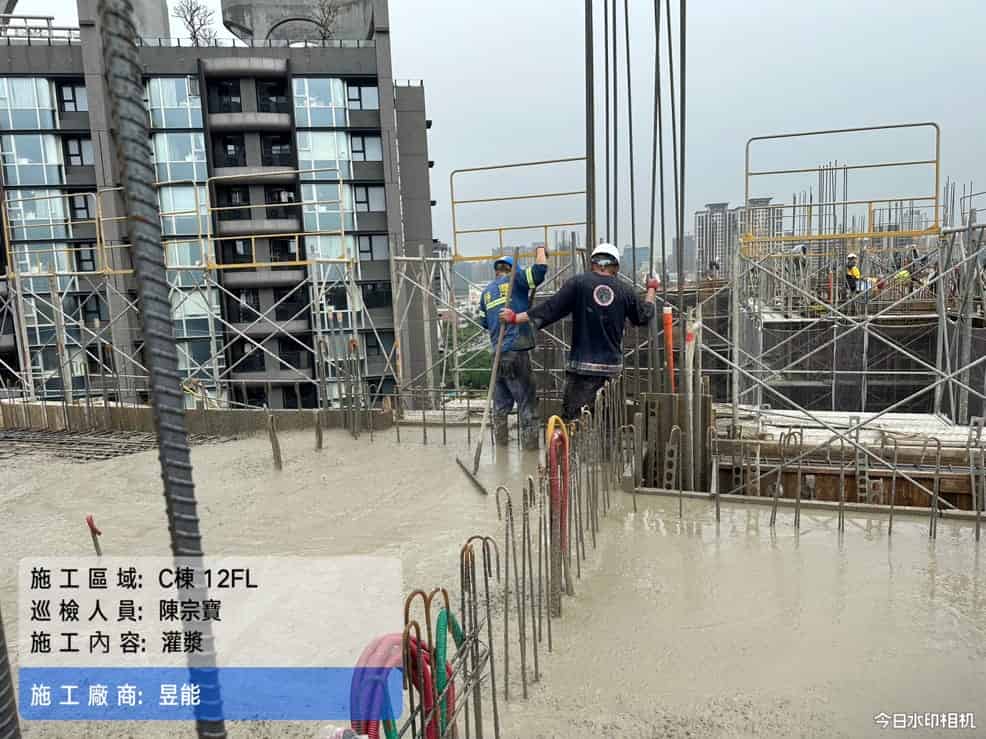

2023/05 12FL grouting operation -

2023/05 12F column connection inspection
-
-
06
2023
-

2023/06 13FL Grouting -

2023/06 3F light partition construction -

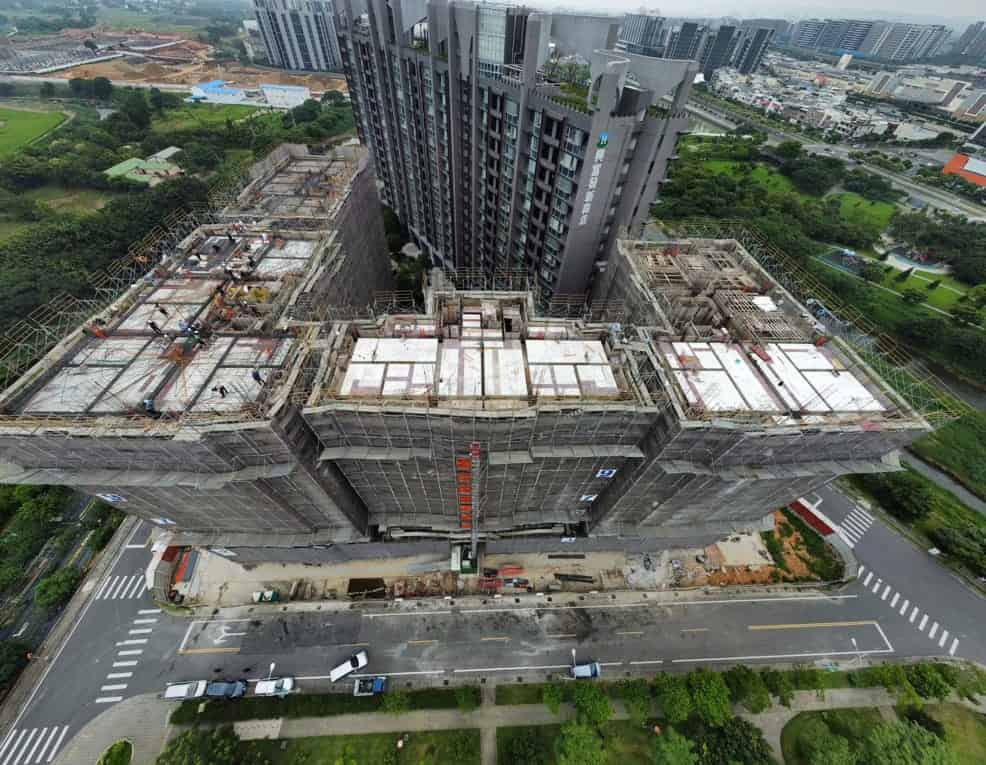

2023/06 Aerial shot
-
-
07
2023
-

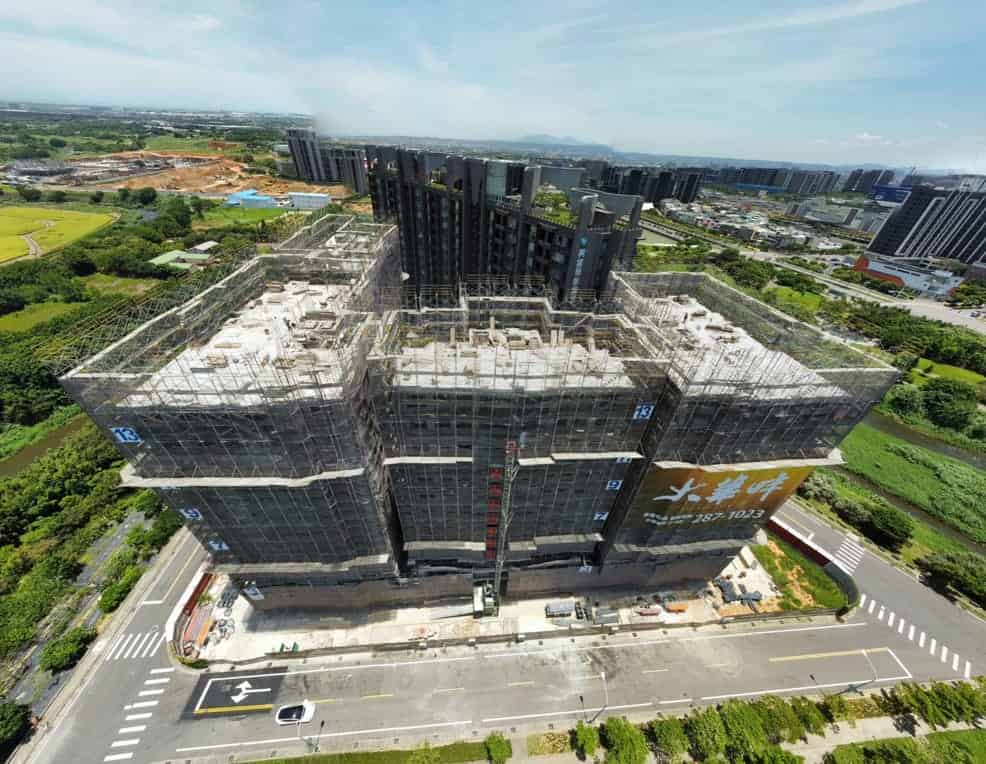

2023/07 14FL grouting completed -

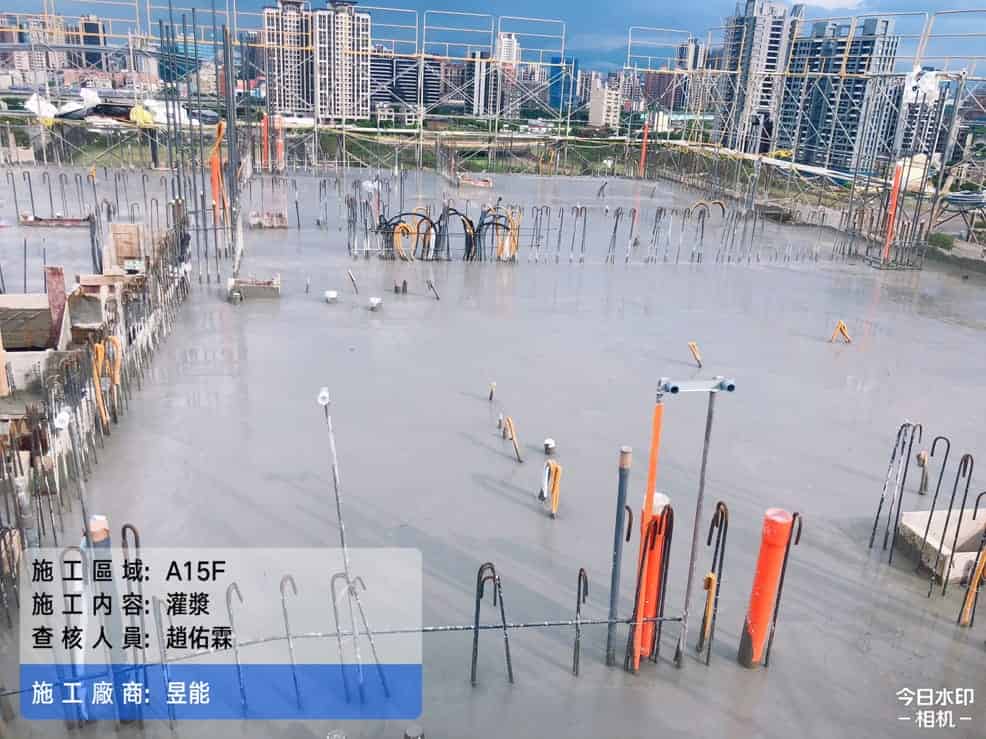

2023/07 15FL grouting completed -

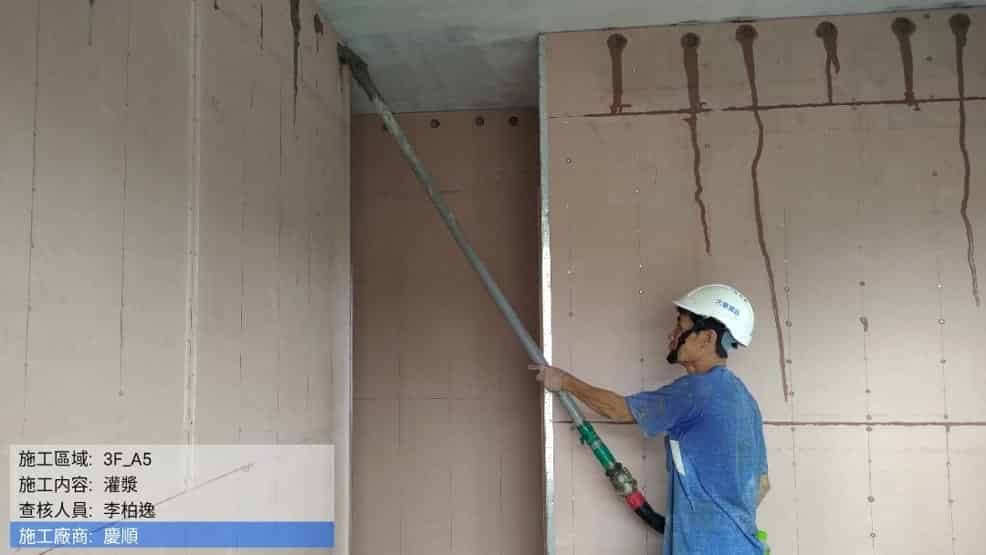

2023/07 2-3F indoor light partition grouting
-
-
08
2023
-

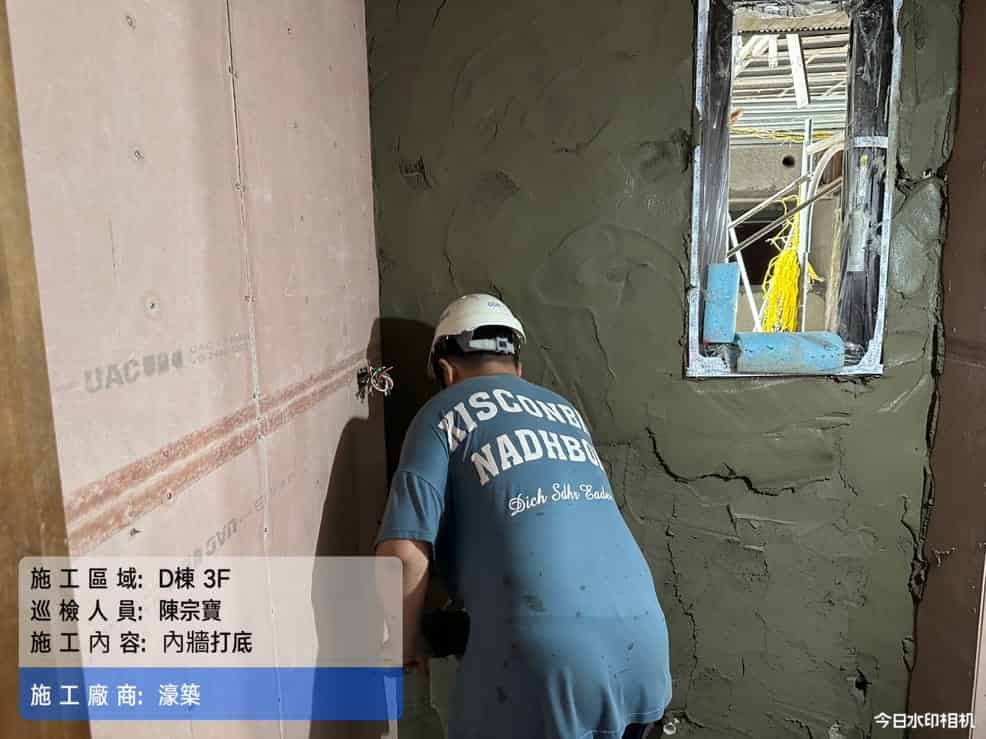

2023/08 3F mud construction -

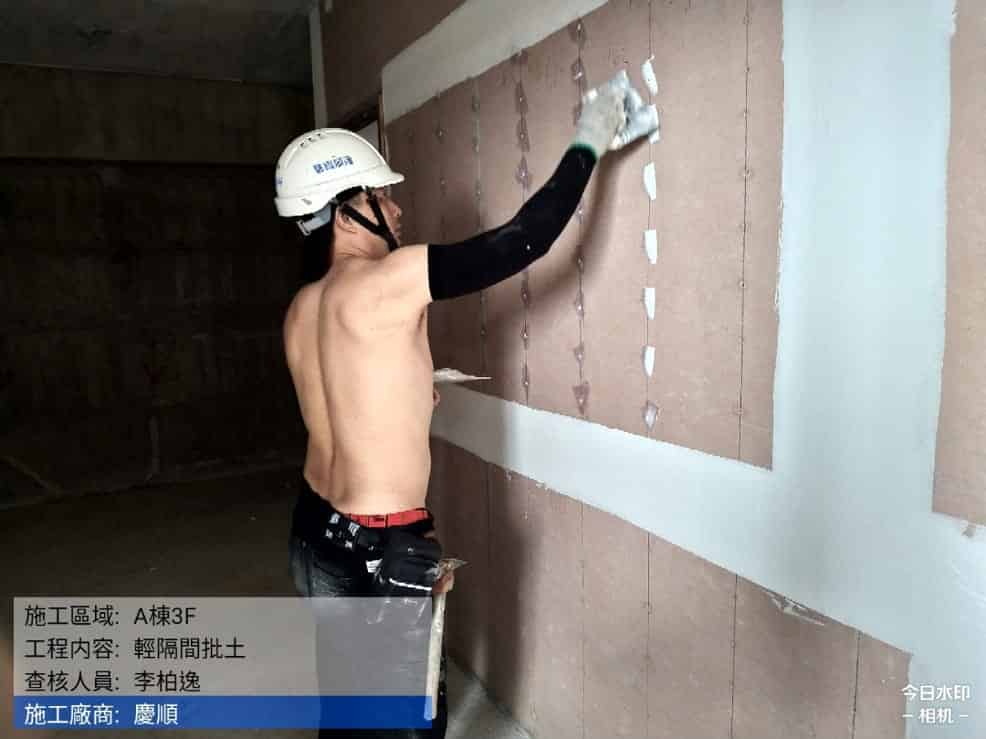

2023/08 3F light compartment soil removal operation -

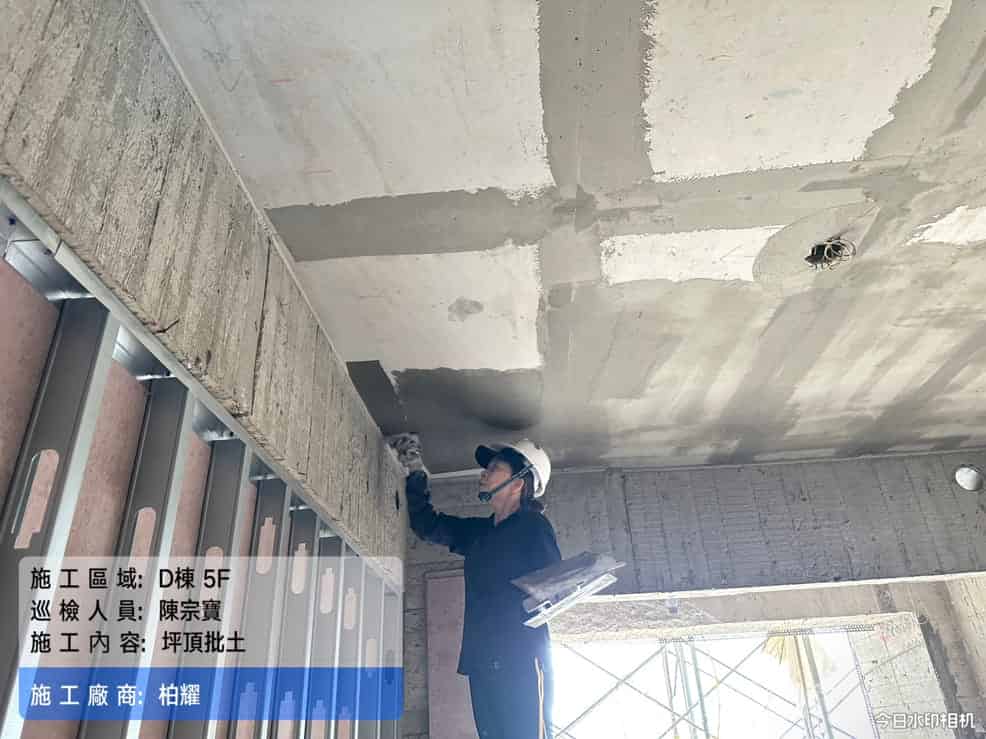

2023/08 5F ceiling soil removal operation
-
-
09
2023
-

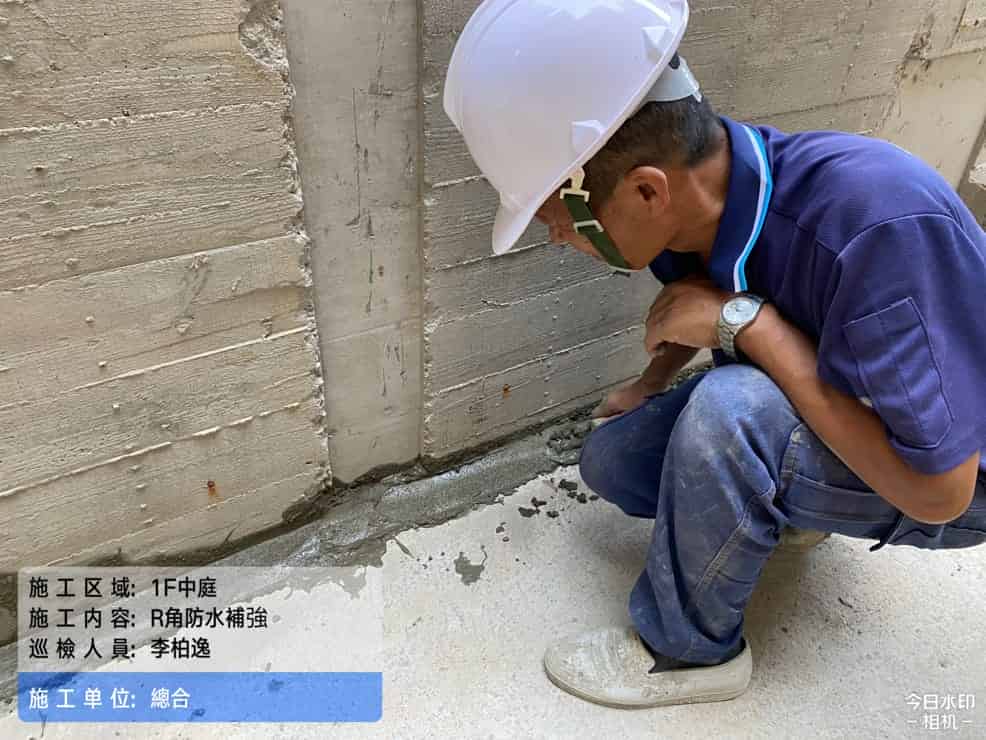

2023/09 1F atrium waterproof -

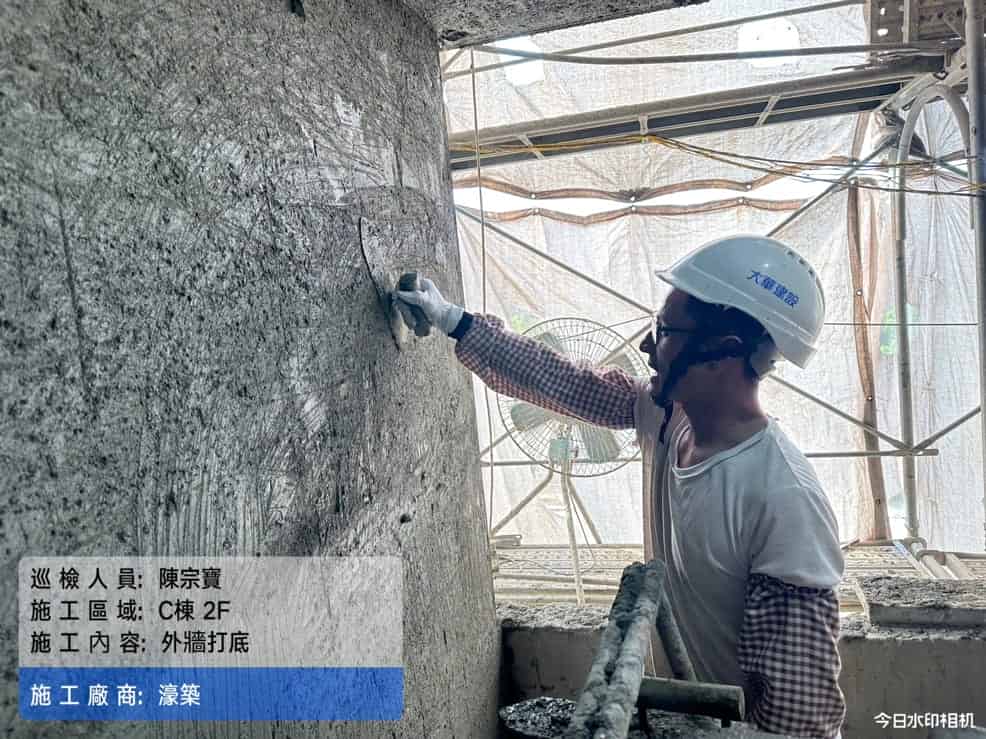

2023/09 2F exterior wall mud construction -

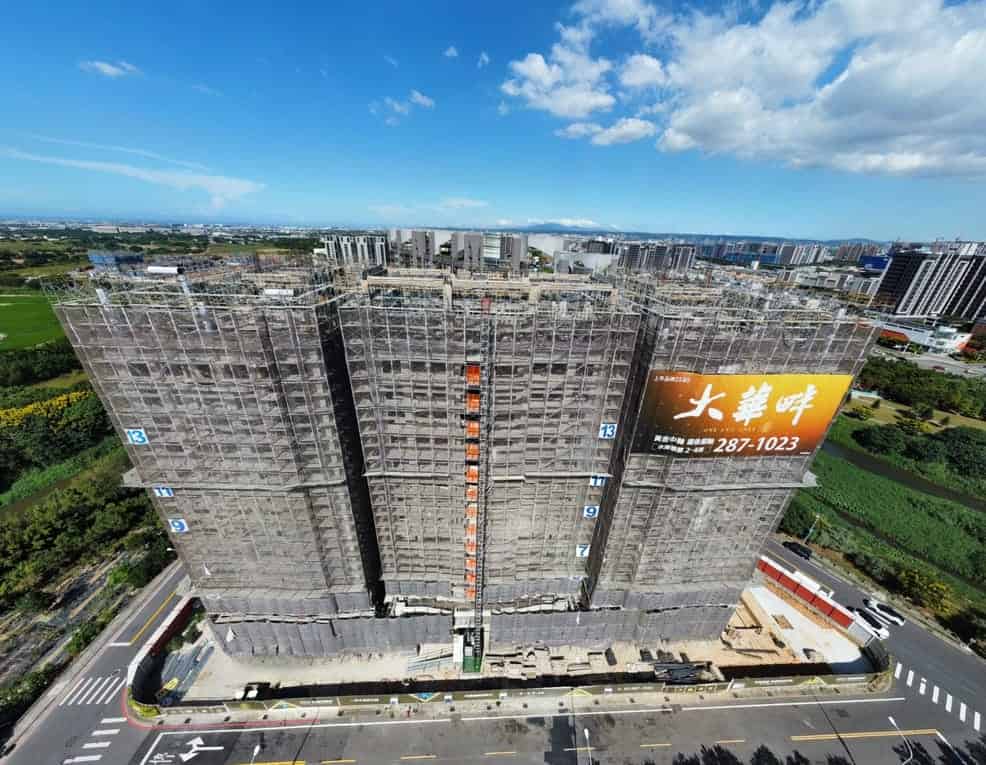

2023/09 facade
-
-
10
2023
-

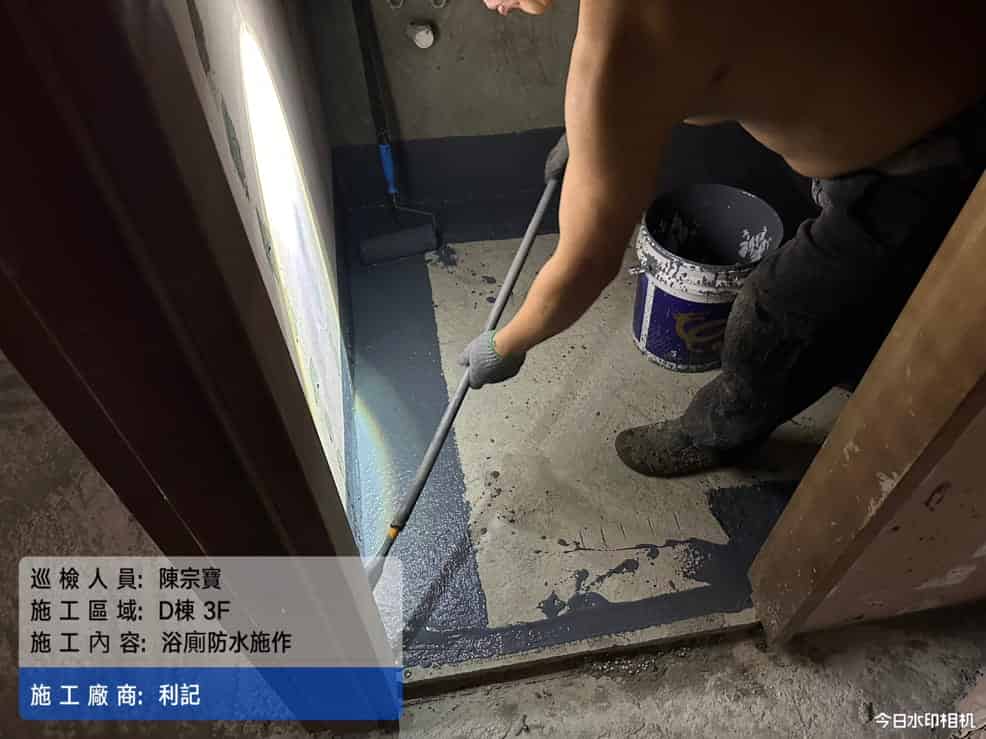

2023/10 Waterproofing of 3F bathroom and toilet -

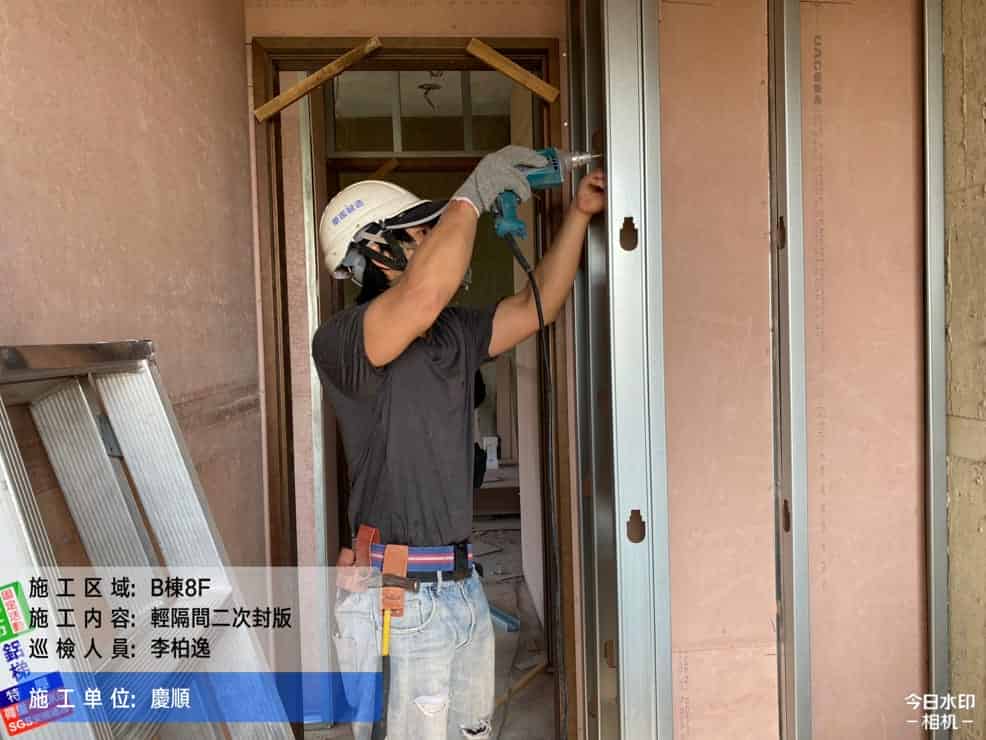

2023/10 8F indoor light partition -

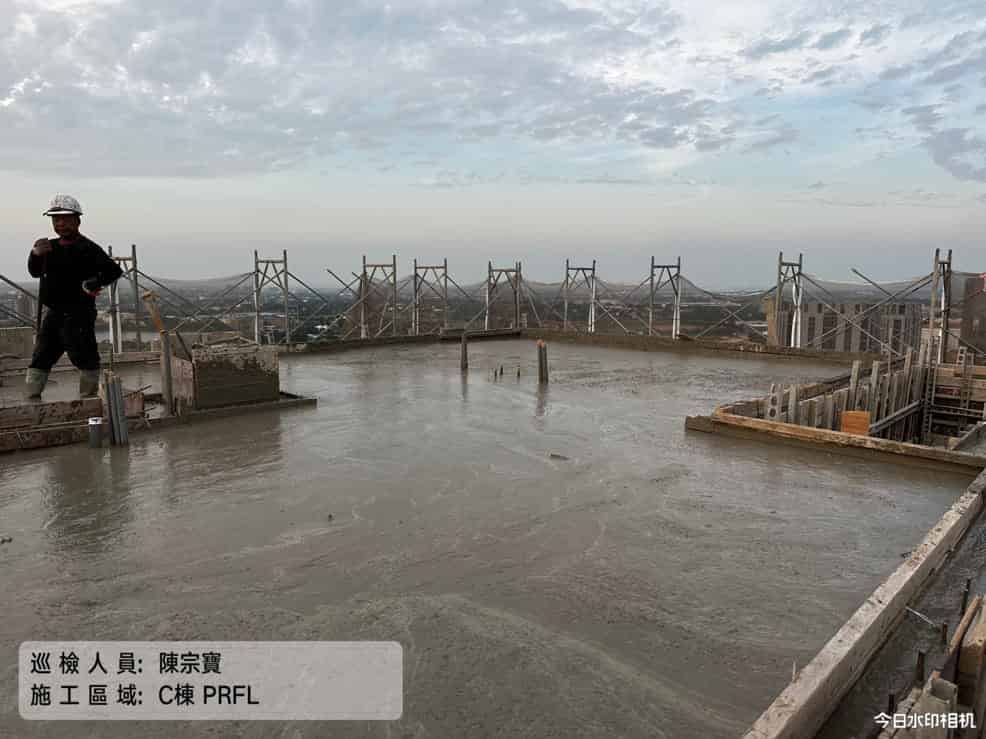

2023/10 Pouring of roof outburst layer
-
-
11
2023
-

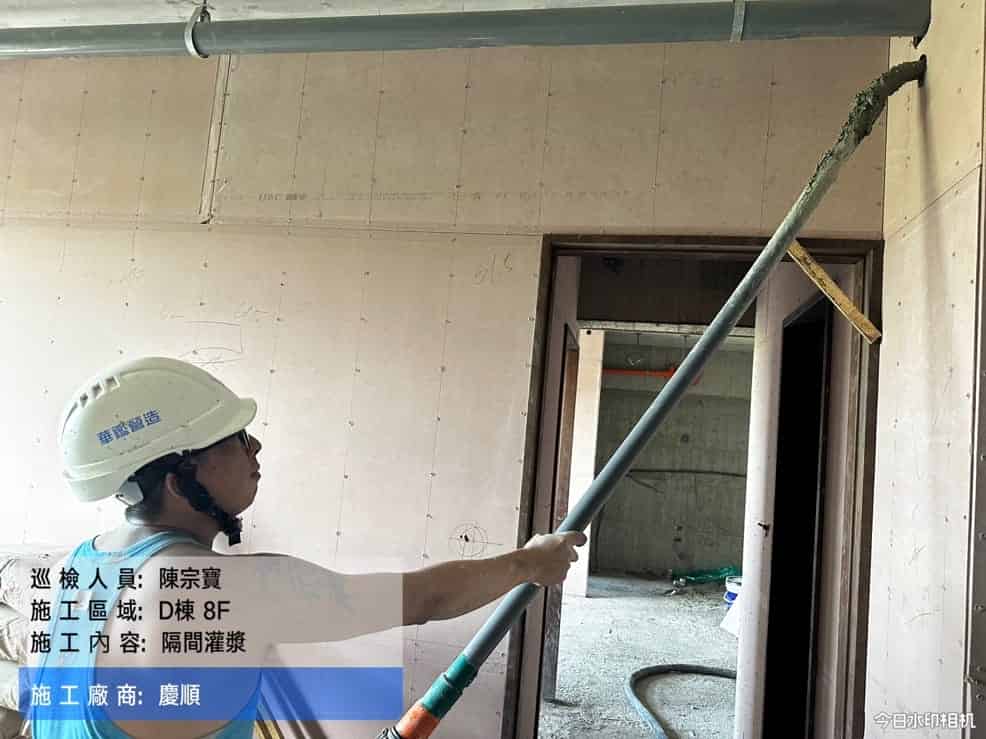

2023/11 8F light compartment grouting -

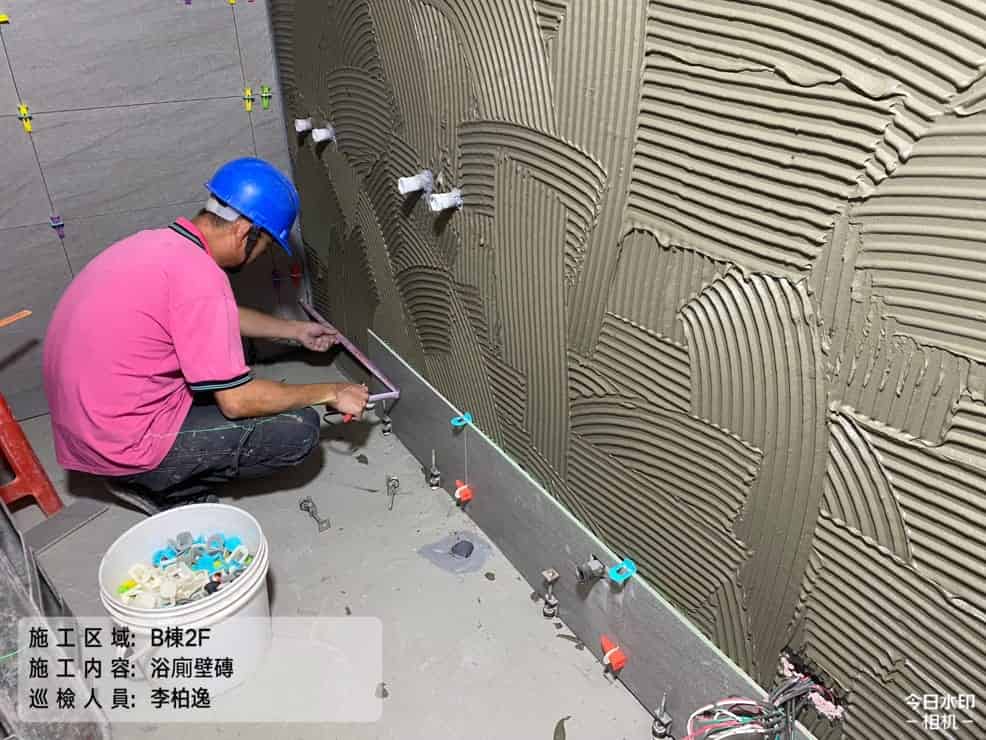

2023/11 Bathroom wall tiles on 2F, Building B -

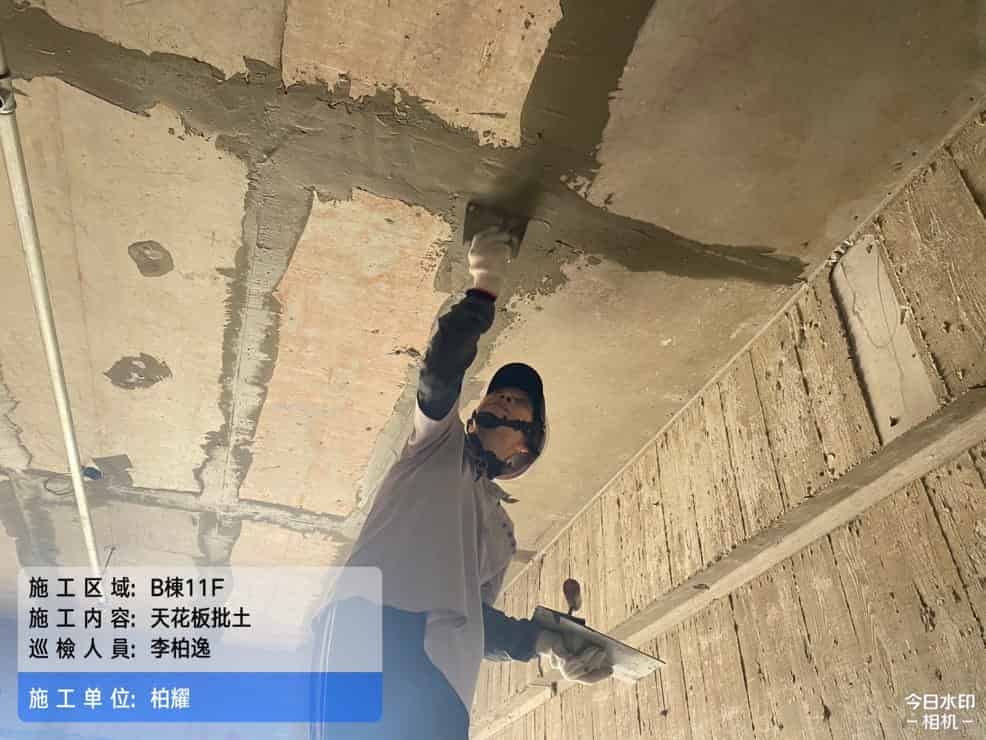

2023/11 11F ceiling flat roof soil removal
-
-
12
2023
-

2023/12 Tile paving in the 2F staircase hall of Building B -

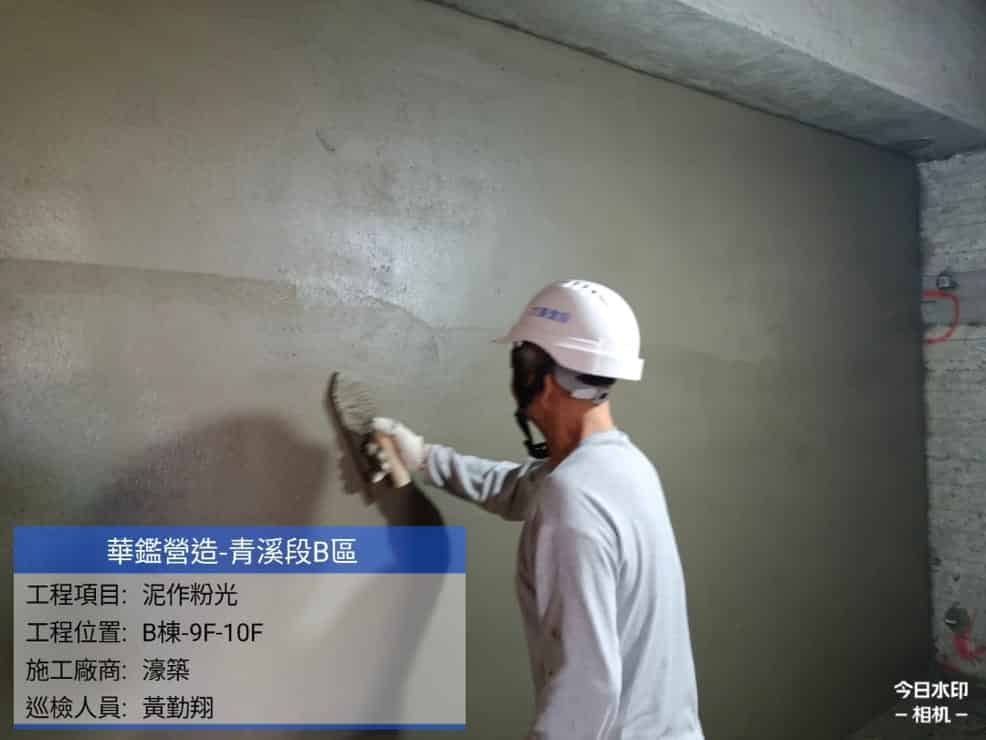

2023/12 8-9F indoor building B, painted with mud -

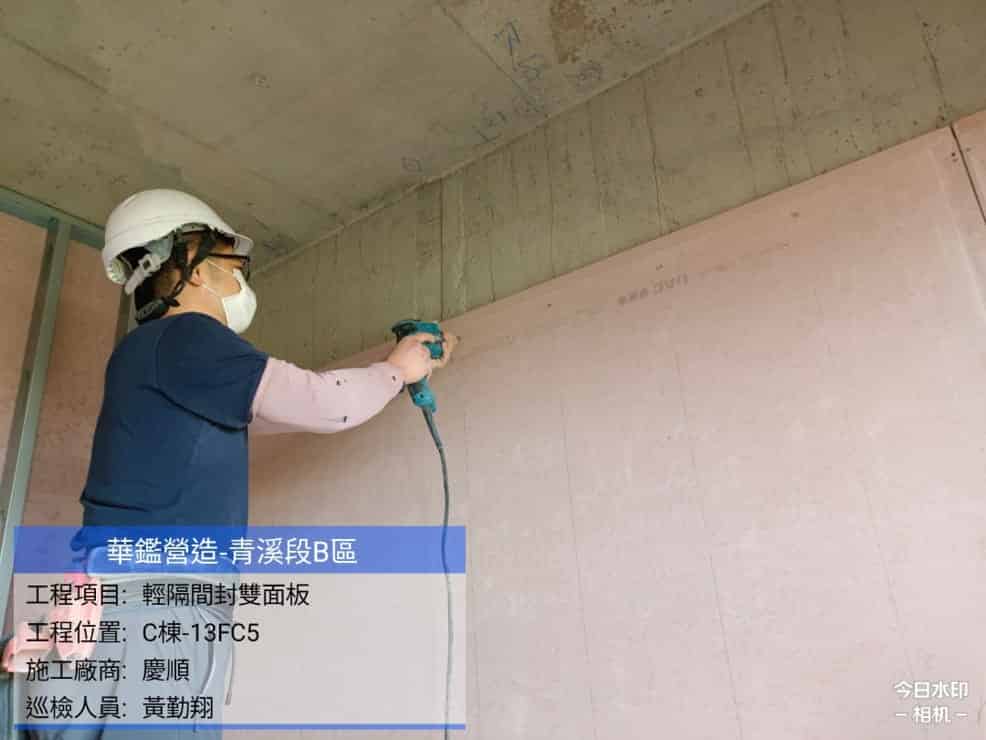

2023/12 Light partition sealing board on 13F, Building C
-
-
01
2024
-
2024/01 1F Stone Construction -

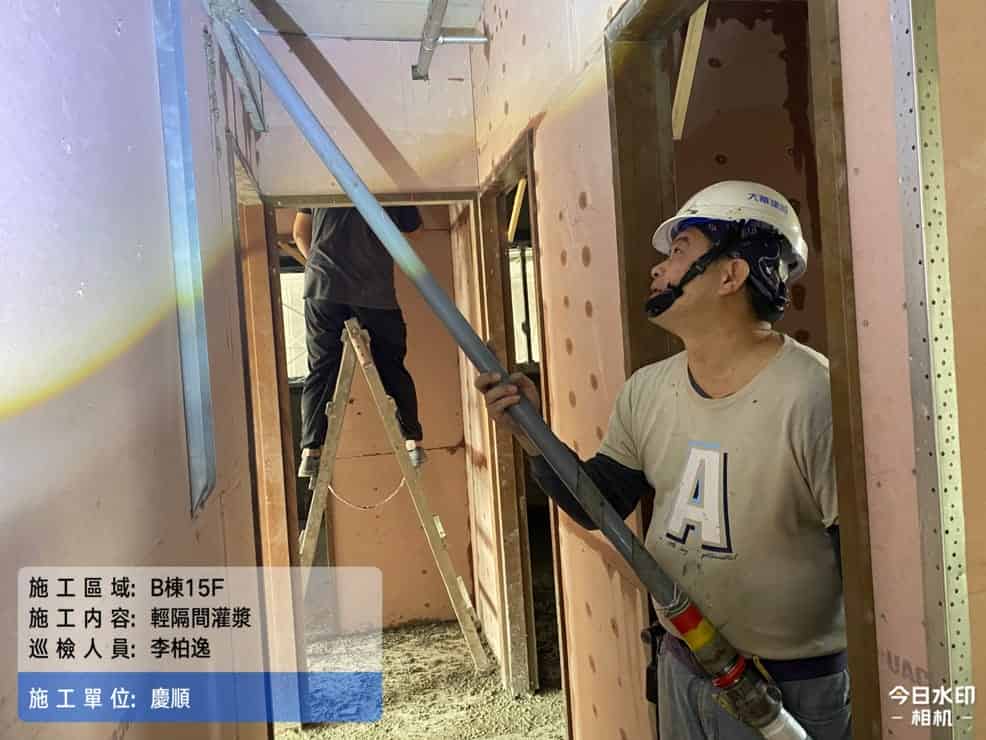

2024/01 Building B 15F light compartment grouting -

2024/01 Building B 4F staircase hall wall lamp and ceiling installation
-
-
02
2024
-

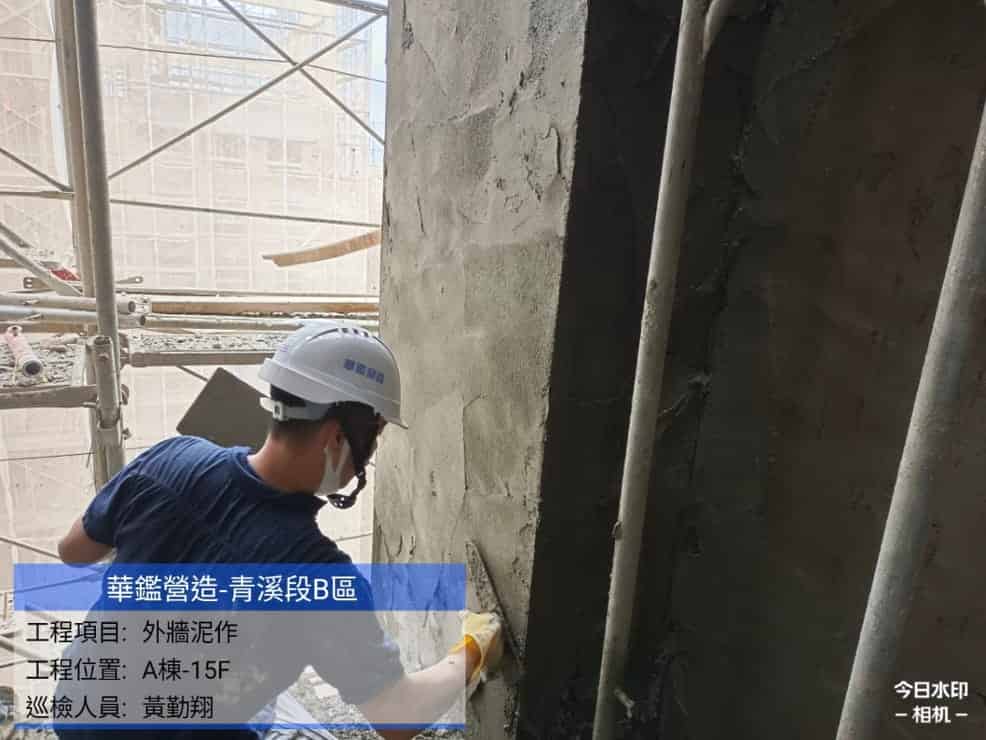

2024/02 Exterior wall mud on 15F of Building A -

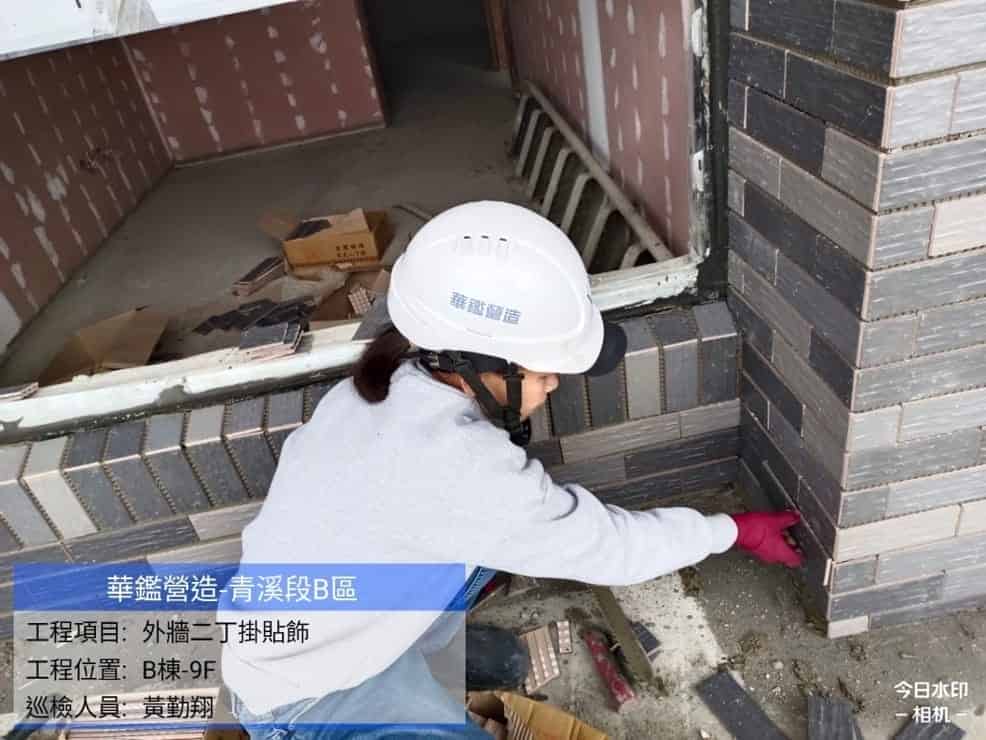

2024/02 Second wall hanging paving on 9F, Building B -

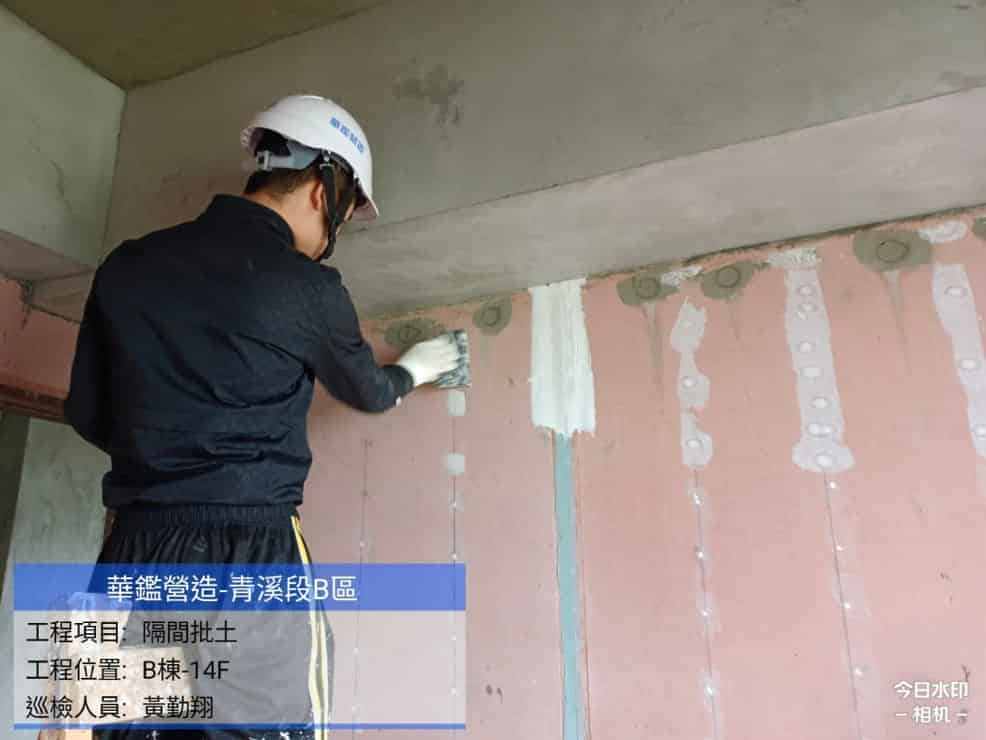

2024/02 B Building 14F light compartment soil plowing
-
-
03
2024
-

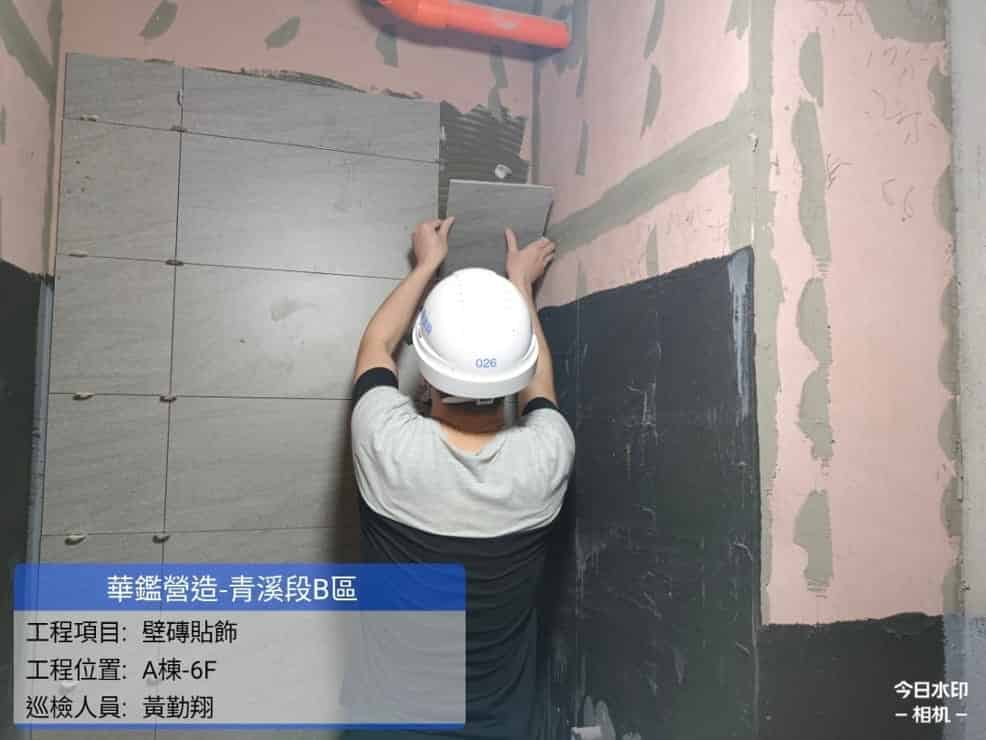

2024/03 Tile paving of interior walls on 6F of Building A -

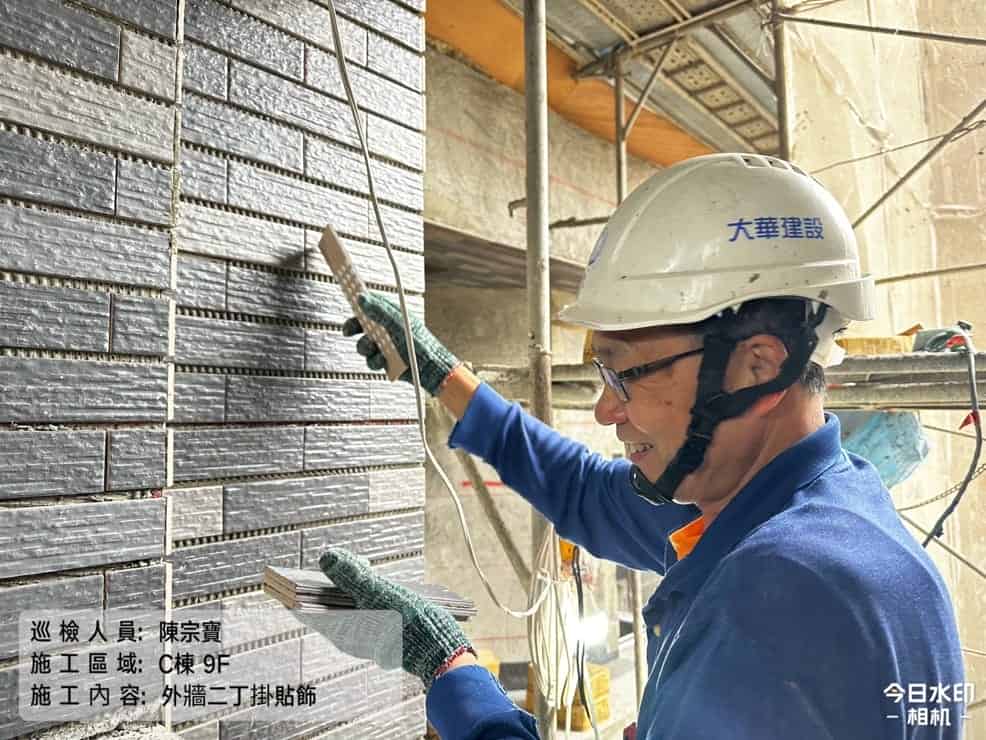

2024/03 2D hanging paving on the exterior wall of 9F, Building C -

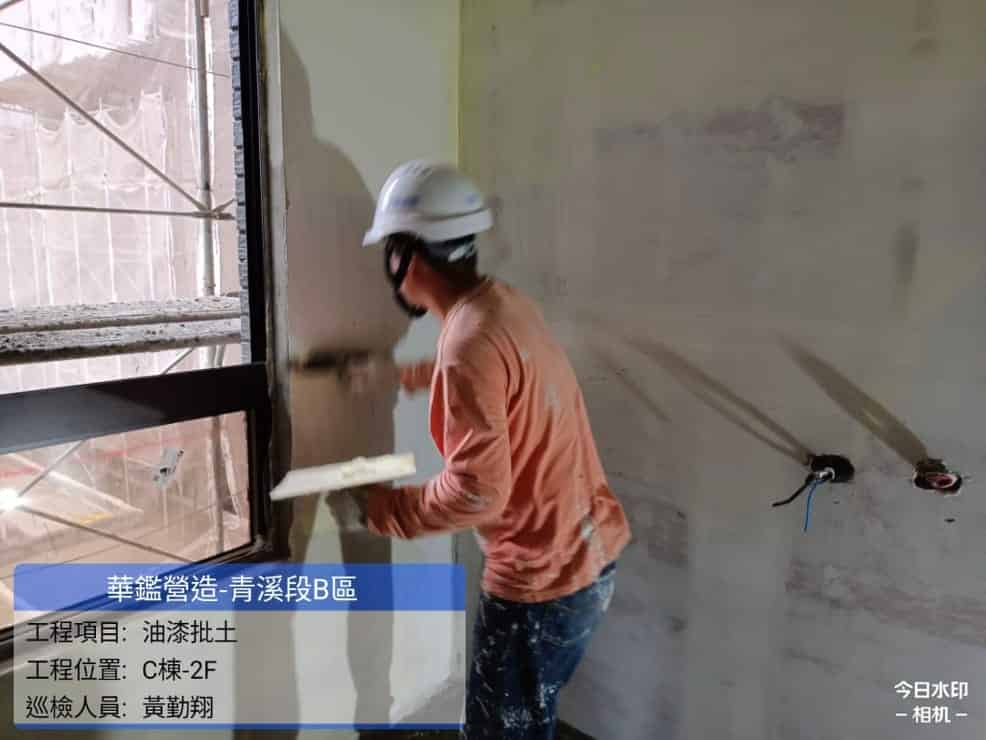

2024/03 Building C interior wall paint and soil application
-
-
04
2024
-

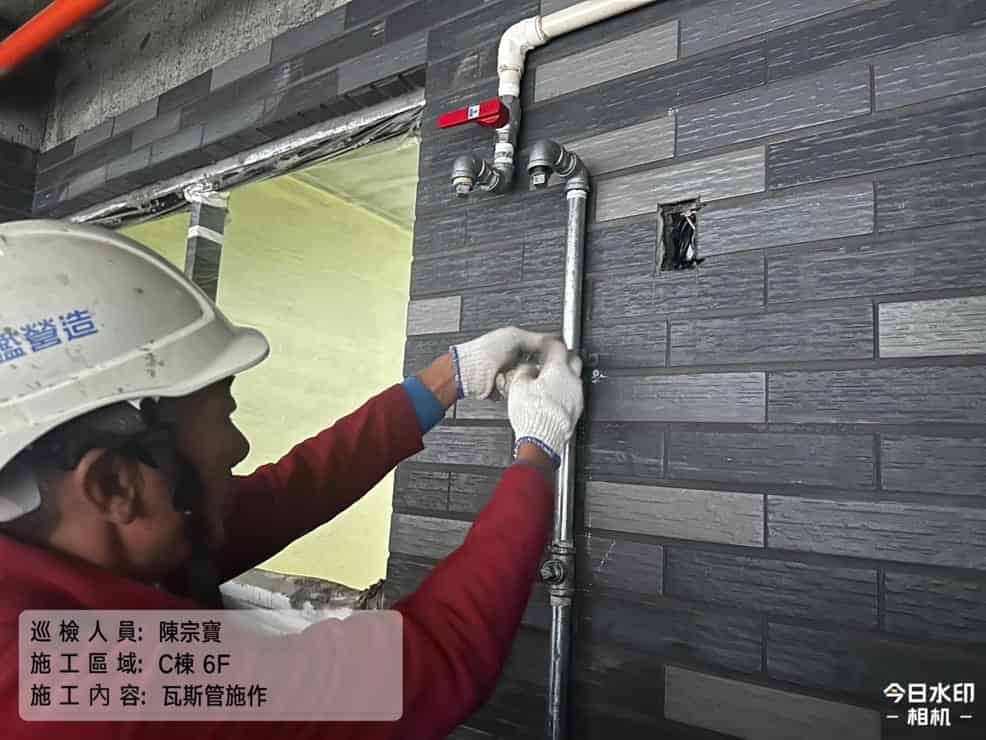

2024/04 Construction of 6F indoor gas branch pipe -

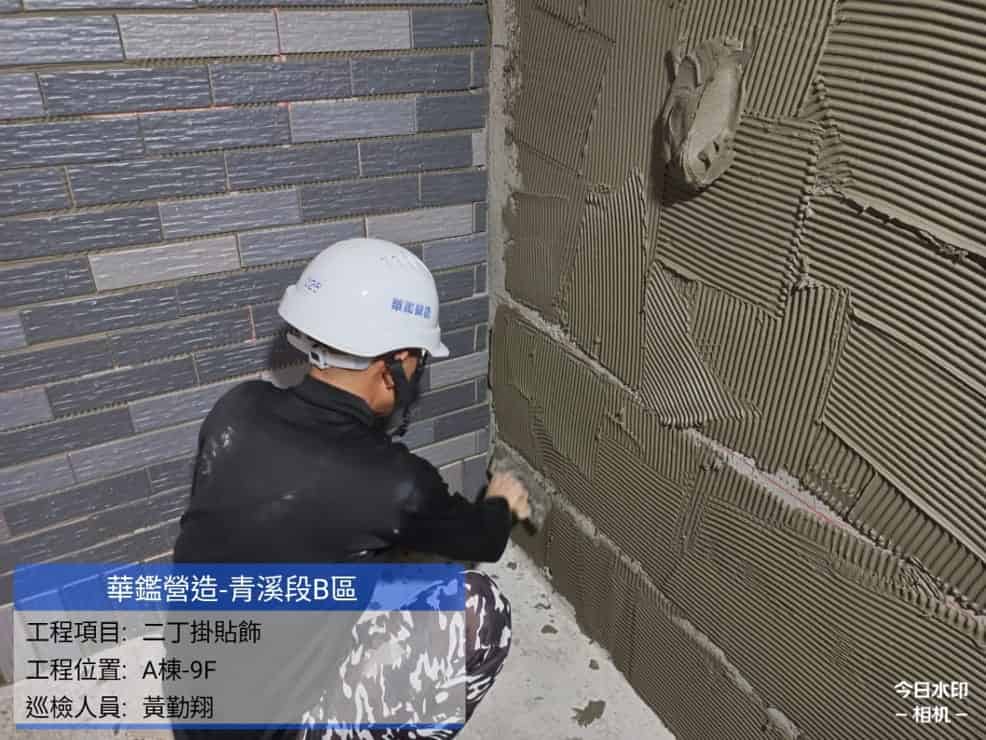

2024/04 9F rear balcony 2-inch hanging paving -

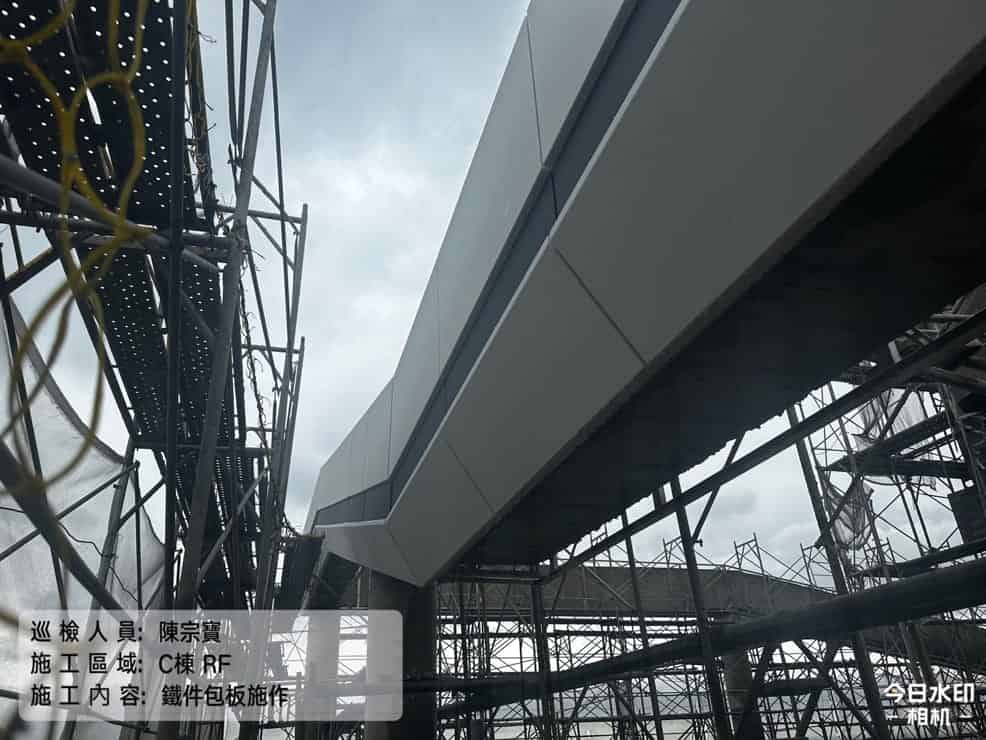

2024/04 Construction of roof iron parts
-
-
05
2024
-

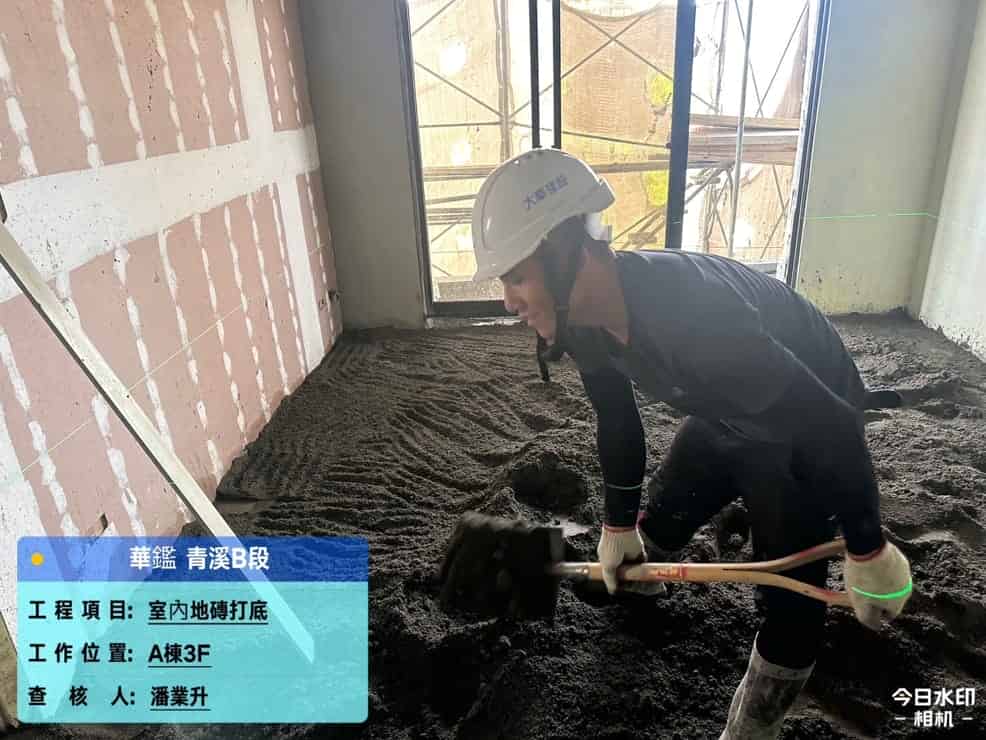

2024/05 3F indoor floor primer -

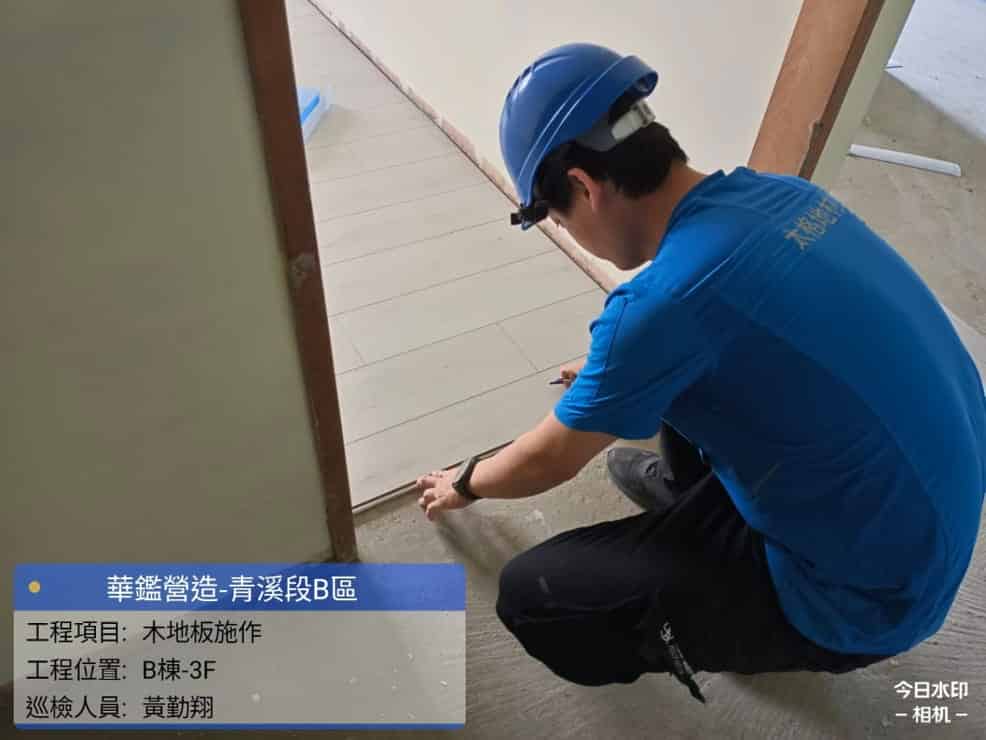

2024/05 3F indoor wooden floor construction -

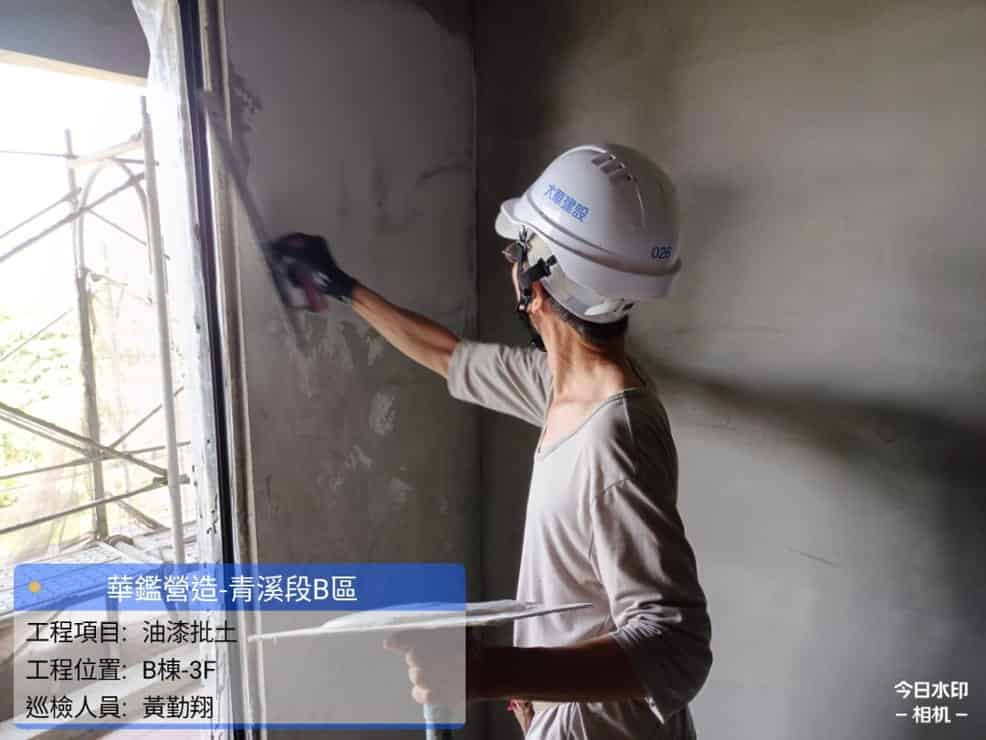

2024/05 3F indoor paint batching
-
-
06
2024
-

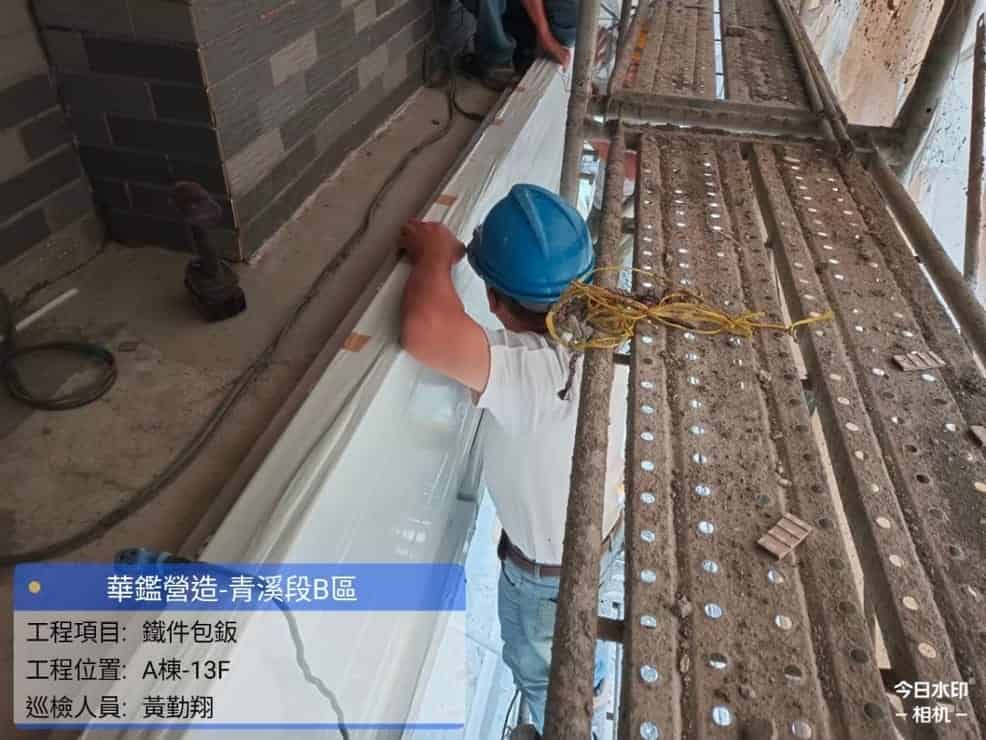

2024/06 Iron parts cladding on 13F of Building A -

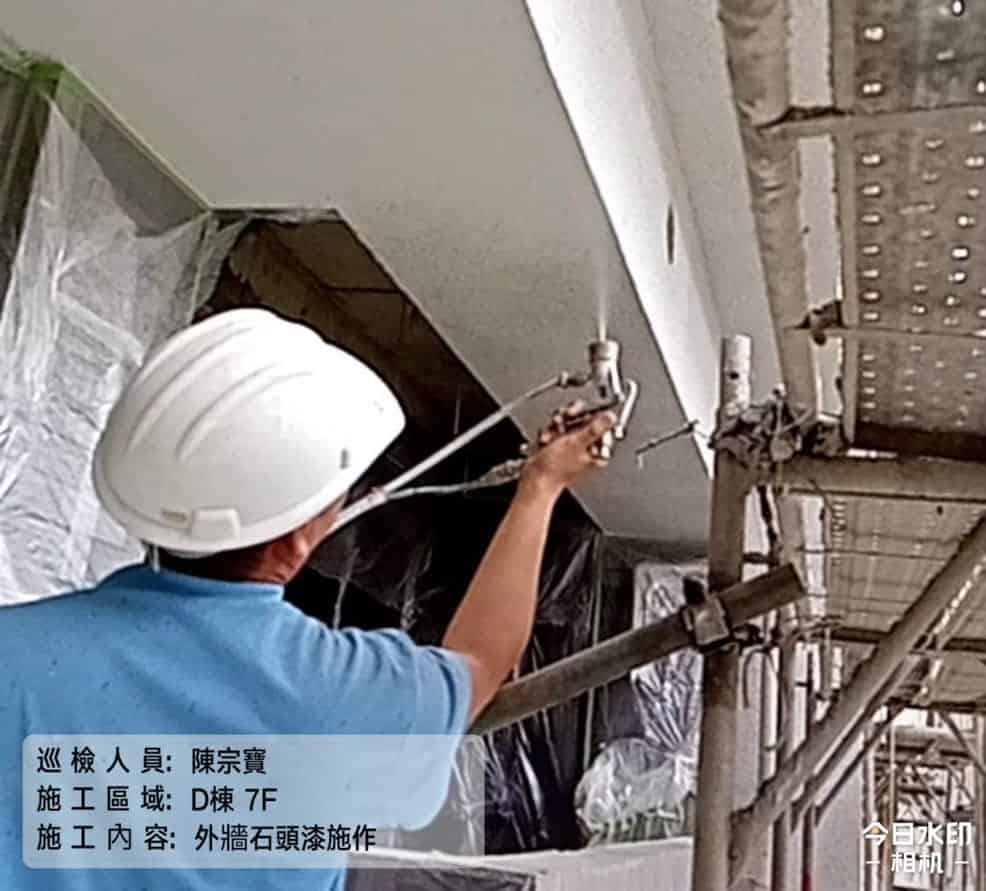

2024/06 Exterior wall imitation stone paint spray decoration on 7F, Building D
-
-
07
2024
-

2024/07 12F exterior wall of Building A -

2024/07 Indoor flooring on 7F, Building A -

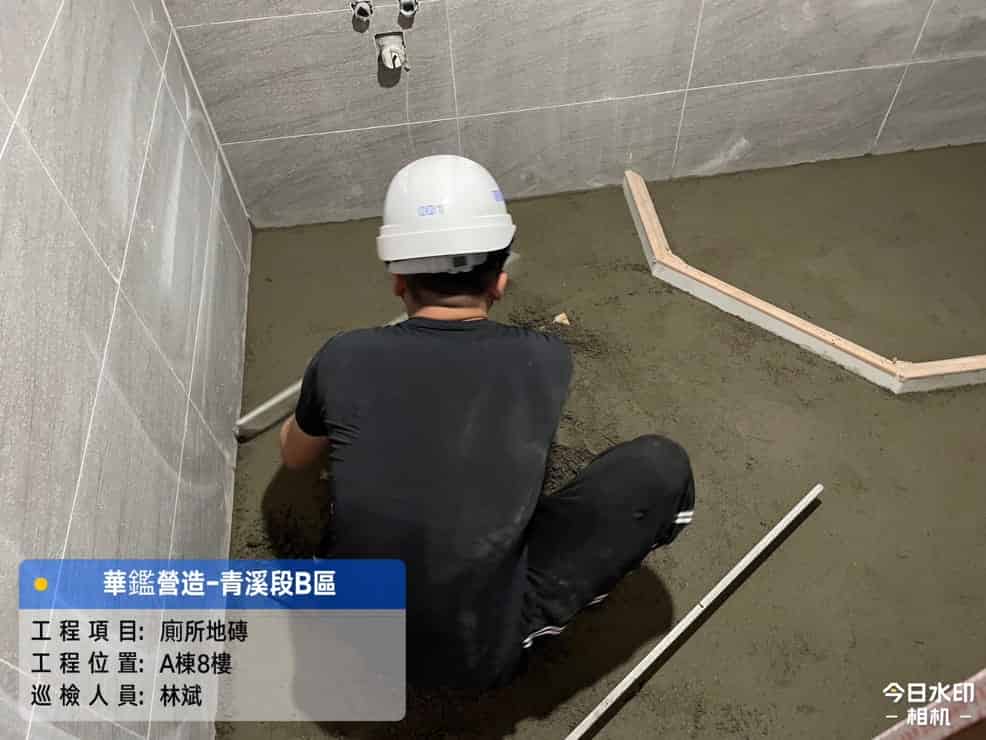

2024/07 The floor tiles in the toilet on 8F of Building A
-
-
08
2024
-

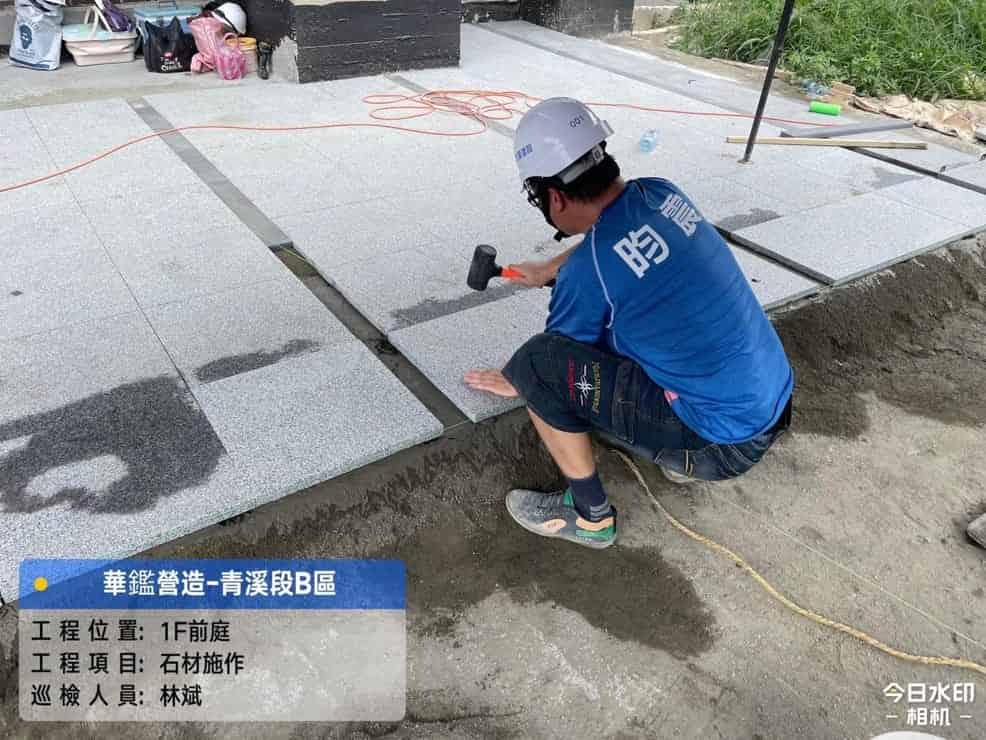

2024/08 1F vestibule floor stone paving -

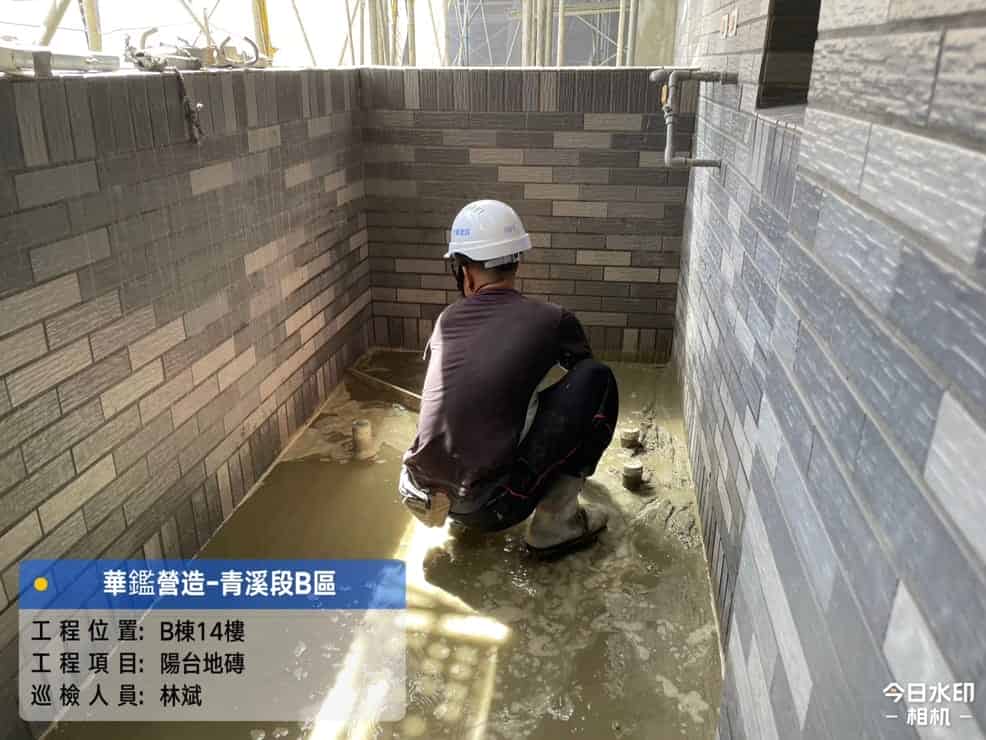

2024/08 Floor tiles on the 14F balcony of Building B -

2024/08 Flat roof wood sealing board on 15F of Building B -

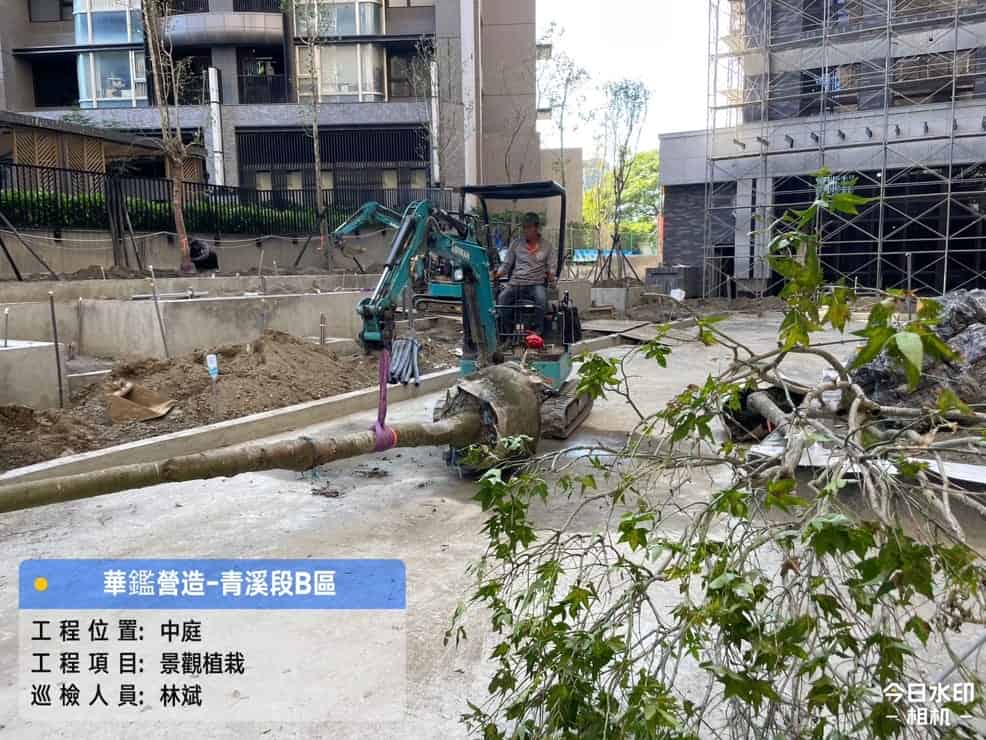

2024/08 Atrium landscape planting
-
-
09
2024
-

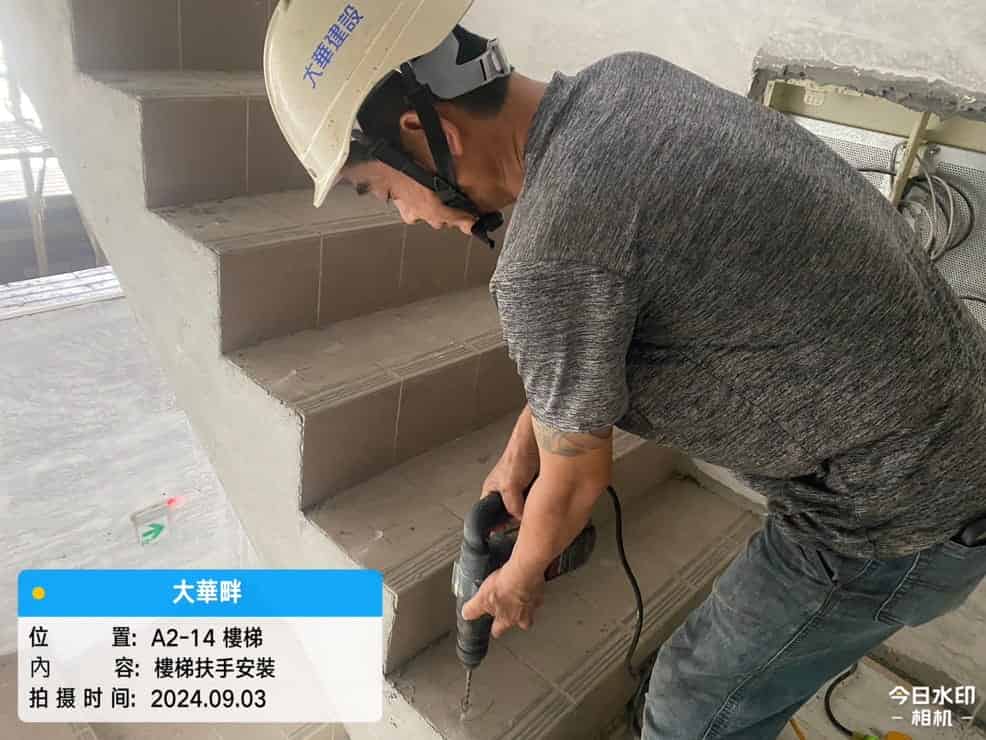

2024/09 Installation of staircase handrails on 14F in Building A -

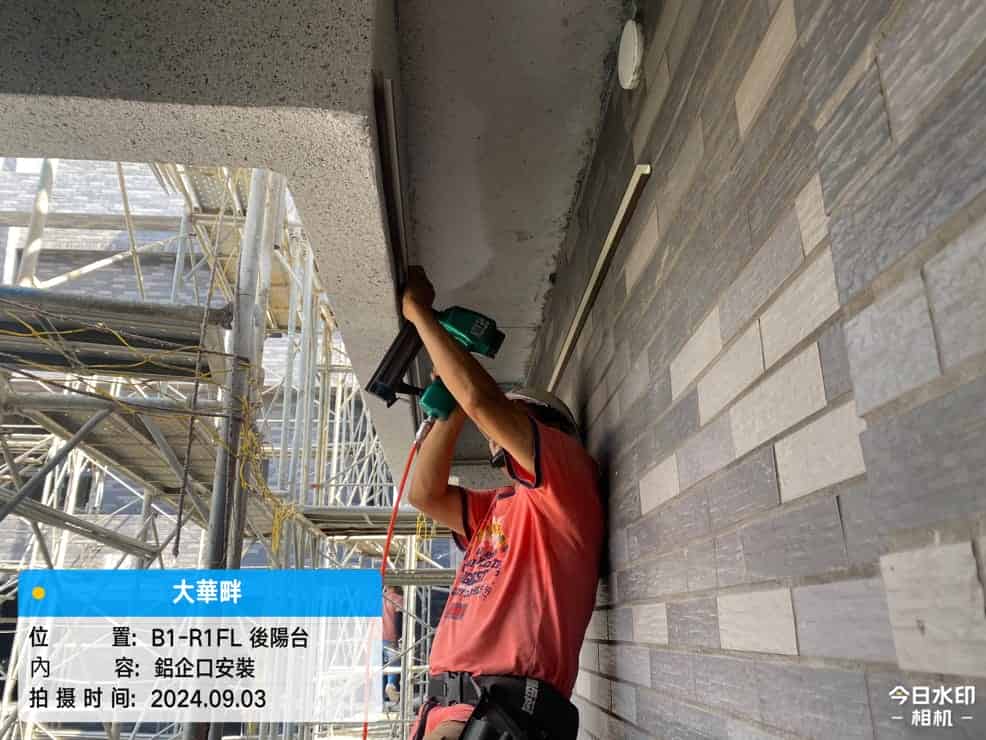

2024/09 Installation of 15F aluminum tongue and groove in Building B -

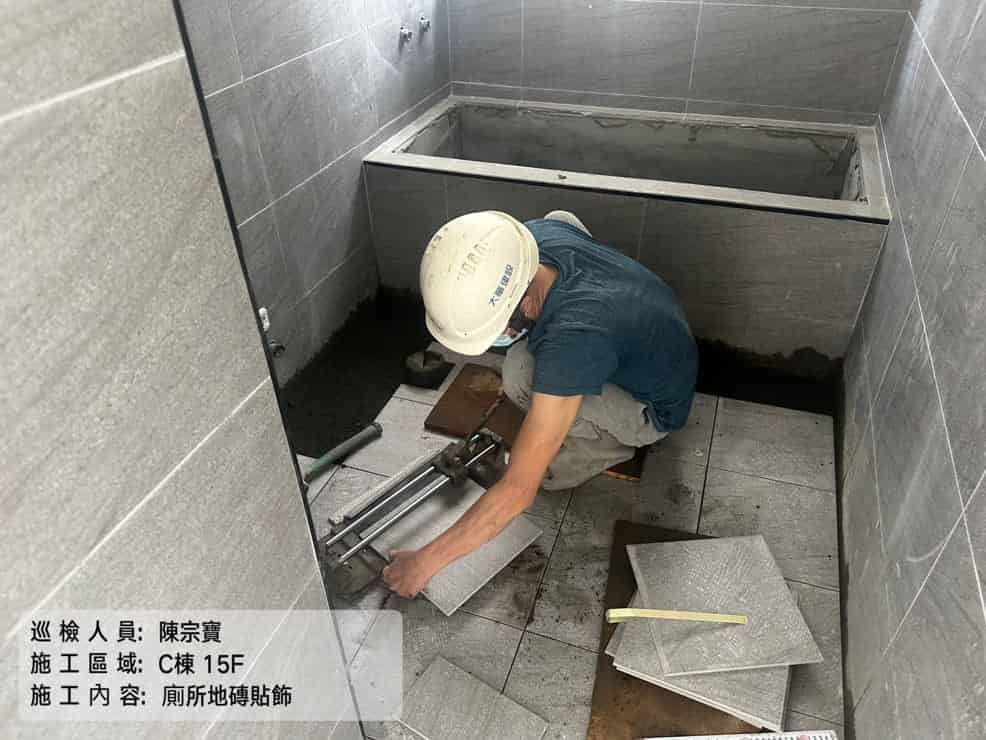

2024/09 Bathroom and toilet floor tiles on 15F, Building C -

2024/09 Floor tiles in the stair hall 13 of Building D
-
-
10
2024
-

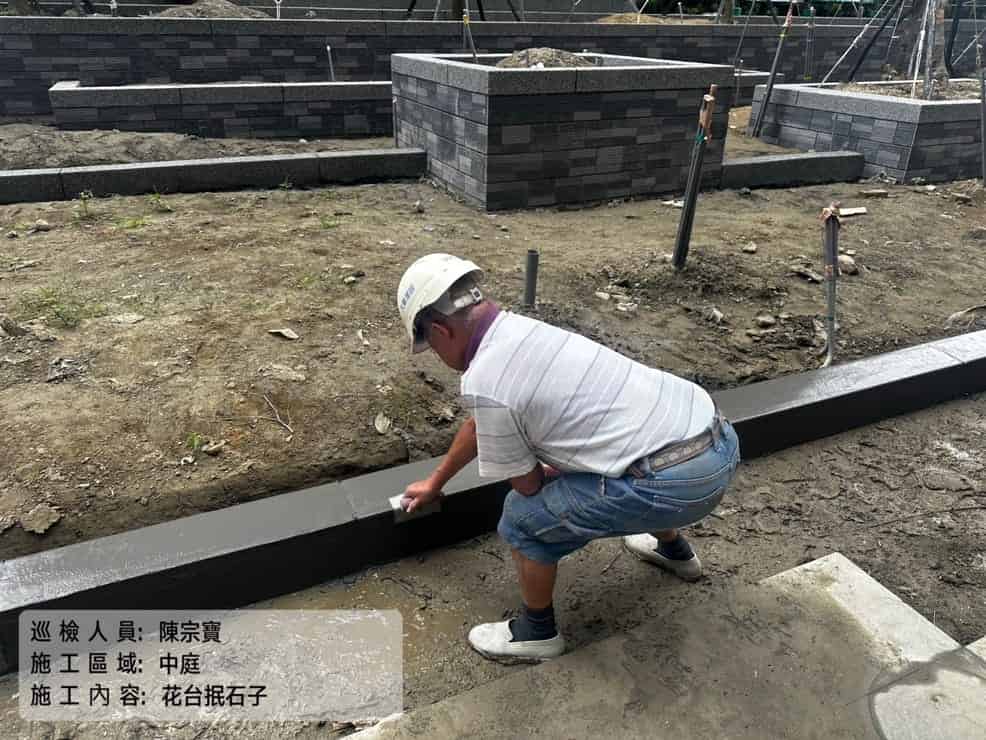

2024/10 Picking up stones by the flower stand in the atrium -

2024/10 Exterior frame dismantling work -

2024/10 Exterior wall demolition completed -

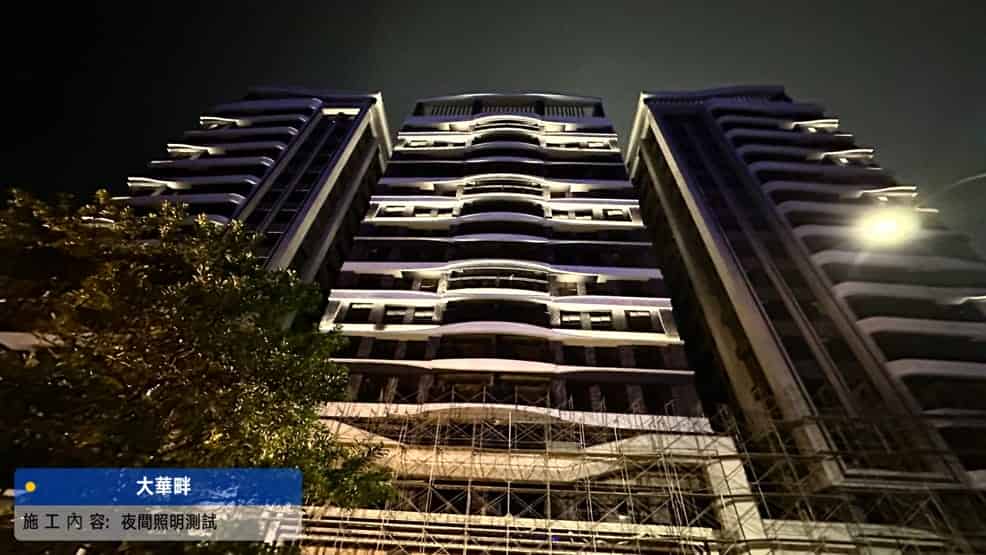

2024/10 Night light test -

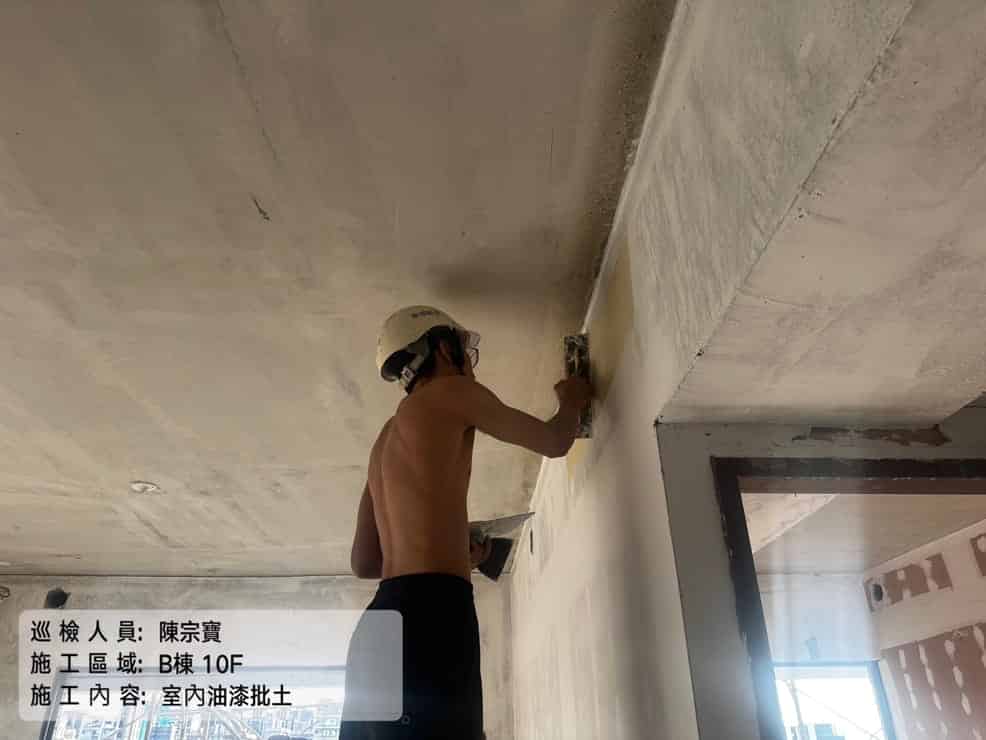

2024/10 Indoor painting and soil preparation work -

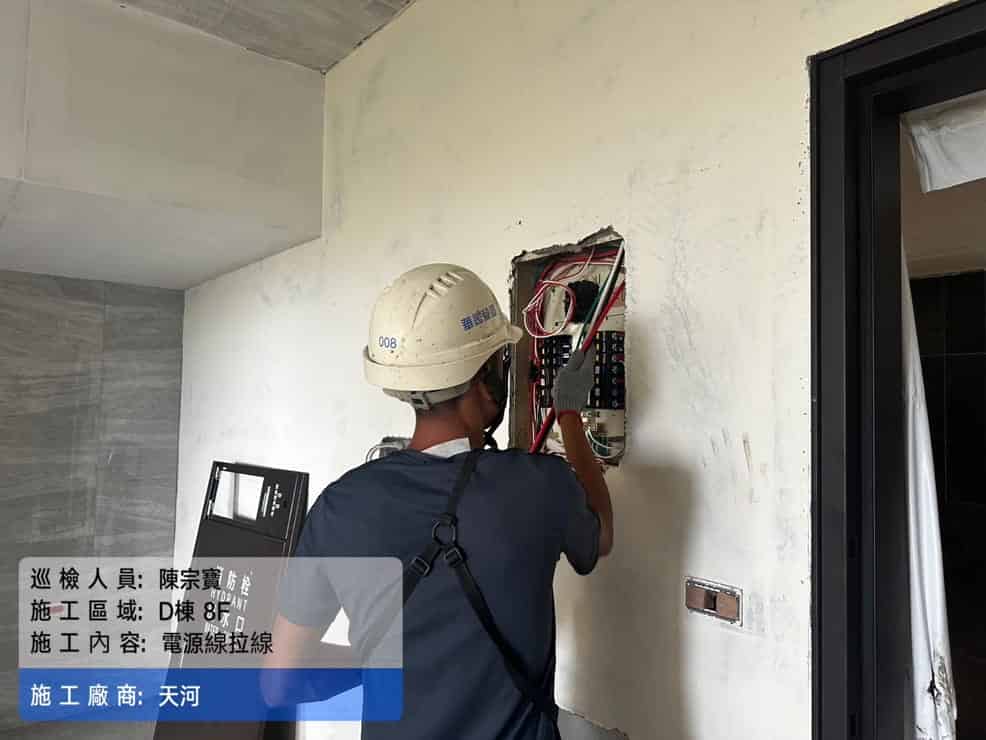

2024/10 Indoor trunk line installation -

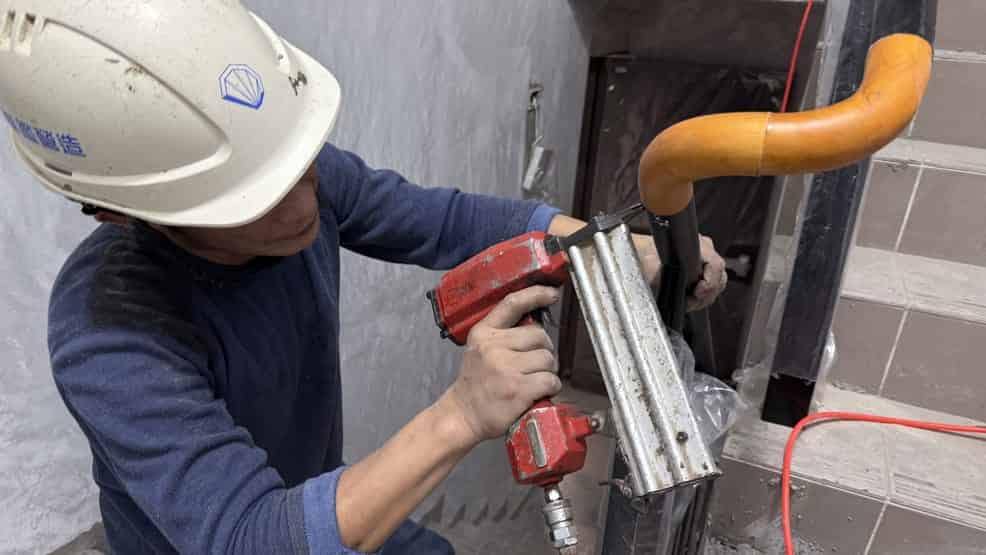

2024/10 Stair handrail installation -

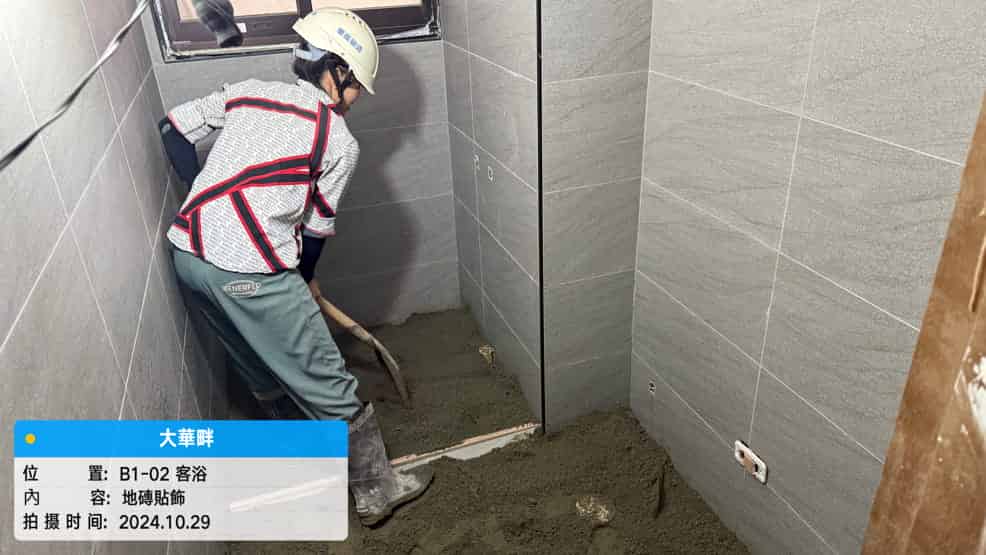

2024/10 Bathroom floor installation
-
-
11
2024
-

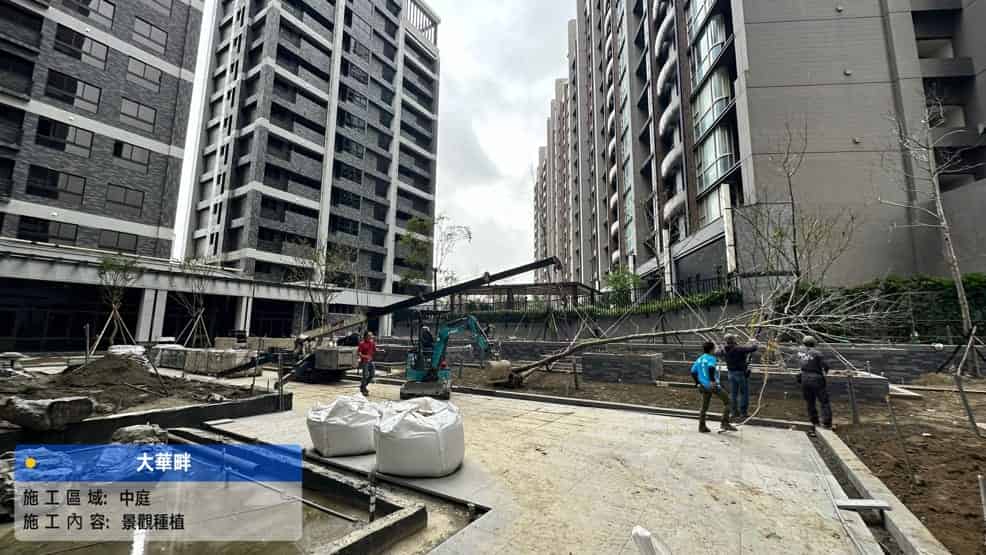

2024/11 Atrium tree planting -

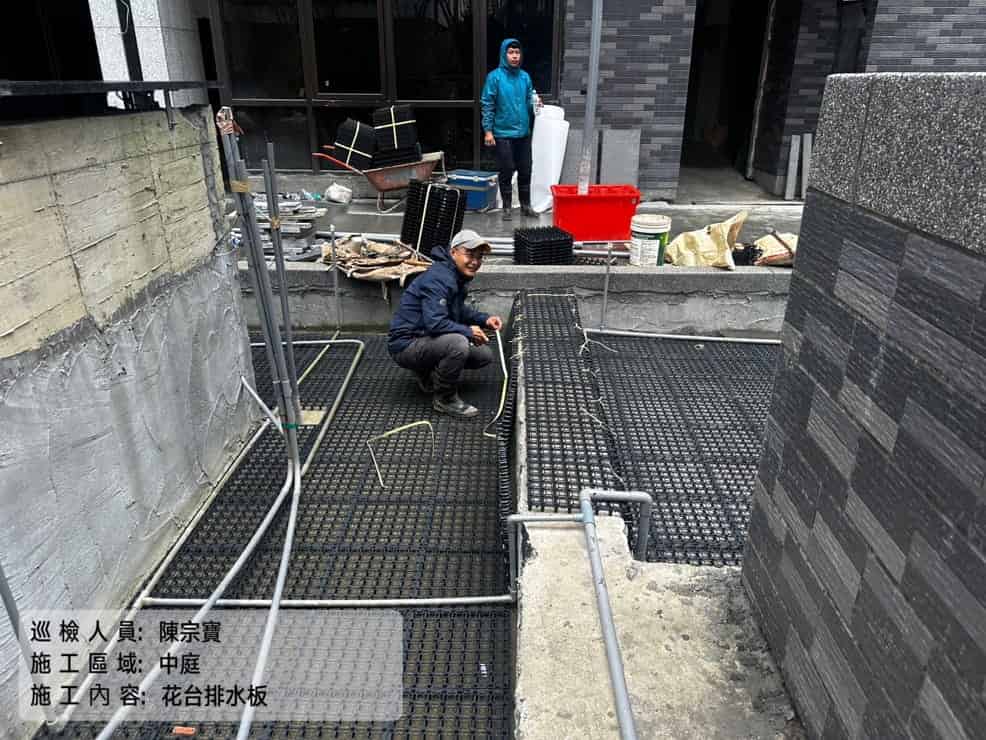

2024/11 Atrium drainage board -

2024/11 Planting of main trees in the atrium landscape -

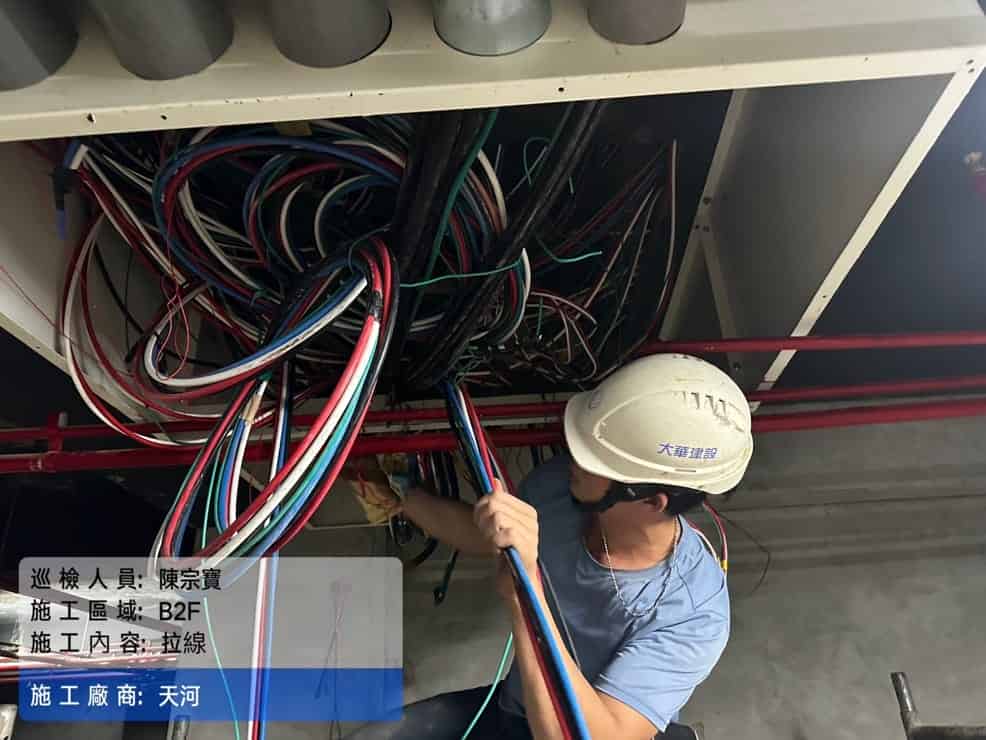

2024/11 Main line installation for each household -

2024/11 House door plate frame installation -

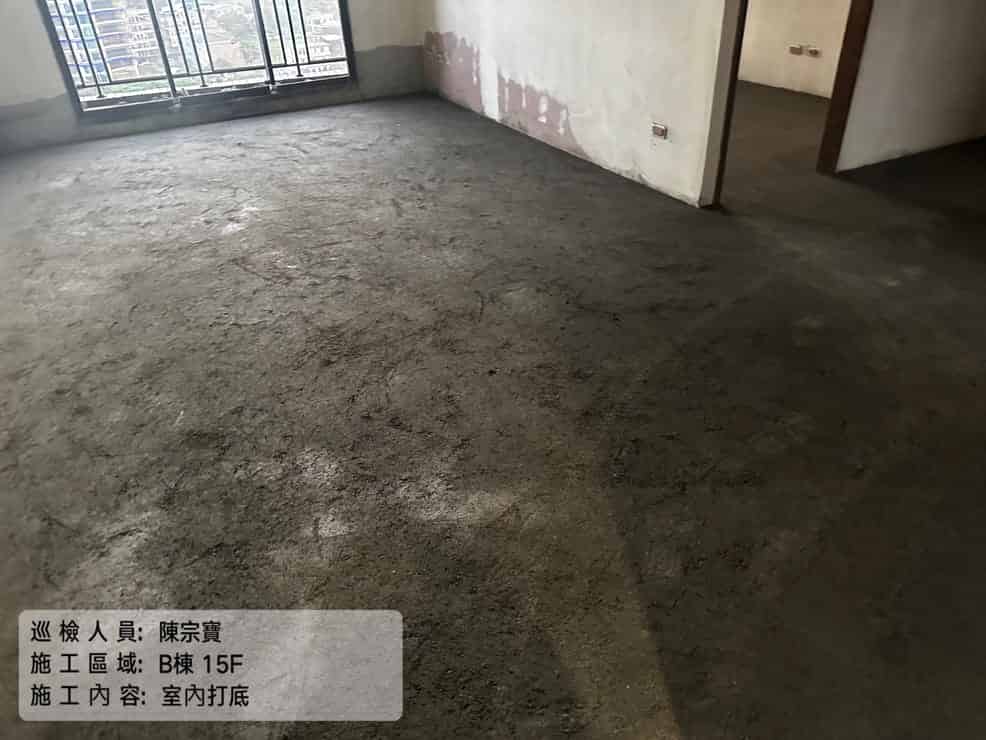

2024/11 Indoor floor primer completed -

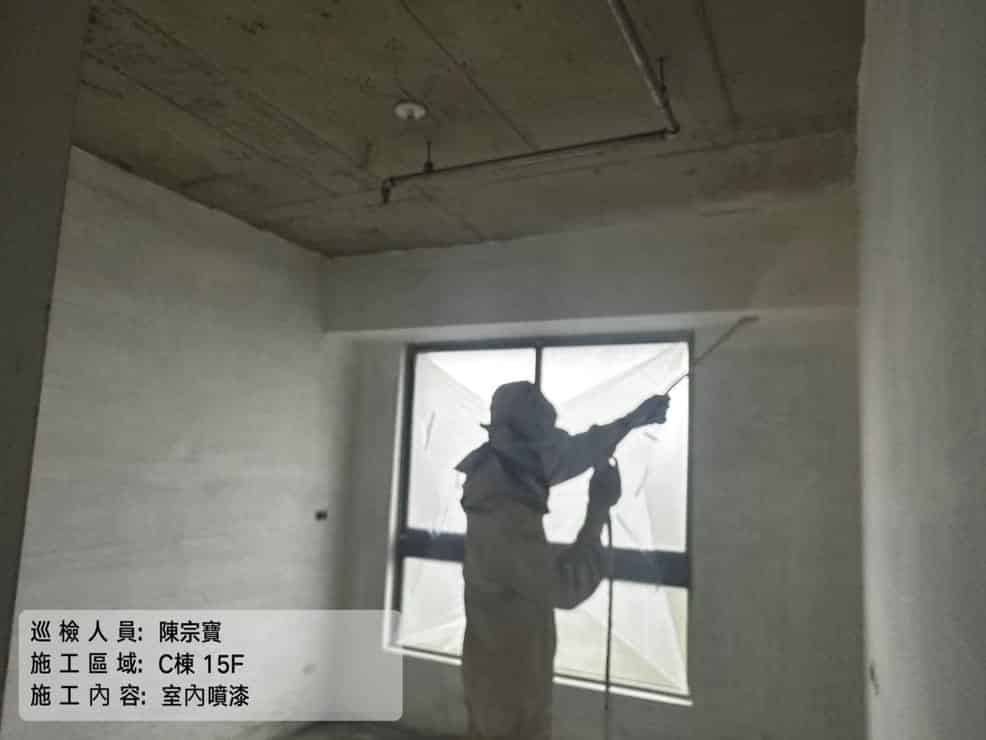

2024/11 Interior primer spraying -
2024/11 Interior paint batching -

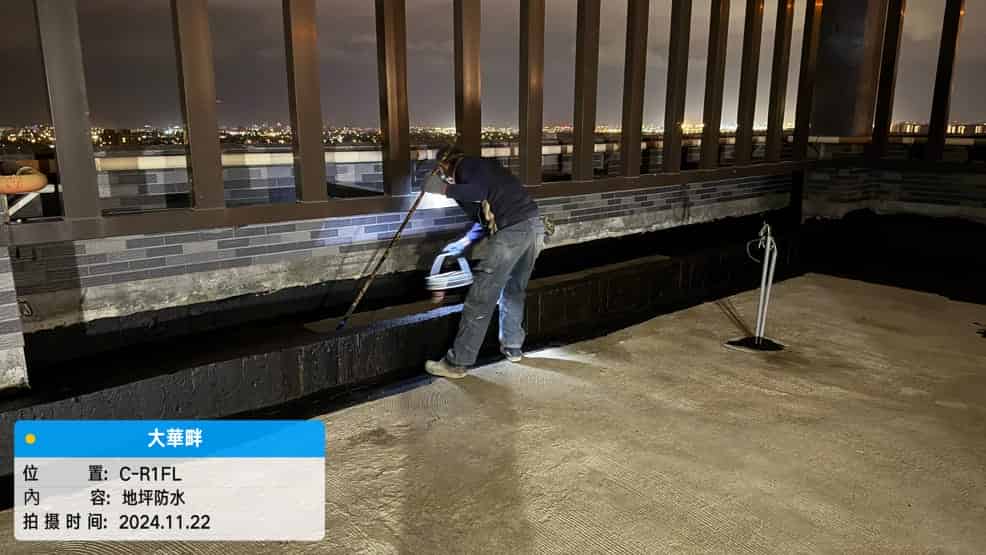

2024/11 Roof waterproofing -

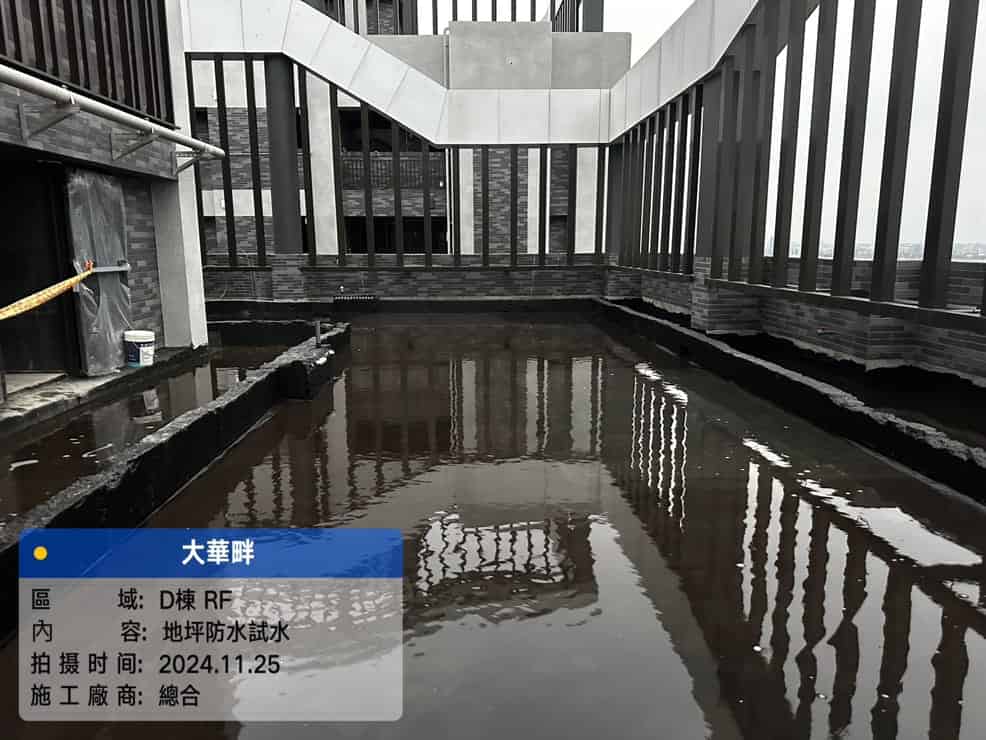

2024/11 Roof waterproofing test work -

2024/11 Tile tiles on staircase floor completed -
2024/11 Bathroom cabinet installation -

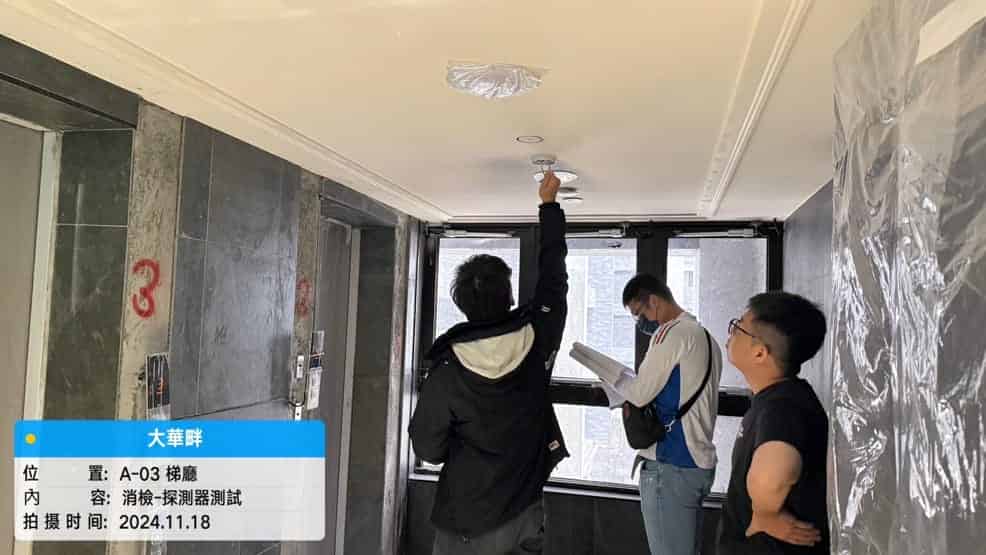

2024/11 Fire inspection operations -

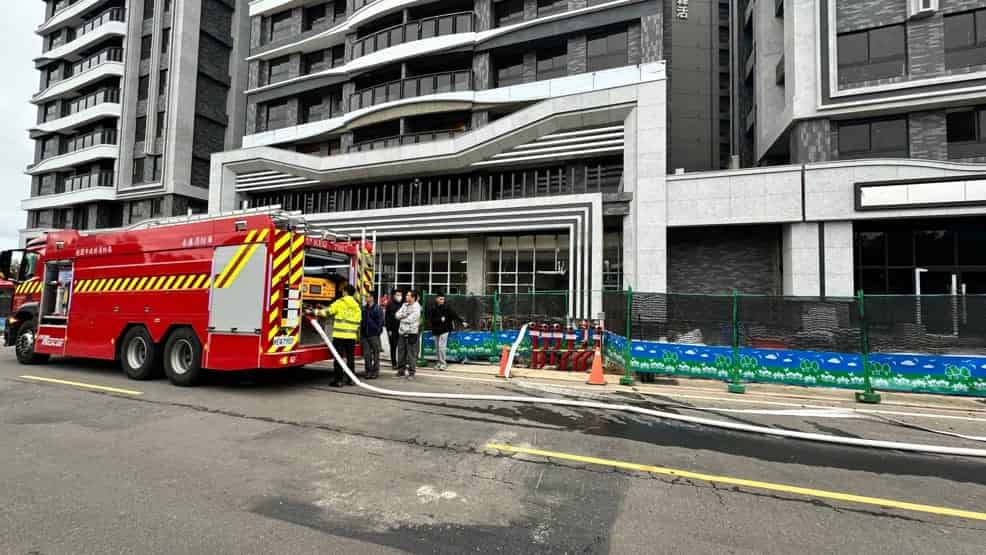

2024/11 Fire water delivery test -

2024/11 Floor-to-ceiling window glass installation
-
-
12
2024
-

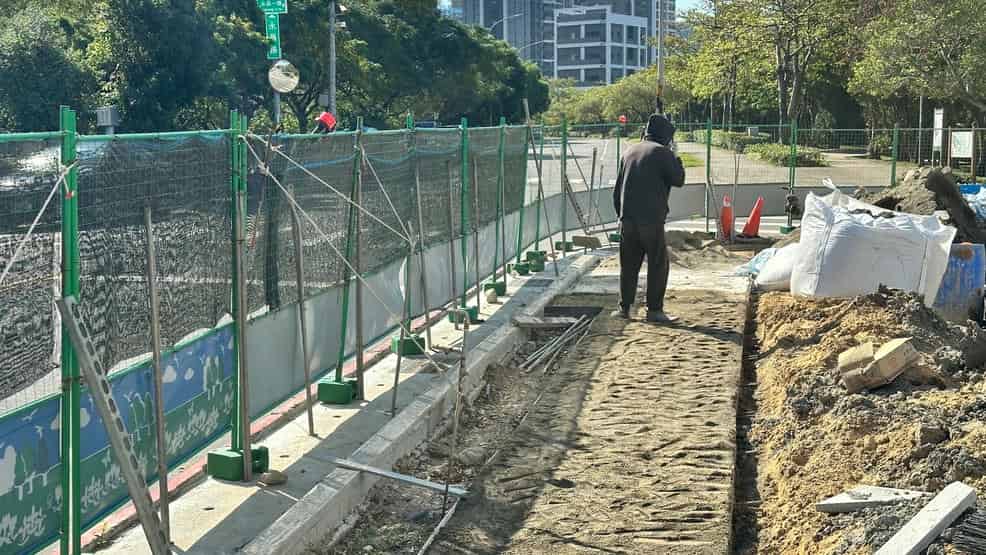

2024/12 Sidewalk re-tiles -

2024/12 Public floor stone construction -

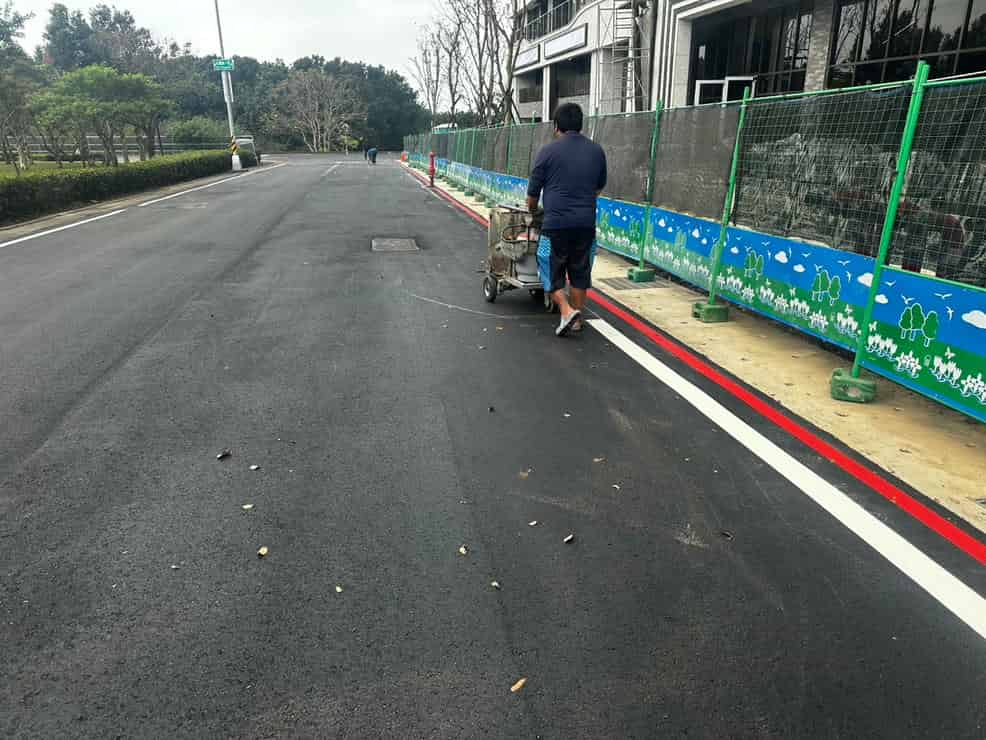

2024/12 Redrawing of surrounding road markings -

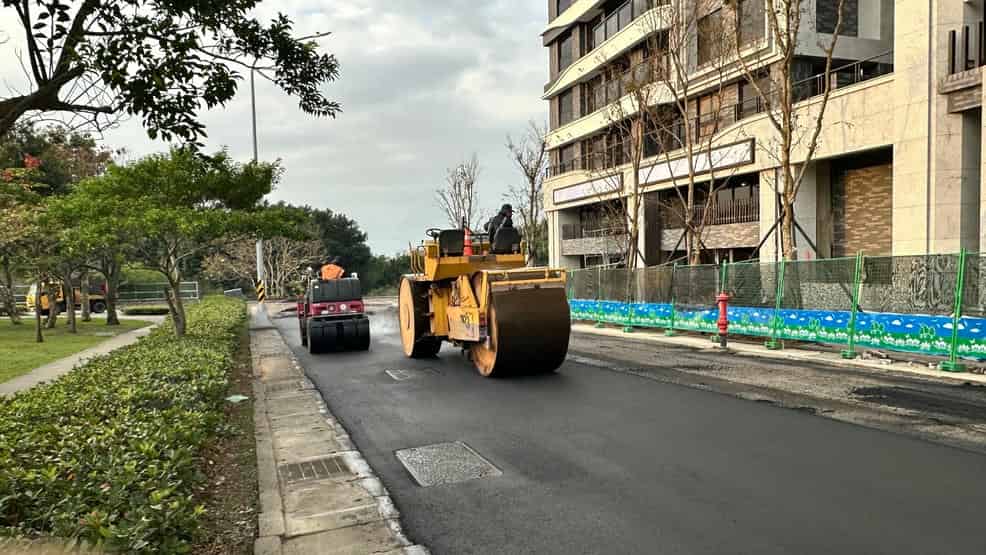

2024/12 Peripheral roads resurfaced with asphalt concrete -

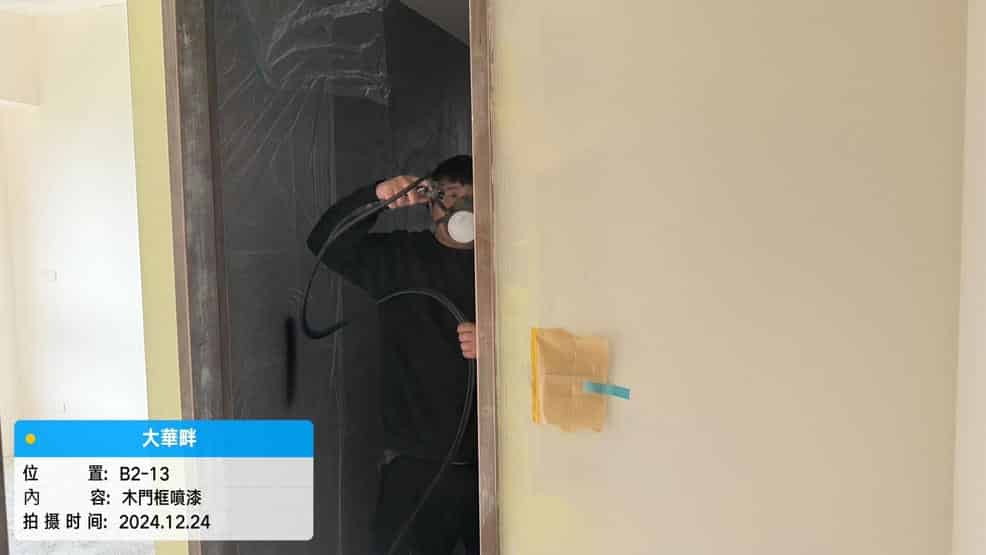

2024/12 Interior wooden door frame spray painting -

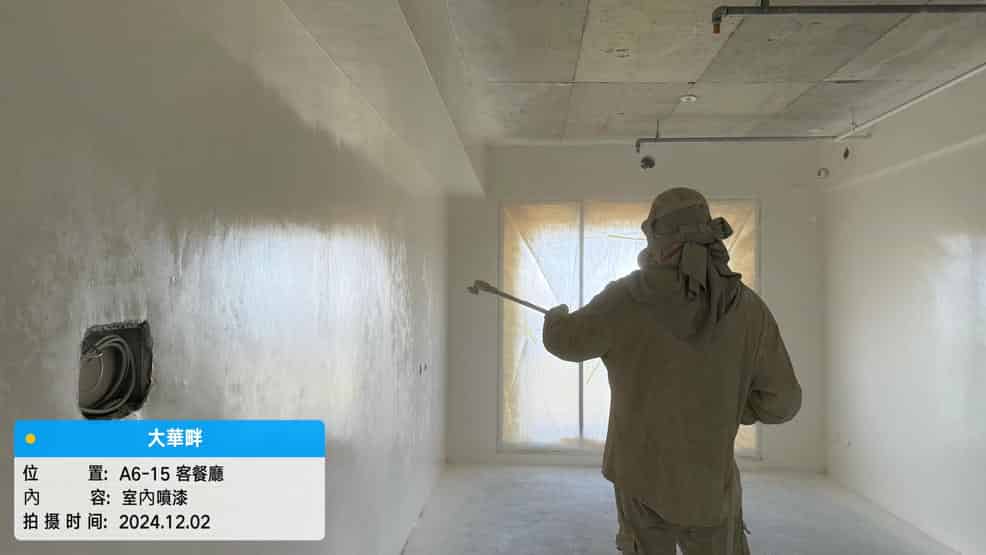

2024/12 Interior paint spraying -

2024/12 Roof greening flower bed with stones -

2024/12 Green roof covering -

2024/12 After the roof waterproofing is completed, the cement protective layer is laid -

2024/12 Indoor wooden floor laying -

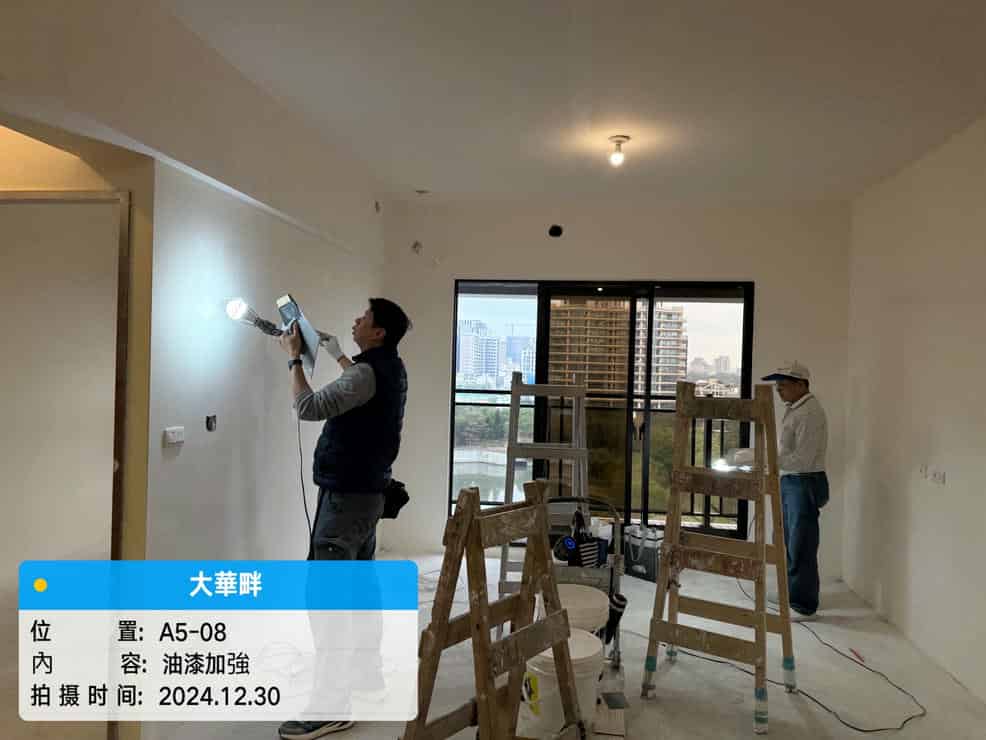

2024/12 Paint enhancement repair -

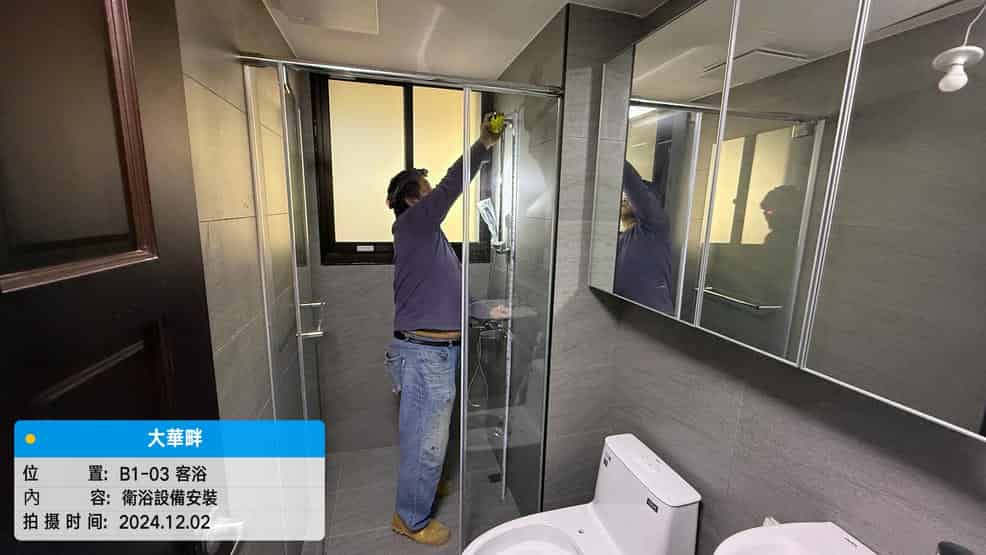

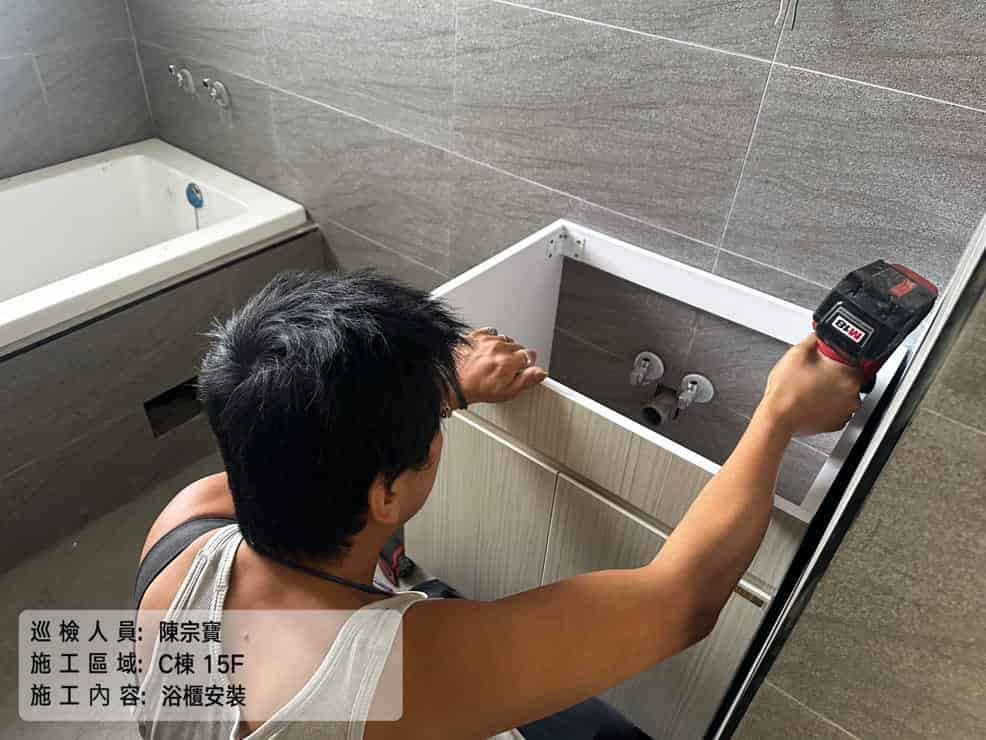

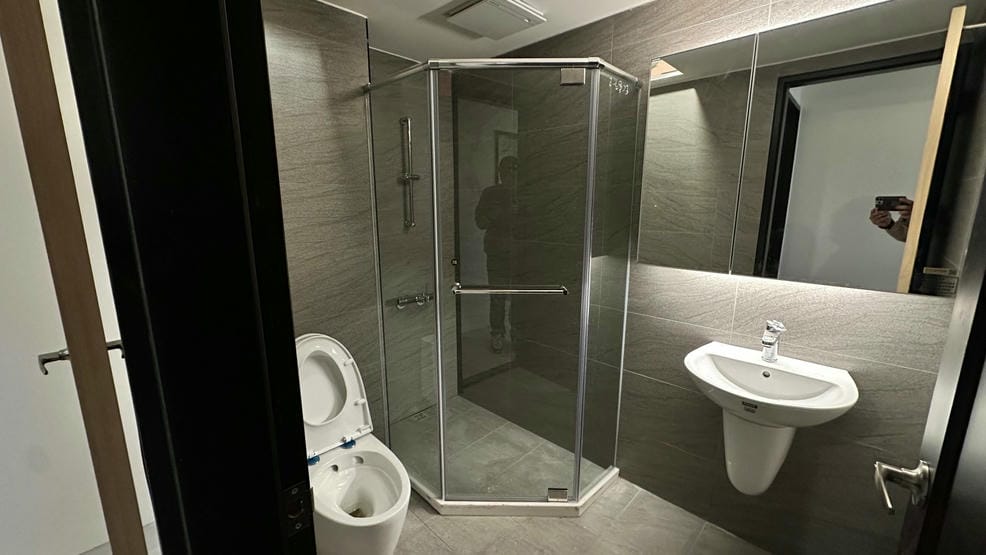

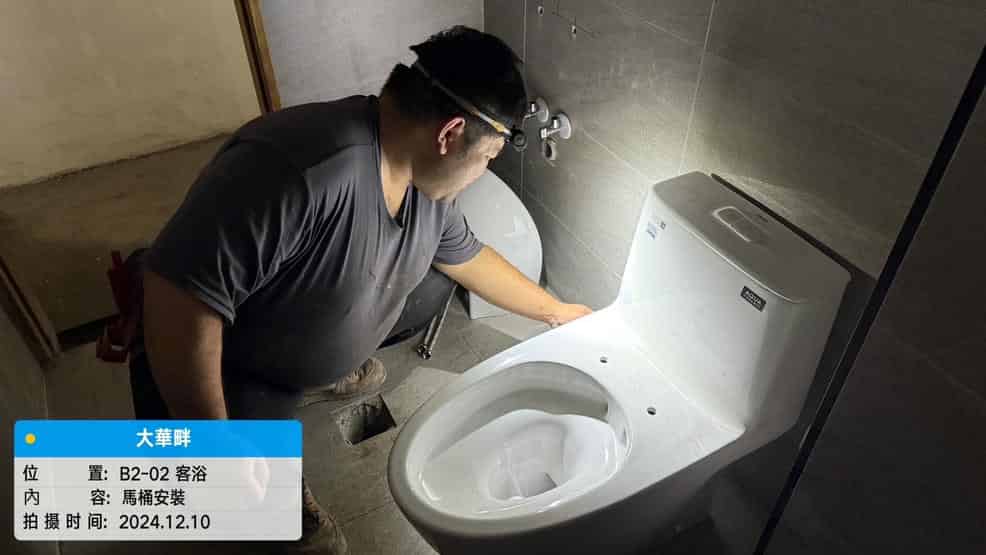

2024/12 Bathroom equipment installation -
2024/12 Bathroom equipment installation -

2024/12 driveway tile laying -

2024/12 Elevator woodworking
-
-
01
2025
-

2025/01 The atrium was paved with stones -

2025/01 Public hall ceiling construction -

2025/01 Drawing lines for parking spaces on the first underground floor -

2025/01 地下室EPOXY底塗打磨 -

2025/01 Interior wood flooring installation -

2025/01 Installation of door sign lights in elevator hall -

2025/01 driveway brick installation
-
-
02
2025
-

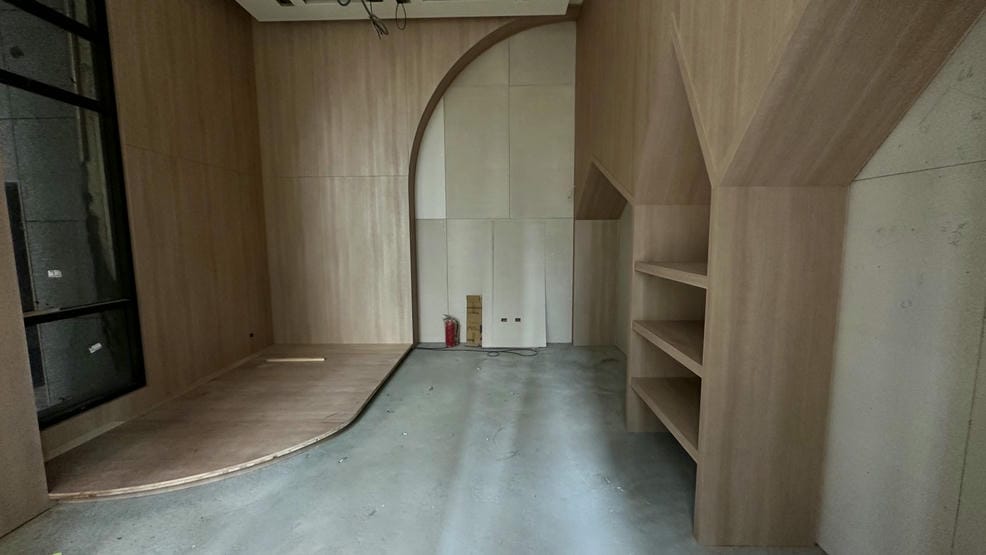

2025/02 Gym woodwork -
2025/02 Children_s playroom woodwork -

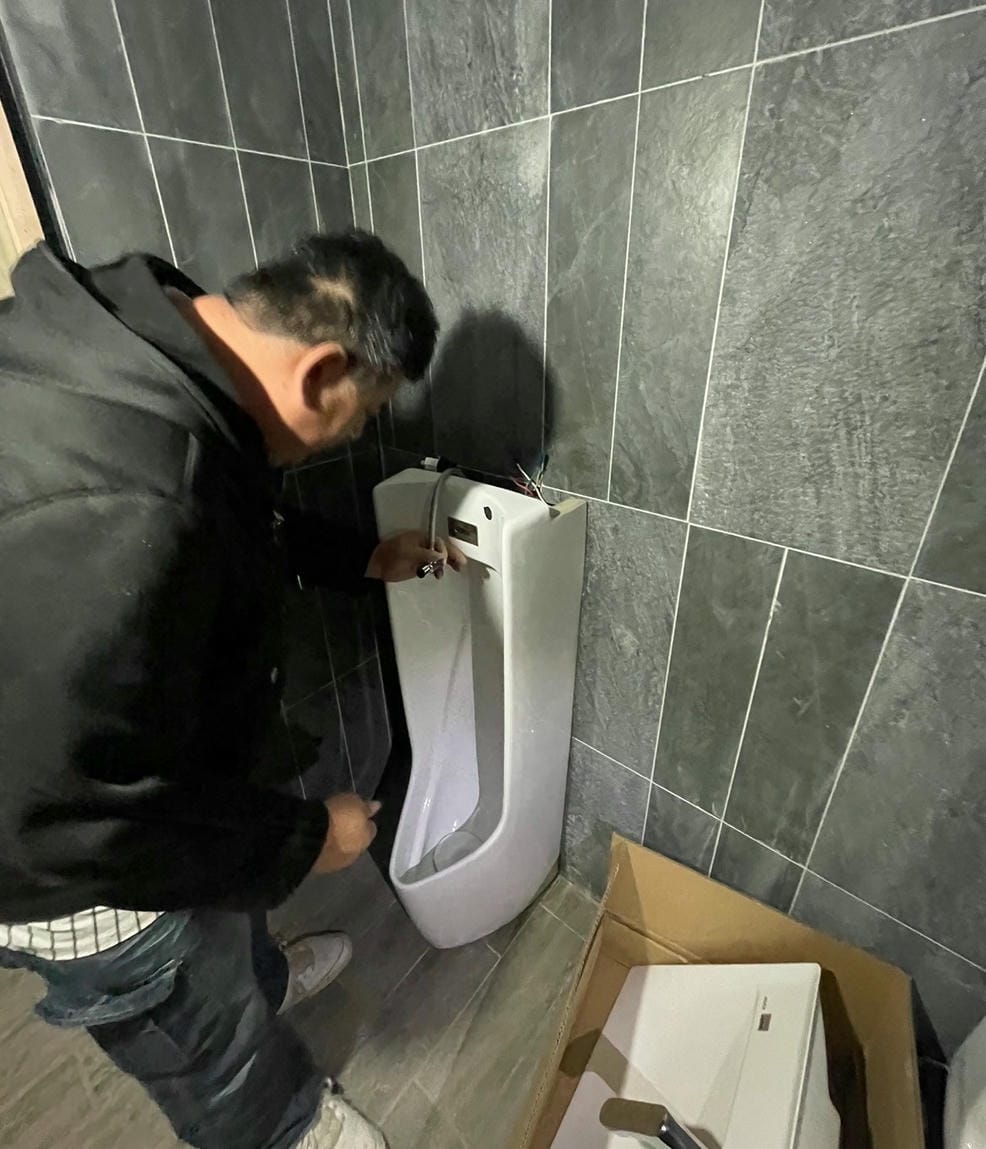

2025/02 Public toilet equipment installation -

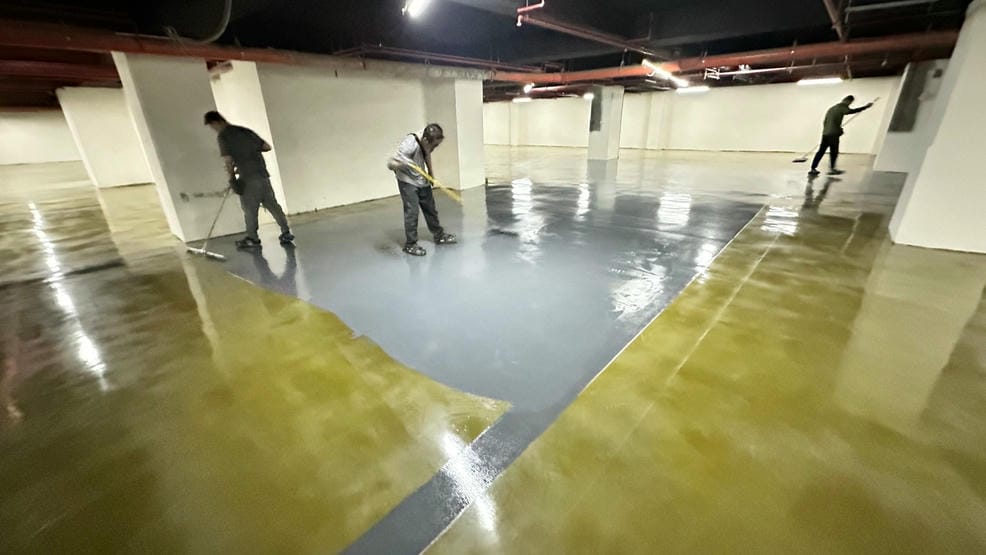

2025/02 Installation of EPOXY surface layer on the second underground floor -

2025/02 Lobby bar installation -

2025/02 Hall column breadboard construction -

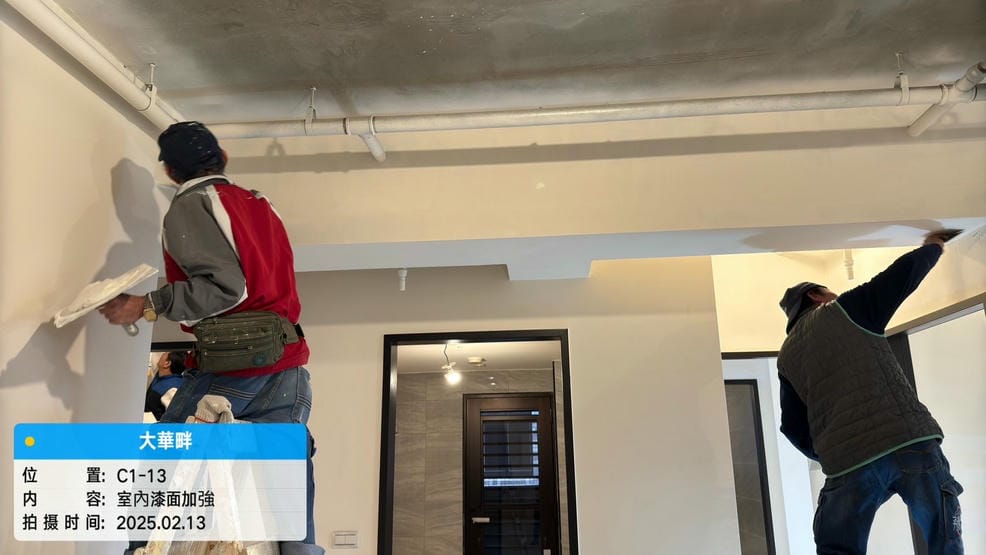

2025/02 Wall paint enhancement repair -

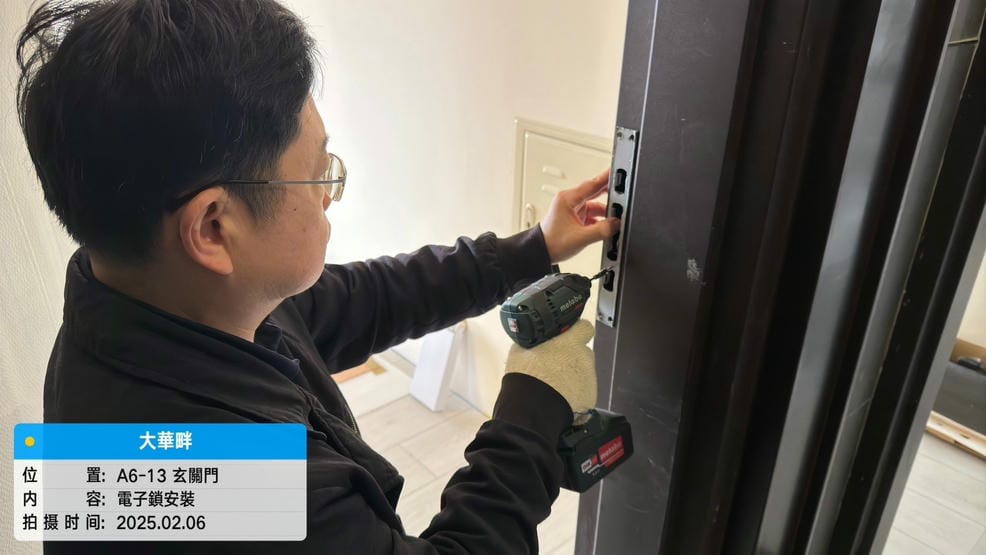

2025/02 Entrance door electronic lock installation -
2025/02 Bathroom equipment installation -

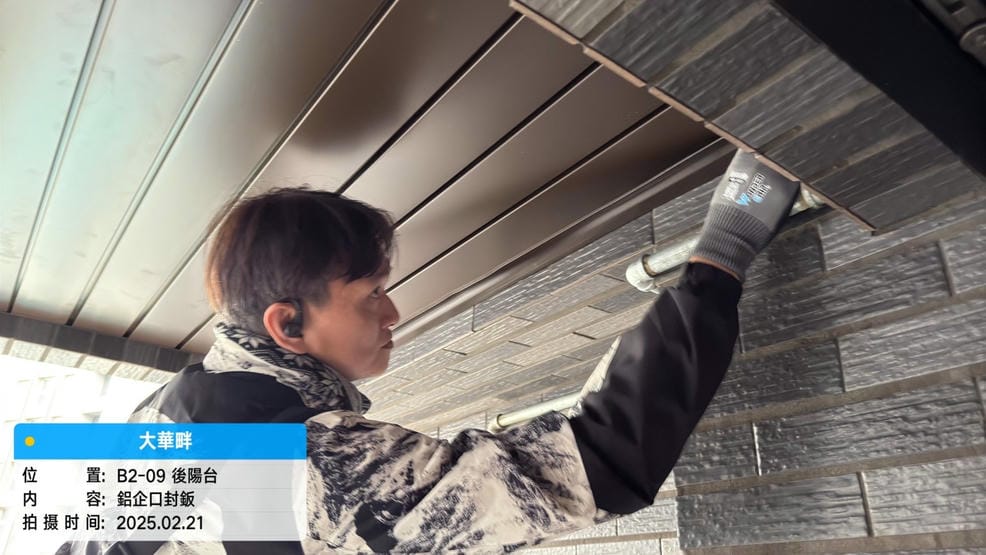

2025/02 Balcony ceiling construction
-
-
03
2025
-

2025/03 Electric vehicle charging bus -

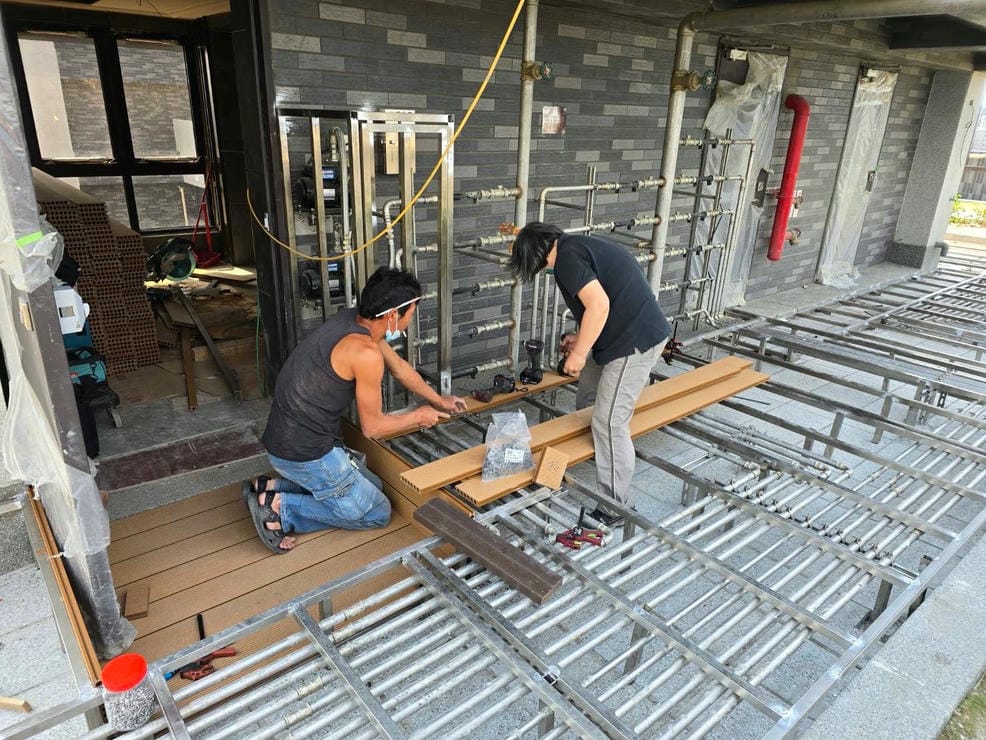

2025/03 Plastic wood floor laying -

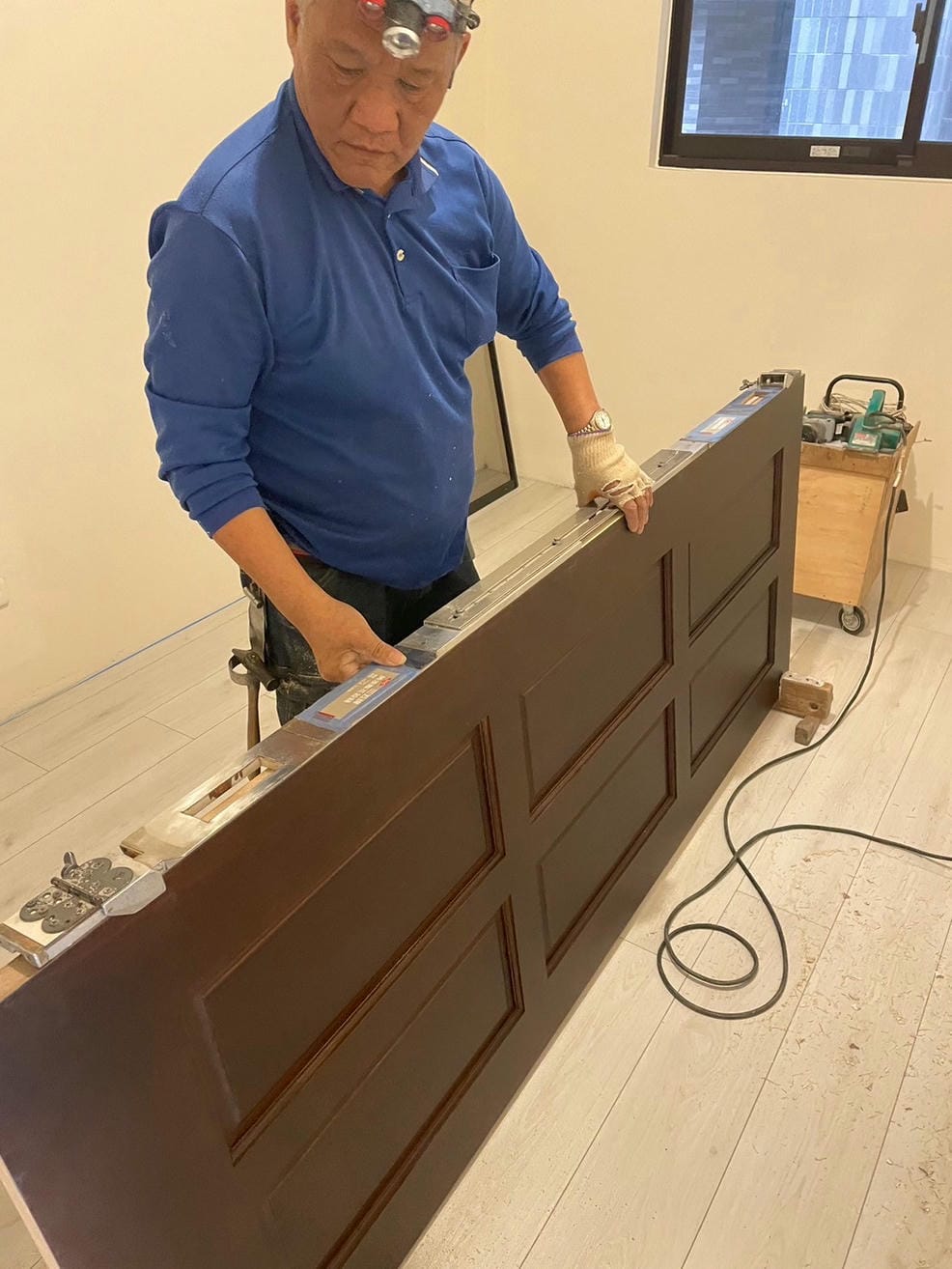

2025/03 Indoor wooden door leaf installation -

2025/03 Construction of roof wooden plank skeleton -

2025/03 Kitchenware painted glass installation -

2025/03 Painted wooden handrails -

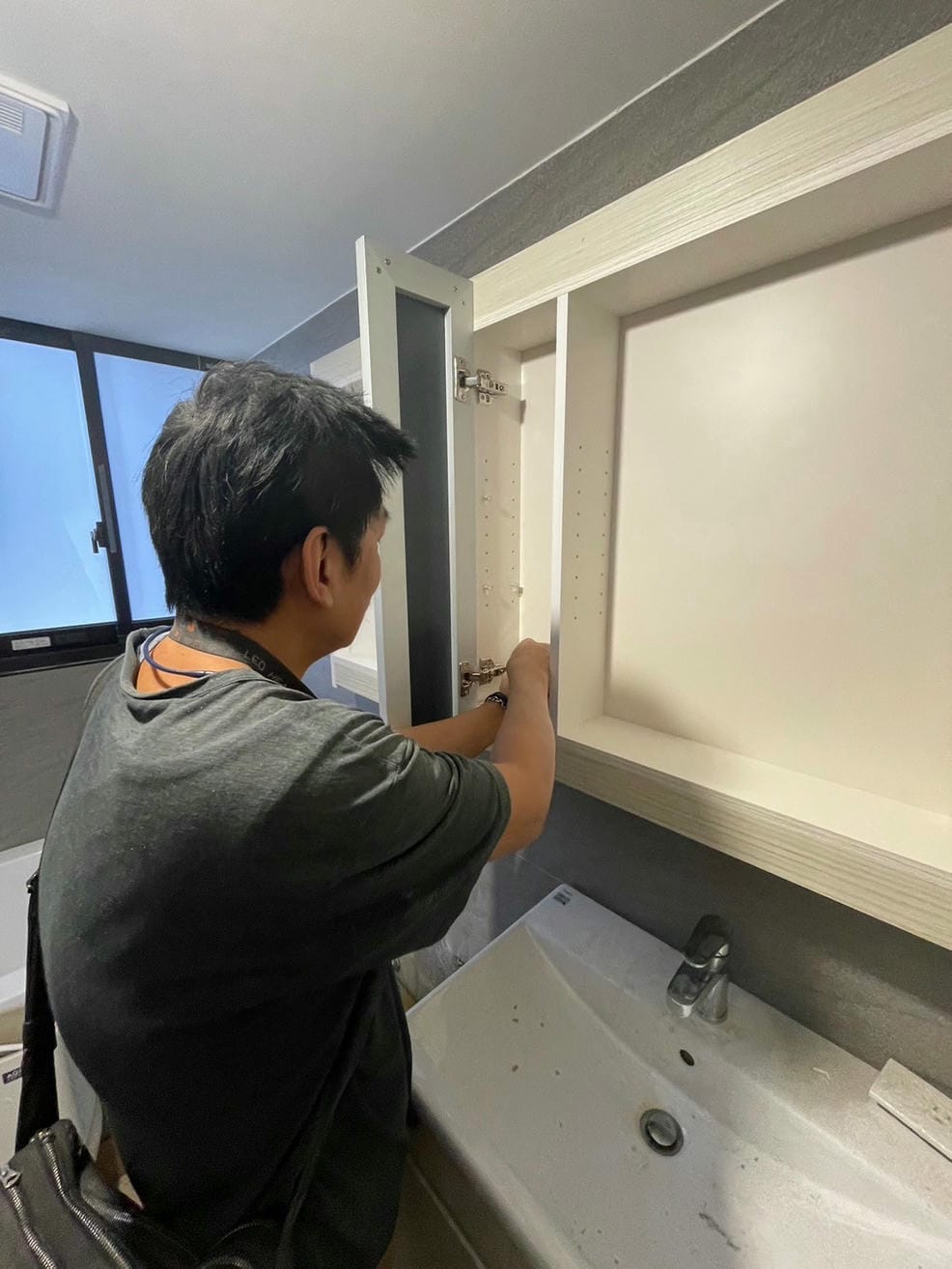

2025/03 Bathroom mirror box installation
-
-
04
2025
-

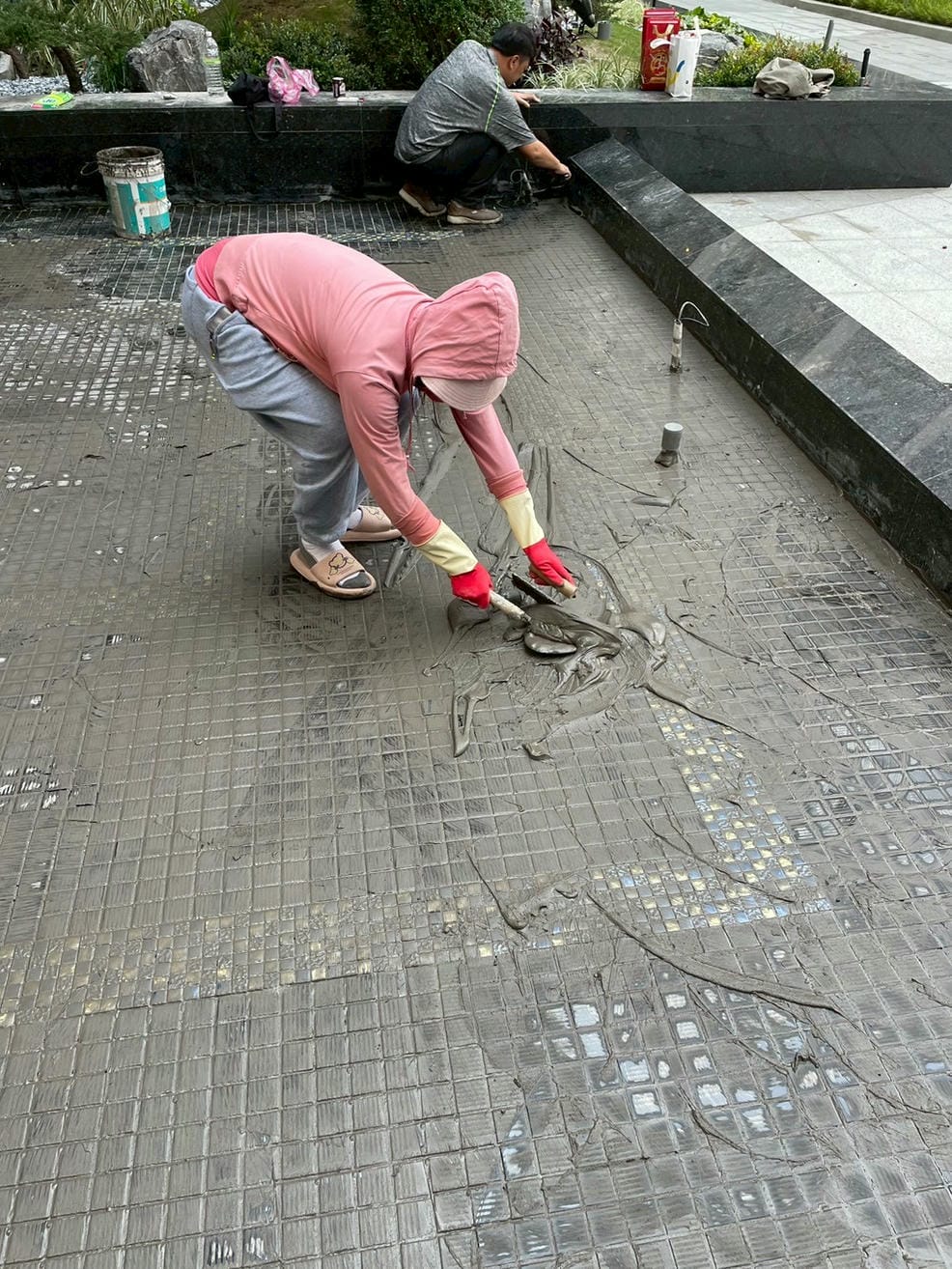

2025/04 Atrium pool brick grouting -

2025/04 Construction of wooden ceiling in atrium corridor -

2025/04 Mailbox installation for each household -

2025/04 Construction of busbar for car charger in basement -

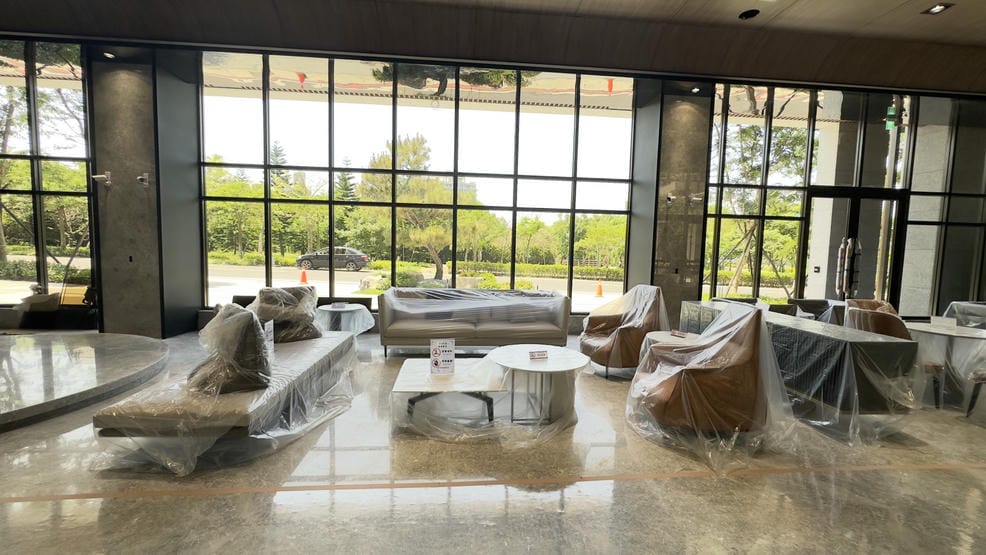

2025/04 Lobby furniture purchase -

2025/04 Driveway arch construction
-
-
05
2025
-
2025/05 1F wall lamp installation completed -
2025/05 Mailbox wood veneer -
2025/05 Installation of locks for utility cabinets -
2025/05 Basement floor construction (B3F) -
2025/05 Lobby piano positioning -
2025/05 Driveway ironwork and height limit frame
-
-
06
2025
-

2025/06 Atrium landscape pool test -

2025/06 Gym carpet installation -

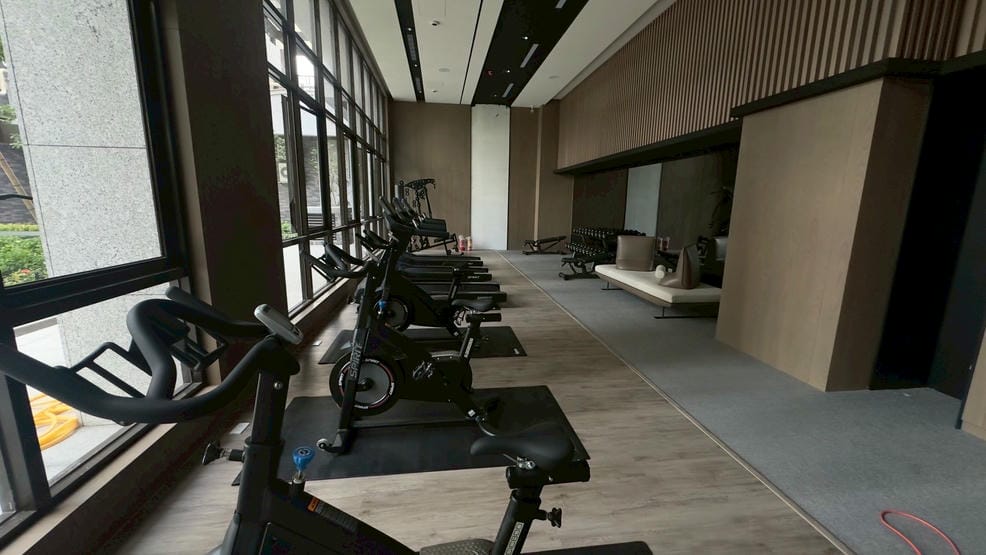

2025/06 Gym equipment positioning -

2025/06 Household door number installation -

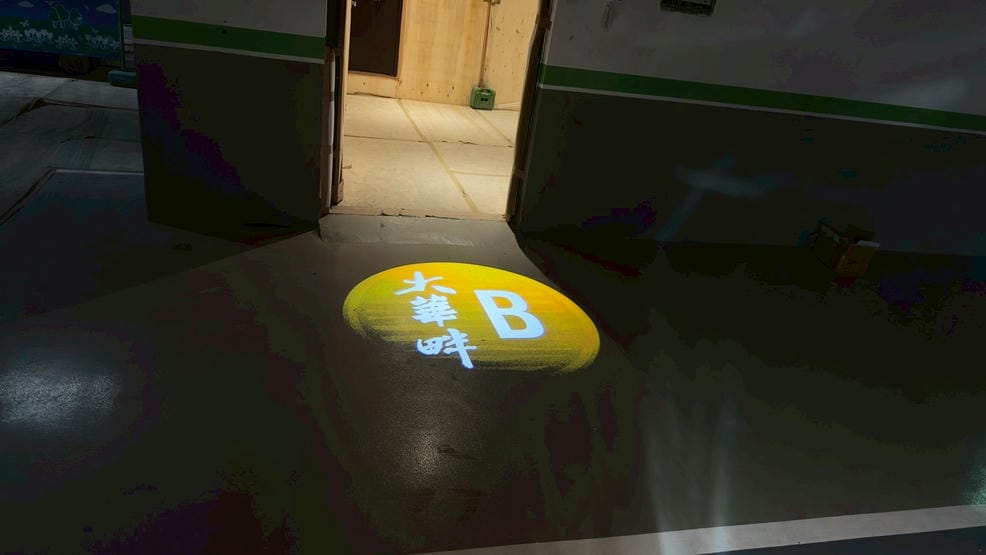

2025/06 Exit spotlights at each basement -

2025/06 Garbage storage room equipment installation -

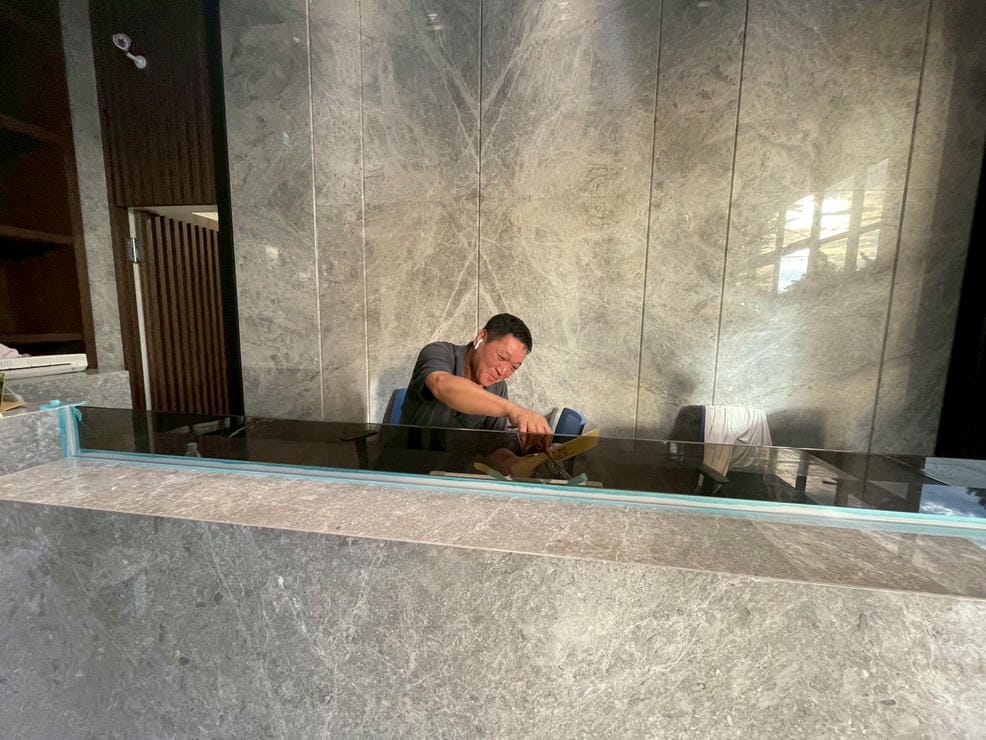

2025/06 Counter glass installation -
2025/06 Game room equipment positioning -
2025/06 Reading room table and chair positioning
-
-
07
2025
-

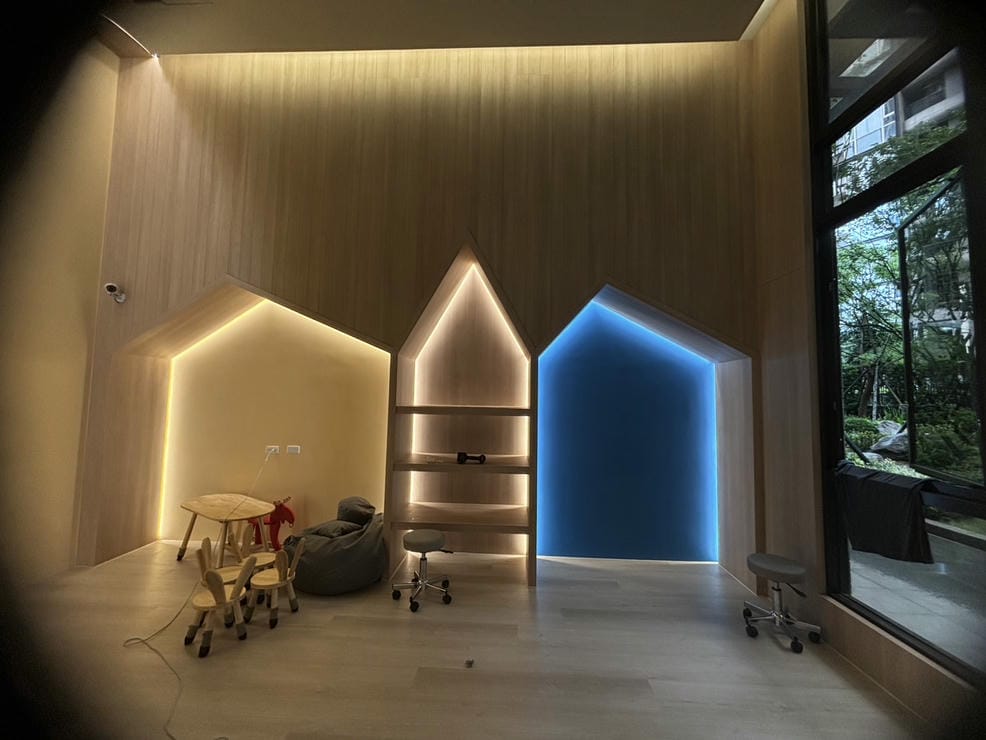

2025/07 Children_s playroom LED strip light installation -
2025/07 Children_s playroom wall LED lighting installation -

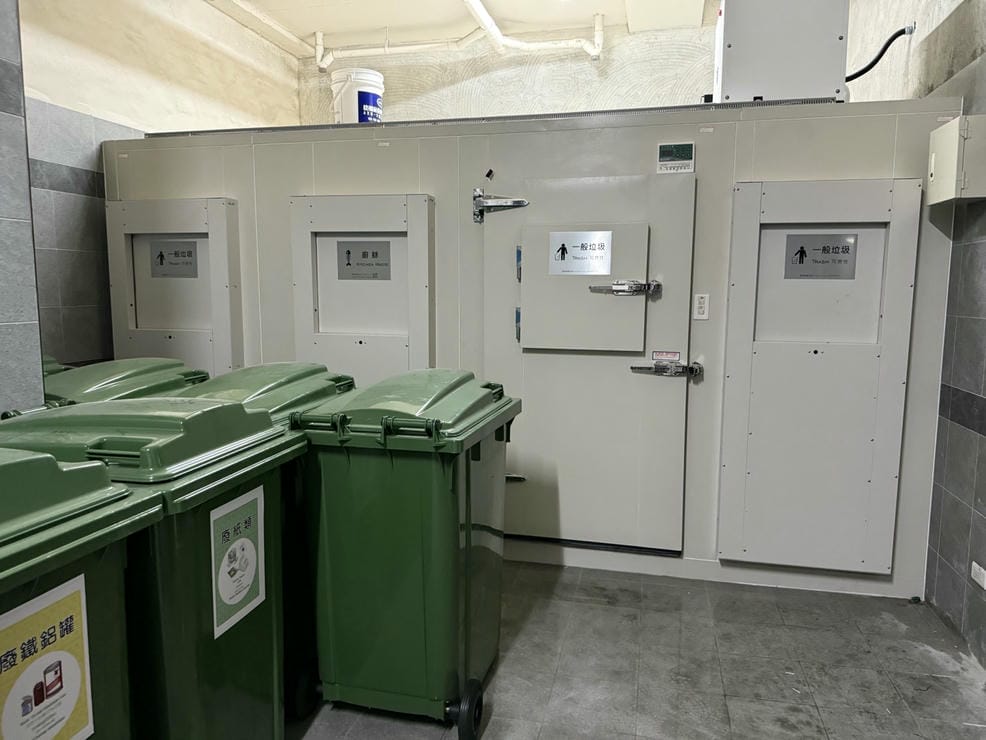

2025/07 Garbage refrigeration equipment installation completed -

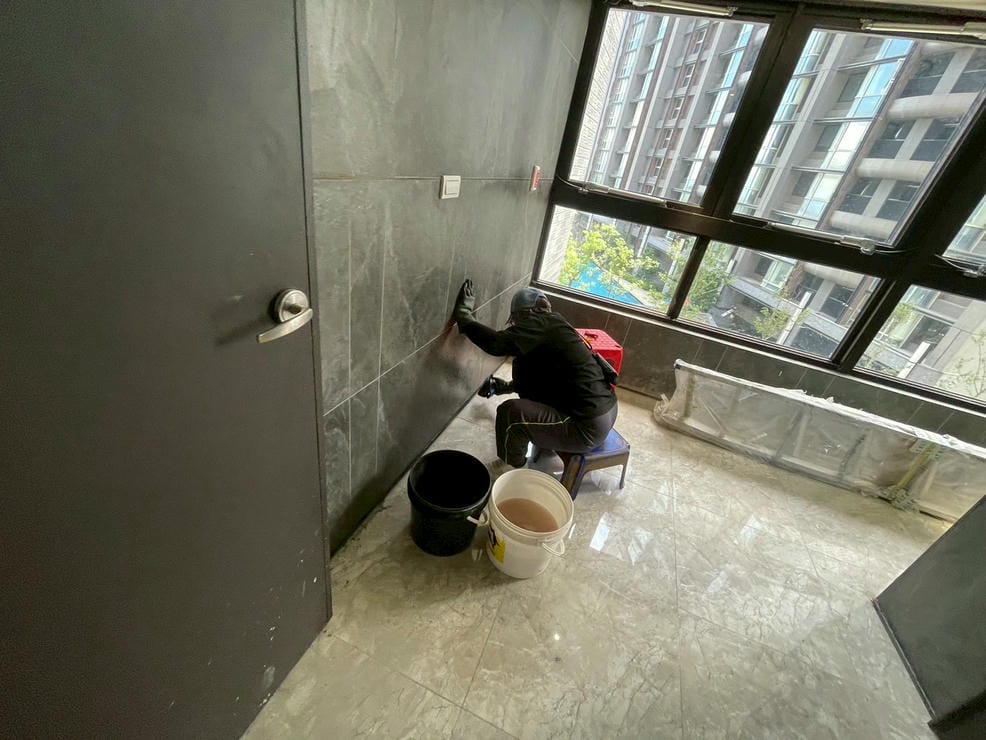

2025/07 Elevator hall wall cleaning -

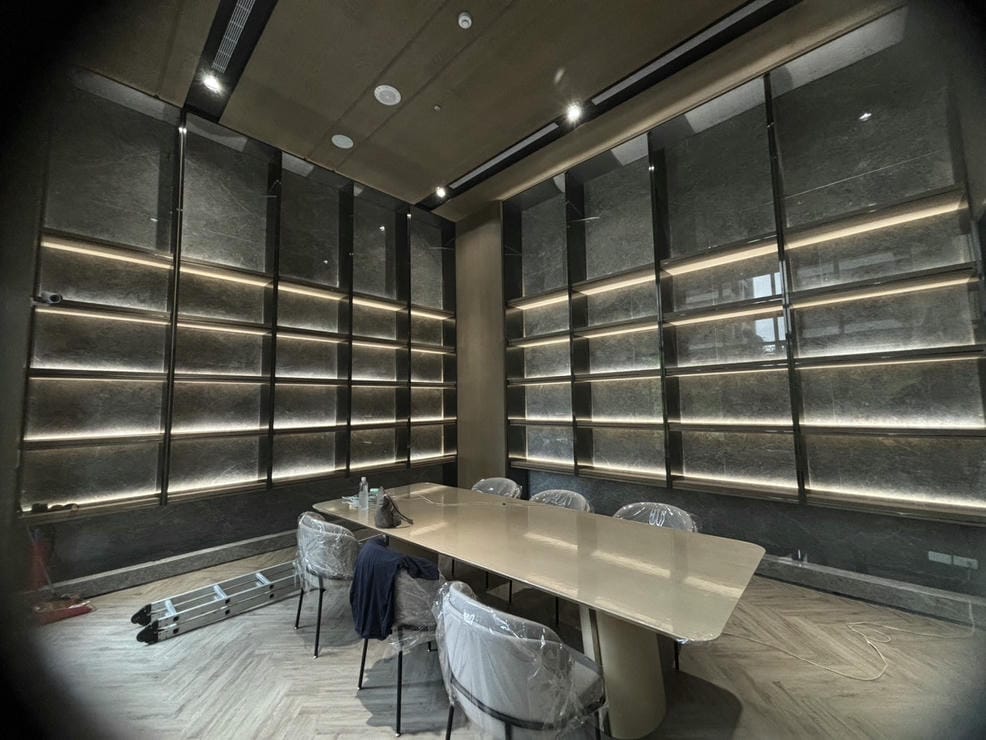

2025/07 Reading room bookcase light installation -

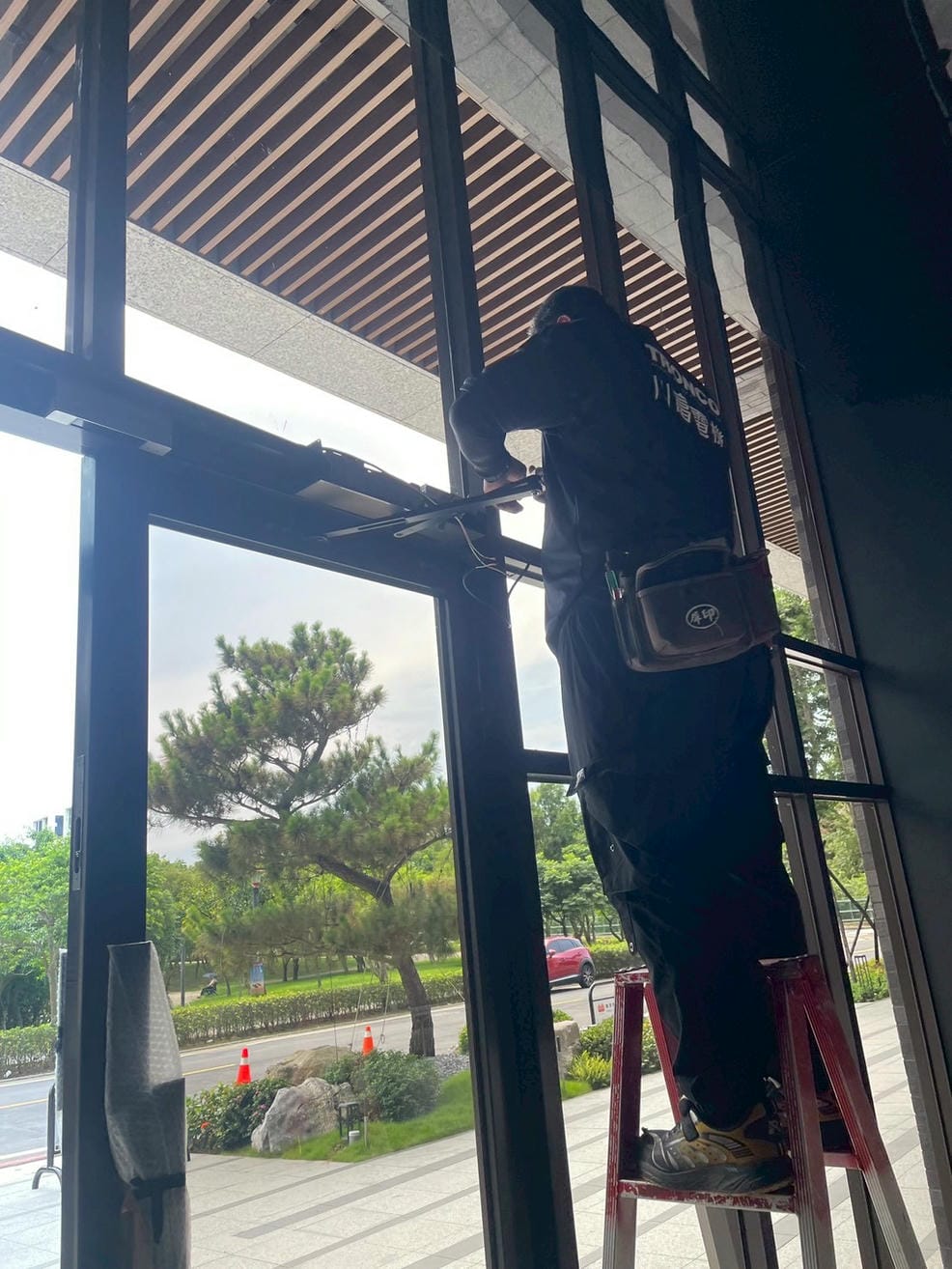

2025/07 Check and adjust the electric door push rod
-
