Delpha Jing
-
04
2022
-

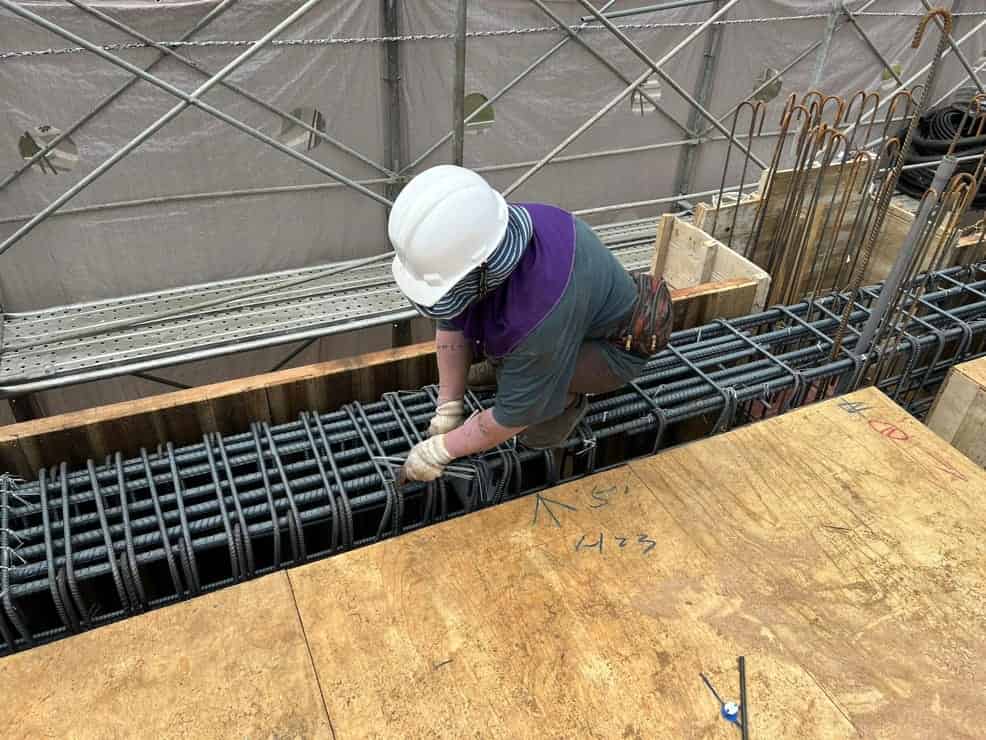

2022/04 3FL beam reinforcement binding -

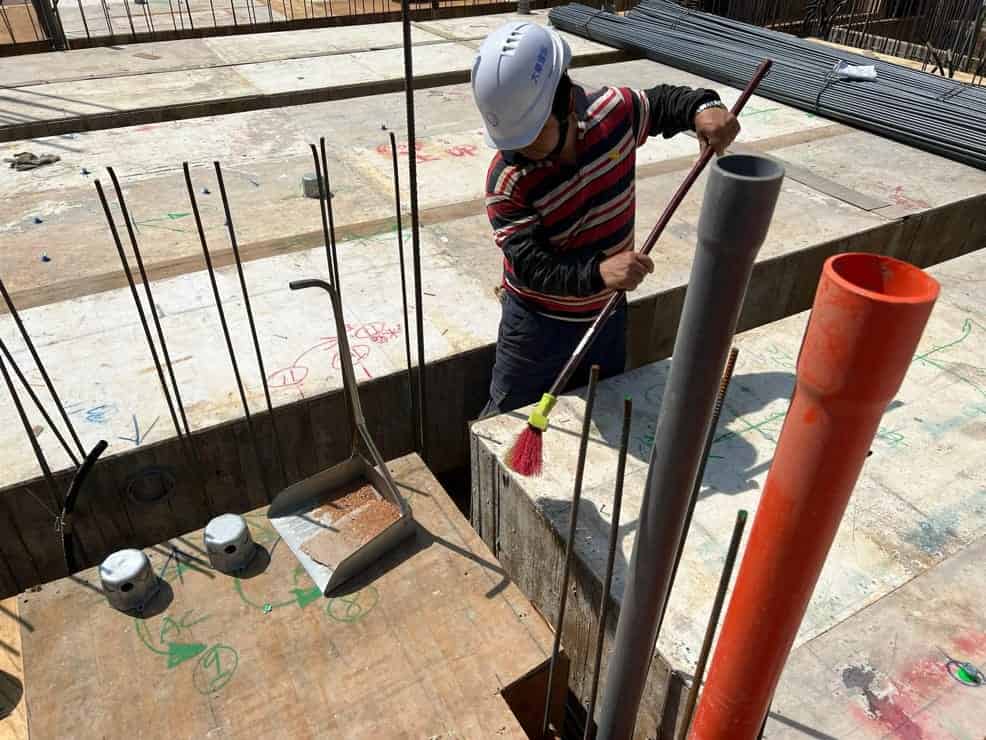

2022/04 3FL layout cleaning
-
-
05
2022
-

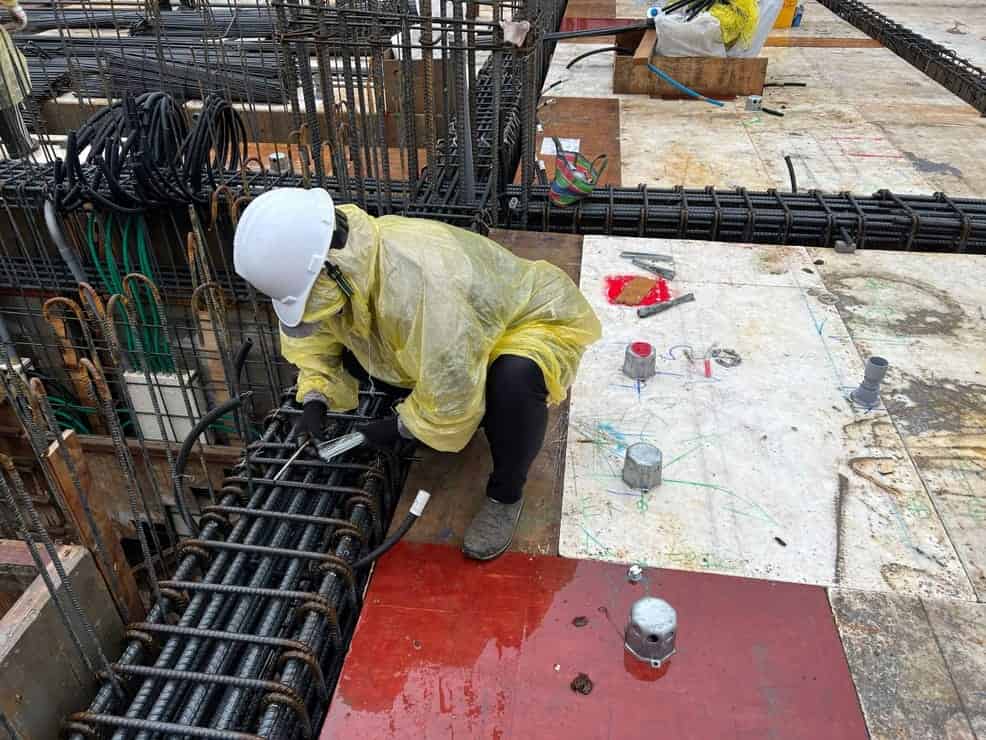

2022/05 4FL beam reinforcement binding -

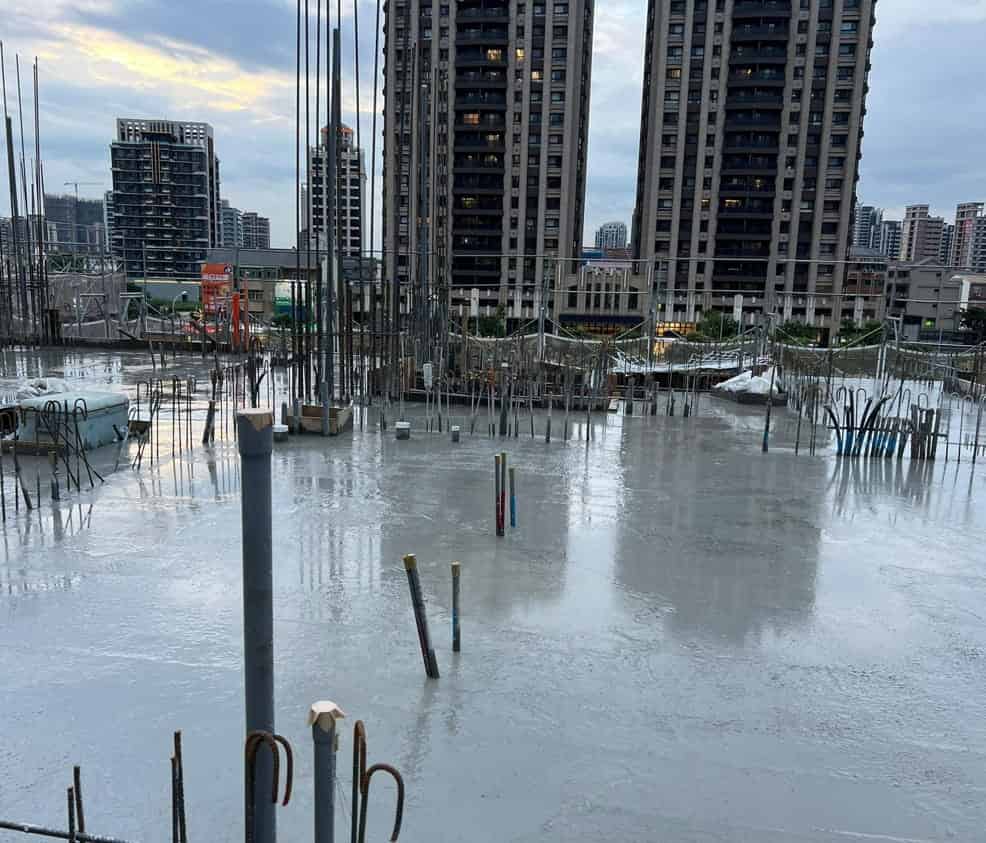

2022/05 4FL concrete placement
-
-
06
2022
-

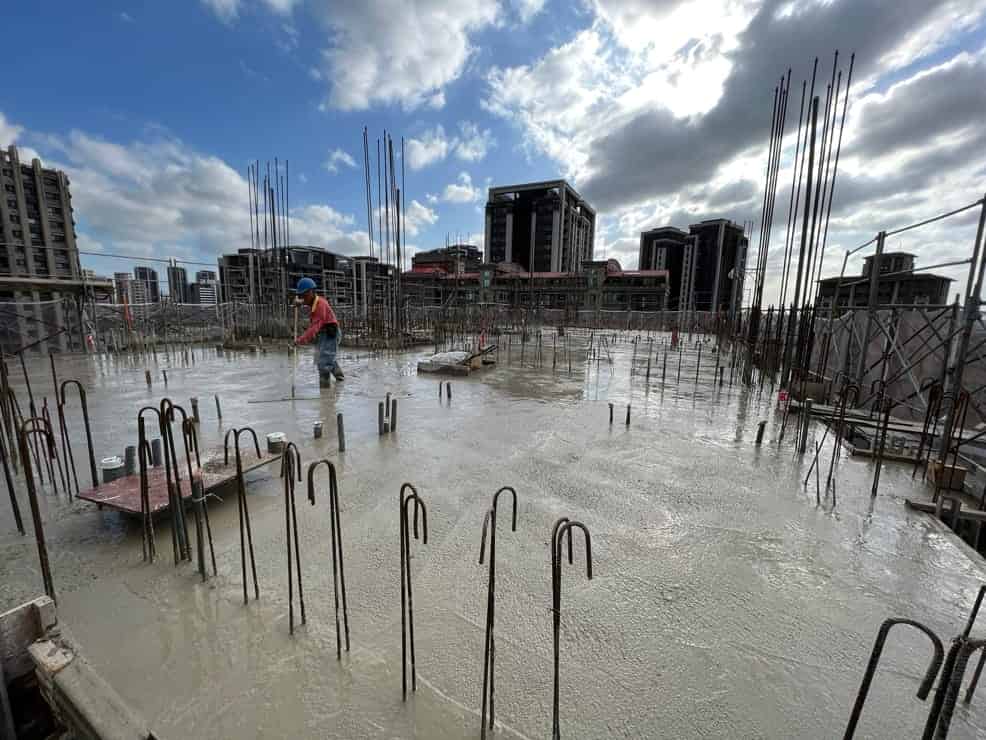

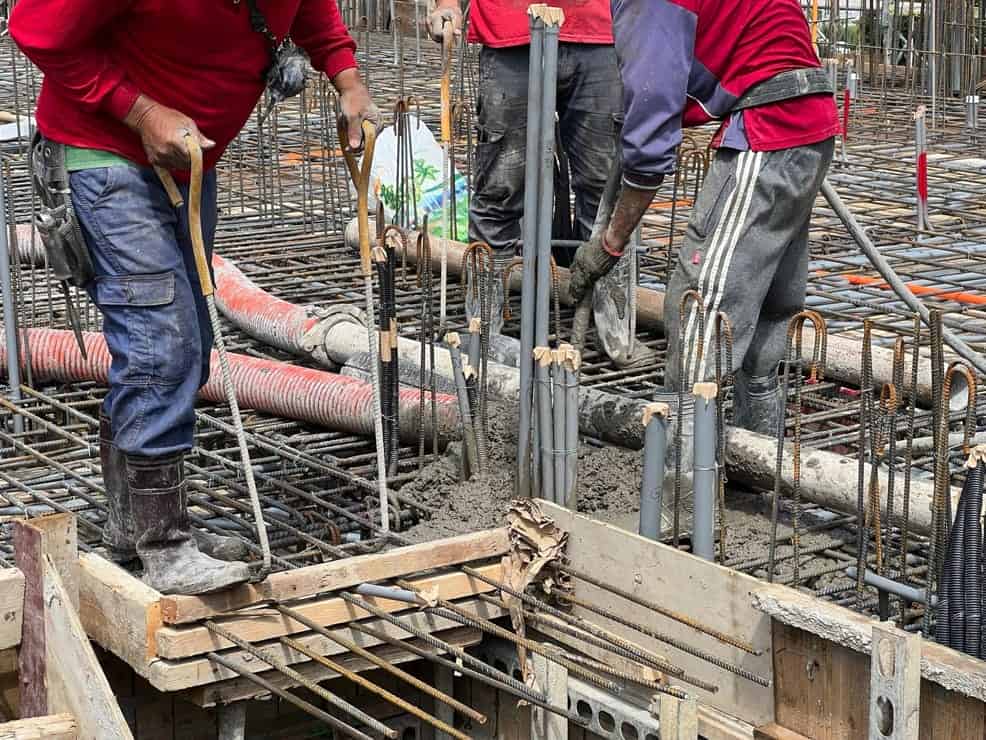

2022/06 5FL concrete placement
-
-
07
2022
-

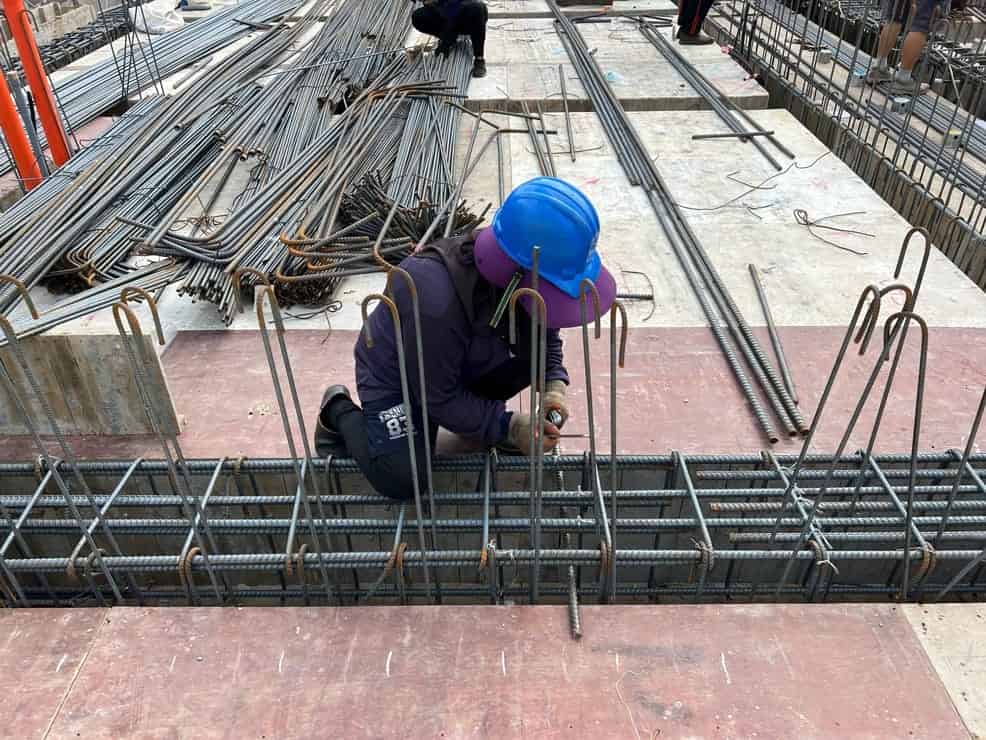

2022/07 7FL beam reinforcement binding
-
-
08
2022
-

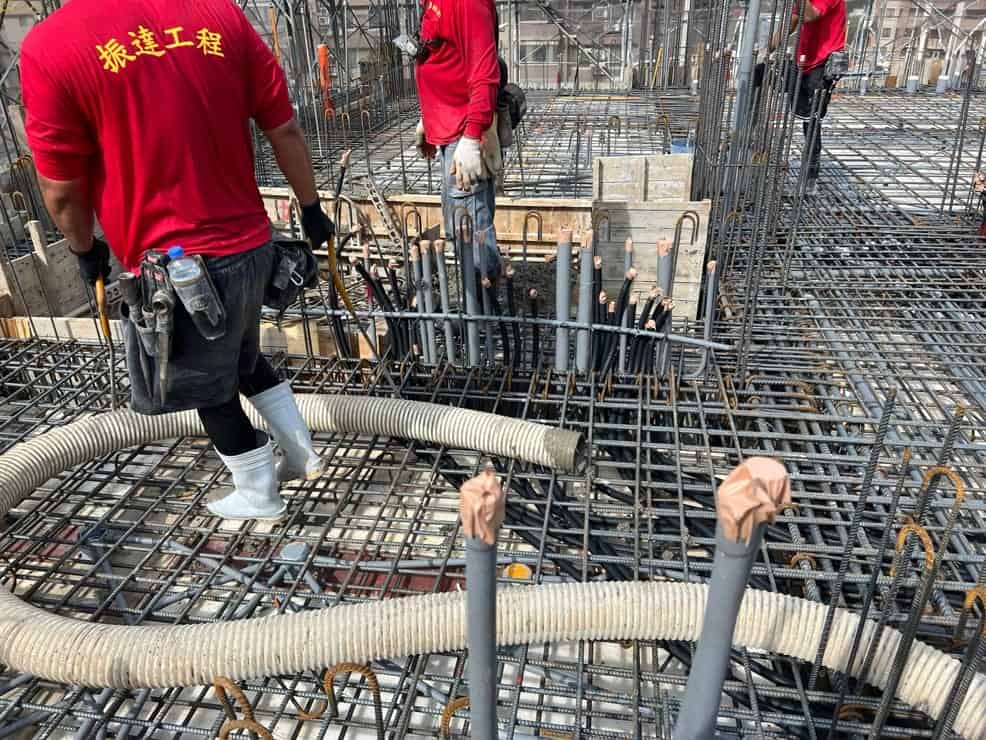

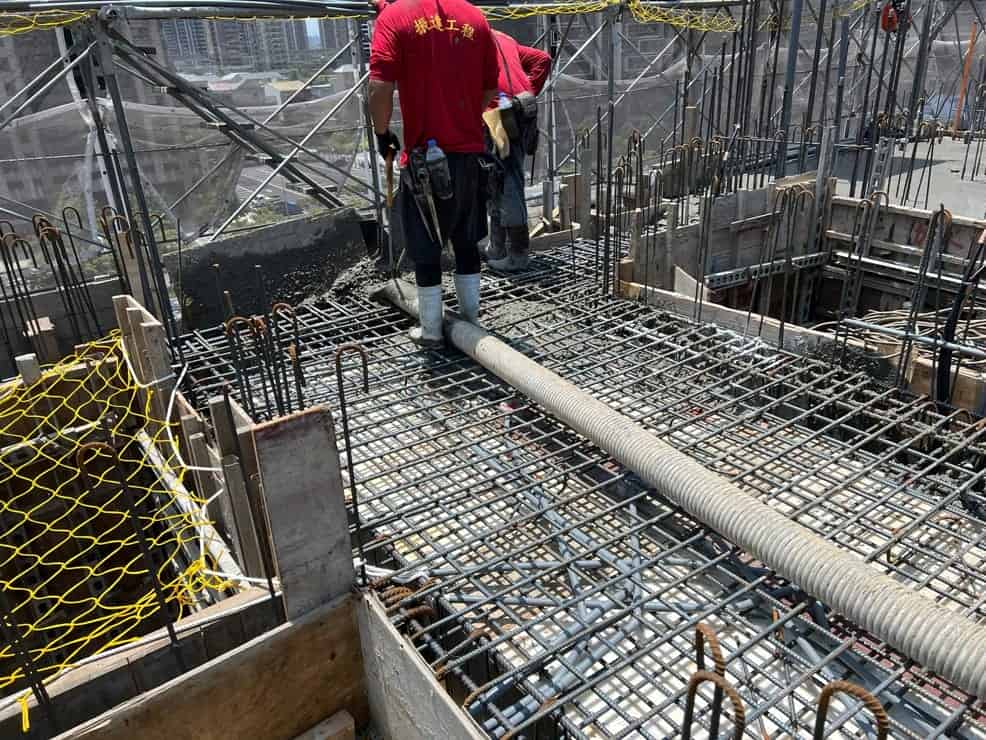

2022/08 8FL concrete placement -
2022/08 8FL concrete placement
-
-
09
2022
-

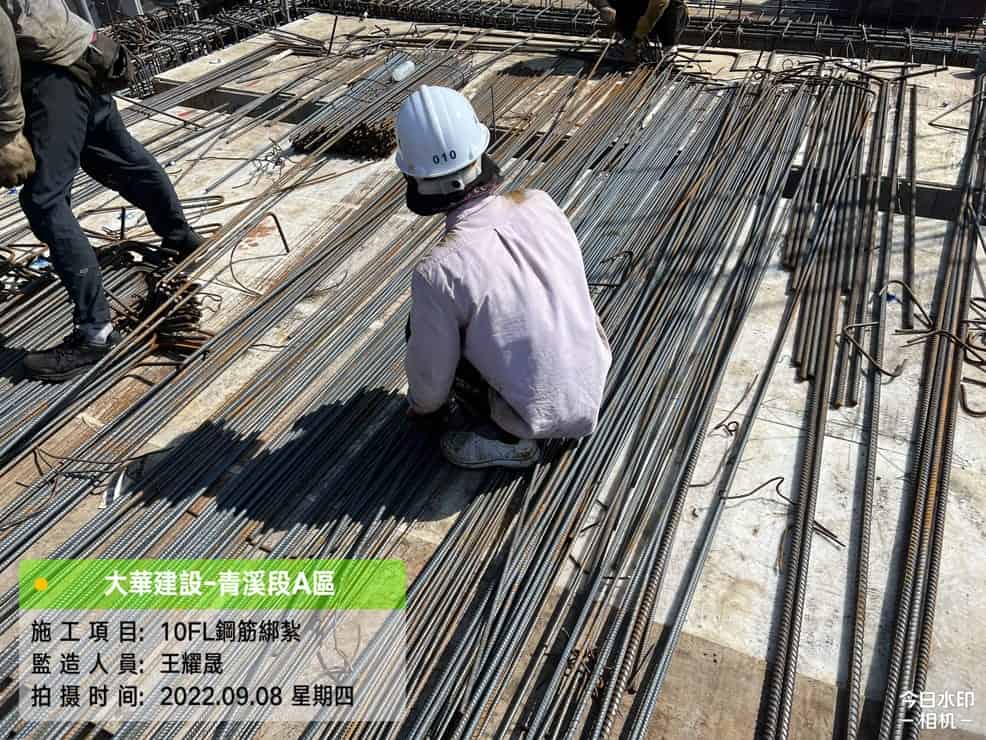

2022/09 10FL beam reinforcement binding
-
-
10
2022
-

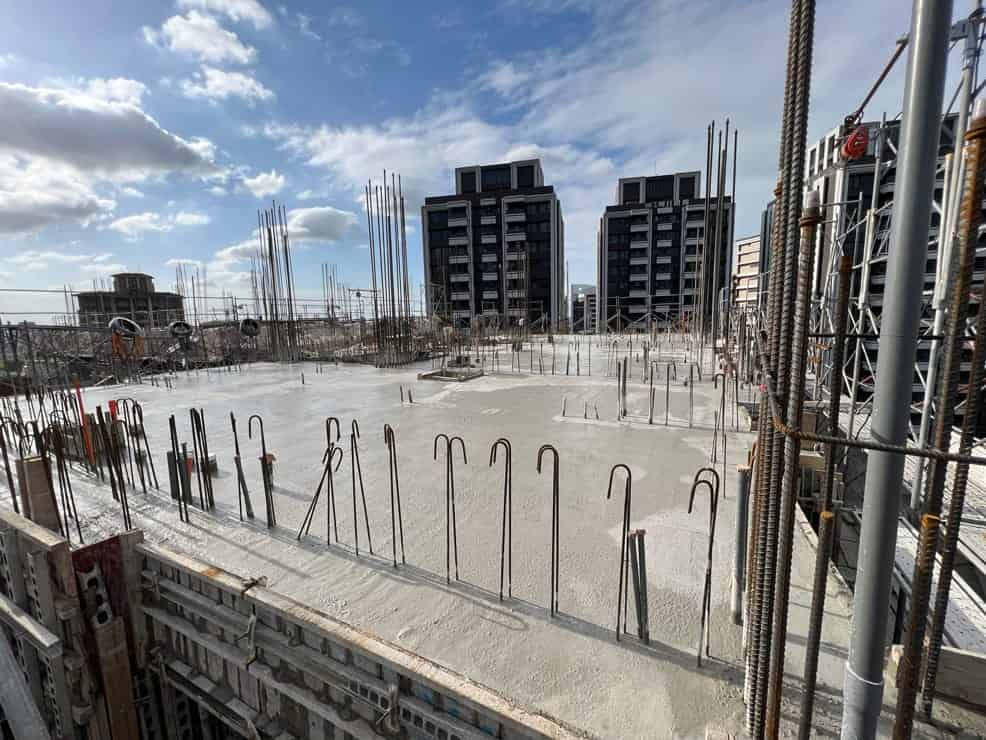

2022/10 12FL concrete placement -
2022/10 12FL concrete placement
-
-
11
2022
-

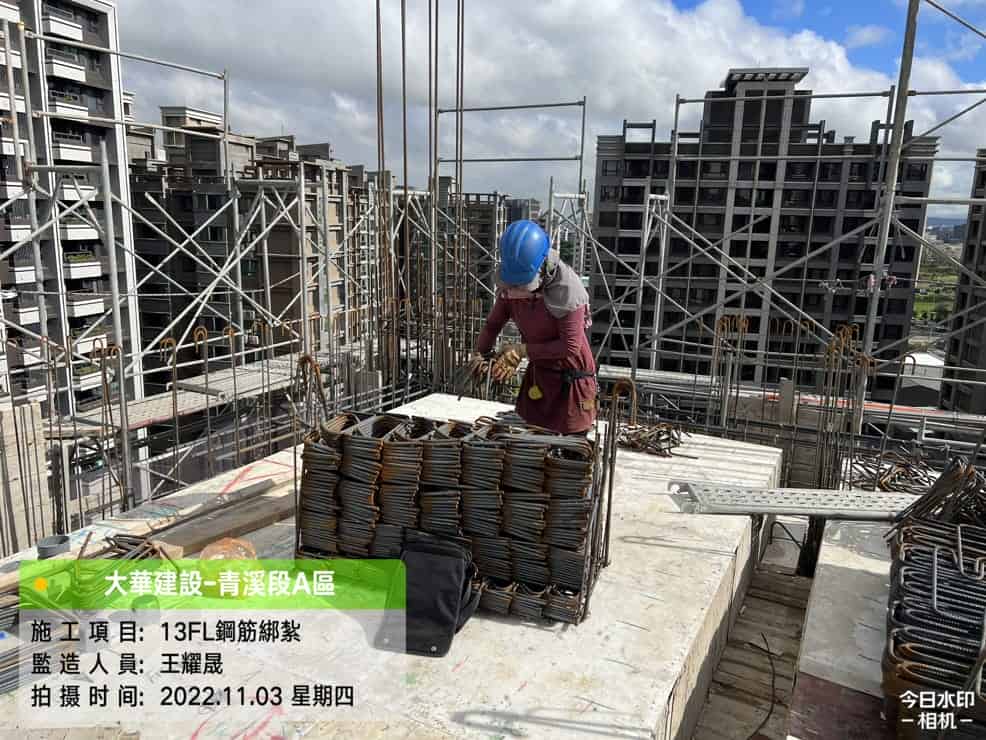

2022/11 13FL beam reinforcement binding -

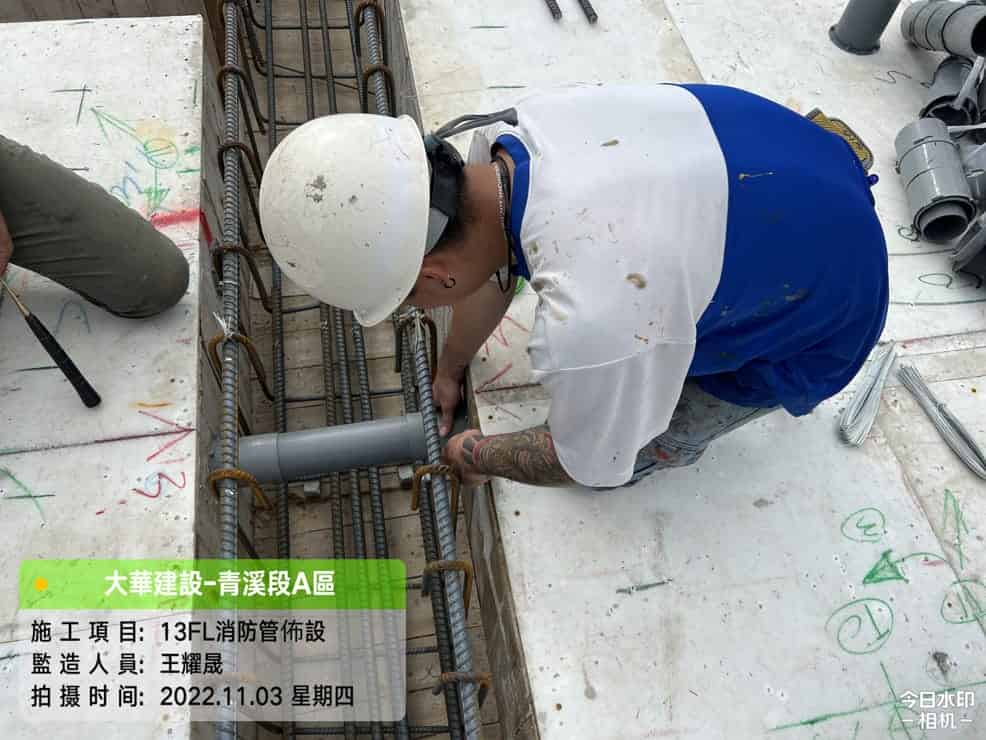

2022/11 13FL water and electricity piping
-
-
12
2022
-

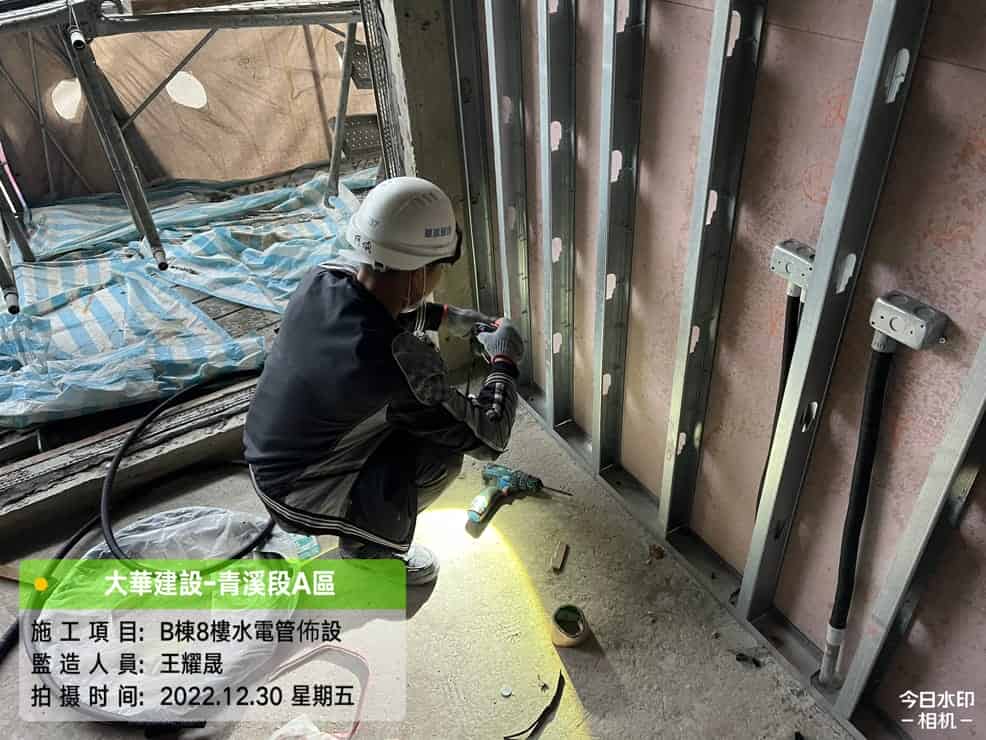

2022/12 water, electricity and piping) -

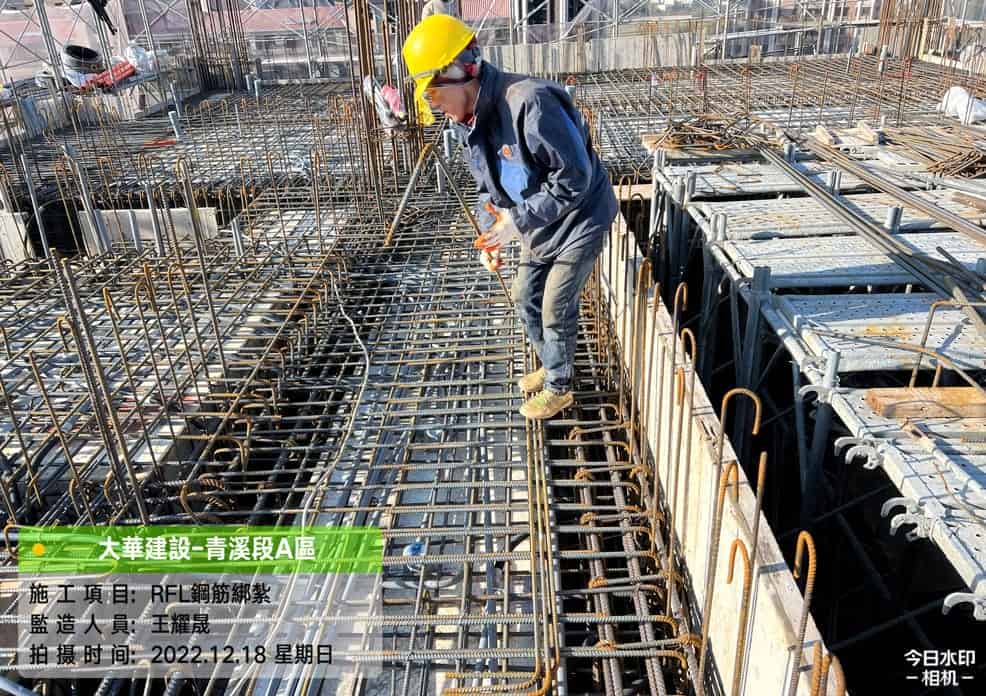

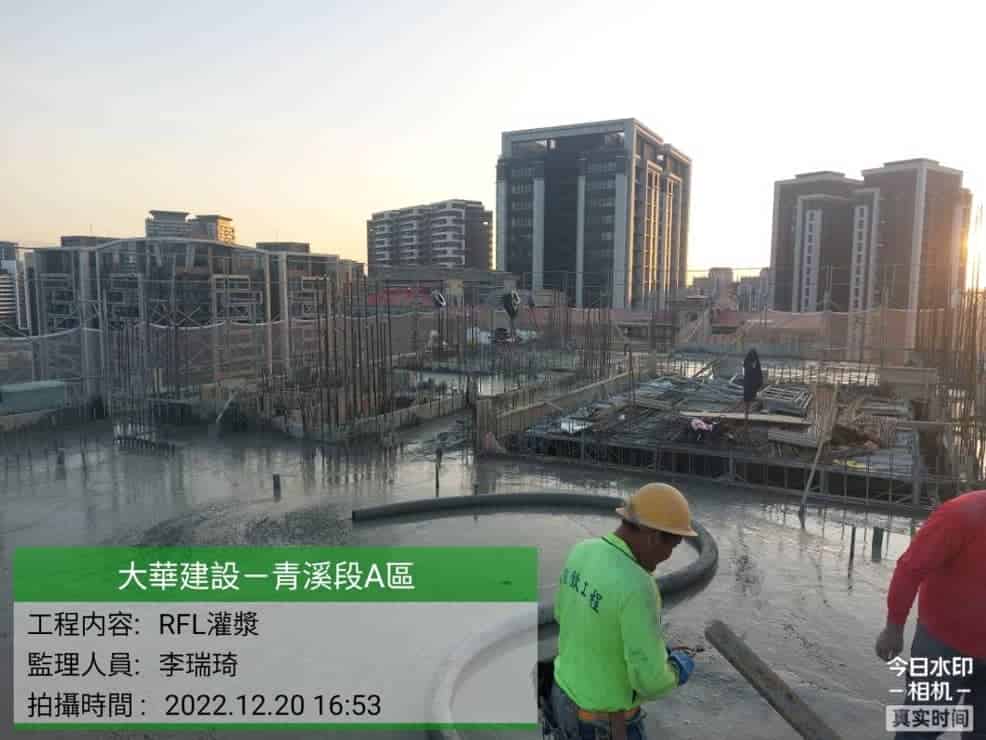

2022/12 RFL grouting) -
2022/12 RFL steel bar binding
-
-
01
2023
-

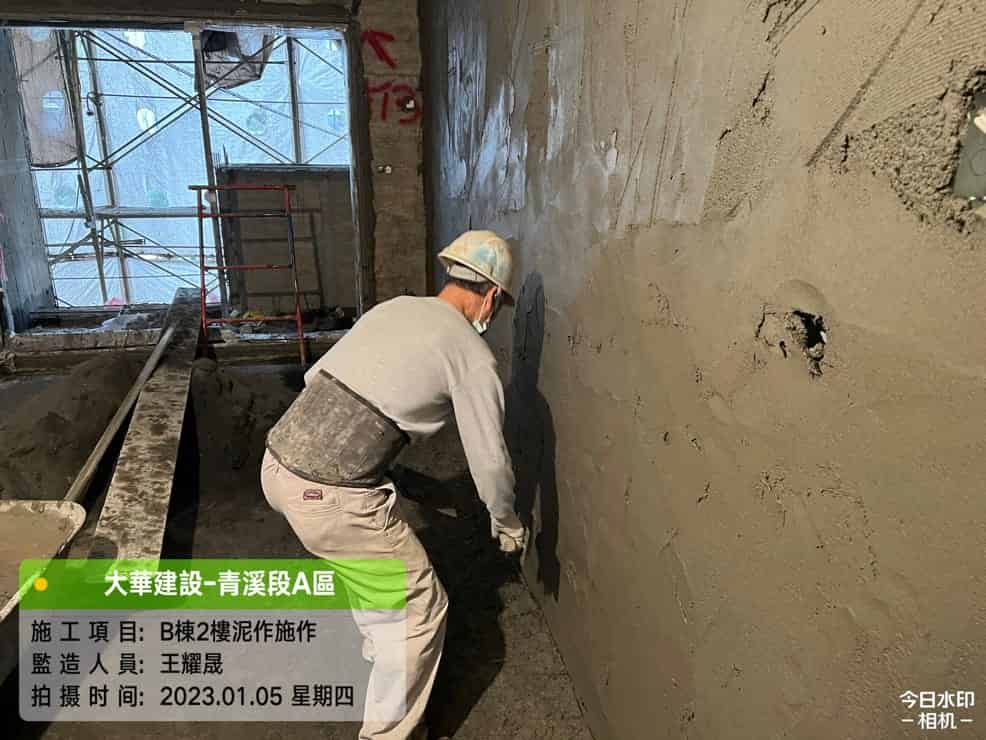

2023/01 mud work -

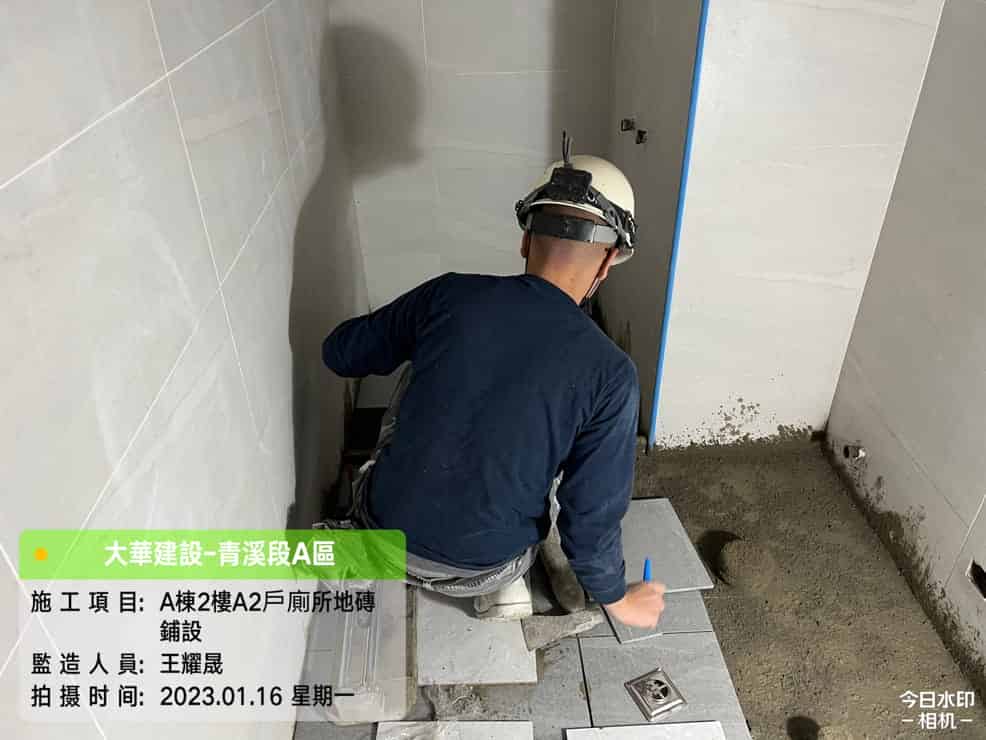

2023/01 bath and toilet floor tiles -

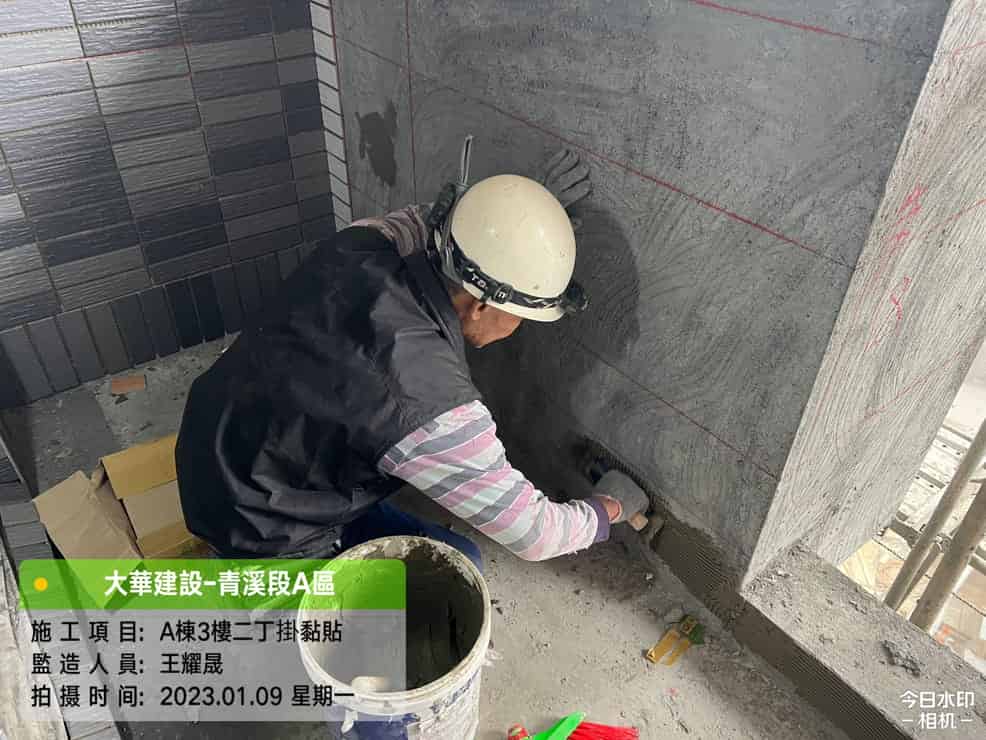

2023/01 exterior wall hanging stickers -

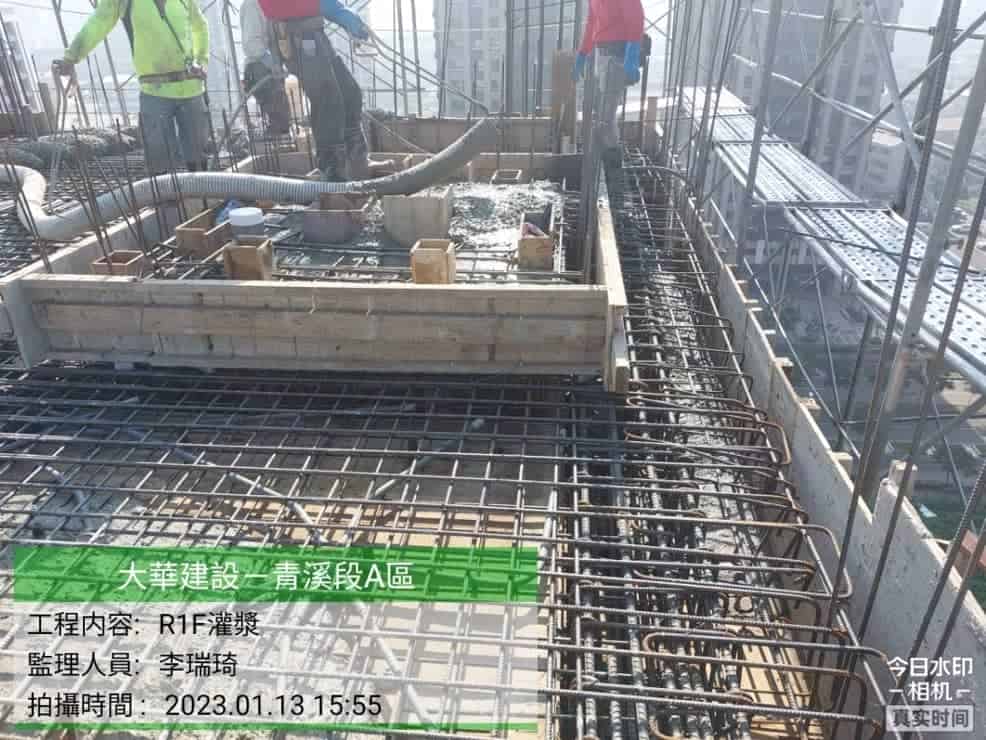

2023/01 R1 Grouting 01 -

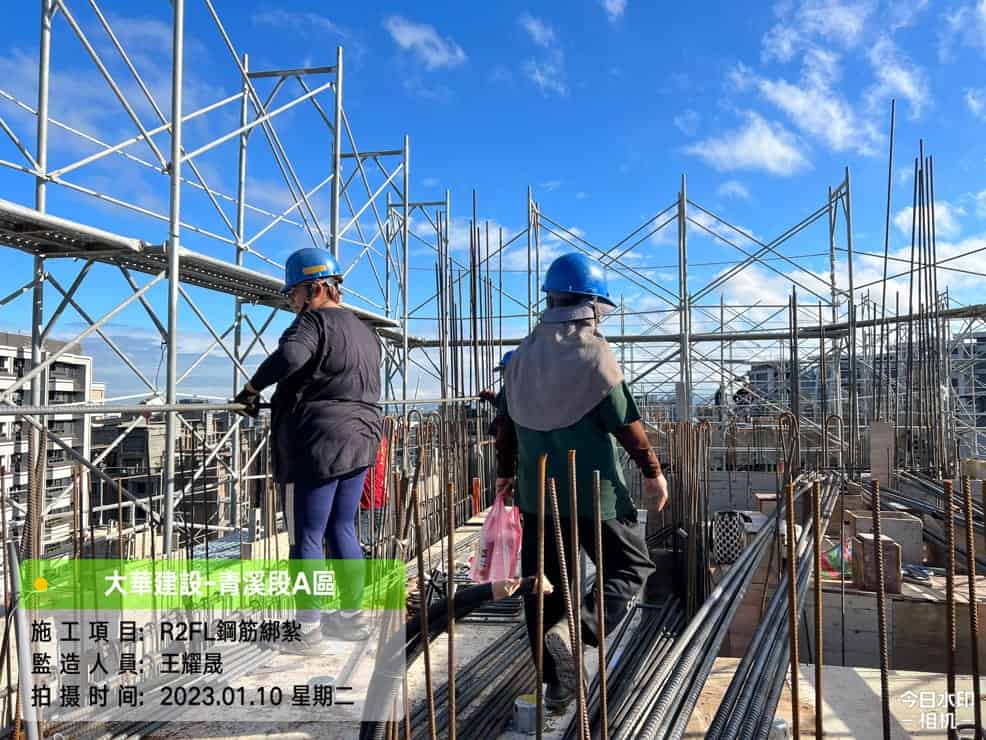

2023/01 R2FL steel bar binding
-
-
02
2023
-

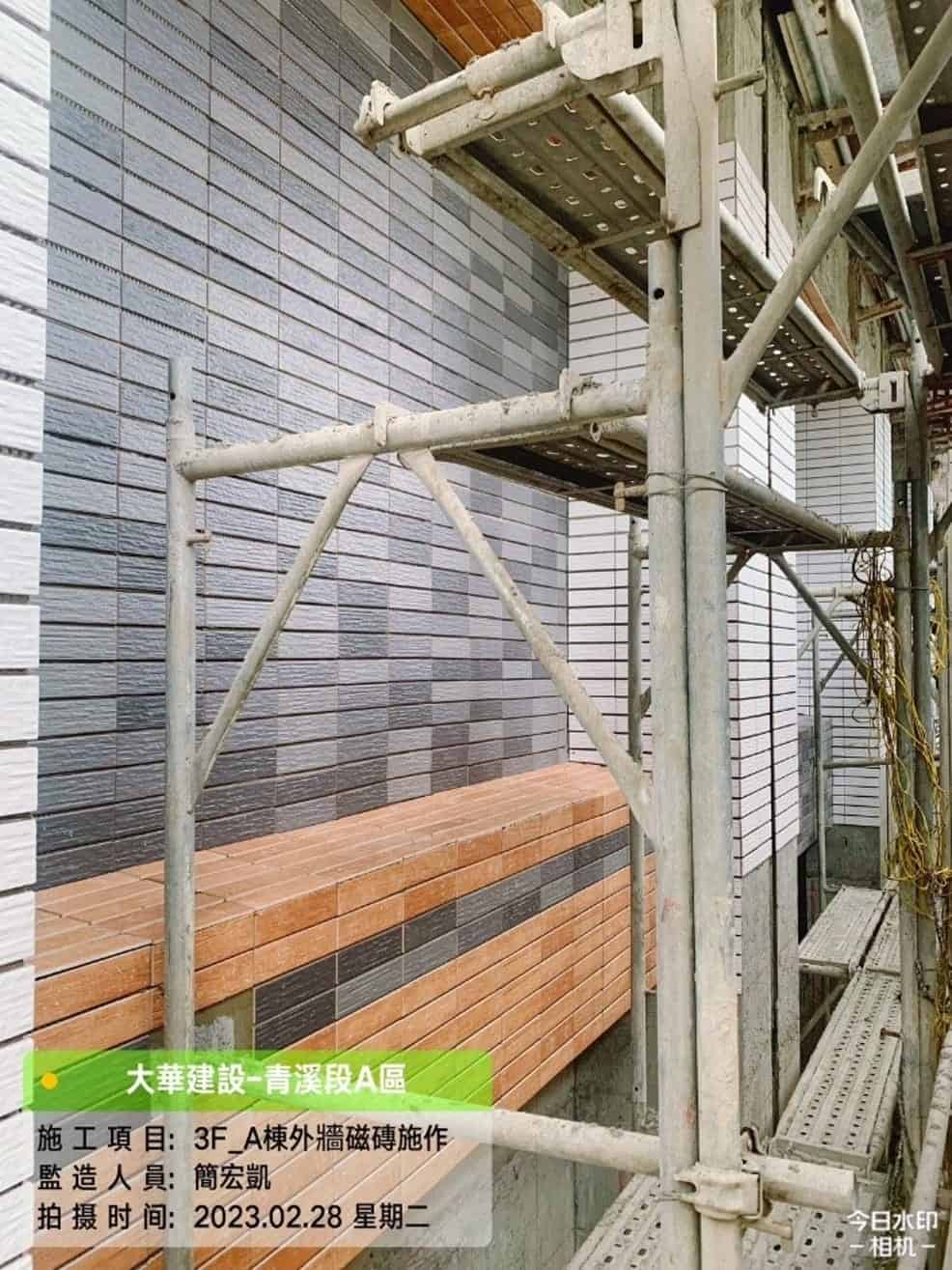

2023/02 3F exterior wall tiling -

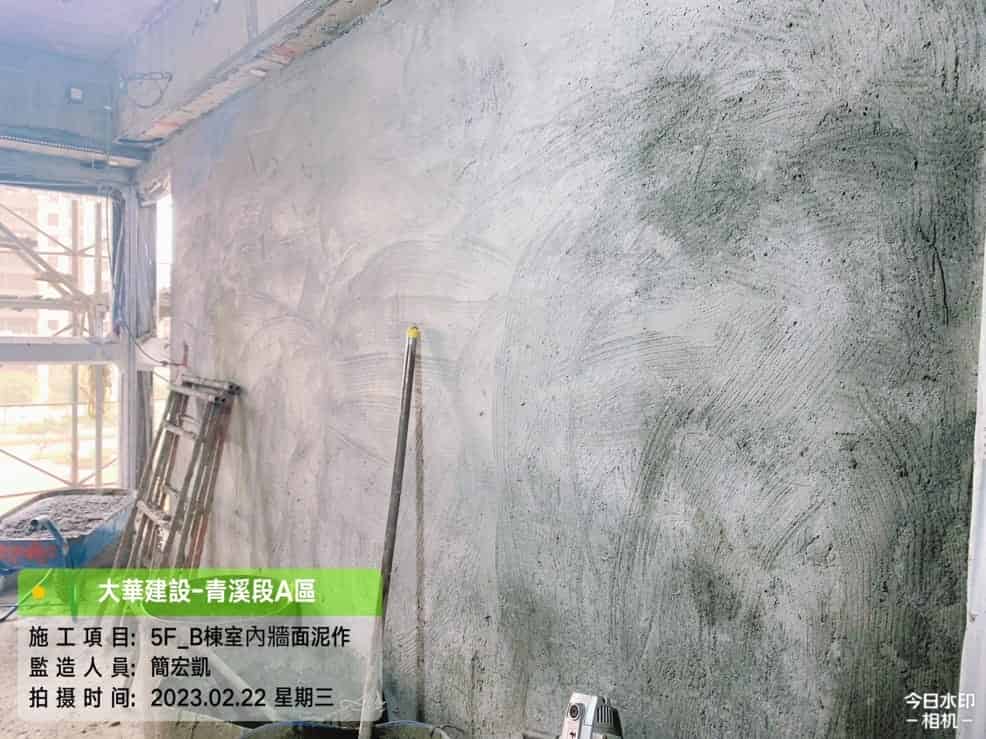

2023/02 5F indoor mud base
-
-
03
2023
-

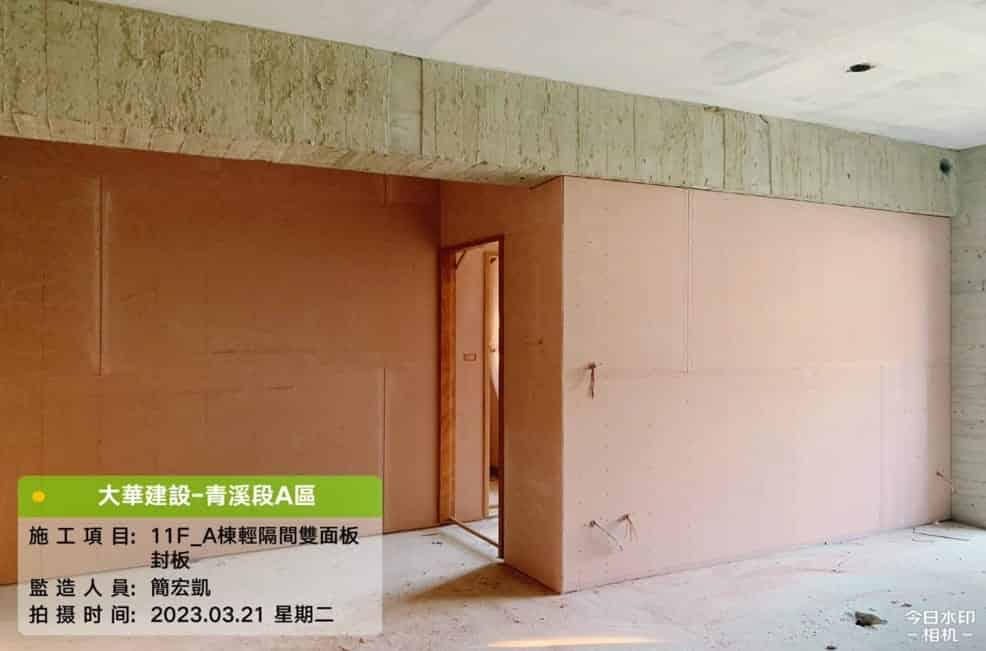

2023/03 11F light partition seal -

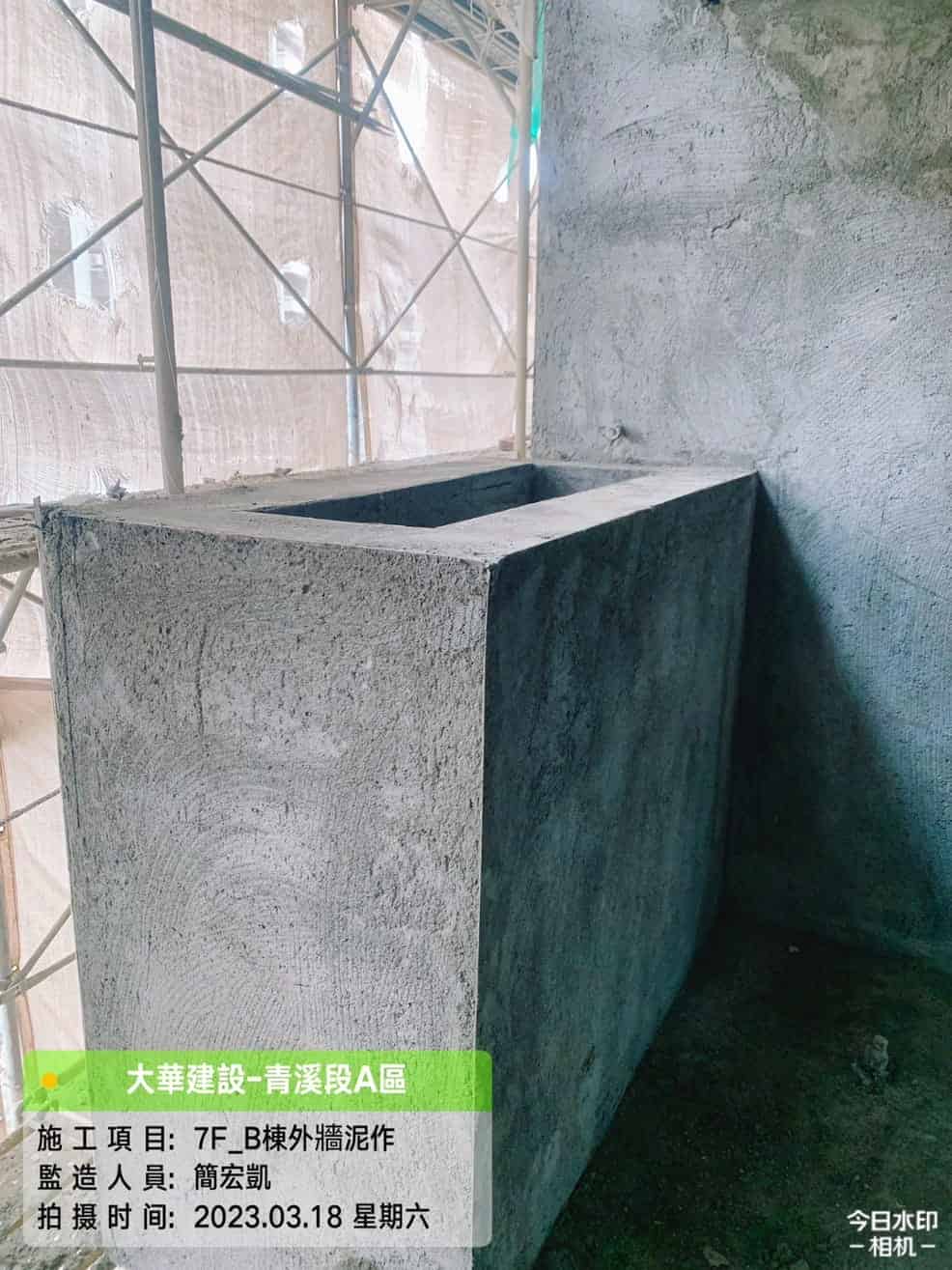

2023/03 7F Exterior wall mud as base
-
-
04
2023
-

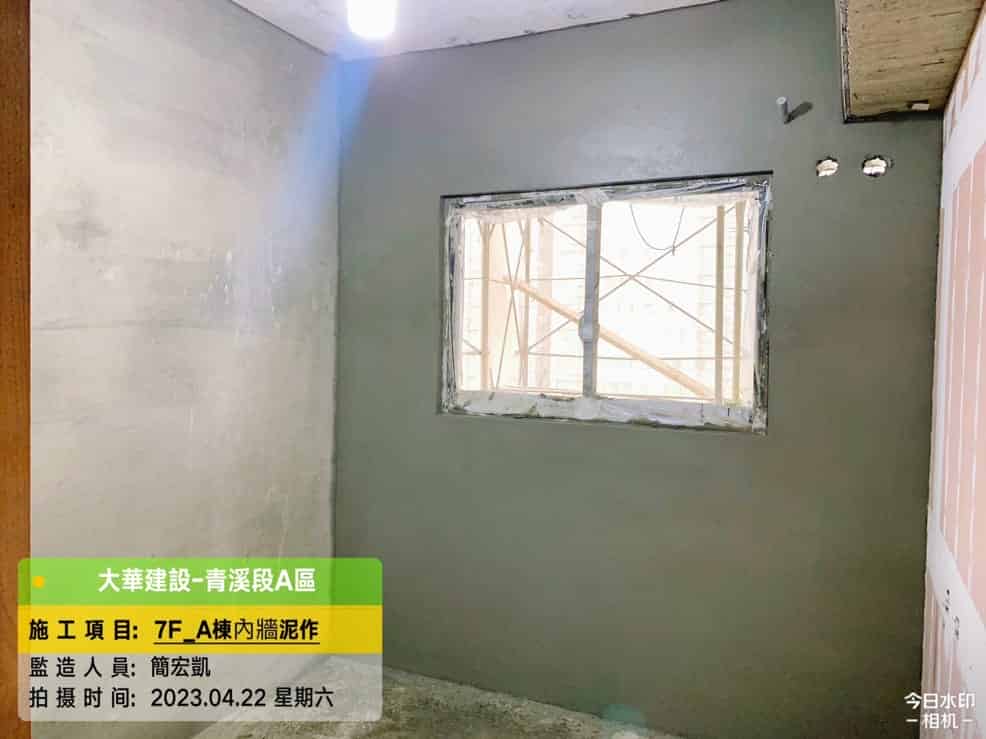

2023/04 Interior wall plaster work on 7F, Building A -

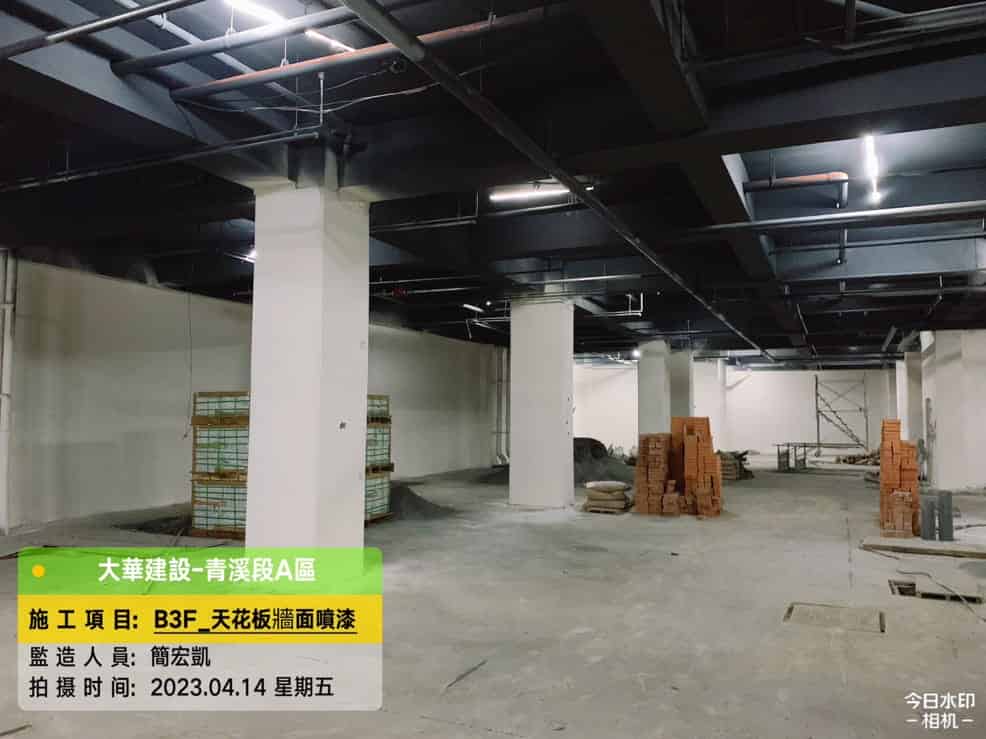

2023/04 B3F paint application
-
-
05
2023
-

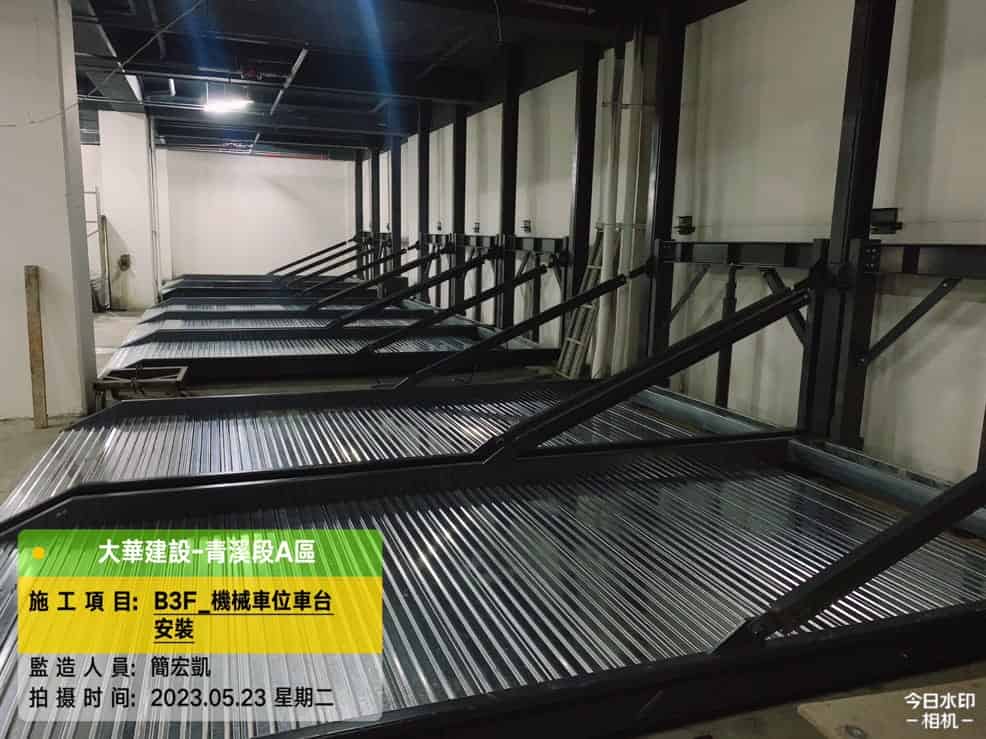

2023/05 B3F mechanical parking space platform installation -

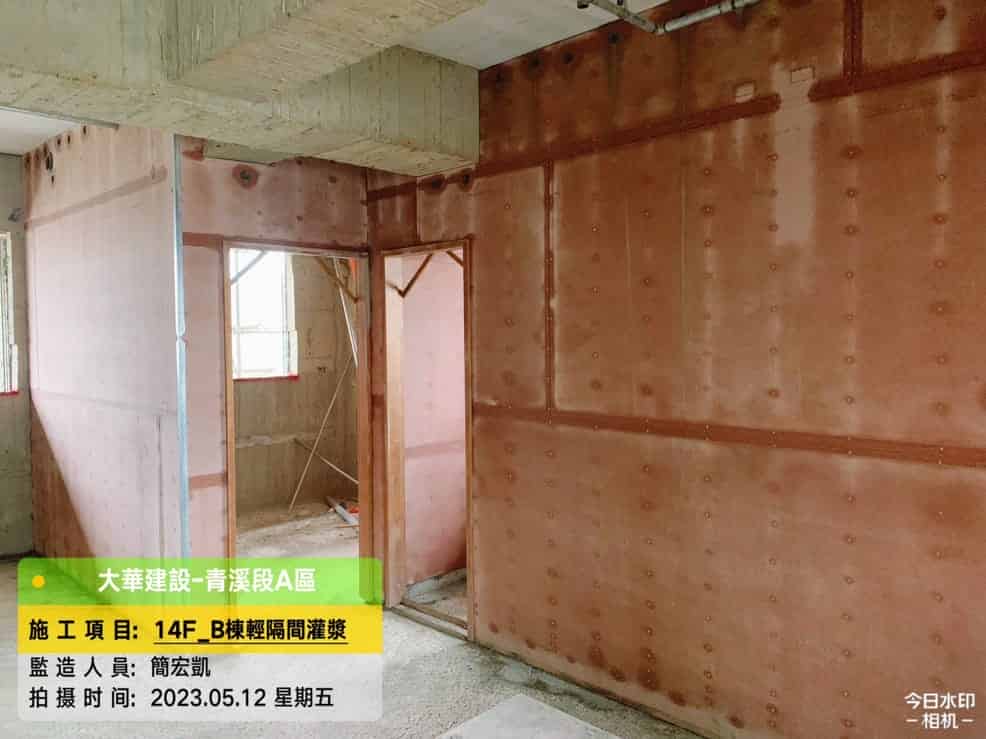

2023/05 Grouting of 14F light compartment in Building B
-
-
06
2023
-

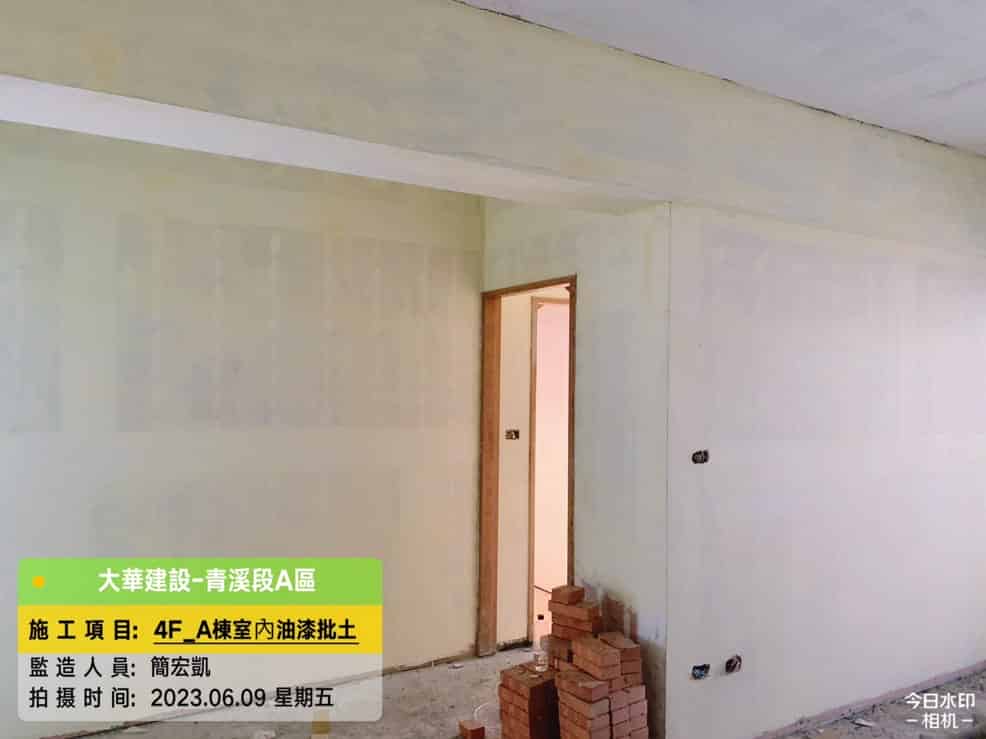

2023/06 4F interior paint -

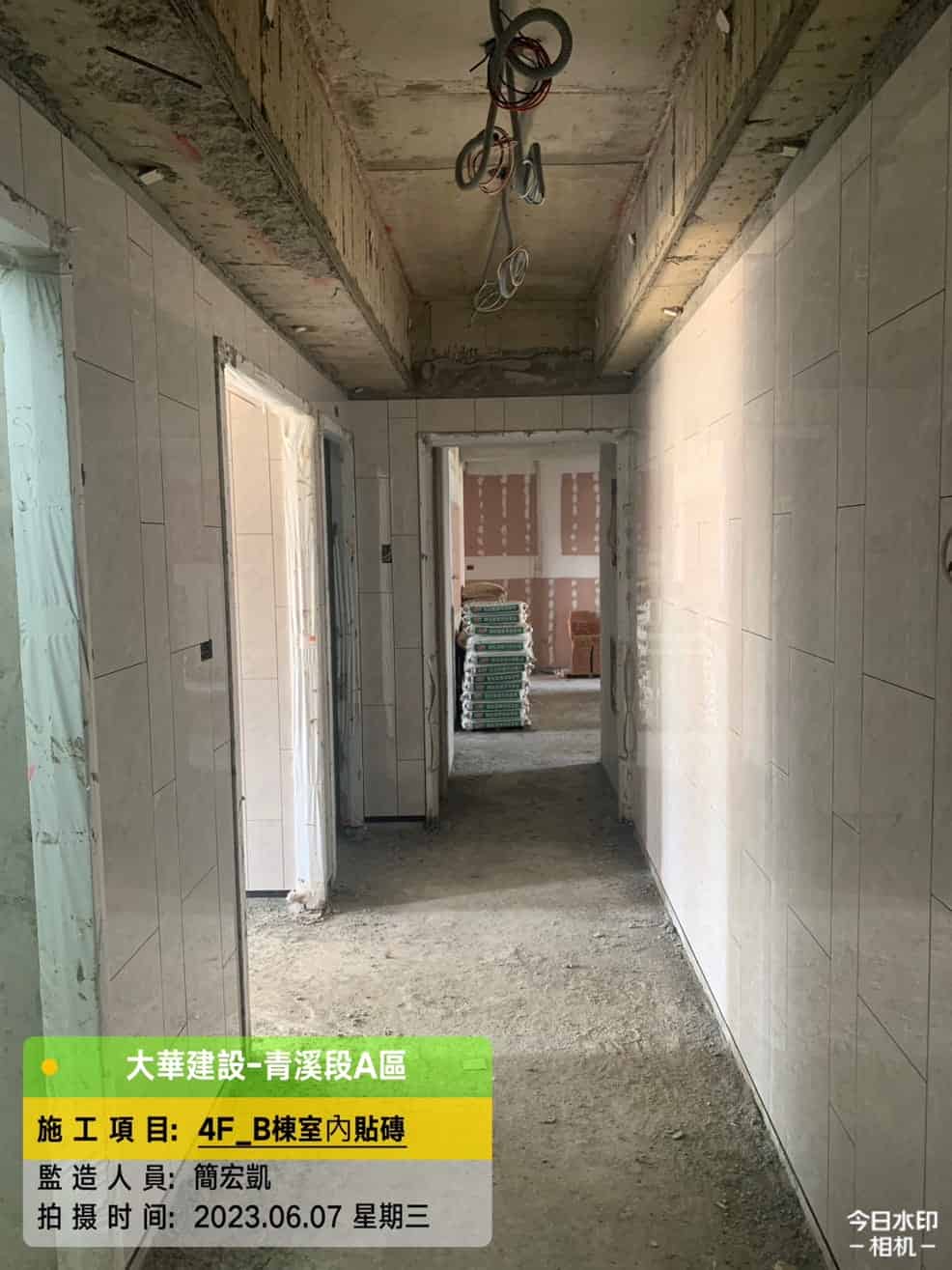

2023/06 4F indoor wall tiles -

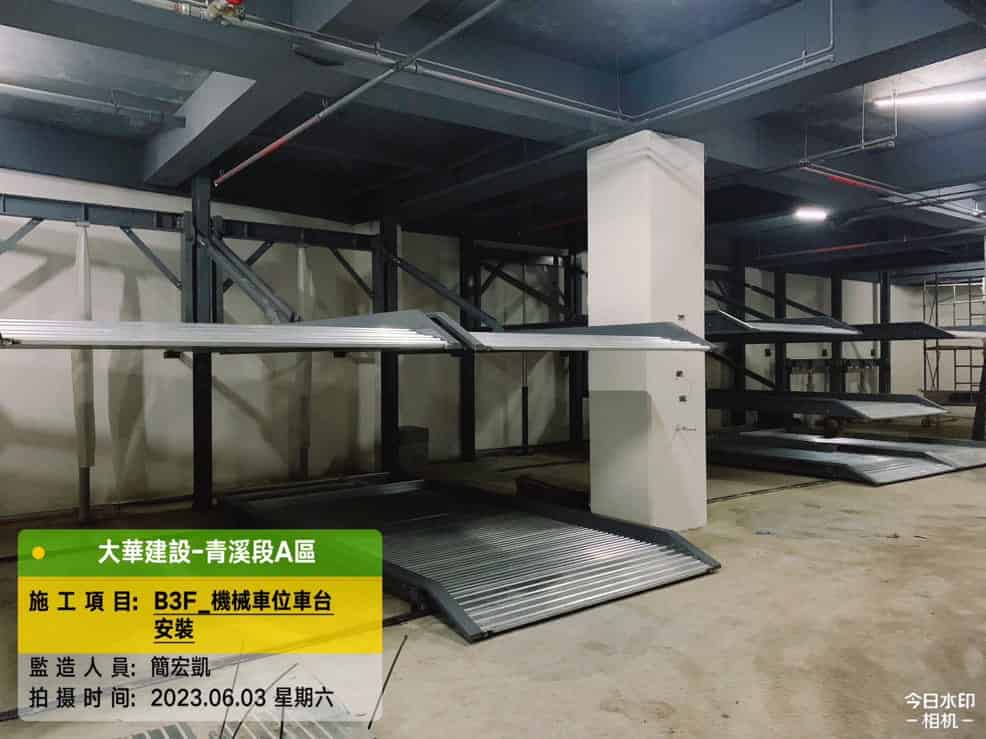

2023/06 B3F mechanical parking space platform installation
-
-
07
2023
-

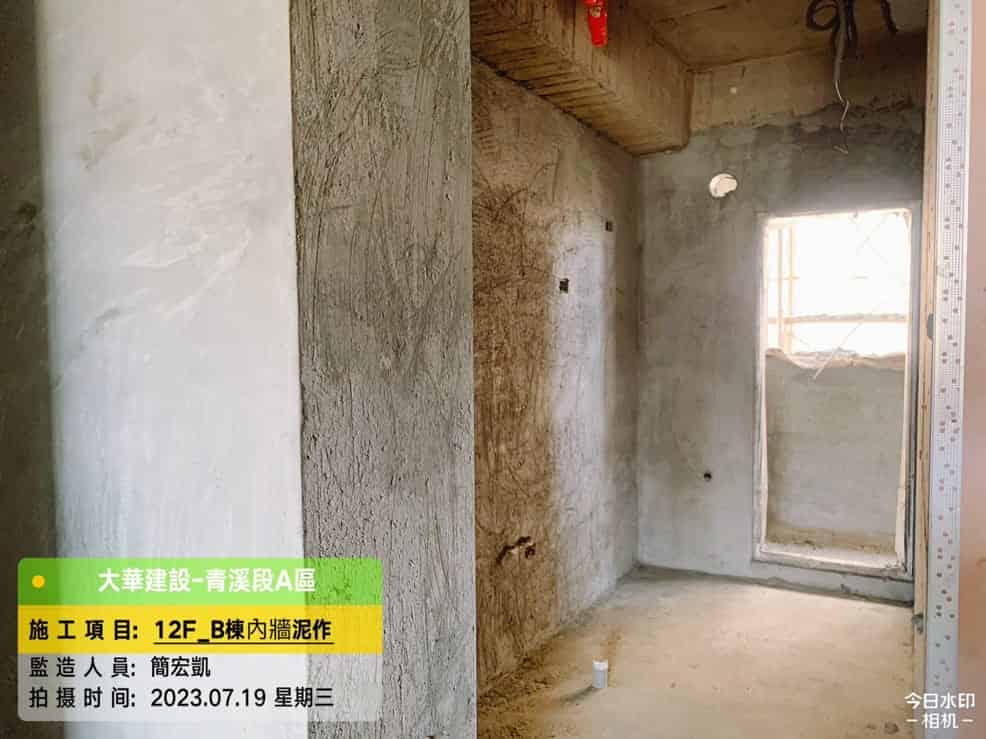

2023/07 12F indoor mud work -

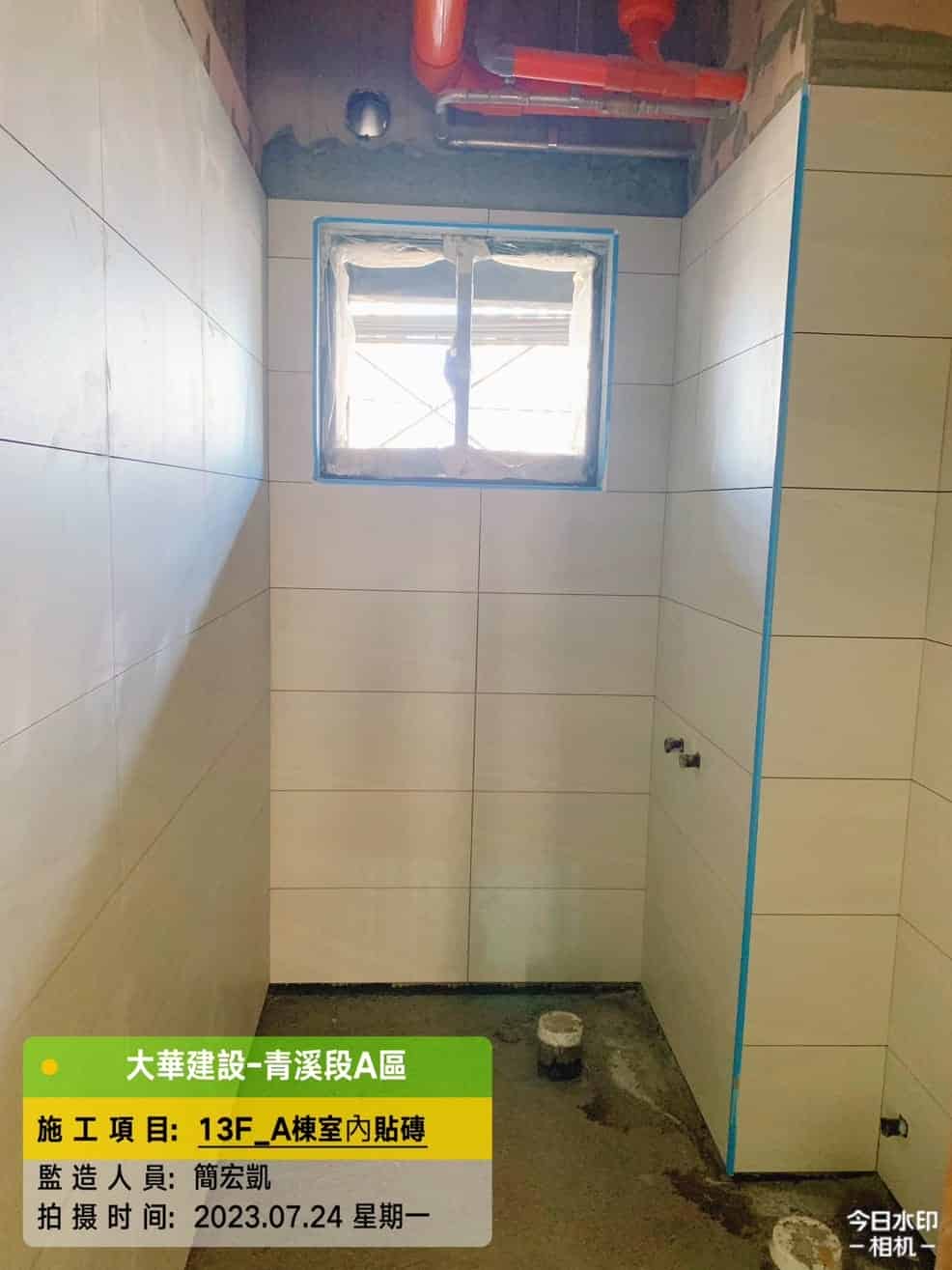

2023/07 13F indoor tiling -

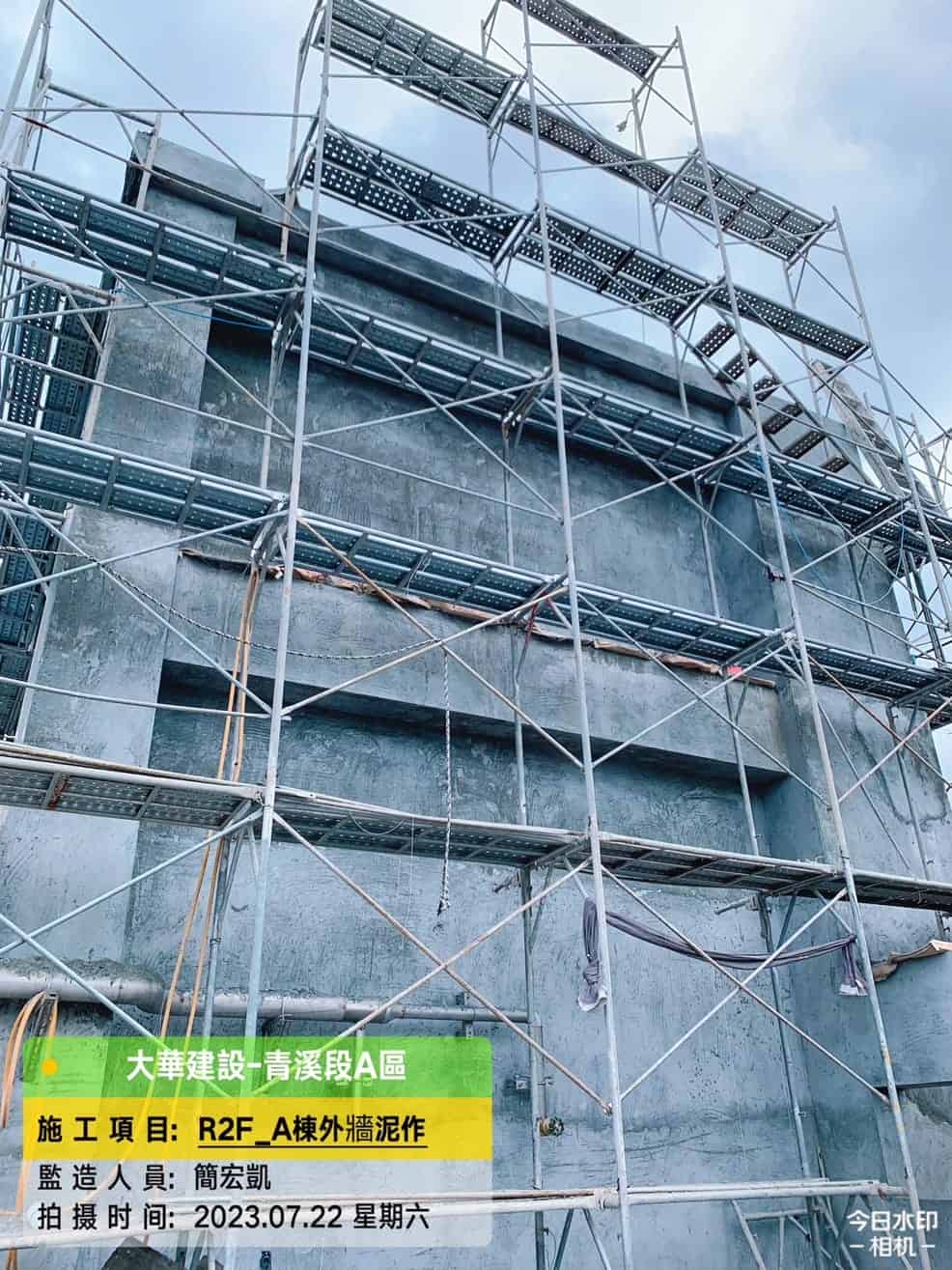

2023/07 RF exterior wall plaster work
-
-
08
2023
-

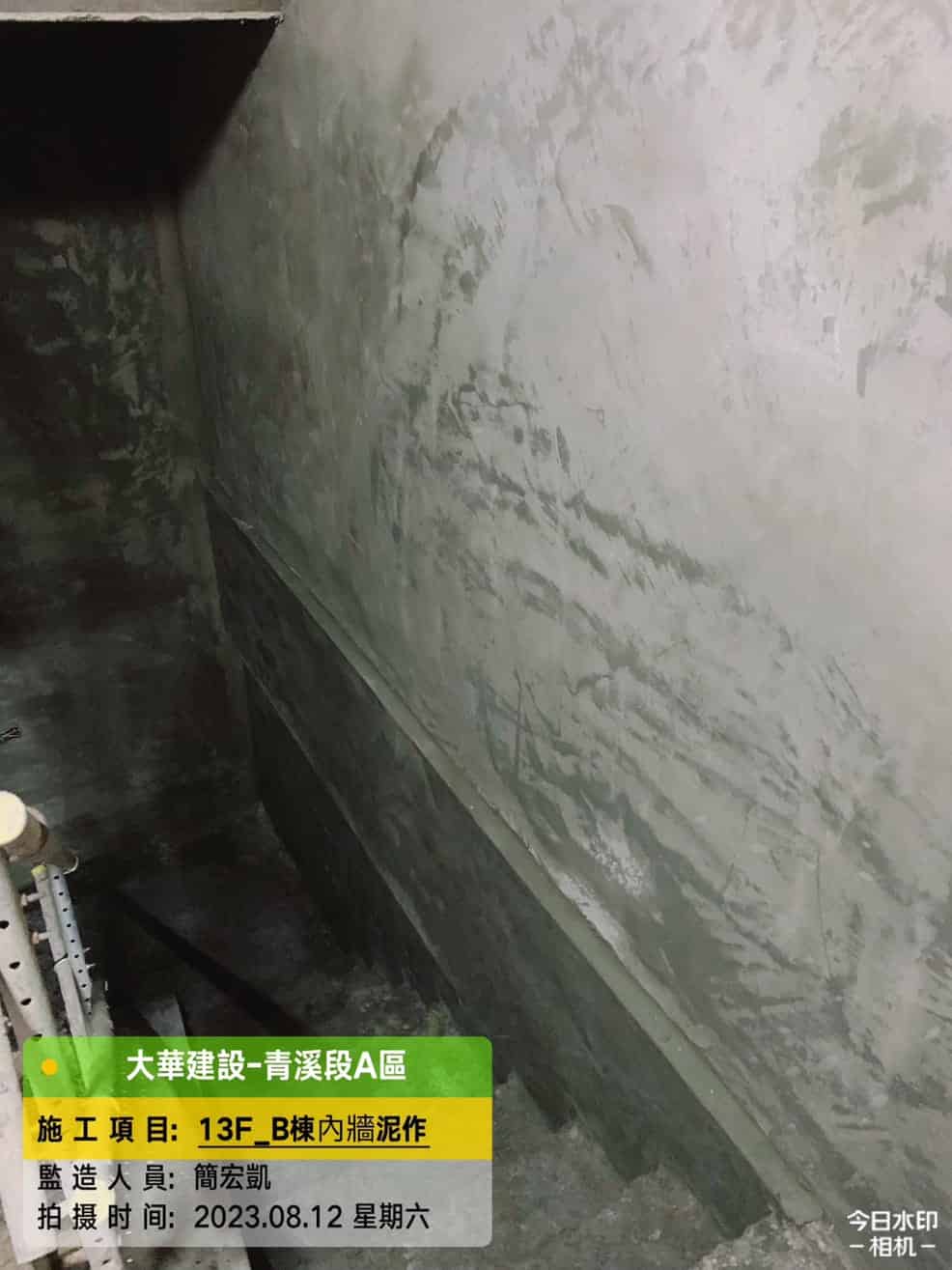

2023/08 13F indoor mud work -

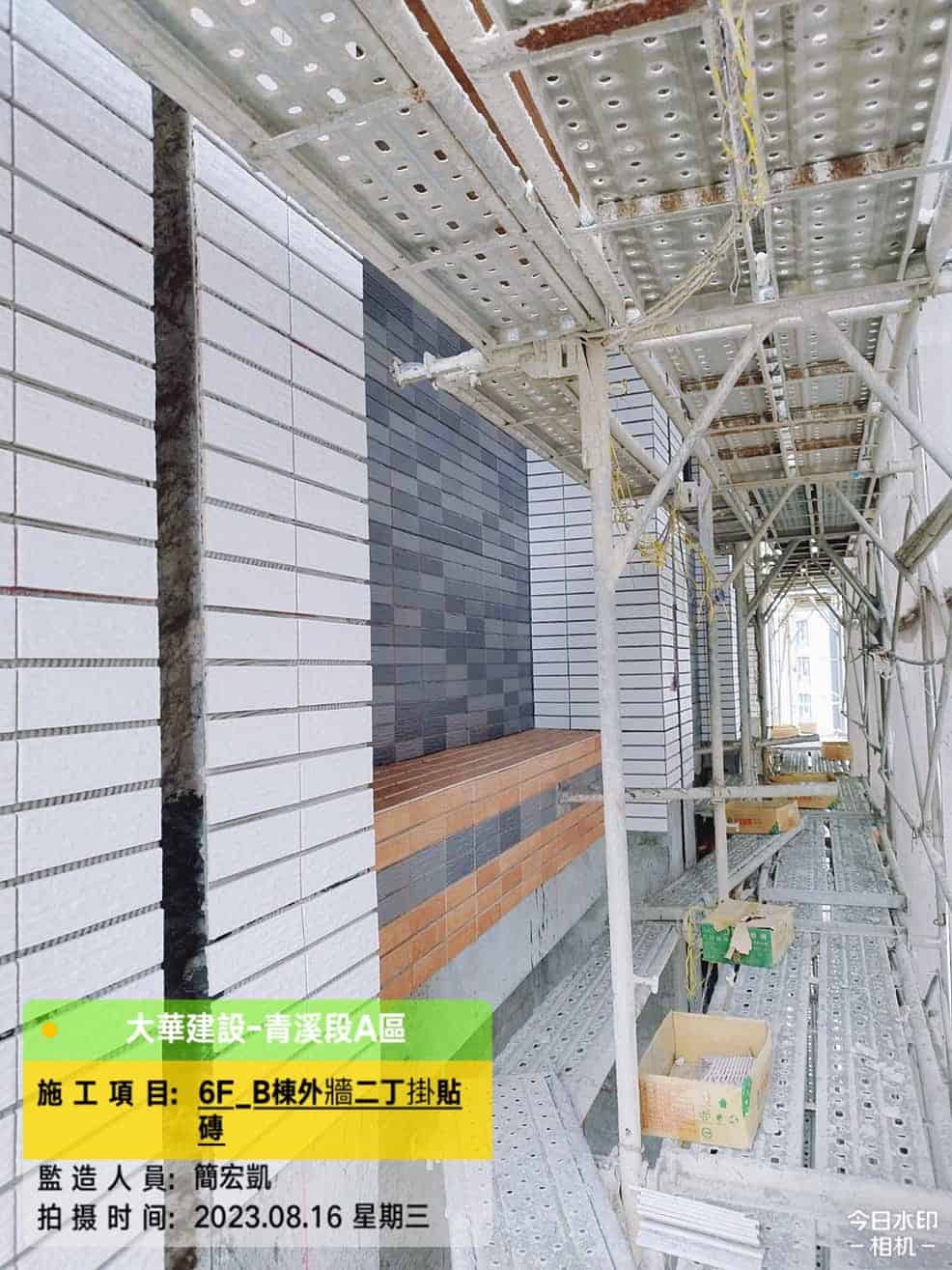

2023/08 6F exterior wall tiles -

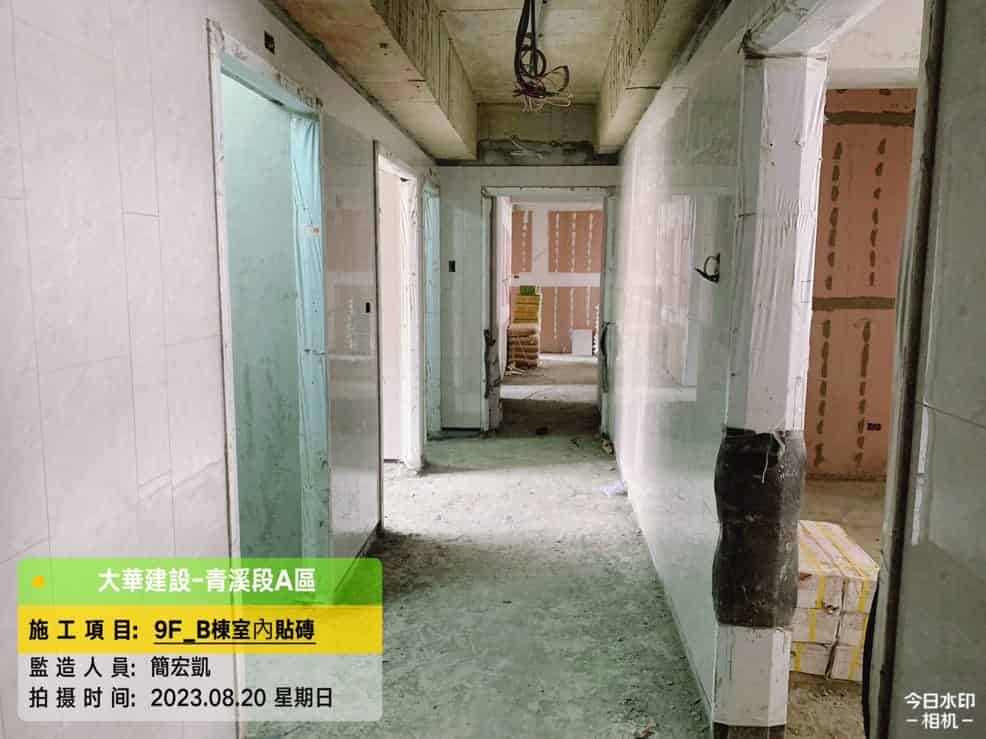

2023/08 9F indoor tiling
-
-
09
2023
-

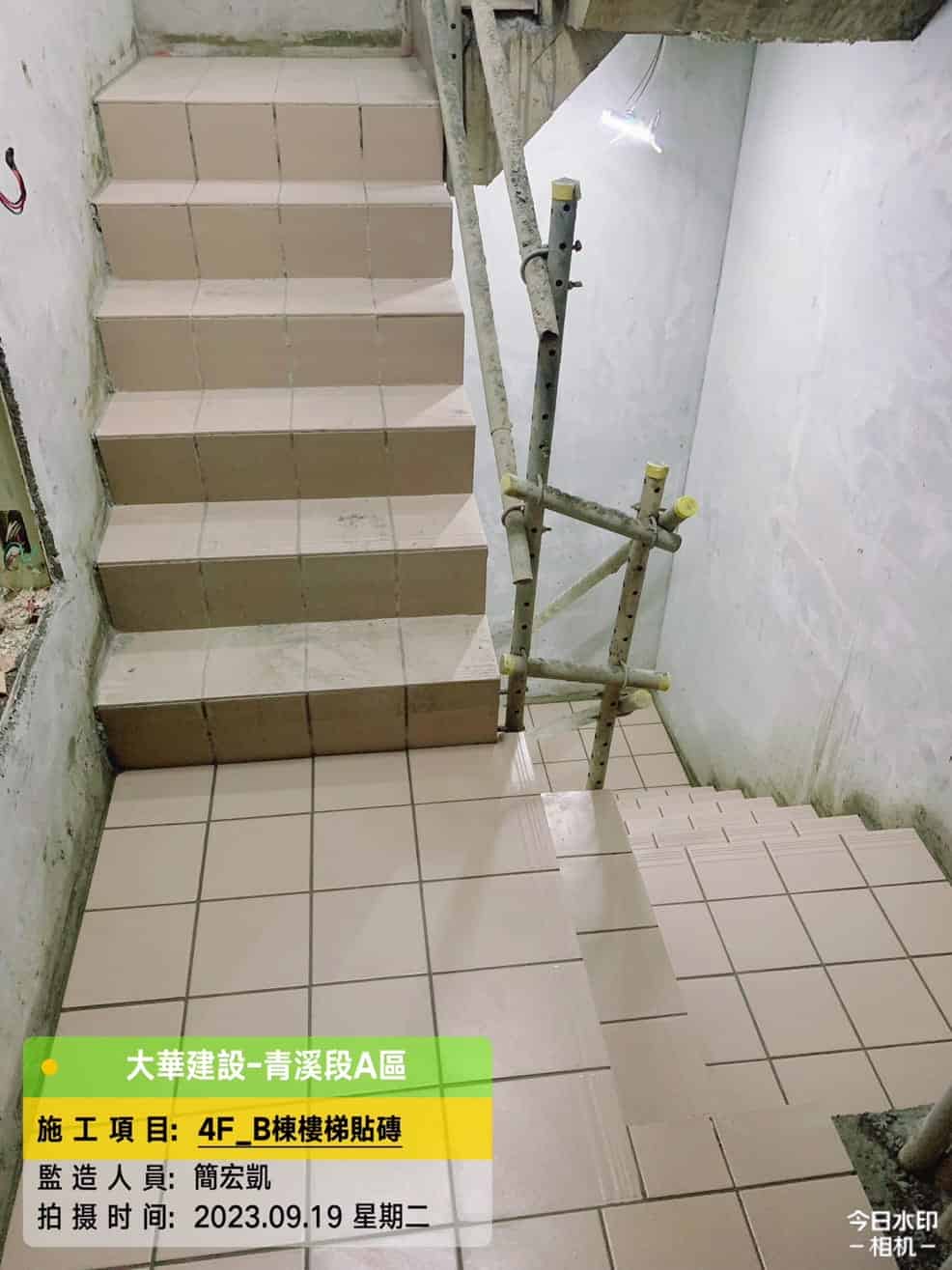

2023/09 4F stair tiling -

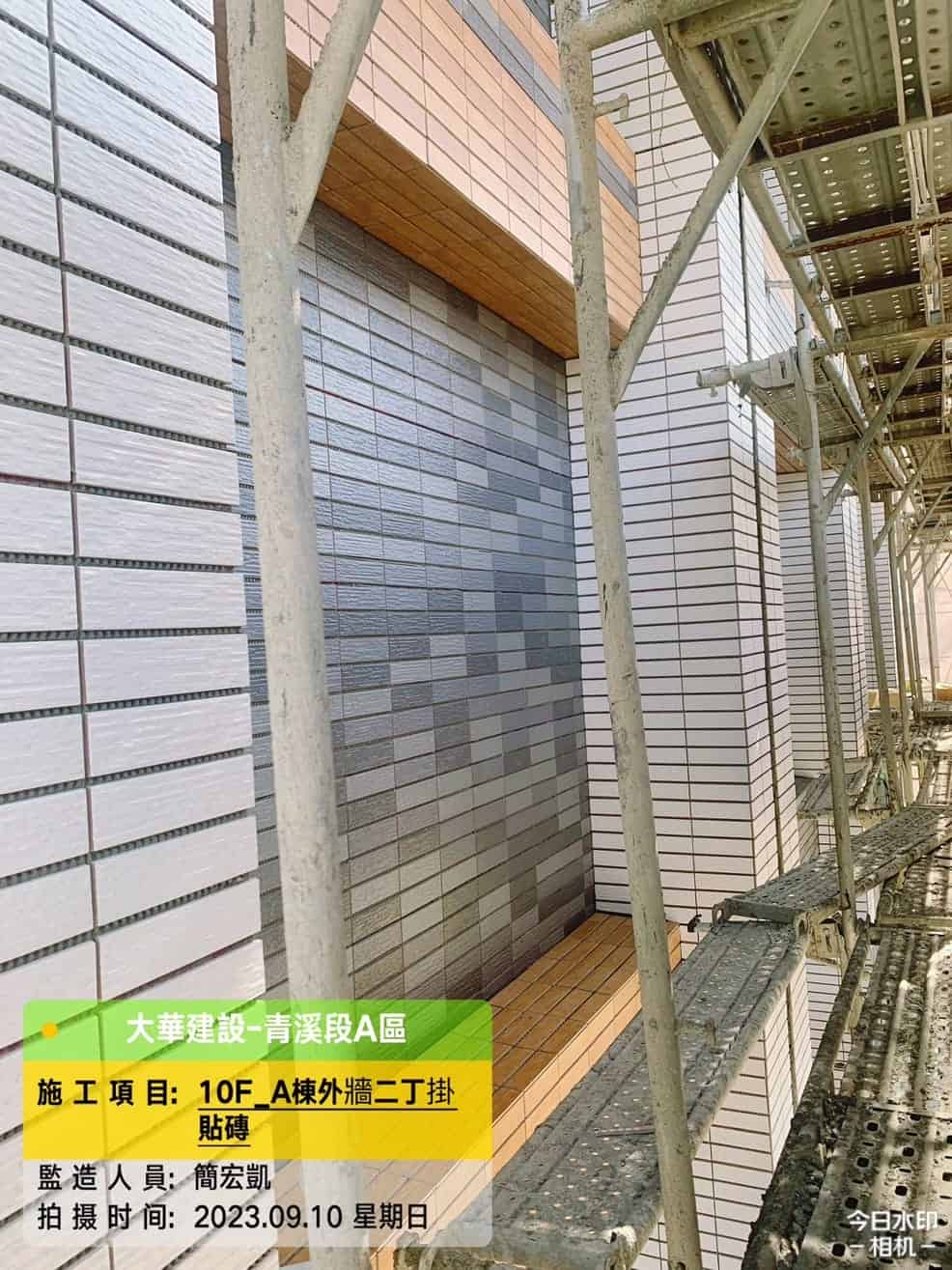

2023/09 10F exterior wall tiles -

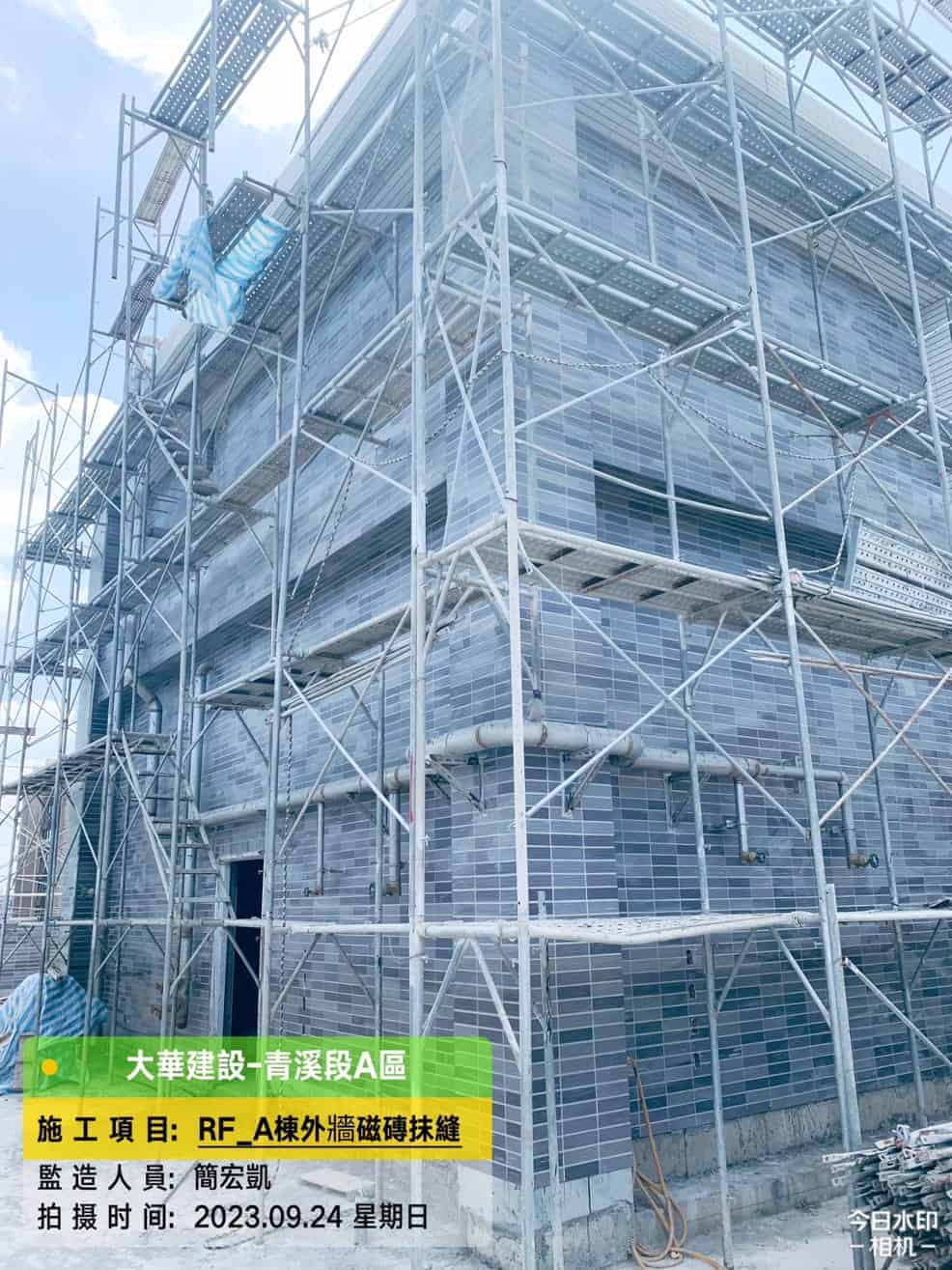

2023/09 Exterior wall decoration RF exterior wall caulking
-
-
10
2023
-

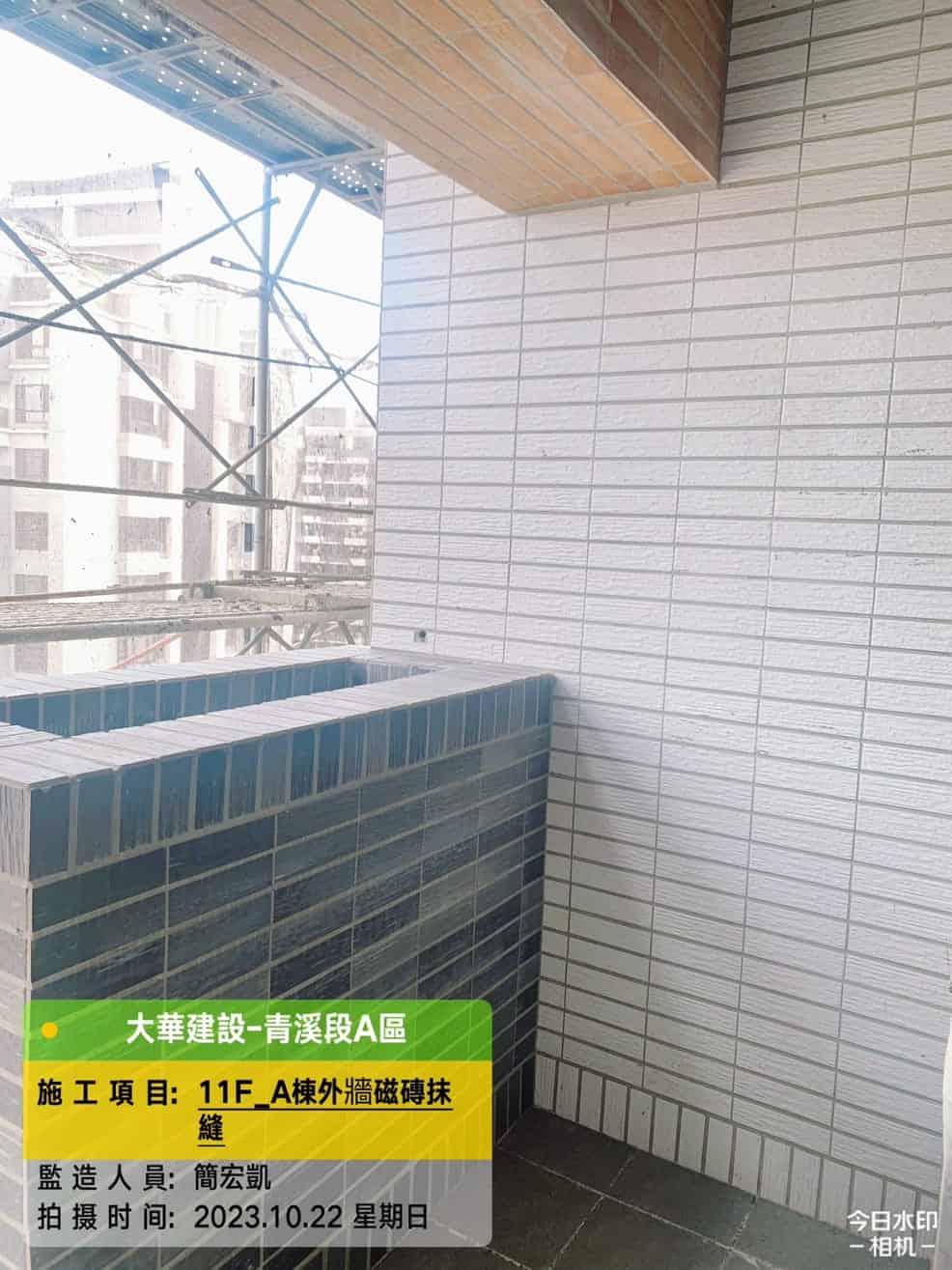

2023/10 Exterior wall tile joints on 11F, Building A -

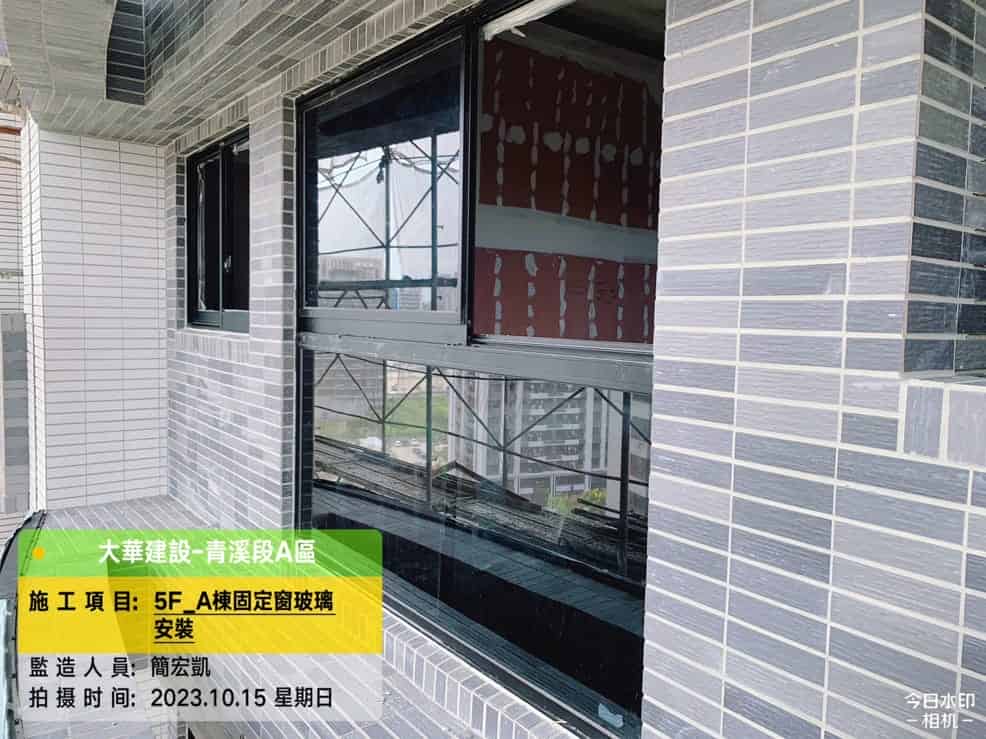

2023/10 Installation of aluminum window glass on 5F, Building A -

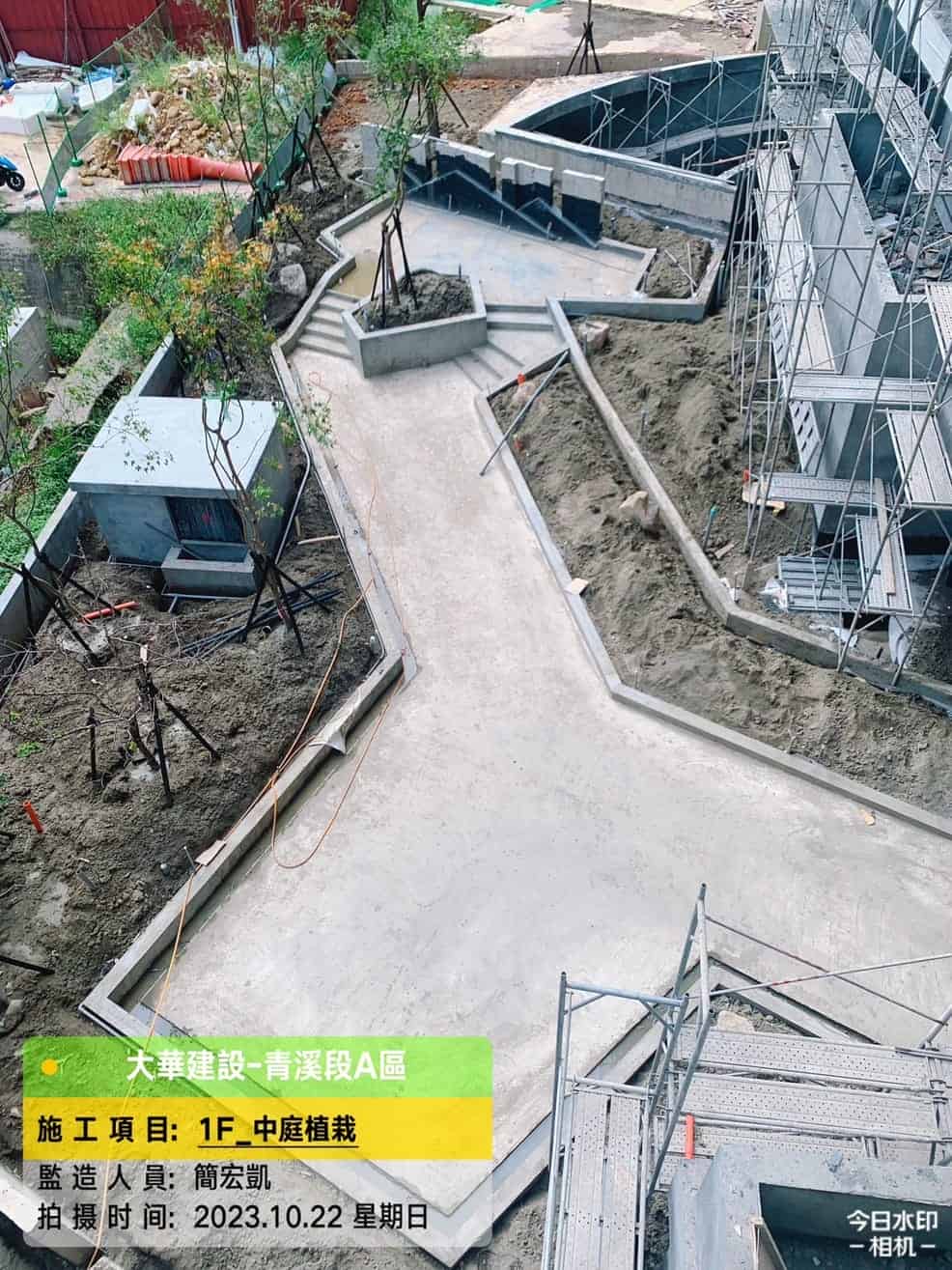

2023/10 Atrium planting
-
-
11
2023
-

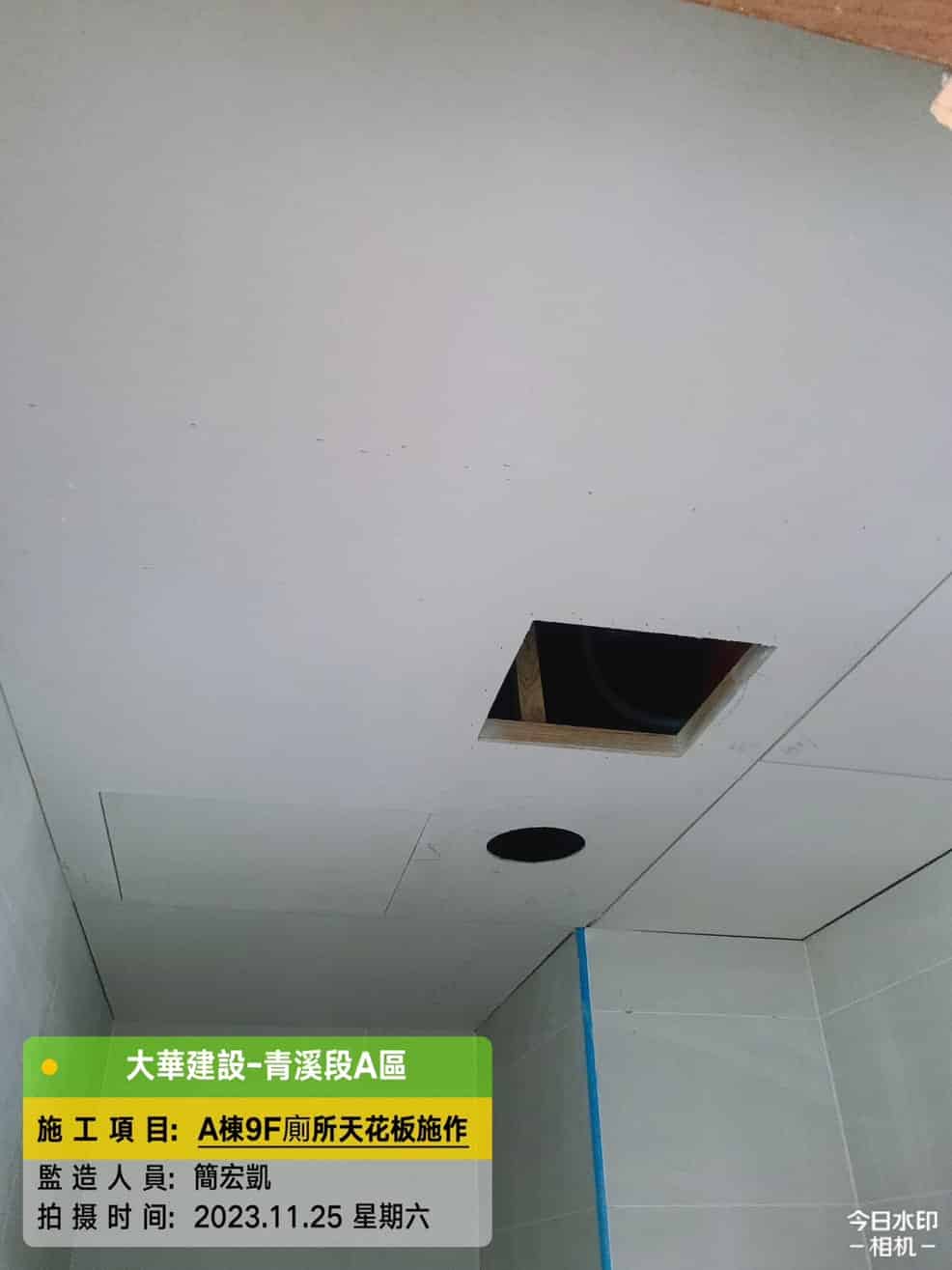

2023/11 Ceiling construction of toilet on 9F, Building A -

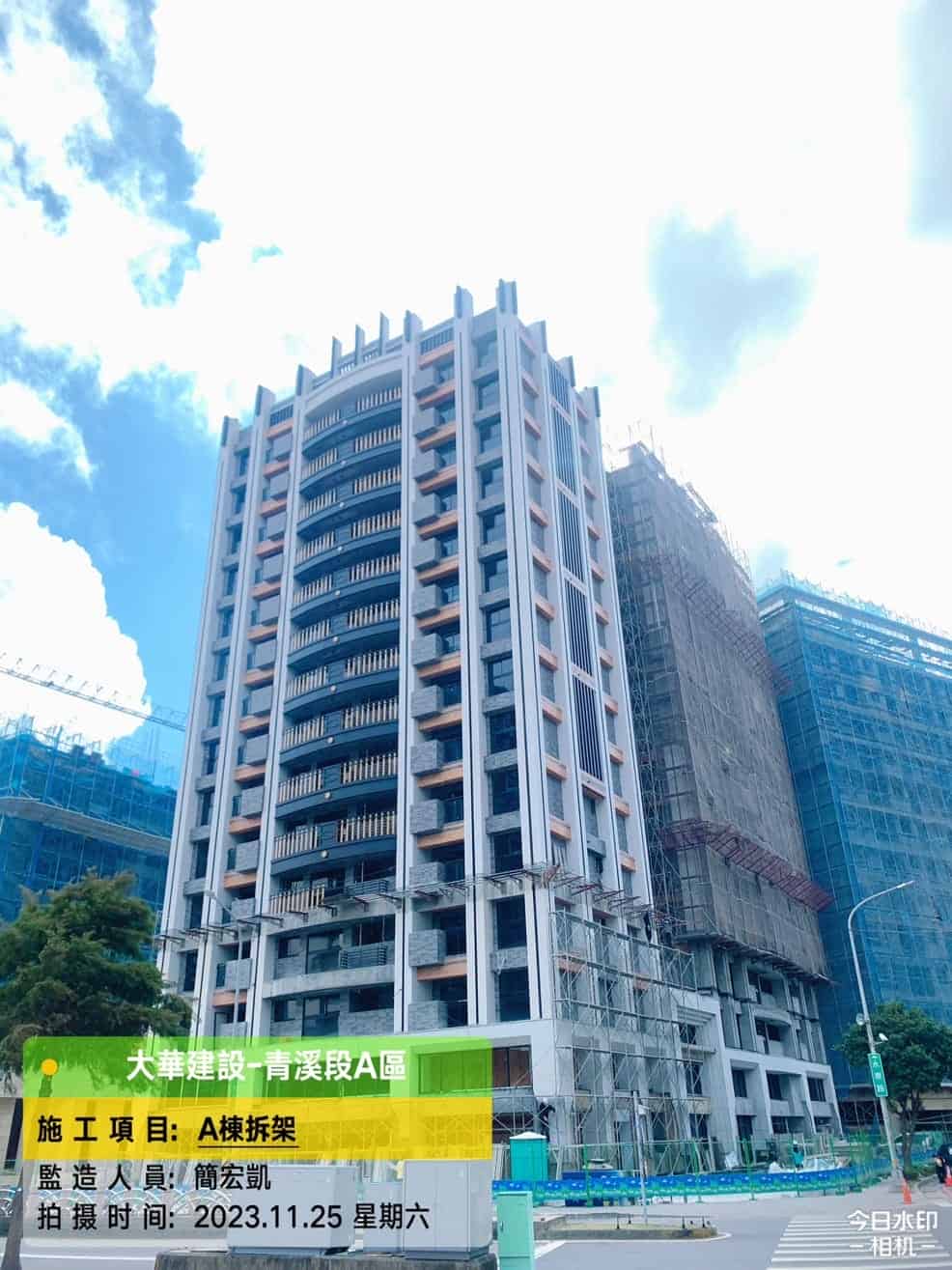

2023/11 Building A exterior wall demolition -

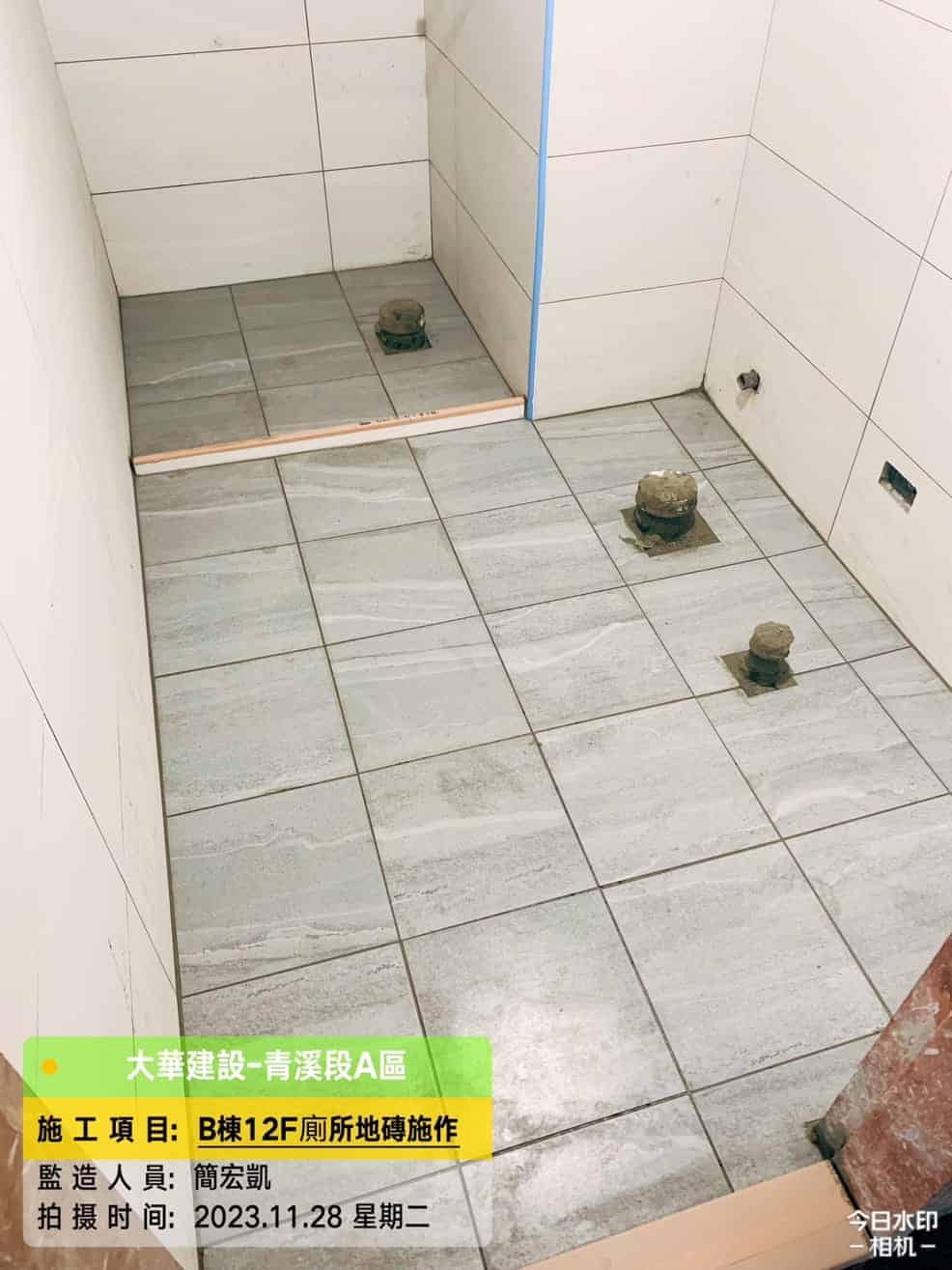

2023/11 Installation of floor tiles in the toilet on 12F, Building B
-
-
12
2023
-

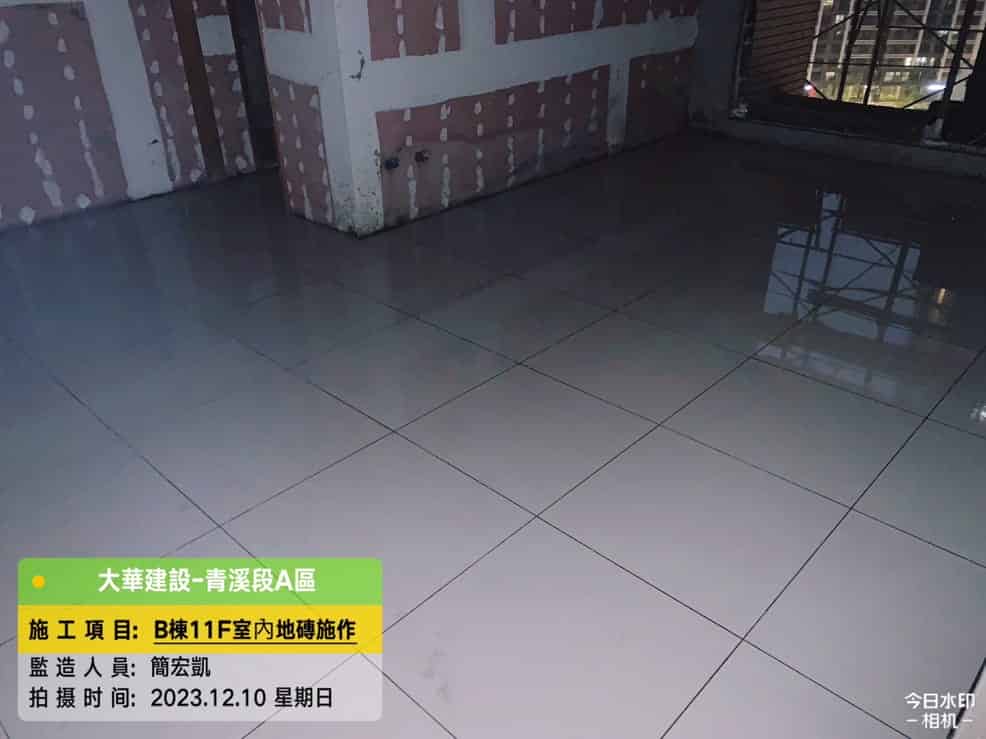

2023/12 Interior floor tile installation on 11F, Building A -

2023/12 Indoor spray painting on 14F, Building A -

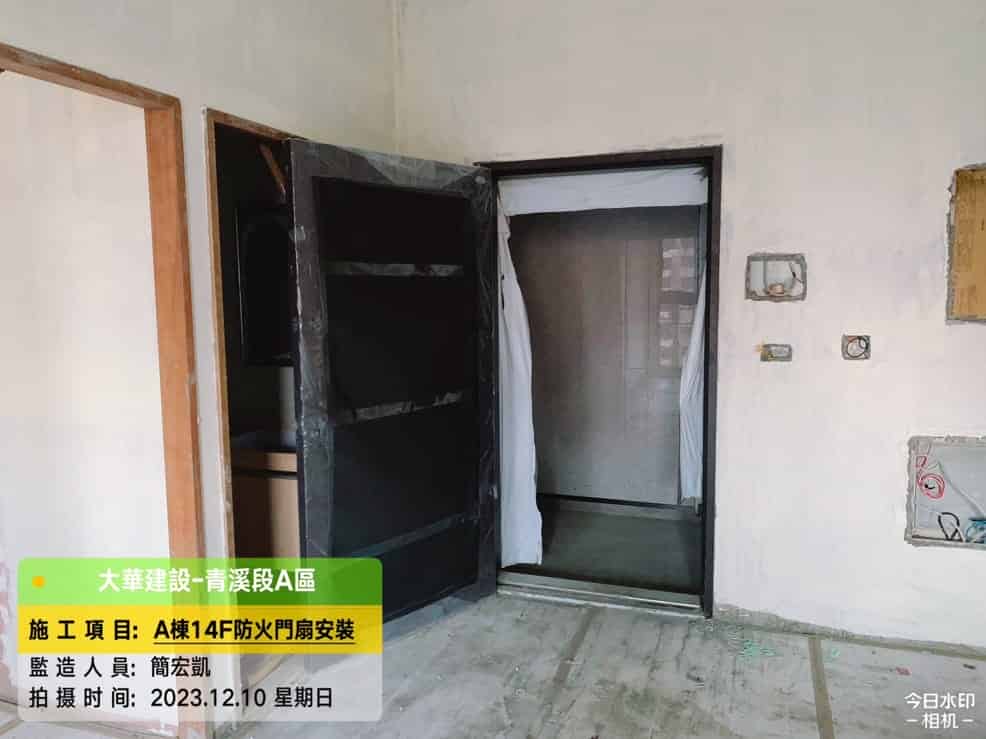

2023/12 Door leaf installation on 14F in Building A
-
-
01
2024
-

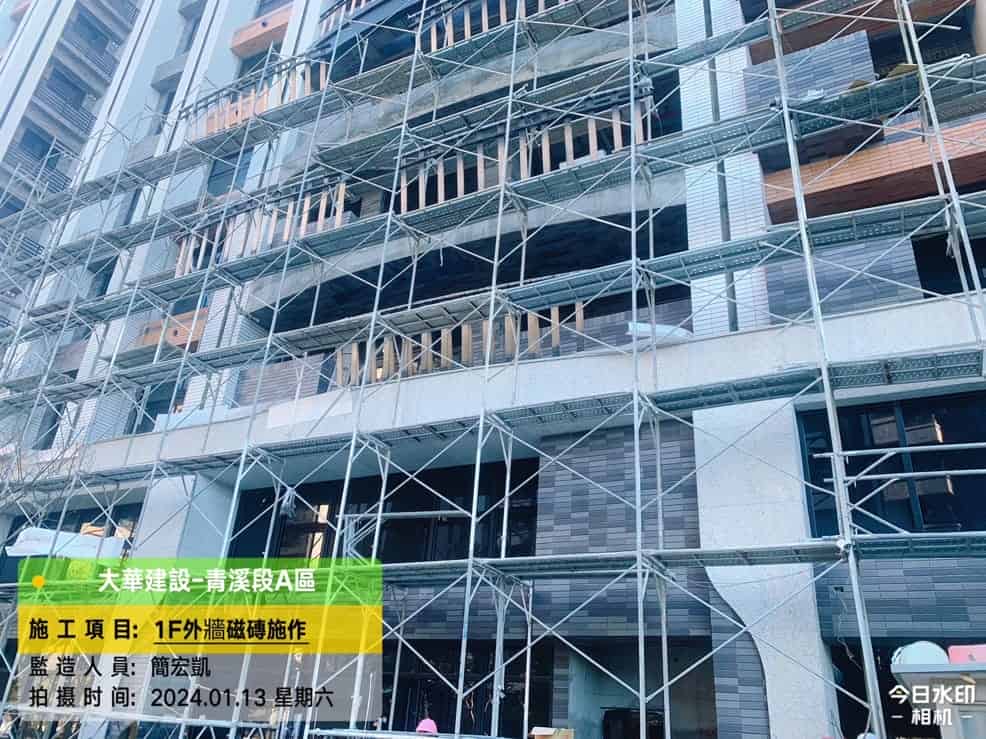

2024/01 1F exterior wall brick installation -

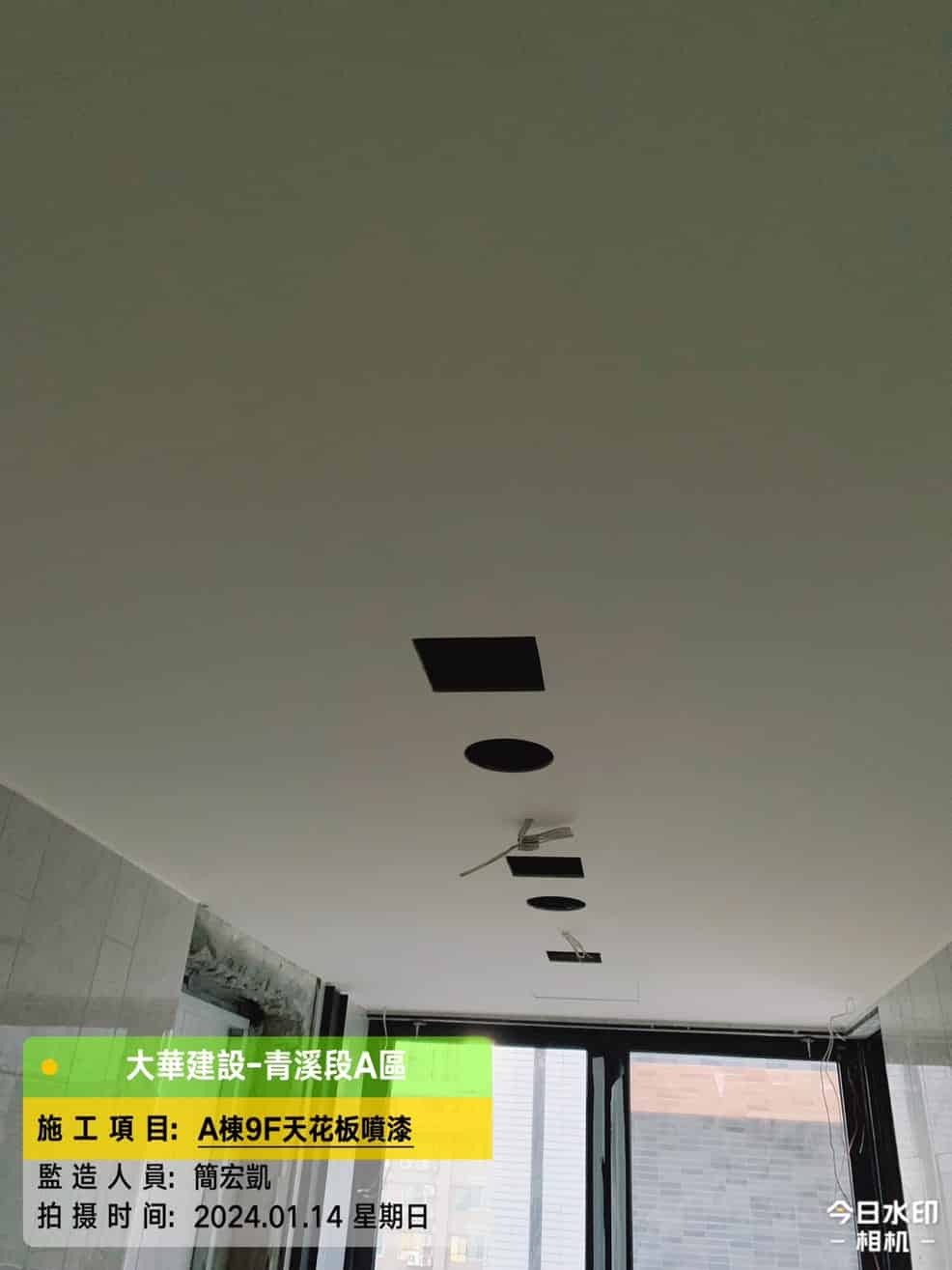

2024/01 Building A 9F ceiling spray painting -

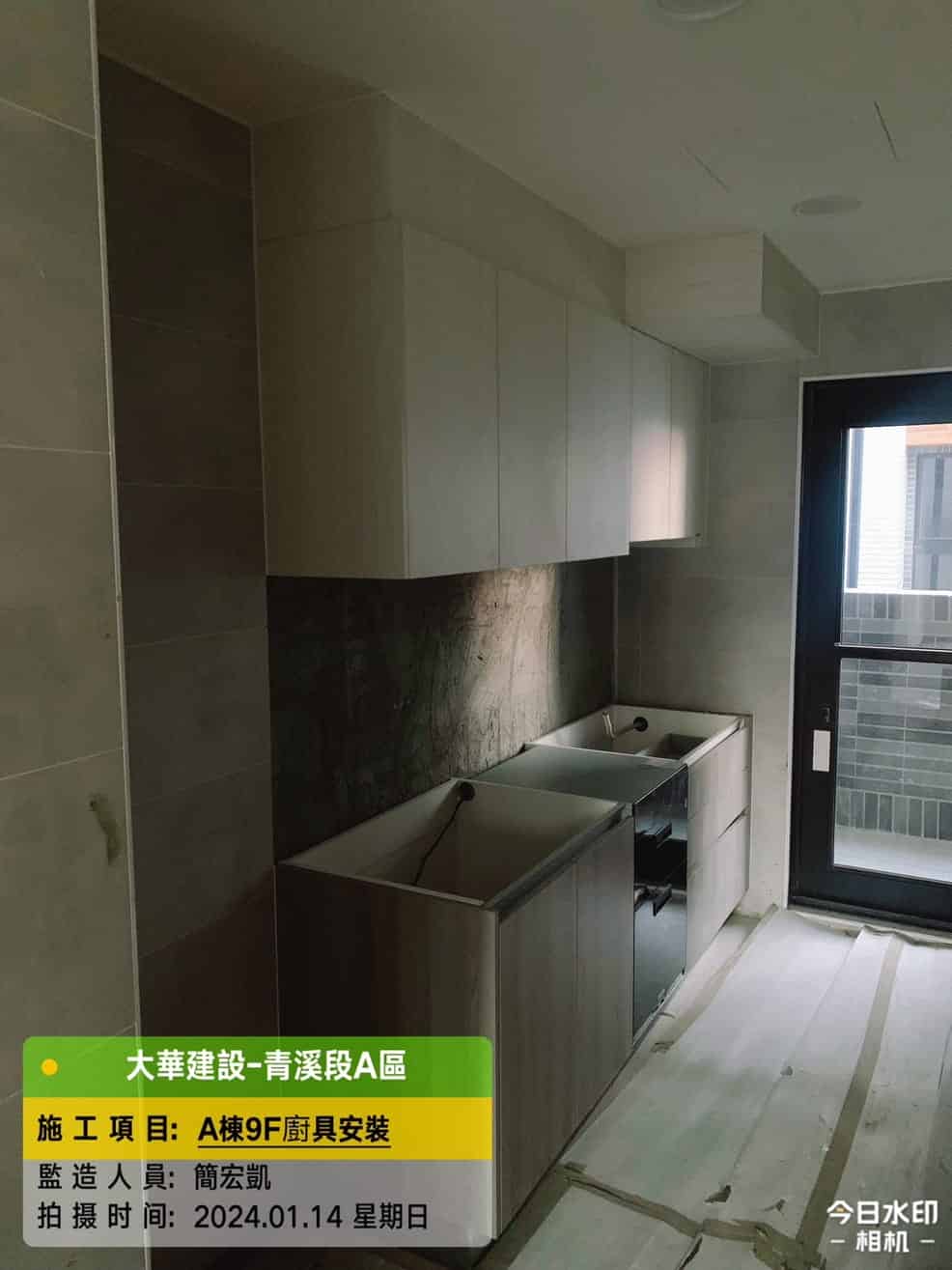

2024/01 Kitchenware installation on 9F, Building A
-
-
02
2024
-

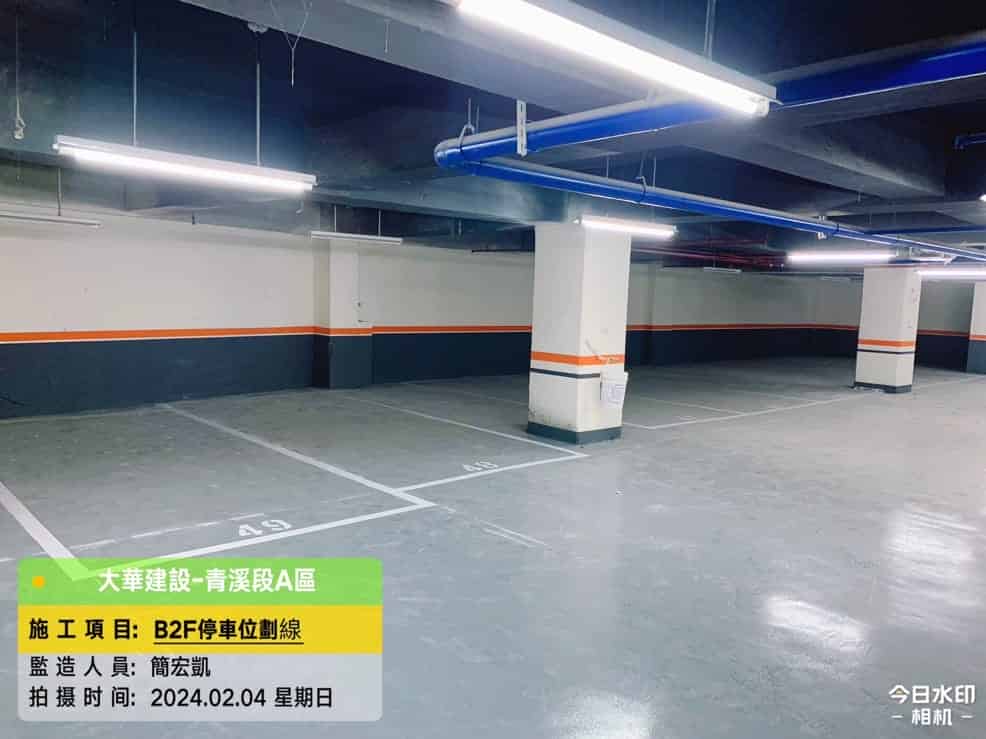

2024/02 B2F parking space marking -

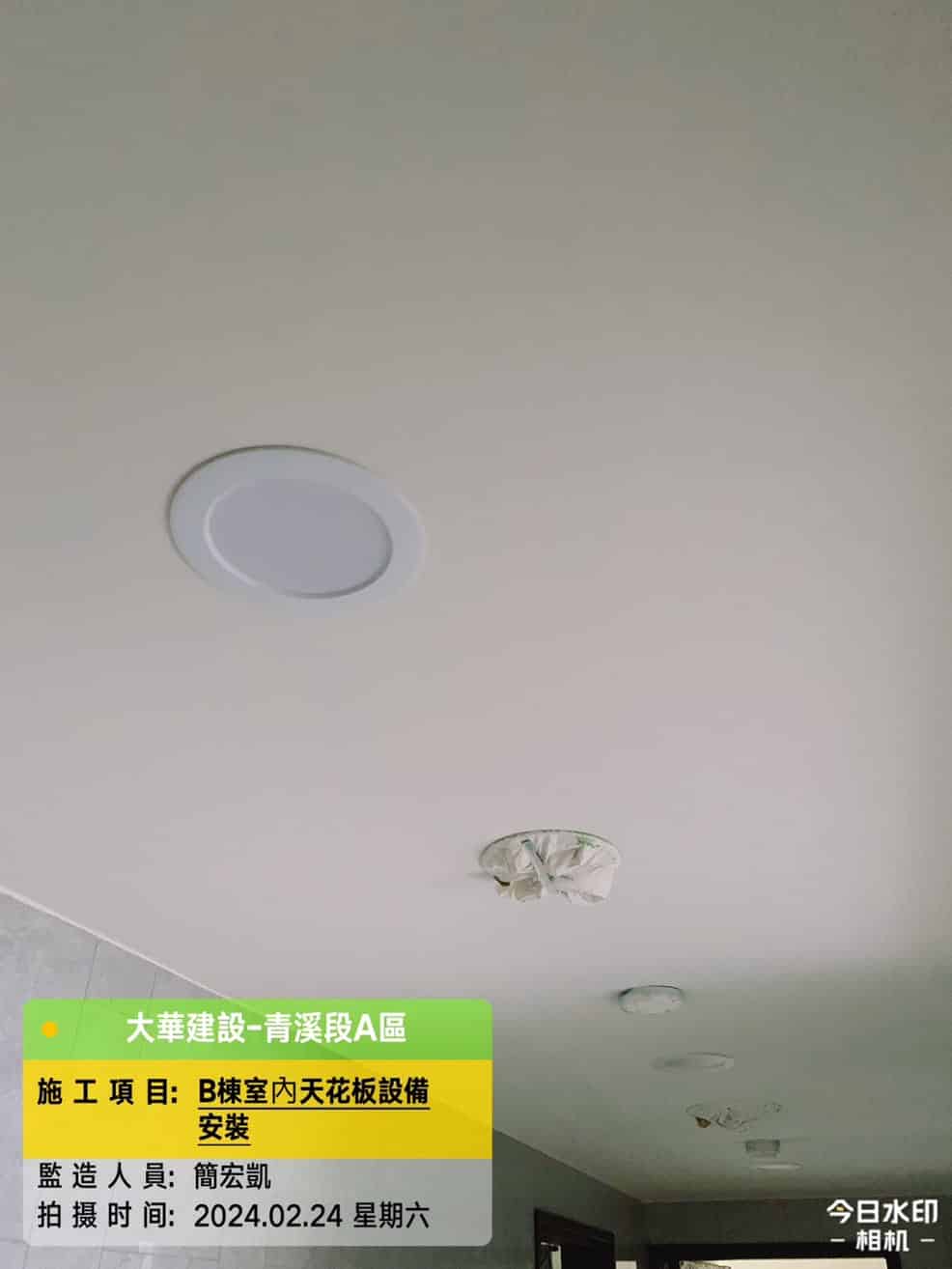

2024/02 Installation of ceiling equipment on 10F, Building B -

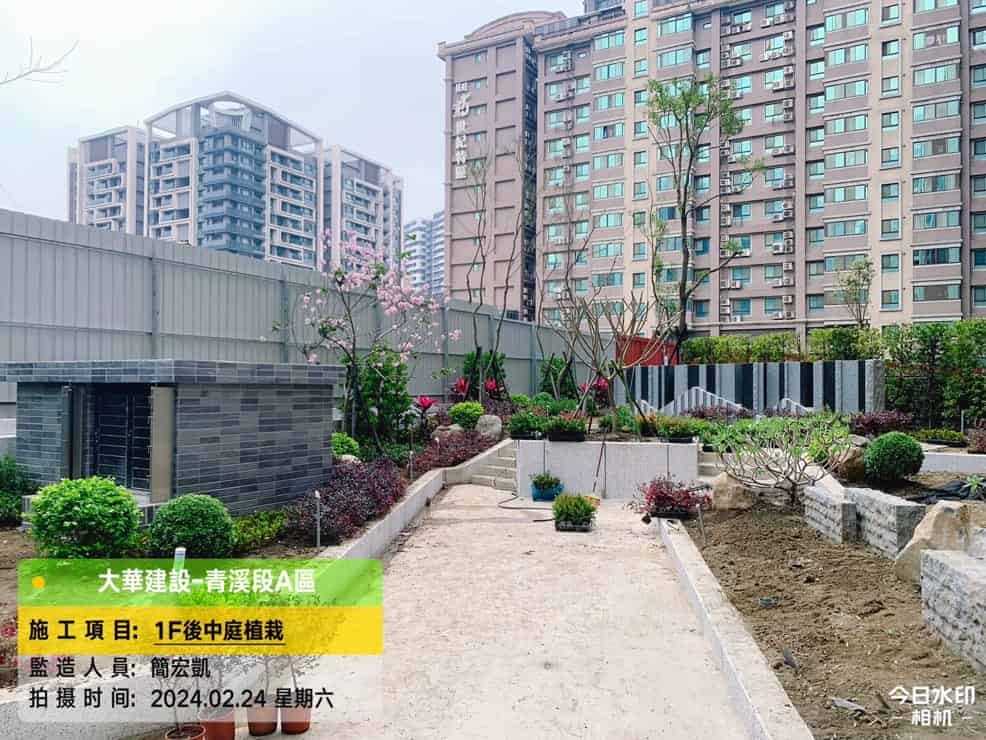

2024/02 Atrium landscape construction
-
-
03
2024
-

2024/03 Installation of skirting boards on 5F of Building A -

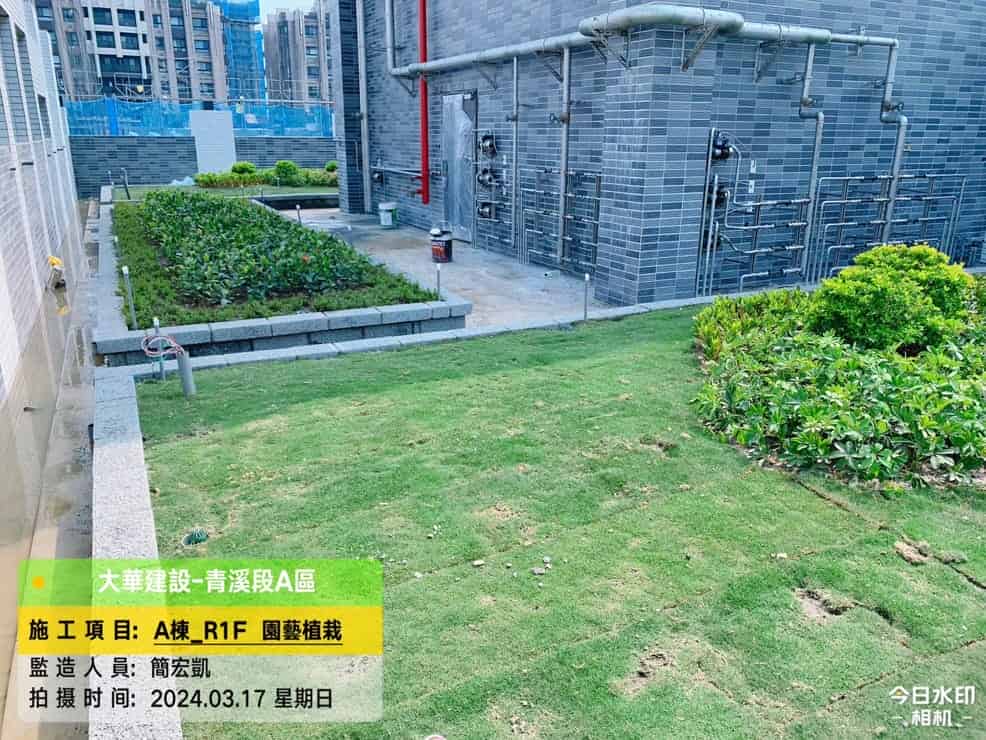

2024/03 Landscape construction of R1F in Building A -

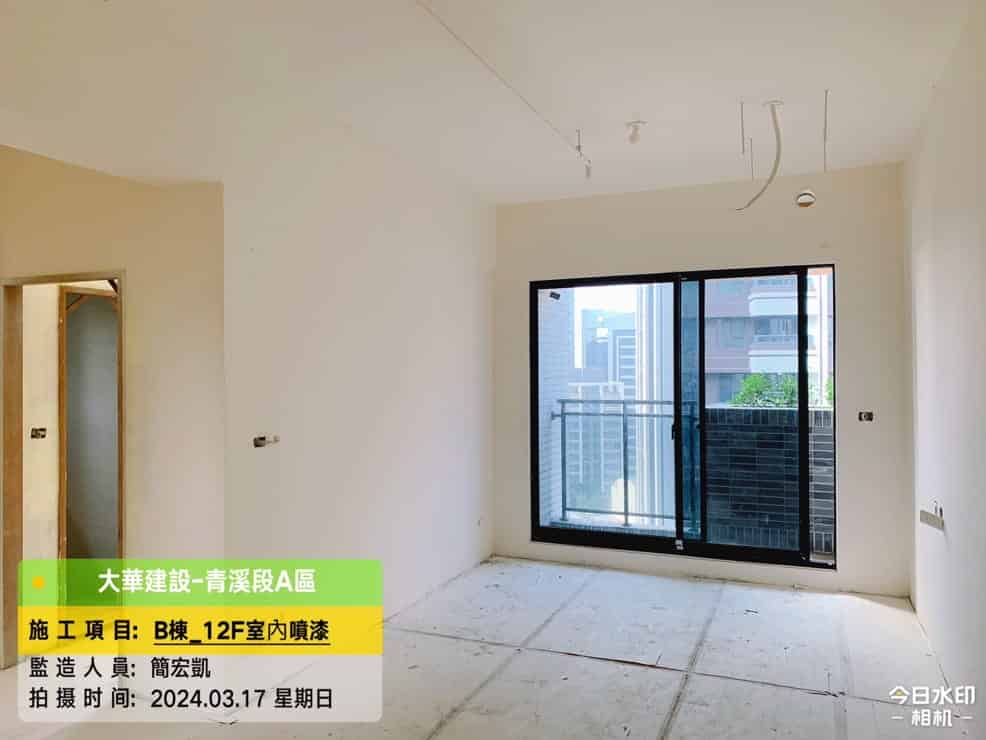

2024/03 Indoor spray painting on 12F, Building B
-
-
04
2024
-

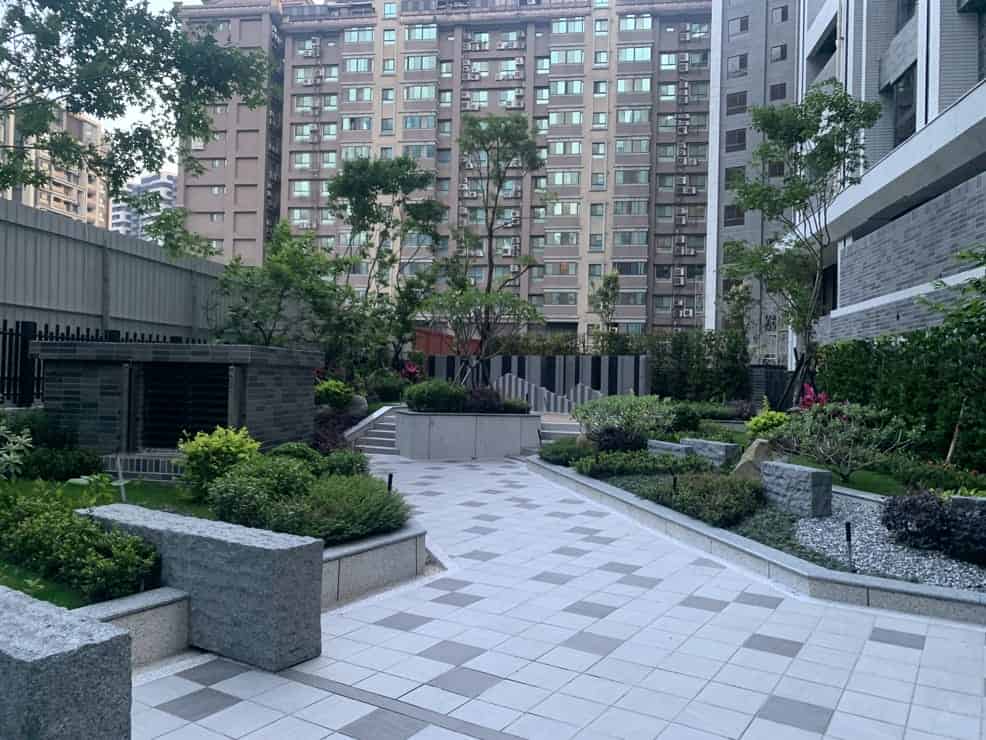

2024/04 Atrium landscape planting -
2024/04 Installation of stone materials for atrium flower table -

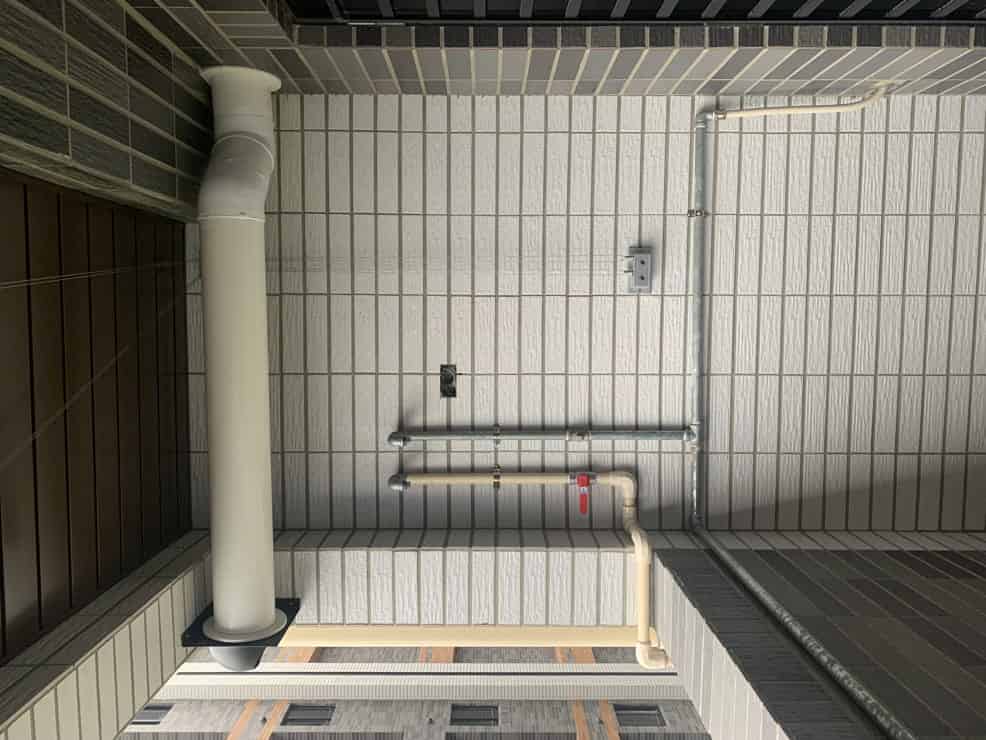

2024/04 Gas inner pipe installation
-
-
05
2024
-

2024/05 Installation of indoor wooden door leaves -
2024/05 Installation of door light -

2024/05 Meter base installation
-
-
06
2024
-

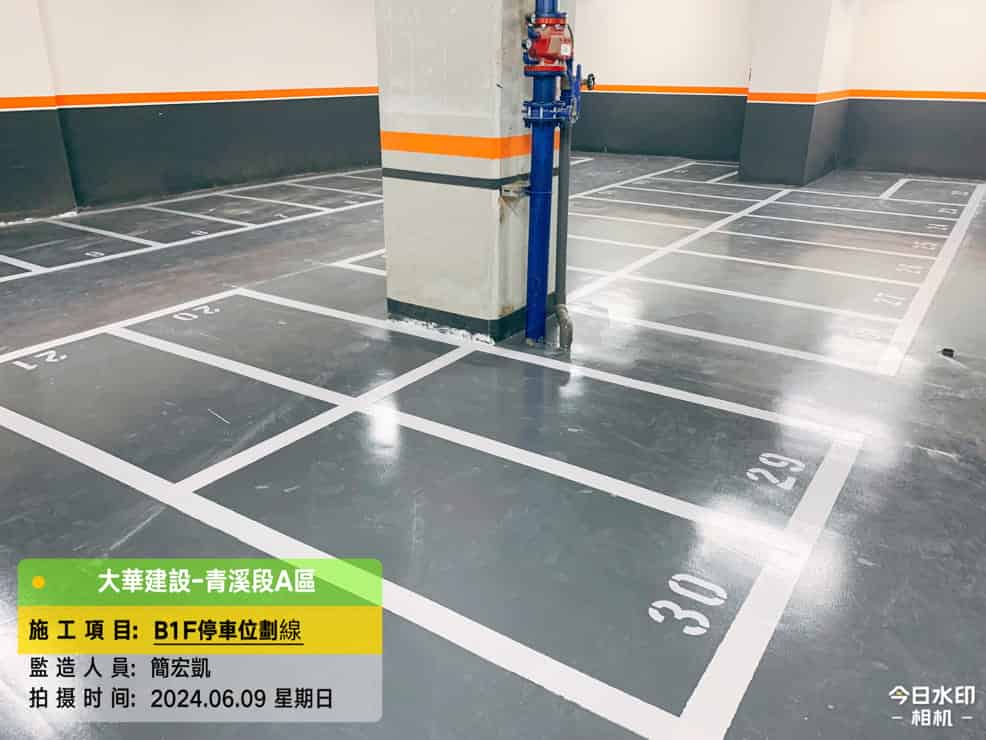

2024/06 B1F parking space marked -

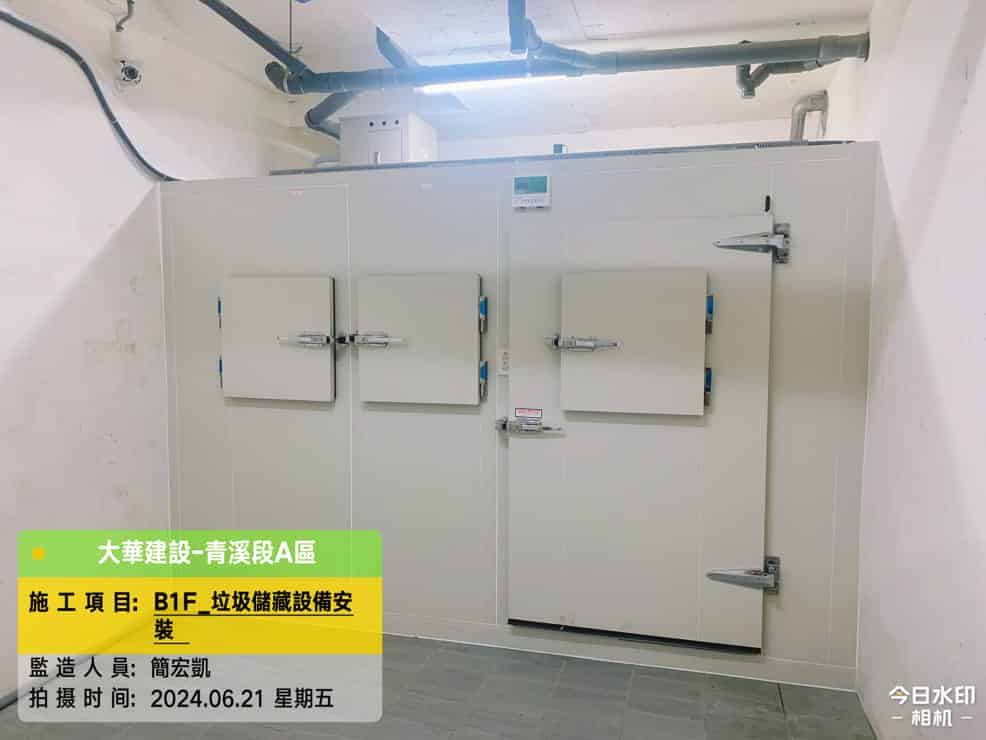

2024/06 B1F garbage storage equipment is installed
-
-
07
2024
-

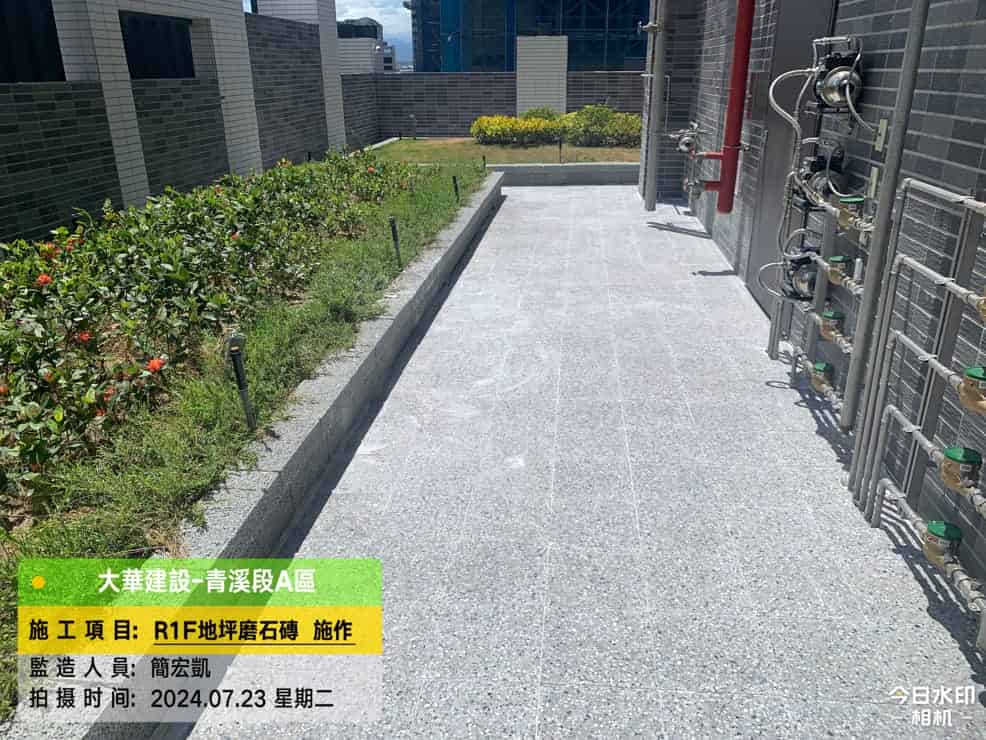

2024/07 R1F floor grindstone brick installation -

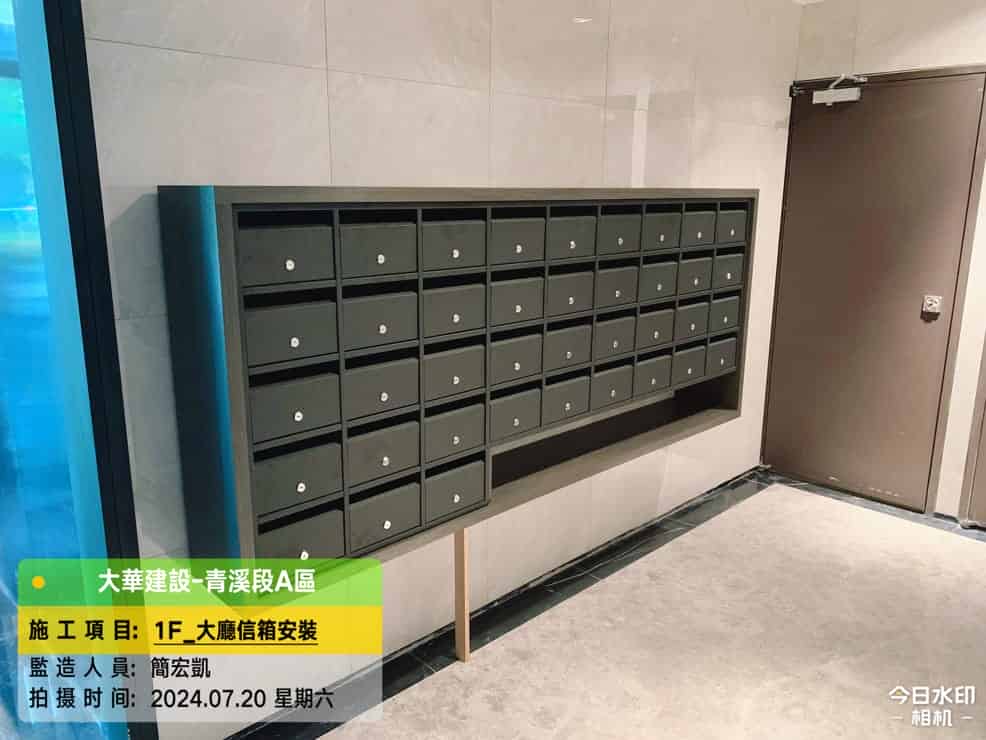

2024/07 Hall mailbox installation
-
-
08
2024
-

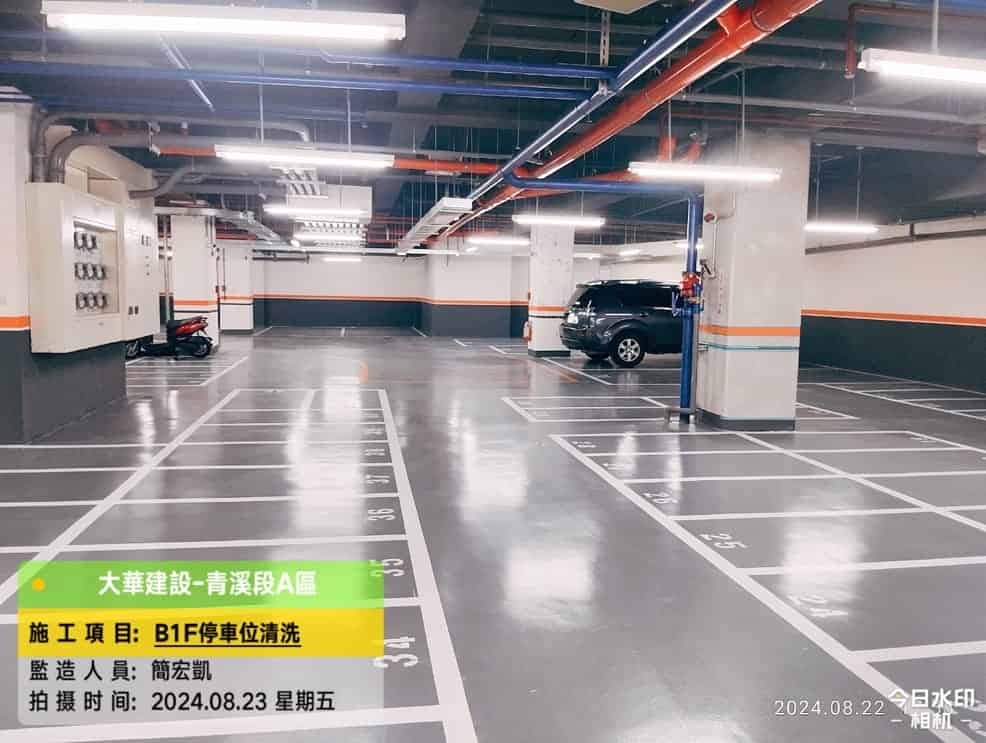

2024/08 B1F parking space cleaning -

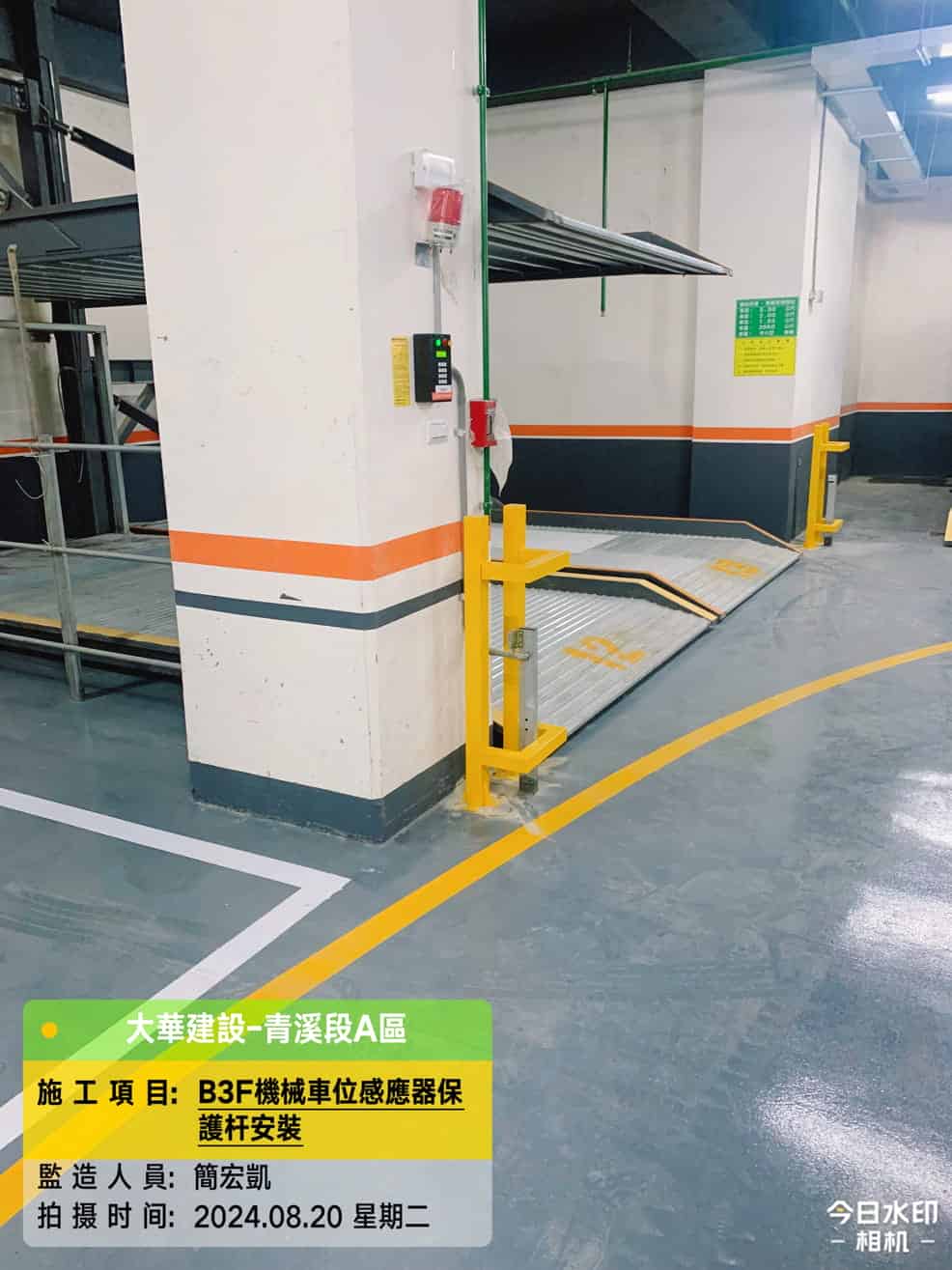

2024/08 B3F mechanical parking space sensor protection rod installation -

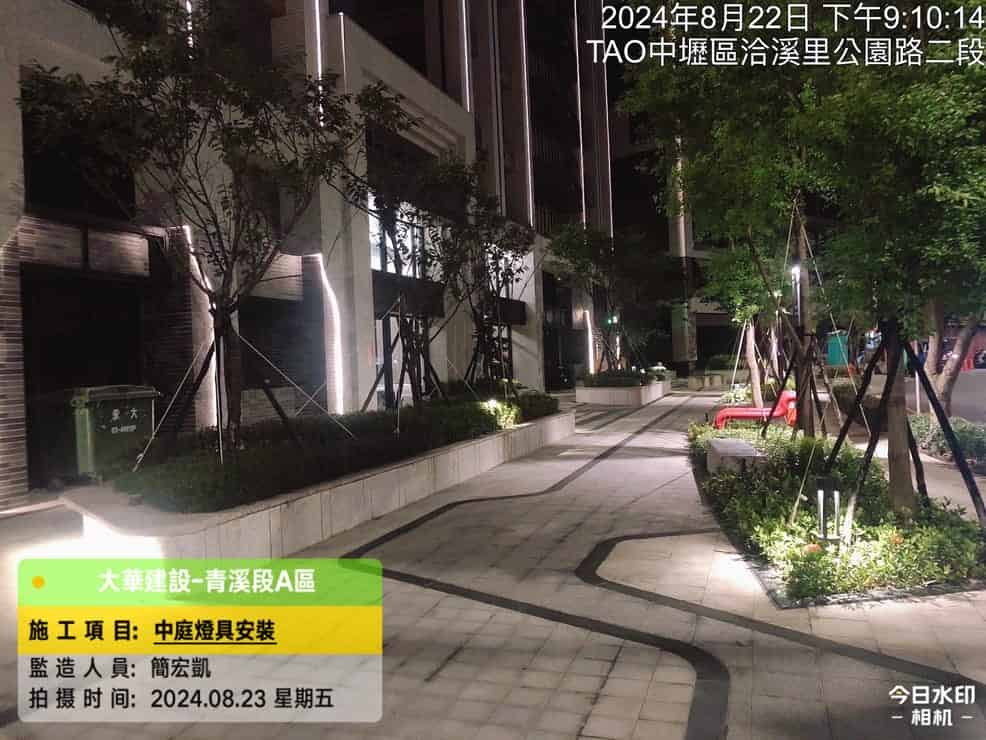

2024/08 Atrium lighting installation
-
