The Rising City
-
03

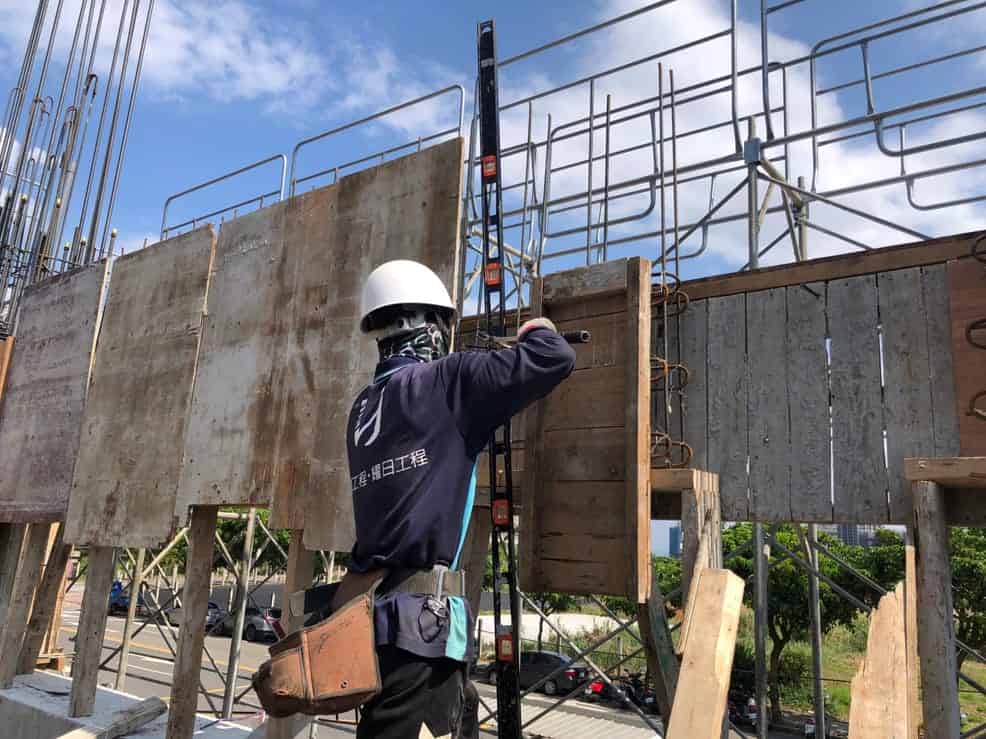

2022
-

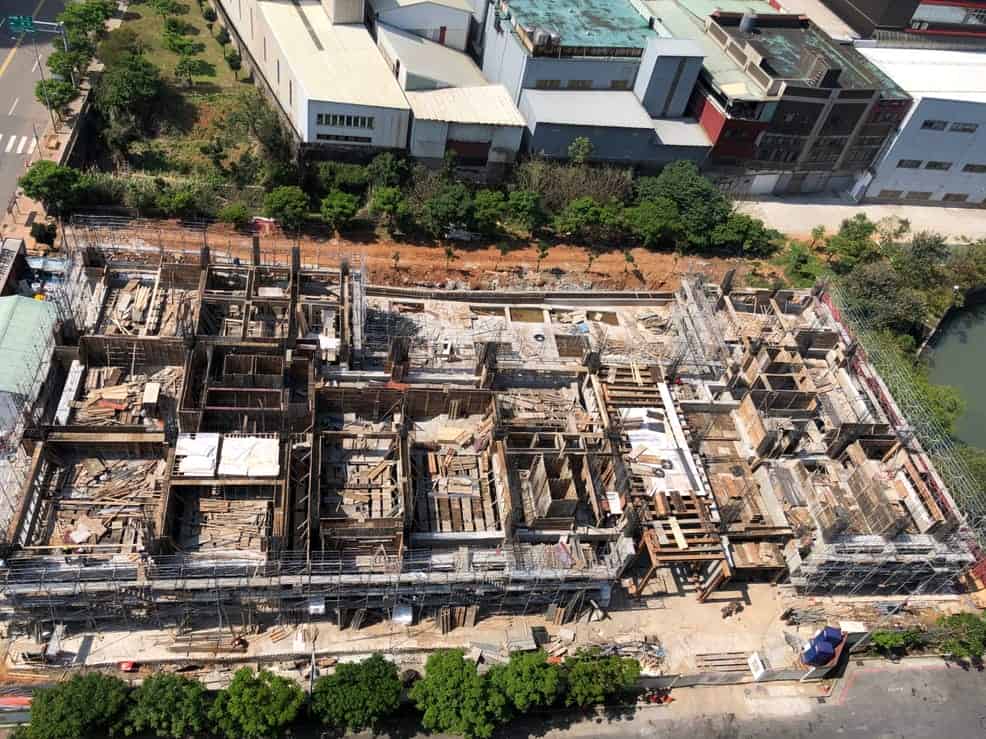

2022/03 1MFL template assembly
-
2022/03 Panoramic photo of the work area, 1MF column wall and 2FL beam version
-
-
04
2022
-

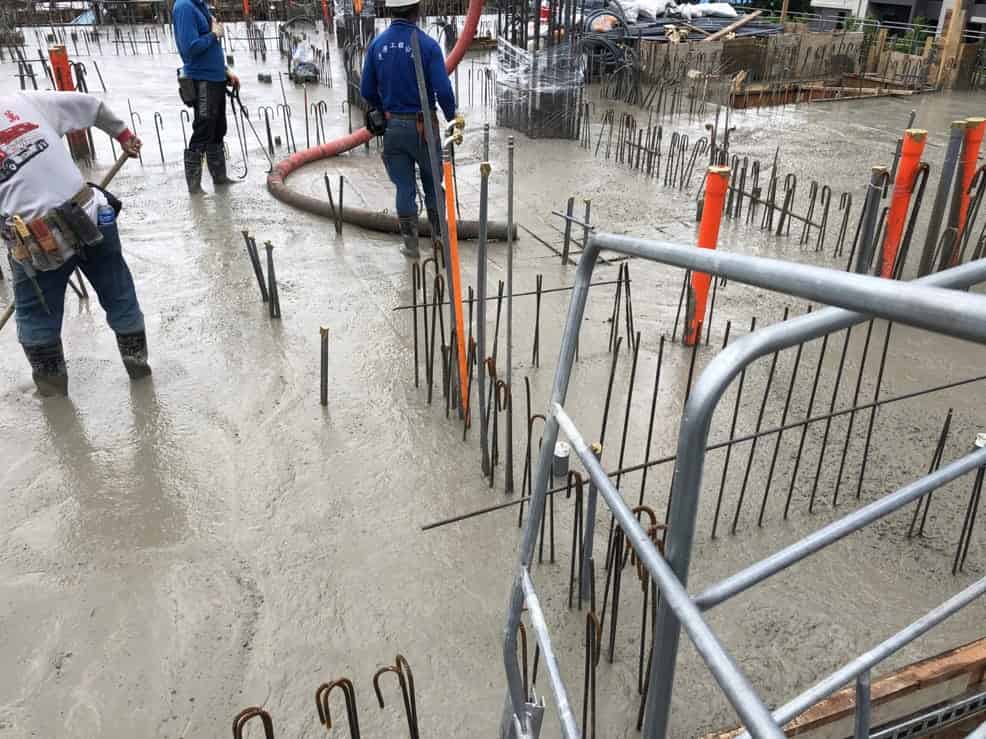

2022/04 Pressure feeding project 3FL beam plate pouring
-

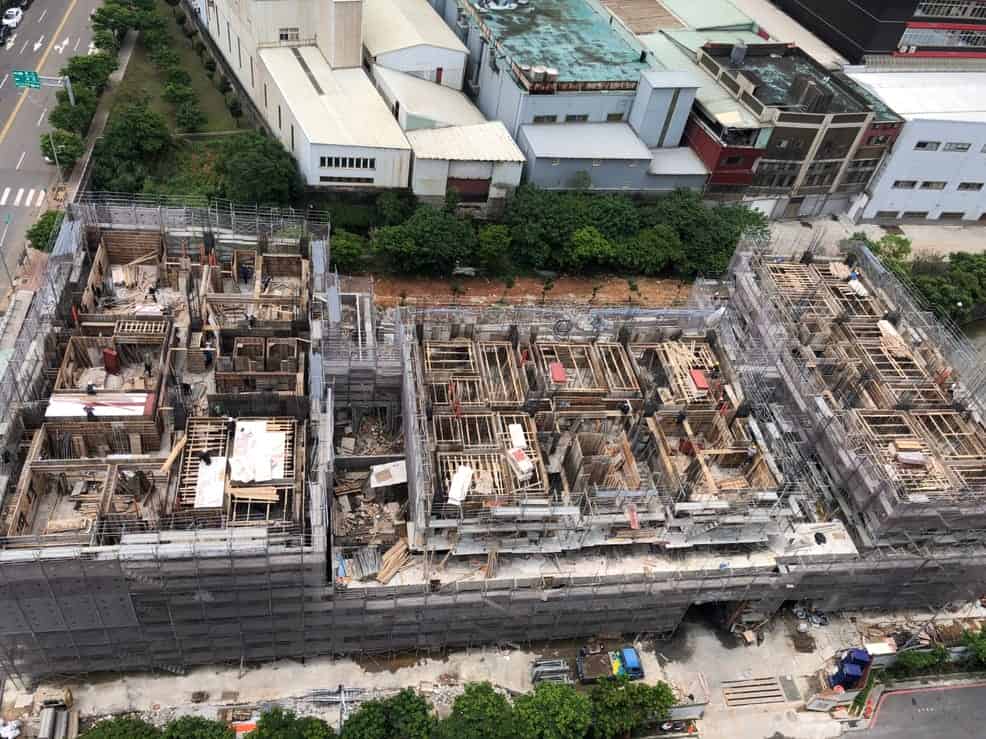

2022/04 Panoramic view of the work area 3F column wall and 4FL beam version assembly
-
-
05
2022
-

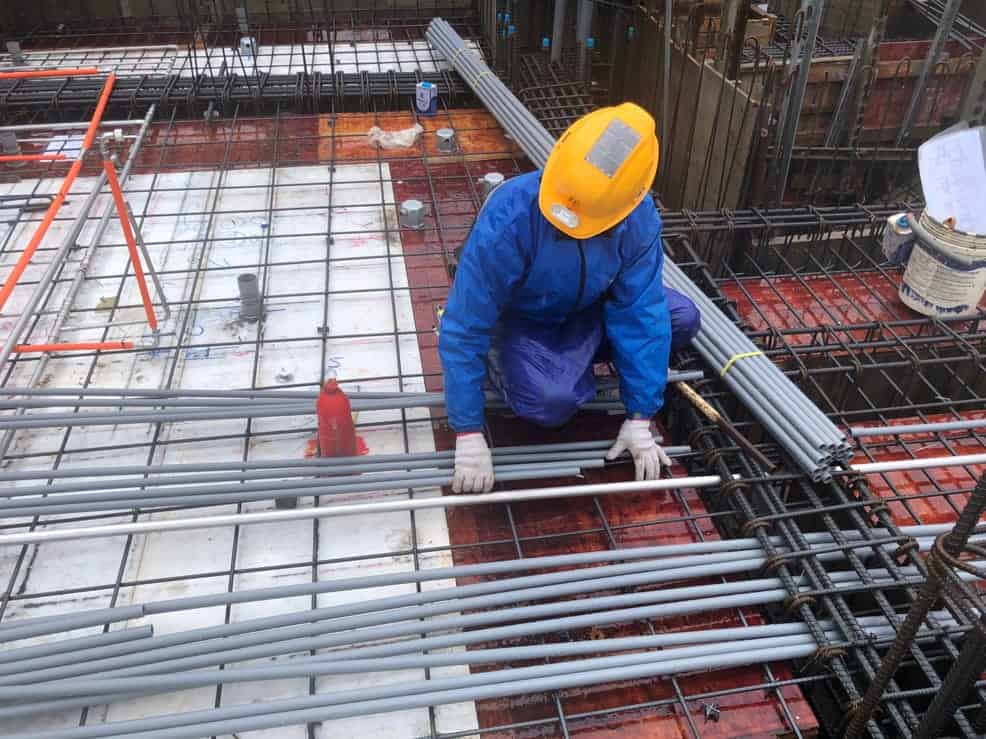

2022/05 5FL water and electricity piping
-

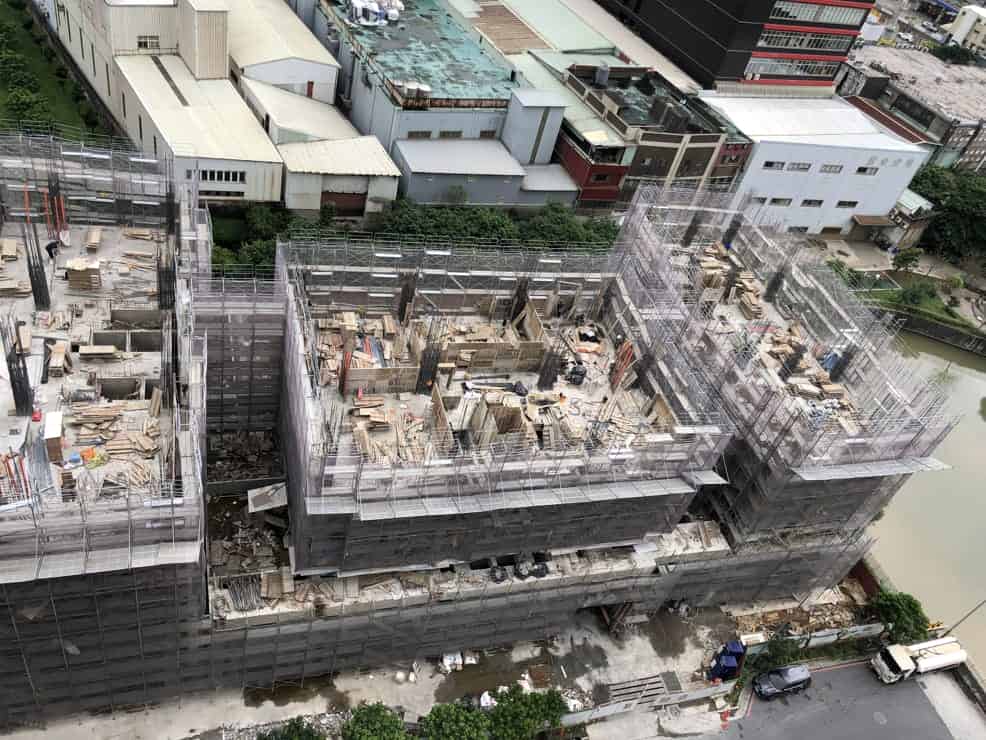

2022/05 Panorama 5F column wall + 6FL beam version
-
-
06
2022
-

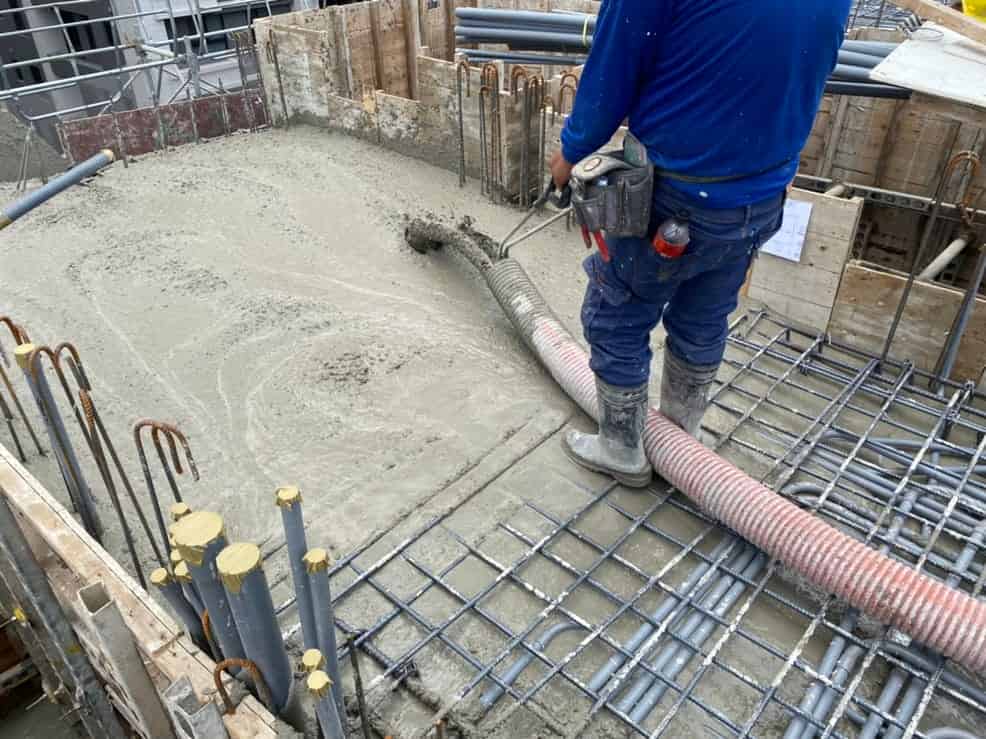

2022/06 6F column wall 7FL beam version grouting
-

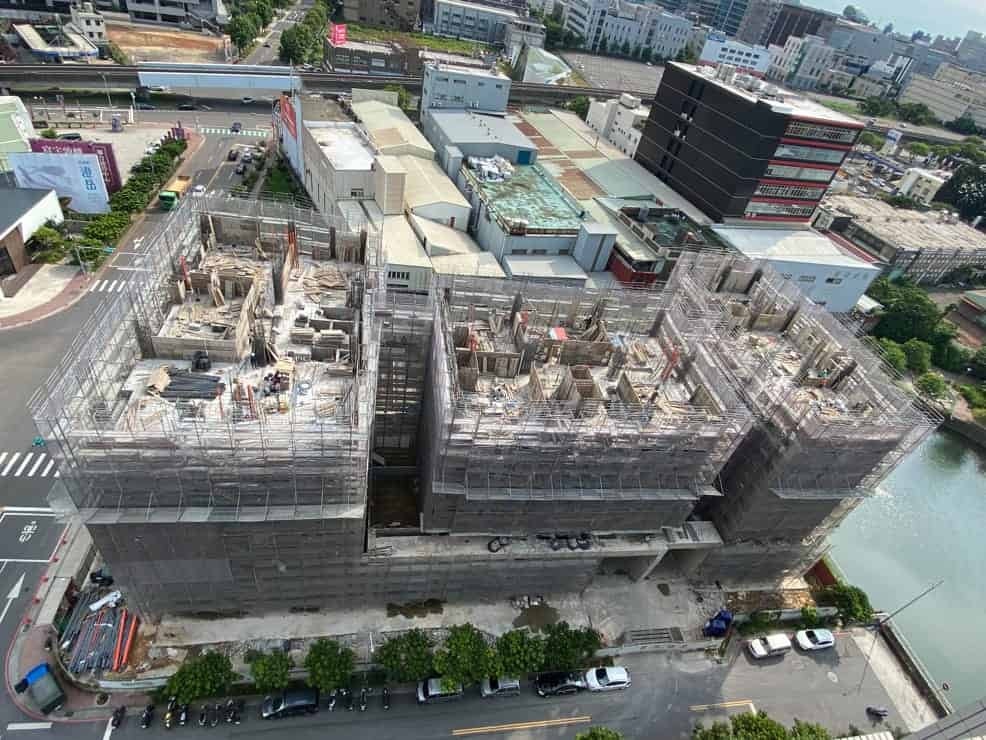

2022/06 Panorama 6F Column Wall 7FL Beam Version
-
-
07
2022
-

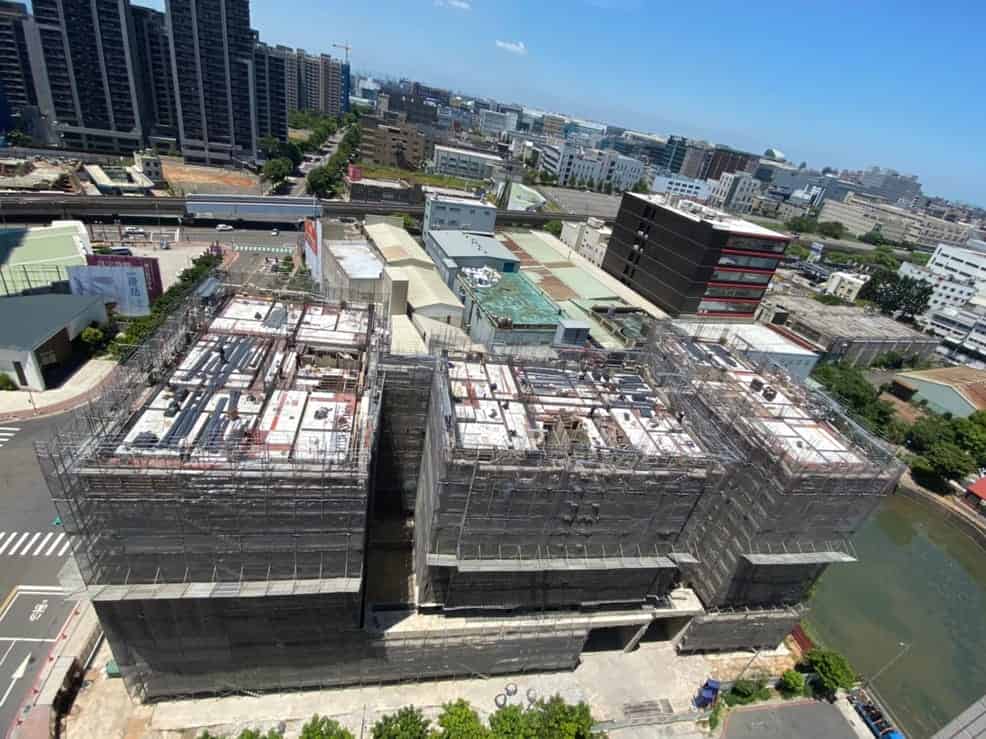

2022/07 8F column wall + 9FL beam version panorama
-

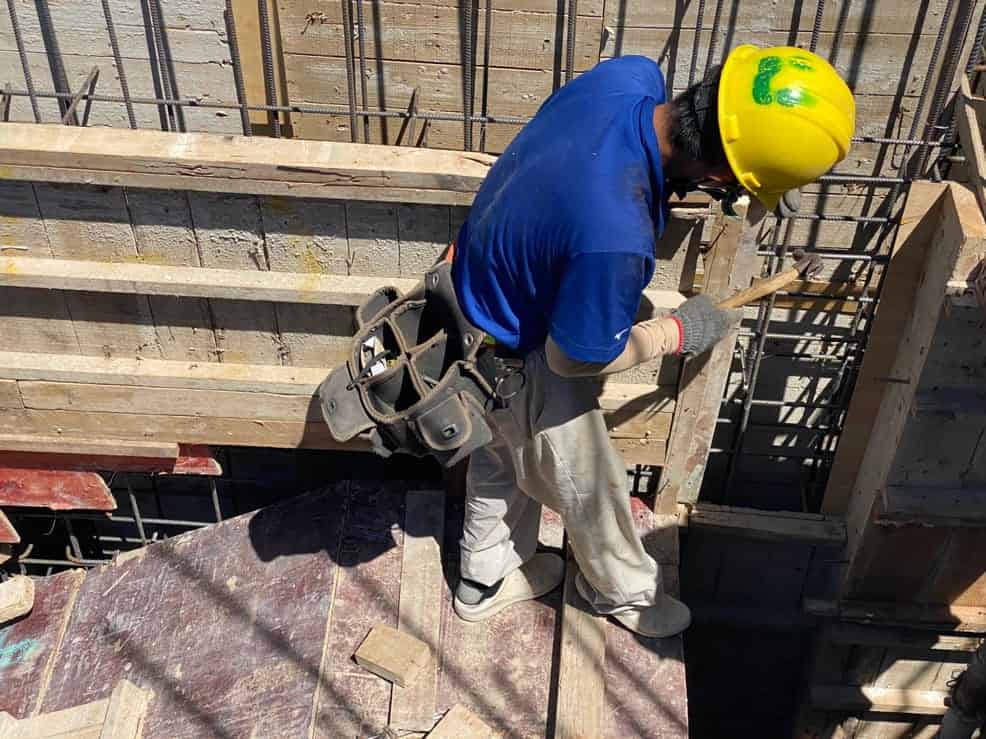

2022/07 9FL beam plate formwork assembly
-
-
08
2022
-

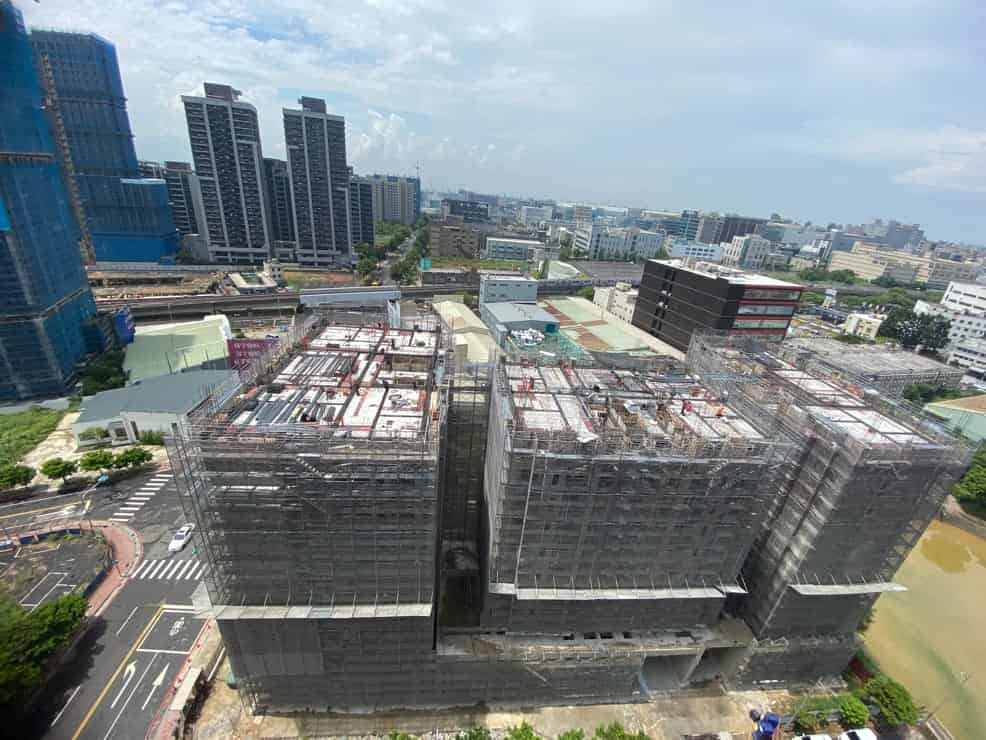

2022/08 10F column wall 11FL beam version panorama
-
2022/08 11FL water and electricity piping
-
-
09
2022
-

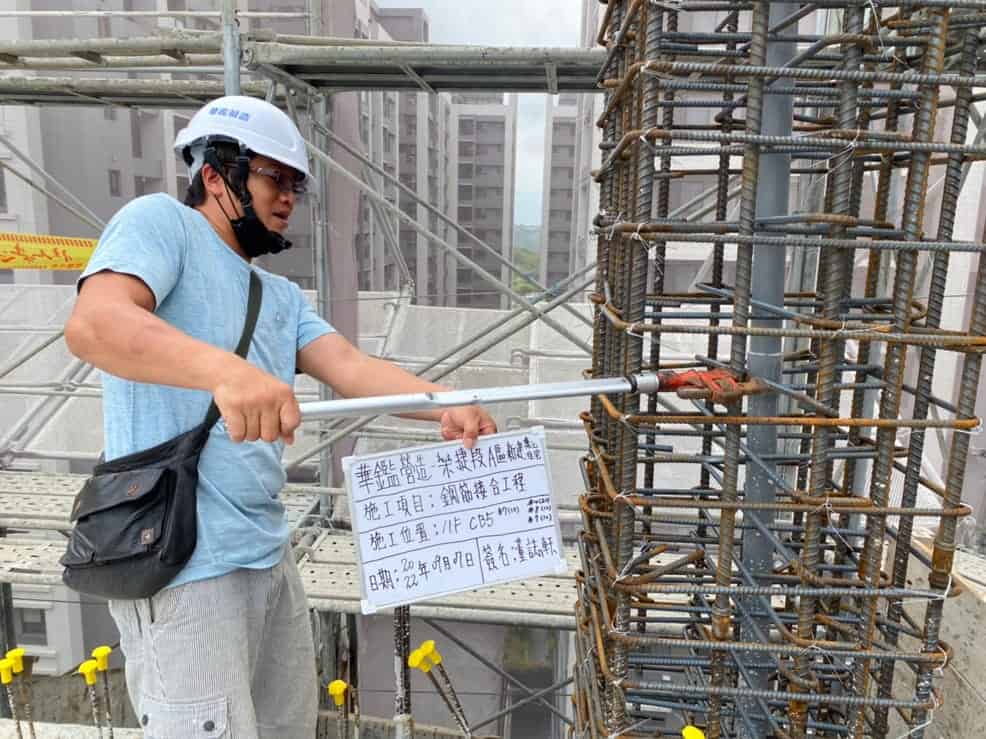

2022/09 11F column continues
-

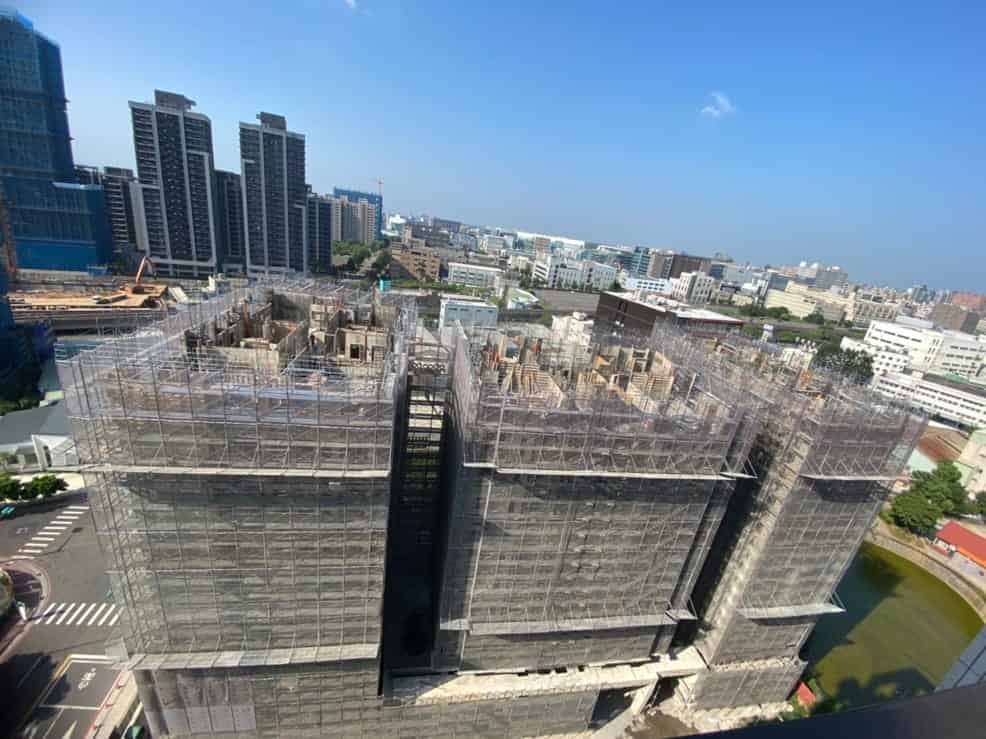

2022/09 Landscape of the whole area 12FL
-
-
10
2022
-

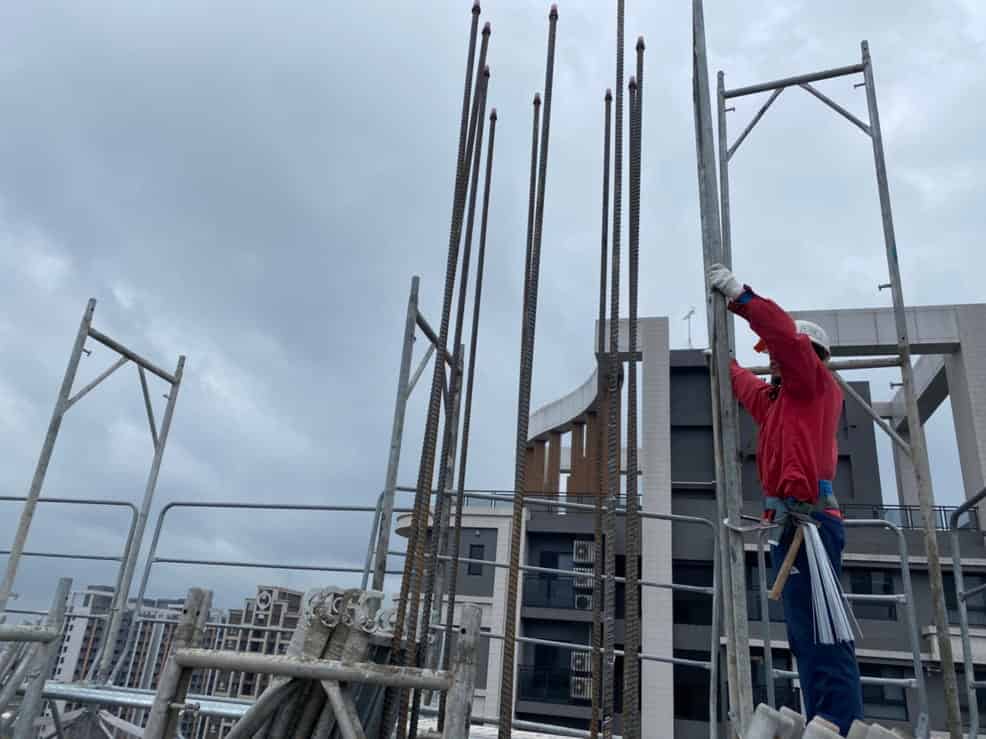

2022/10 14F scaffolding stand
-

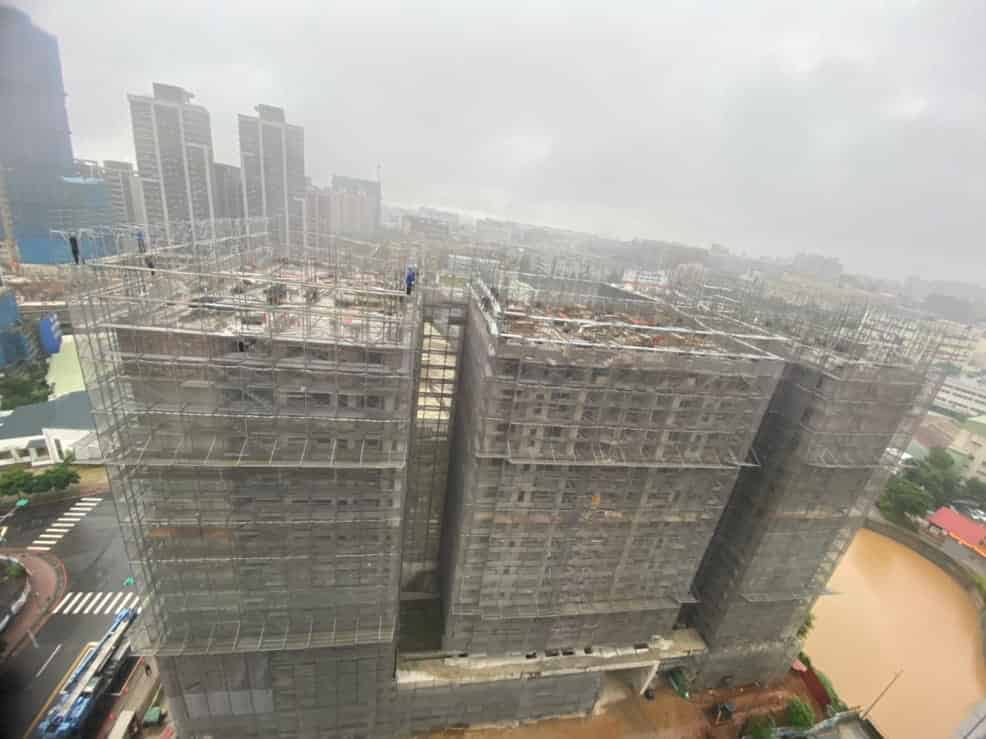

2022/10 Panorama 13F column wall 14FL beam version
-
-
11
2022
-

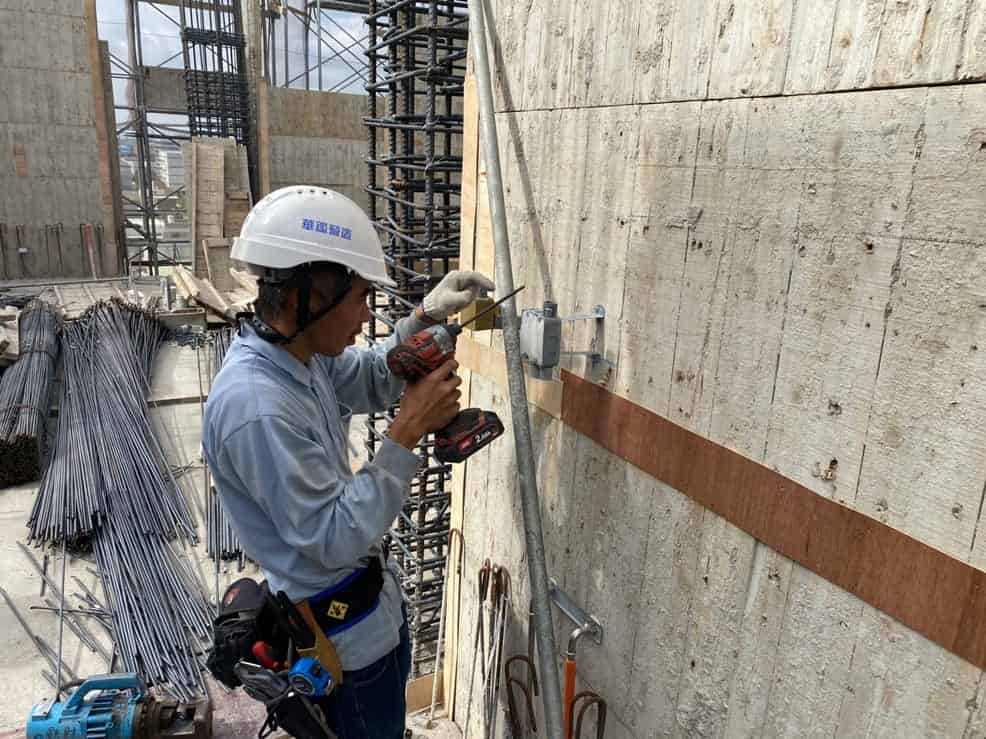

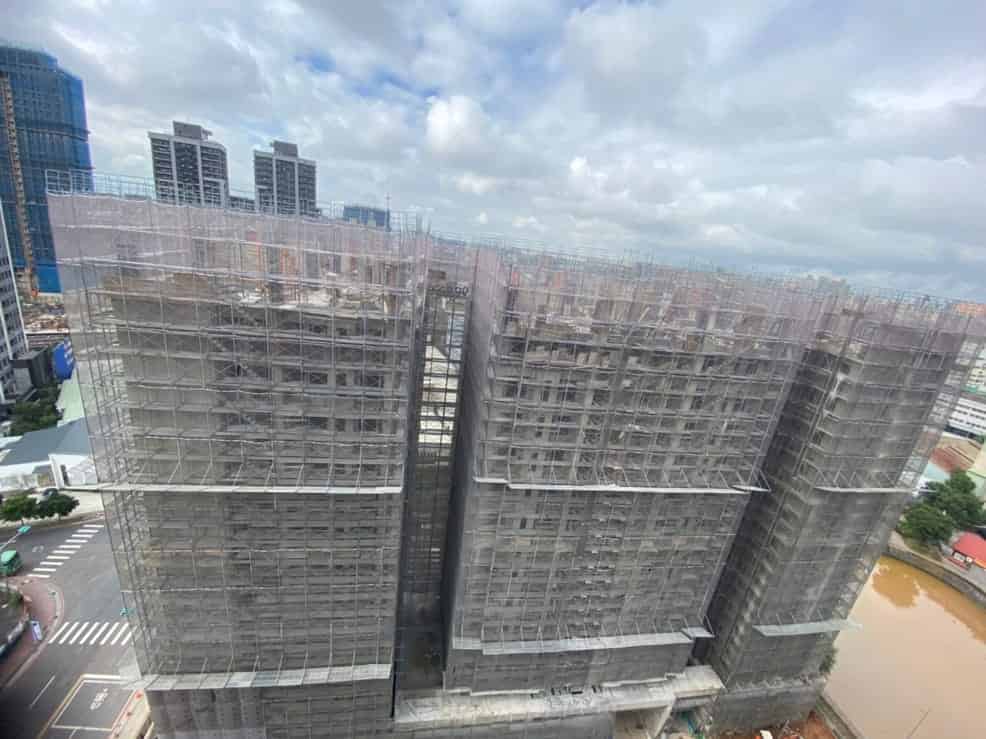

2022/11 5F water and electricity outlet configuration
-
2022/11 Whole area landscape 14F column wall + 15FL beam version
-
-
12

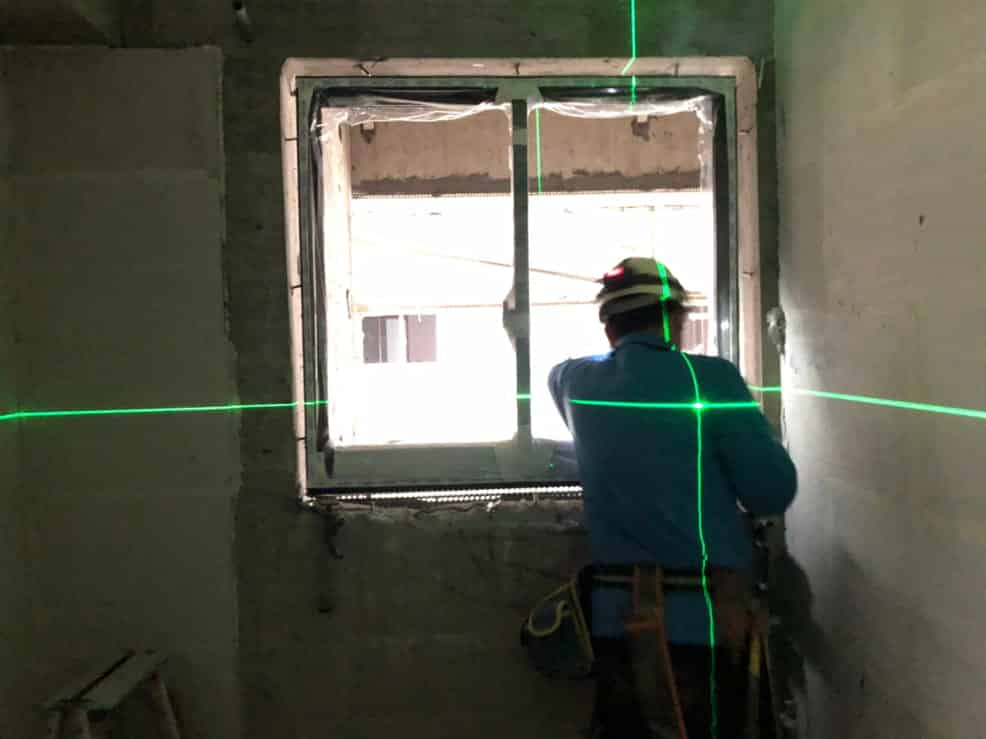

2022
-
2022/12 Aluminum window stand-4F
-

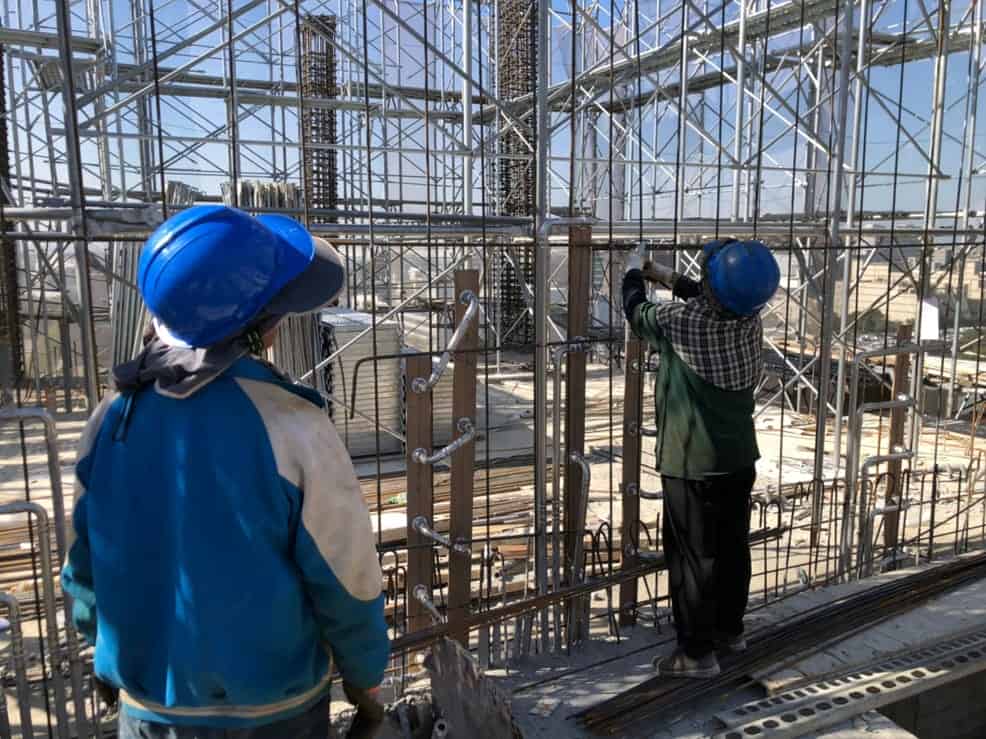

2022/12 Wall reinforcement binding-R1F
-

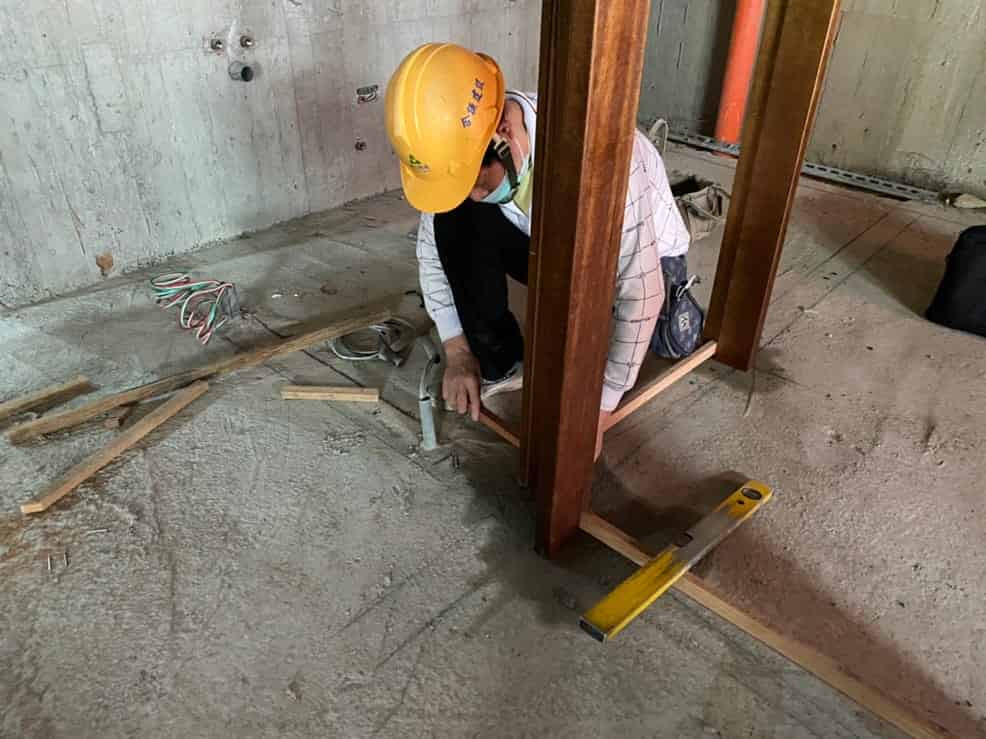

2022/12 Wooden door frame standing-11F
-

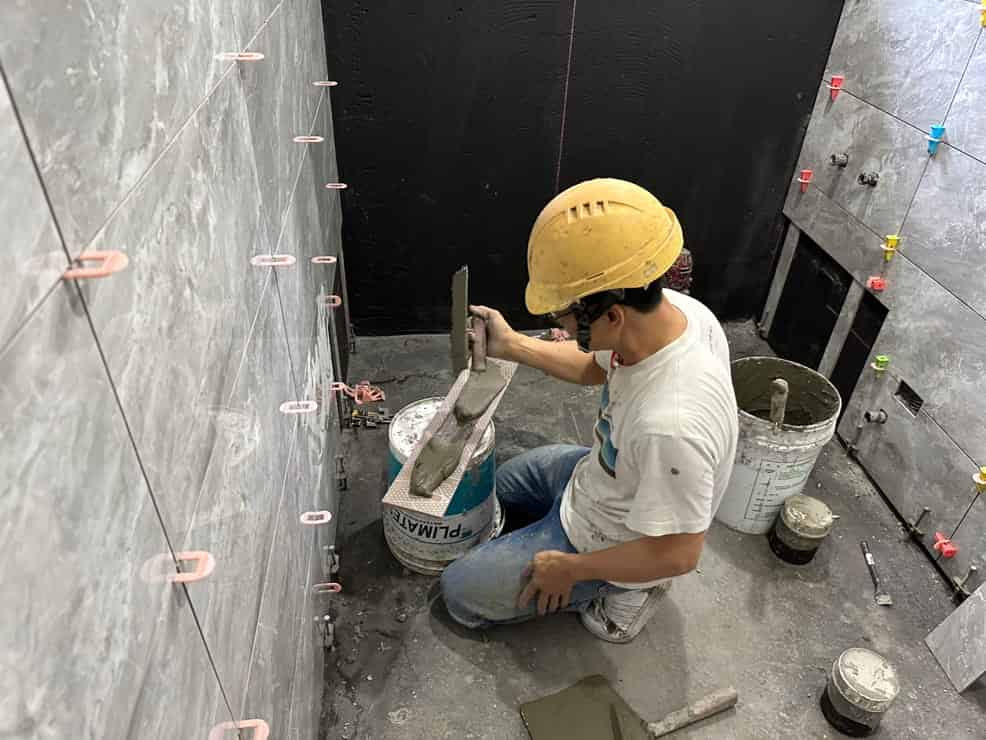

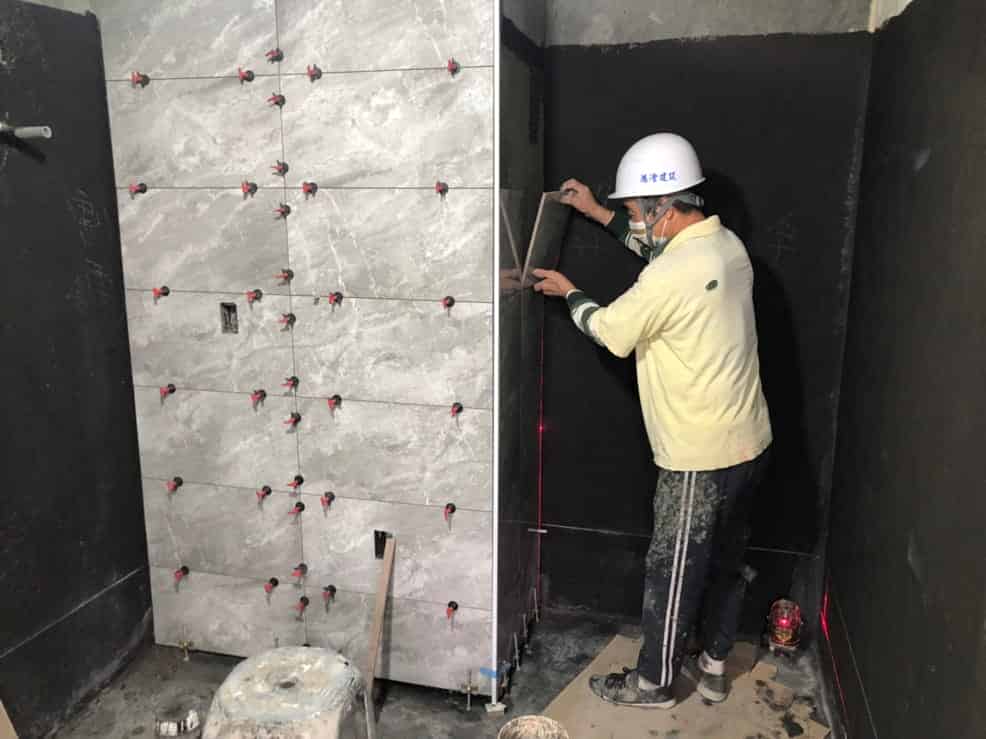

2022/12 Bathroom wall tile installation-1F shop S07
-

2022/12 Water and electricity piping-R2FL
-
-
01
2023
-

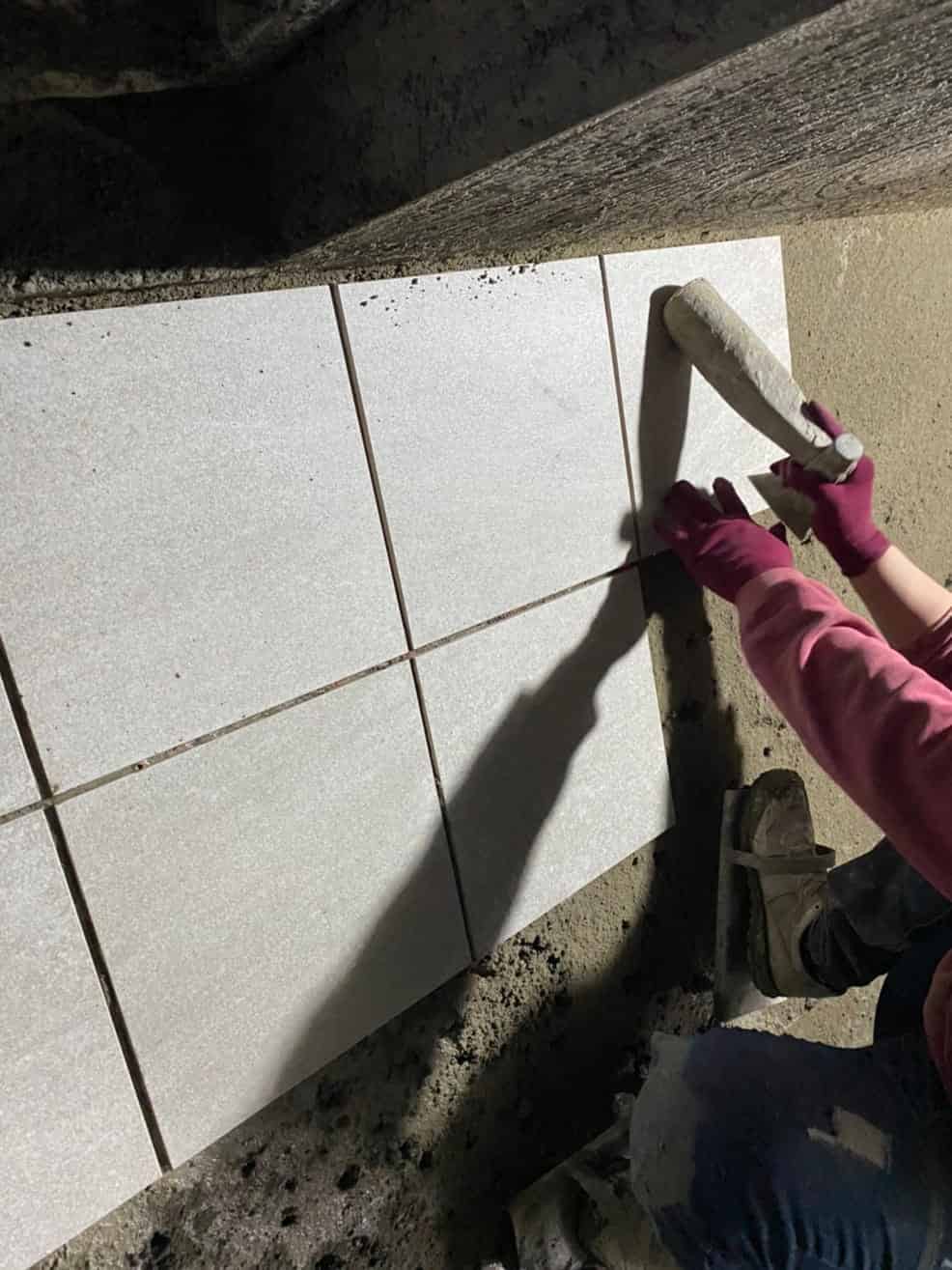

2023/01 Balcony floor tile paving-3FA1
-

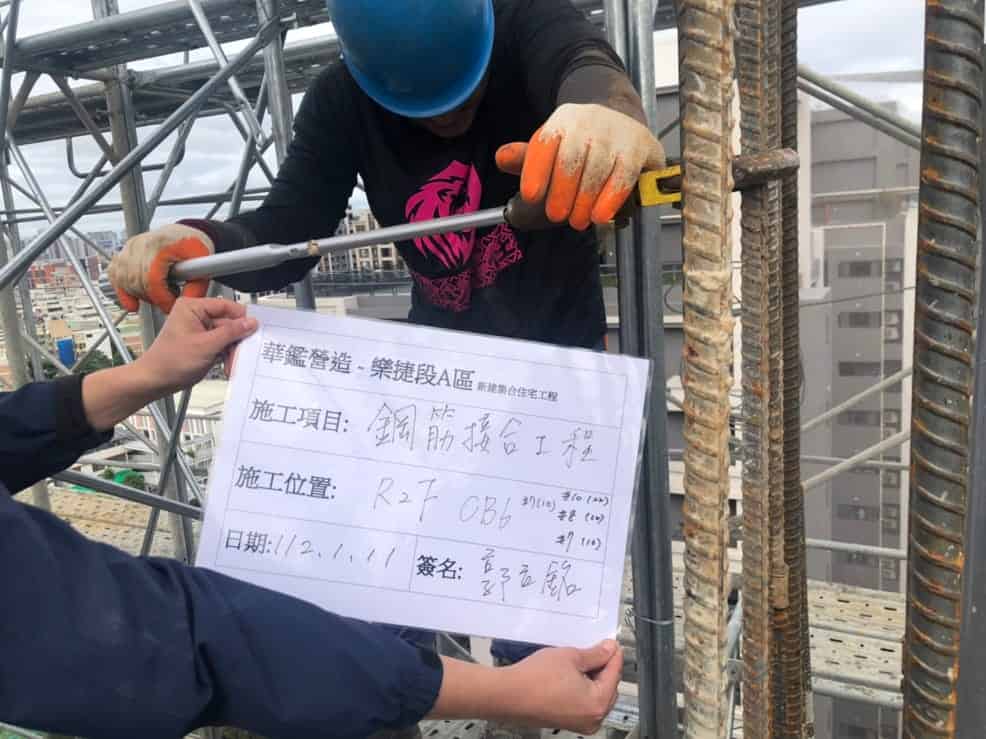

2023/01 Steel bar connection inspection-R2F column
-

2023/01 Paint spray-1F shop S06
-

2023/01 Ceiling construction-1F shop S06
-

2023/01 Water tank wall reinforcement binding-R2F
-
-
02

2023
-
2023/02 12.13F indoor stakeout
-
-
03
2023
-

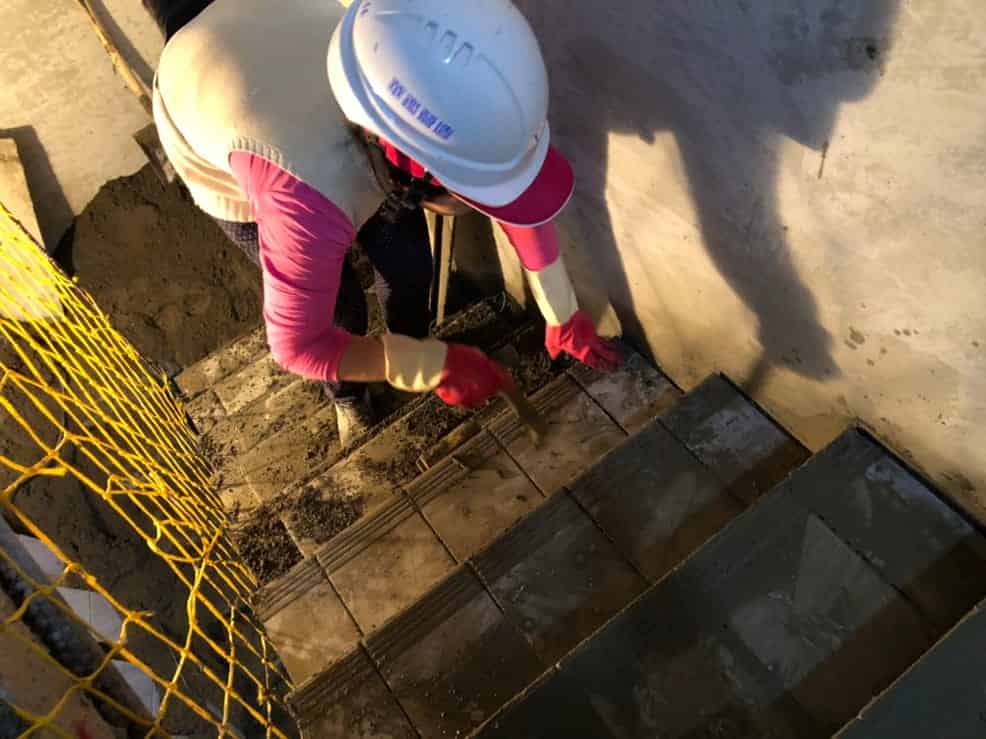

2023/03 Building A stair brick installation
-
-
04
2023
-

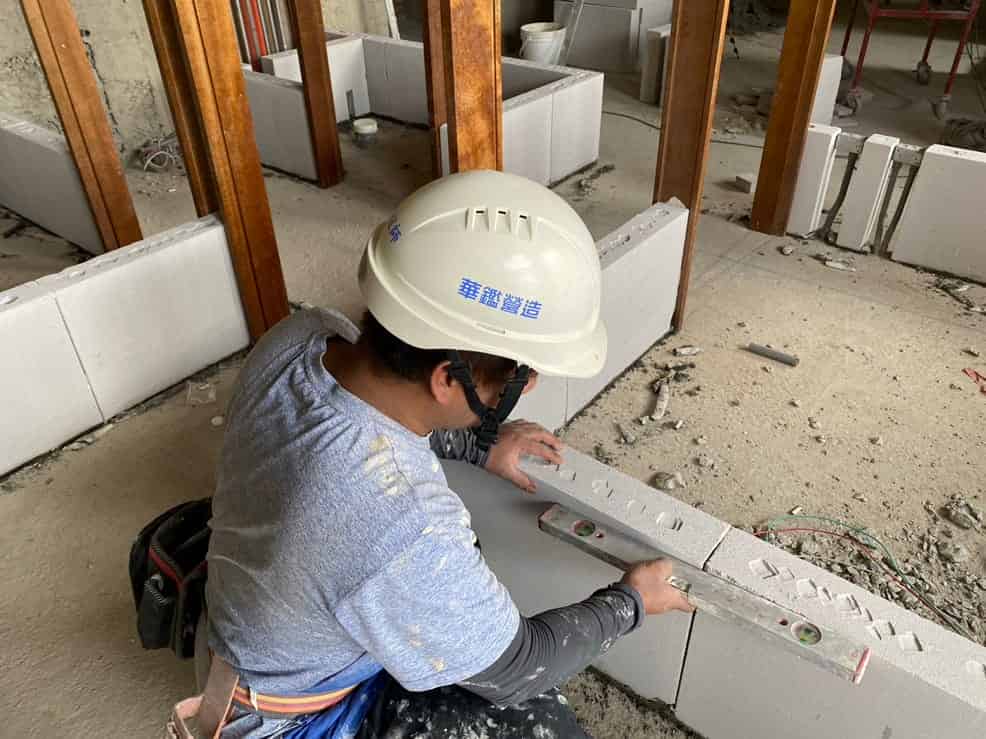

2023/04 Construction of white brick partitions on 13F, Building ABC
-

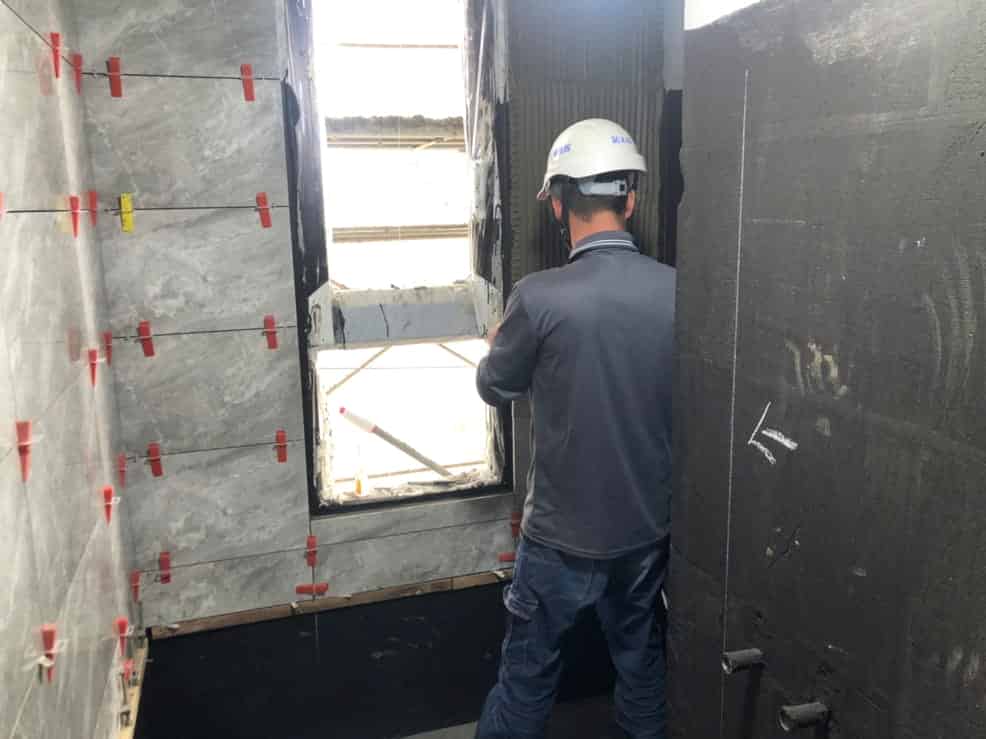

2023/04 Construction of wall tiles for toilet on 3F, Building A
-

2023/04 Construction of aluminum windows on 10F in Building B
-
-
05
2023
-

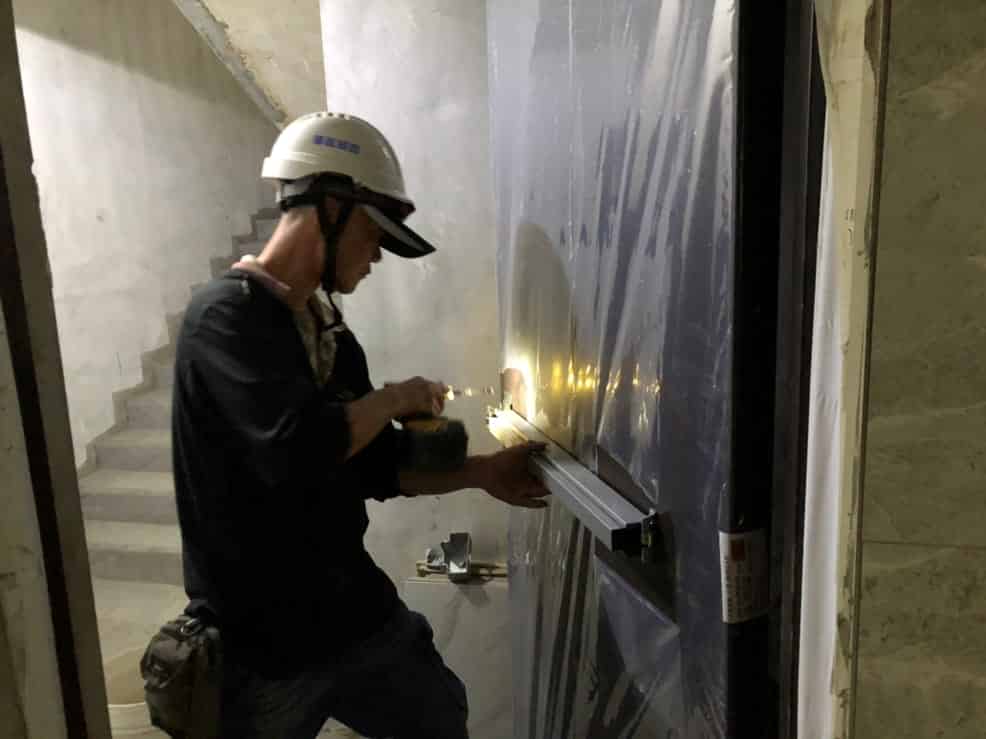

2023/05 Installation of fire doors from 1F to 3F in Building AC
-

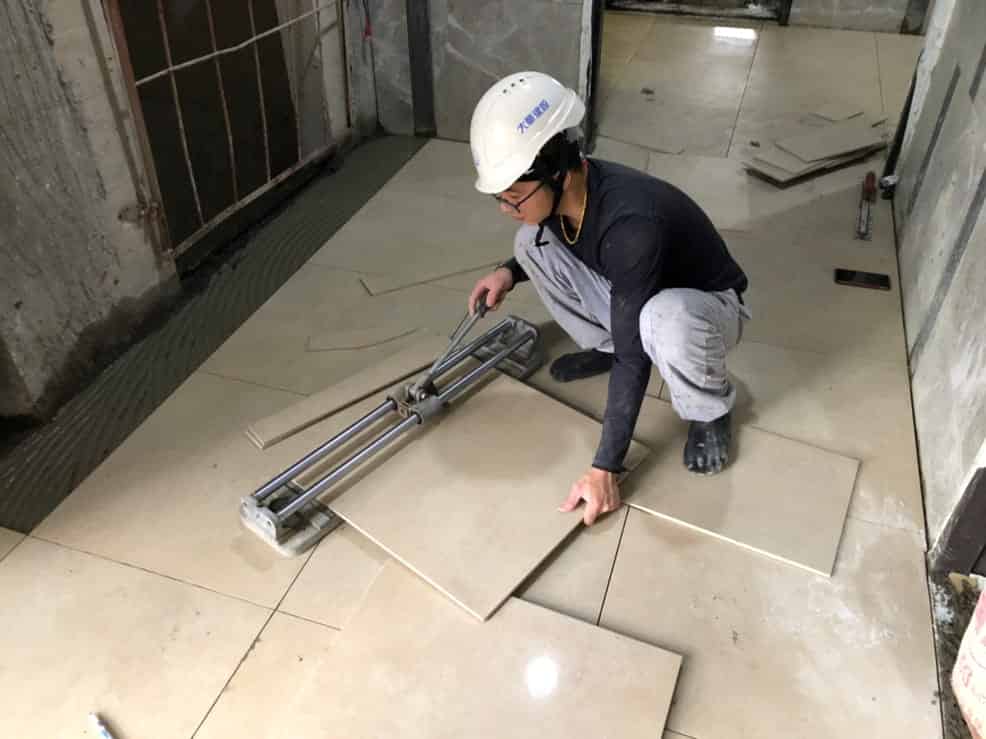

2023/05 Installation of floor tiles in the 3F staircase hall of Building A
-

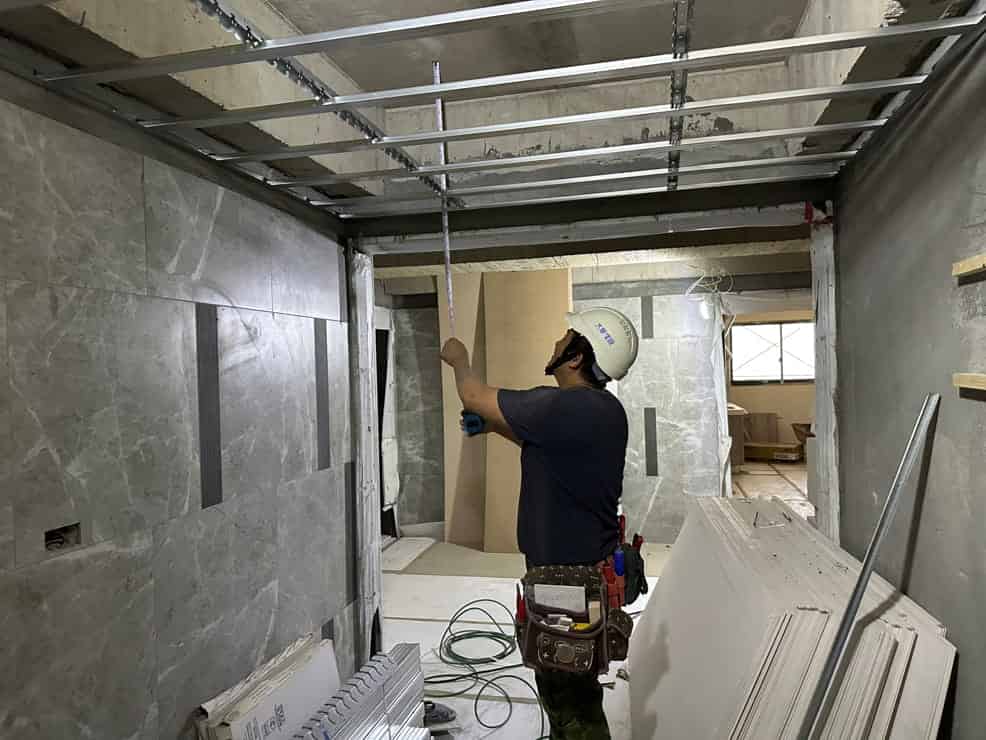

2023/05 Construction of ceiling in staircase hall of Building C
-
-
06
2023
-

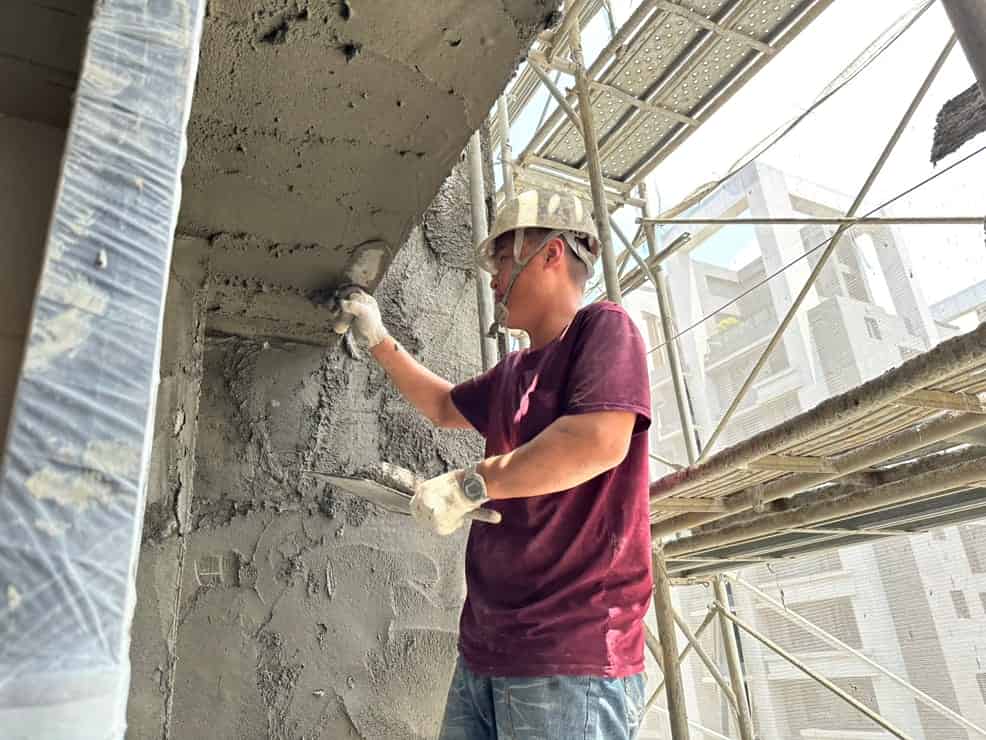

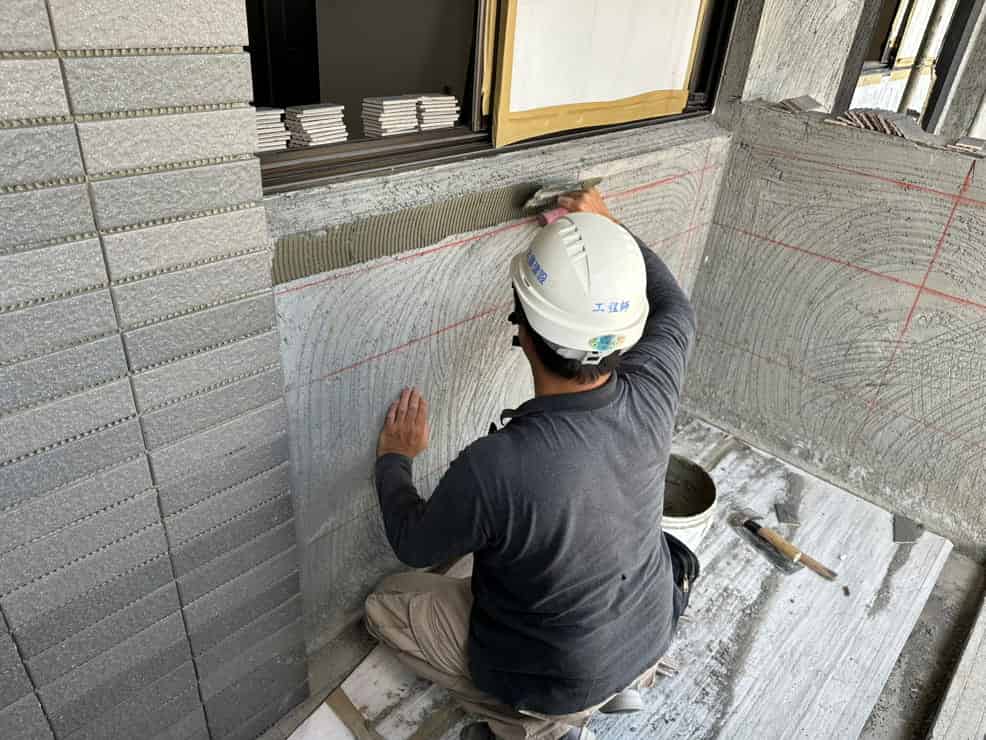

2023/06 Exterior wall plaster application
-
2023/06 Exterior wall tile construction
-
2023/06 Bathroom wall tile installation
-
-
07
2023
-

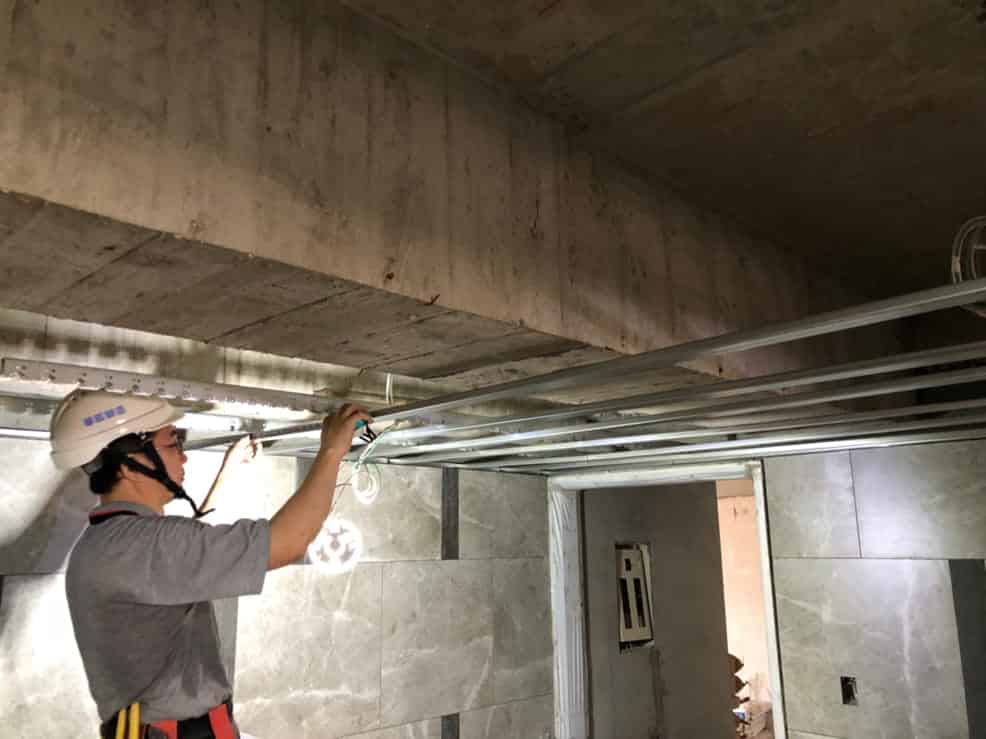

2023/07 Ceiling installation
-

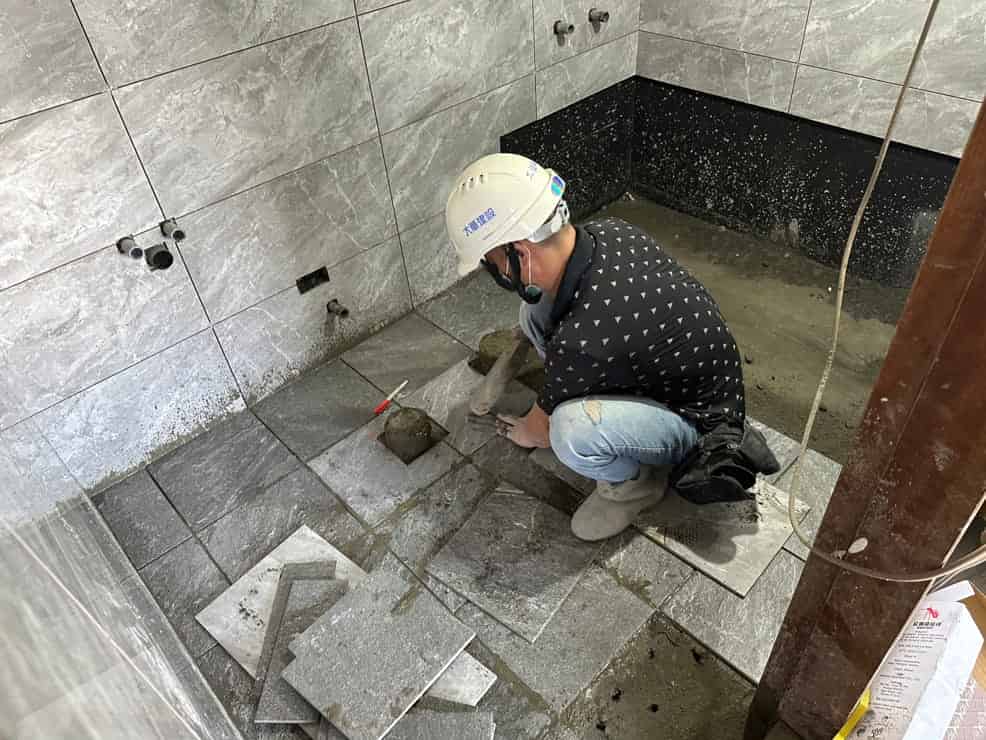

2023/07 Installation of bathroom floor tiles
-
-
08
2023
-

2023/08 Gas pipe work
-

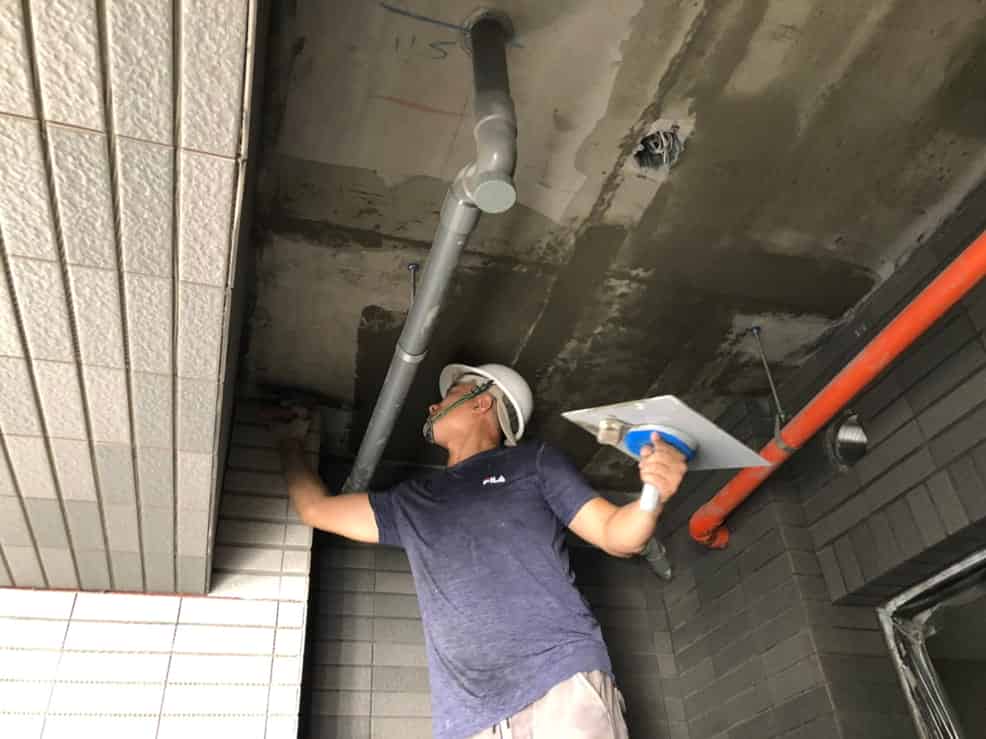

2023/08 Balcony soil preparation
-

2023/08 Elevator equipment installation
-
-
09
2023
-

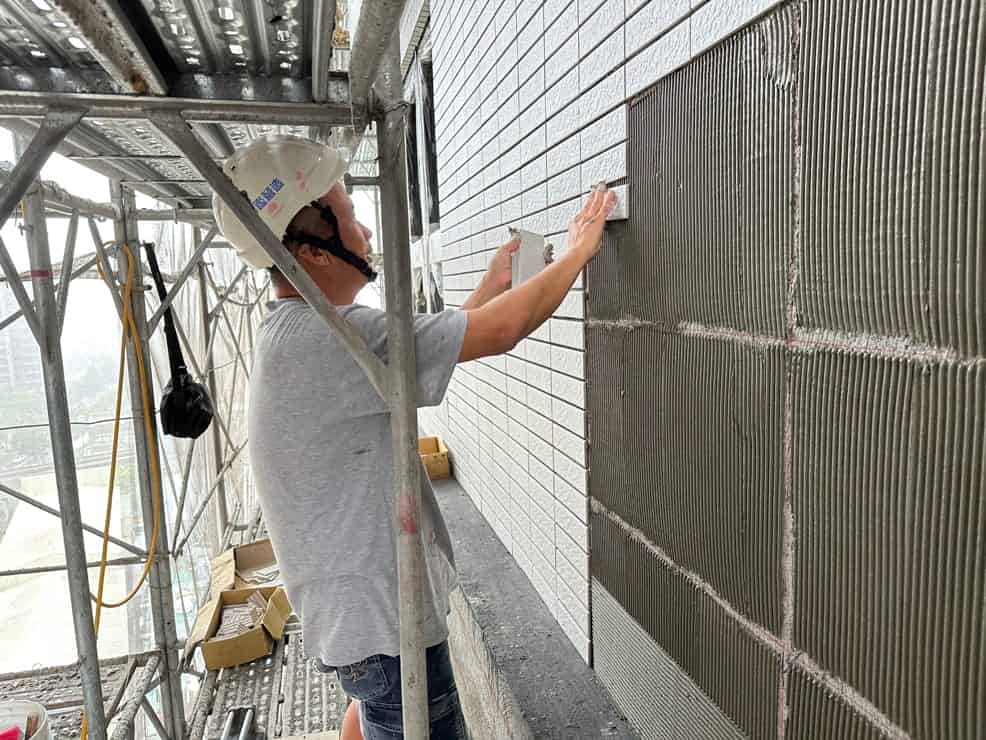

2023/09 Installation of exterior wall hangings
-

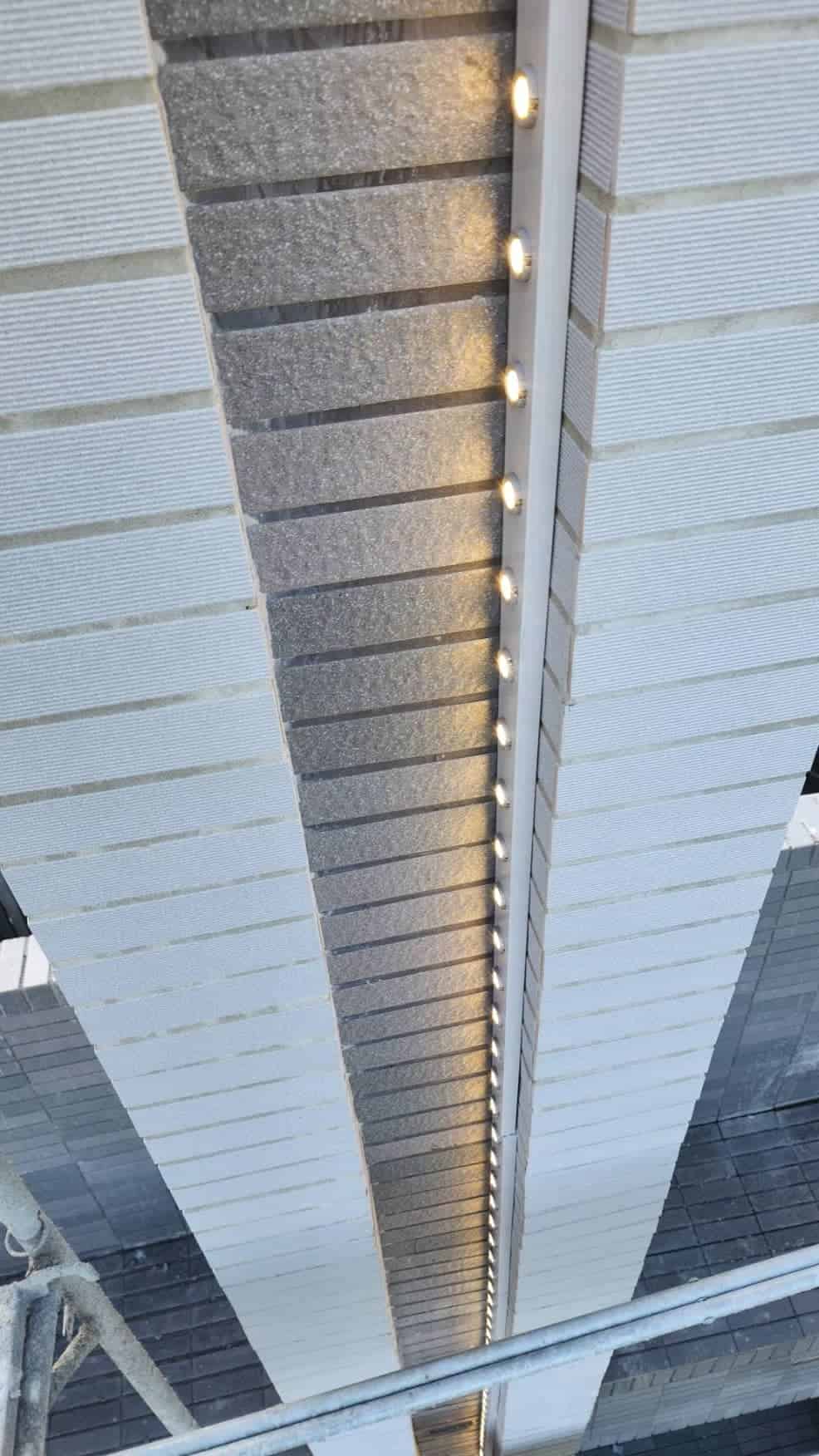

2023/09 Installation of exterior wall lighting
-

2023/09 Dismantling of the scaffolding
-
-
10
2023
-

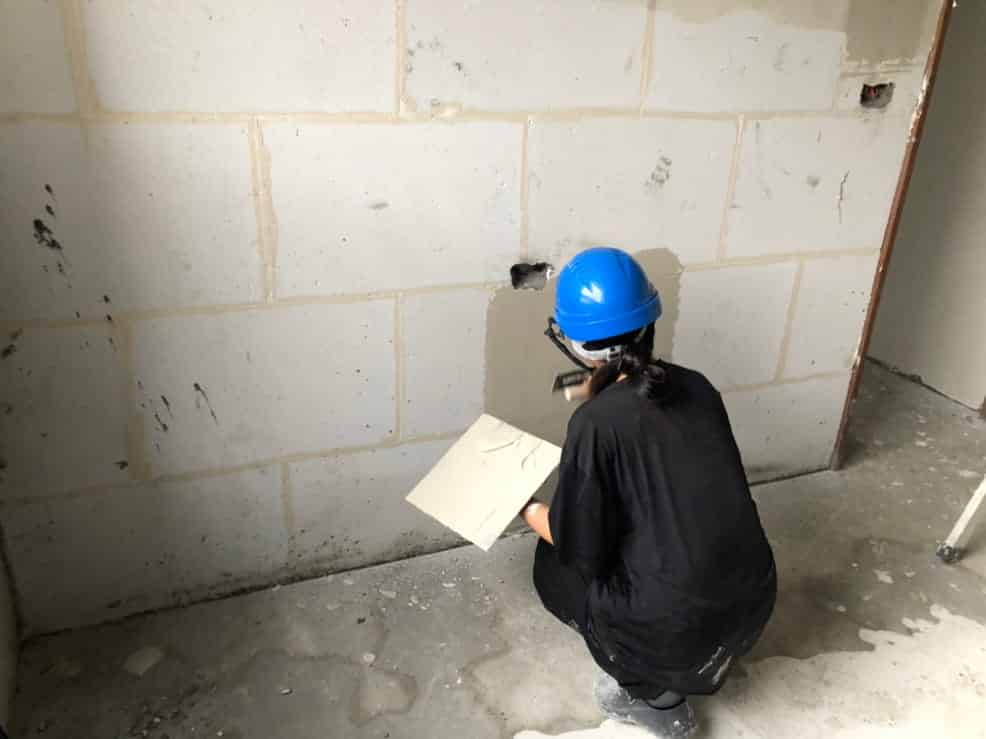

2023/10 White bricks and soil on 11F, Building A
-

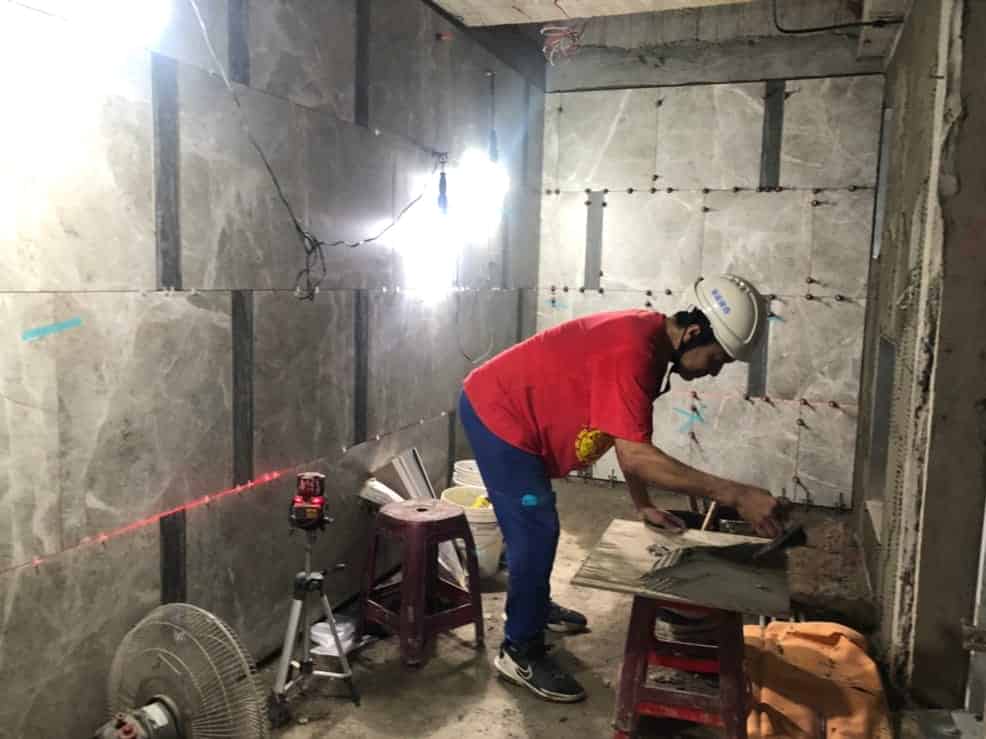

2023/10 Installation of wall tiles in the basement staircase hall of Building B
-

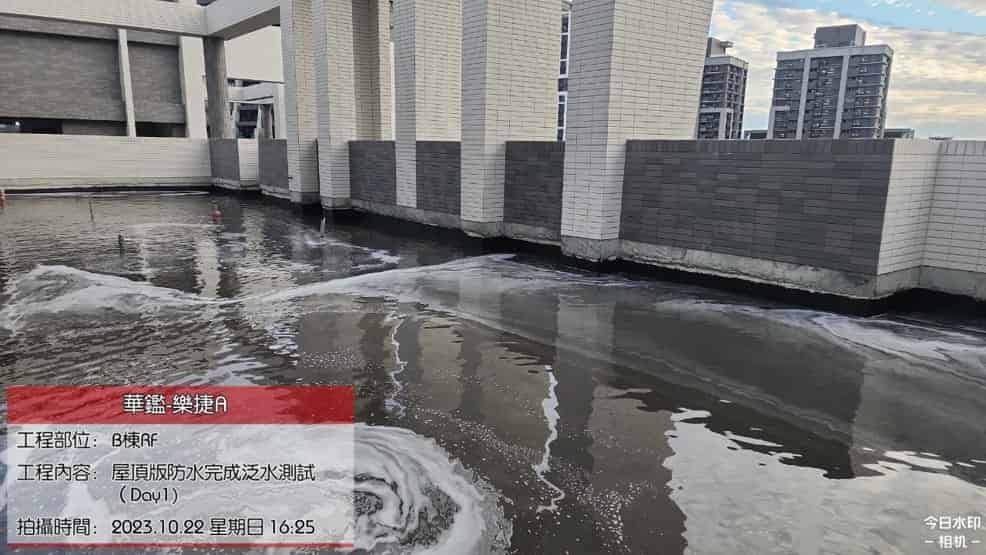

2023/10 Roof waterproofing and flashing test
-
-
11

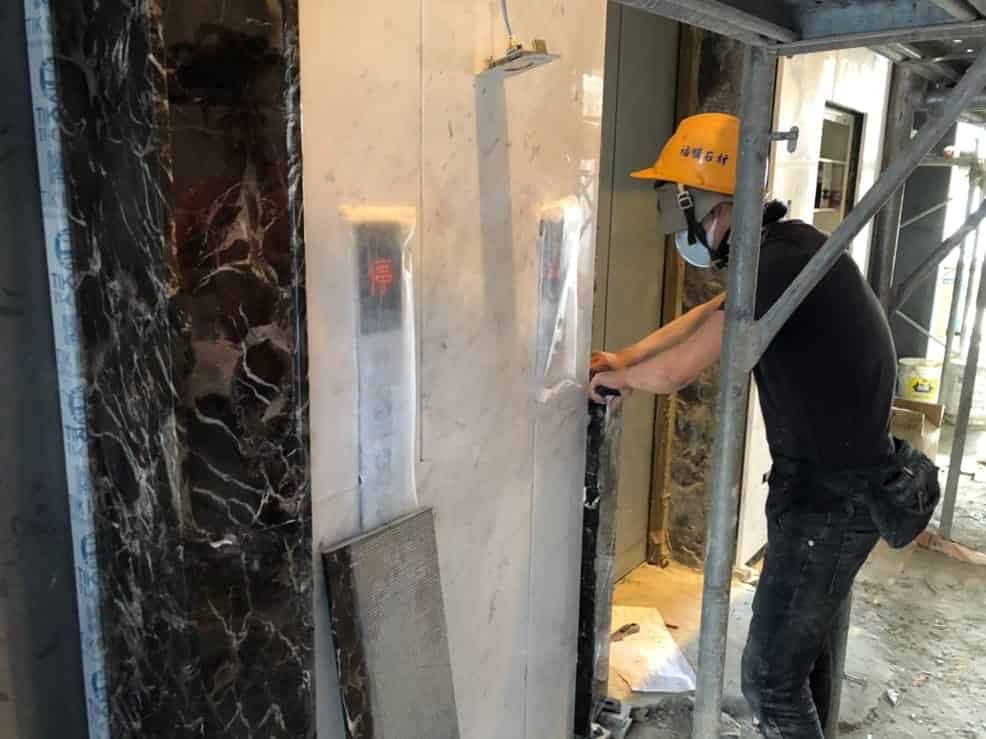

2023
-
2023/11 Stone construction in the 1F staircase hall of Building B
-

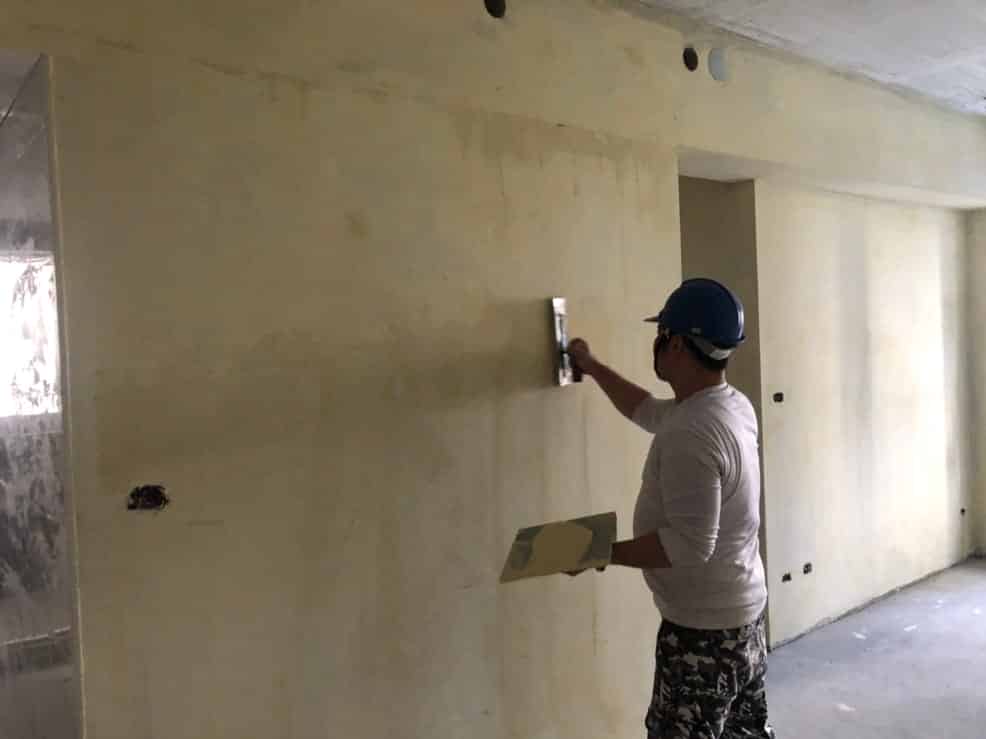

2023/11 Building B wall paint and soil application
-

2023/11 Installation of door leaf in the entrance hall of Building B
-
-
12
2023
-

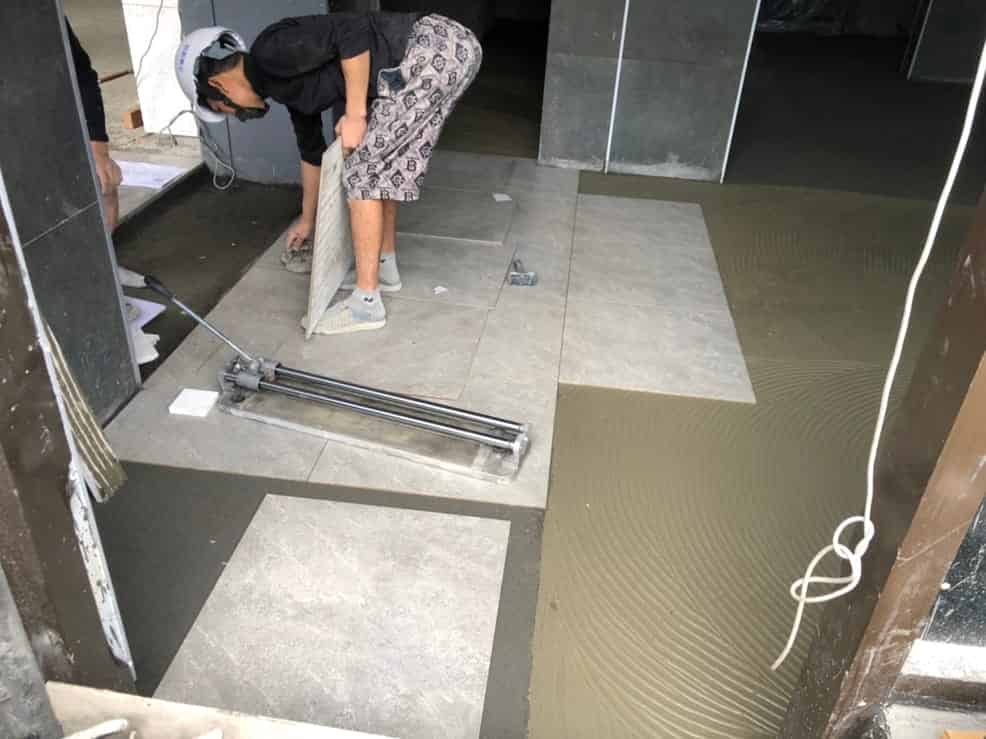

2023/12 1F public floor tile installation
-

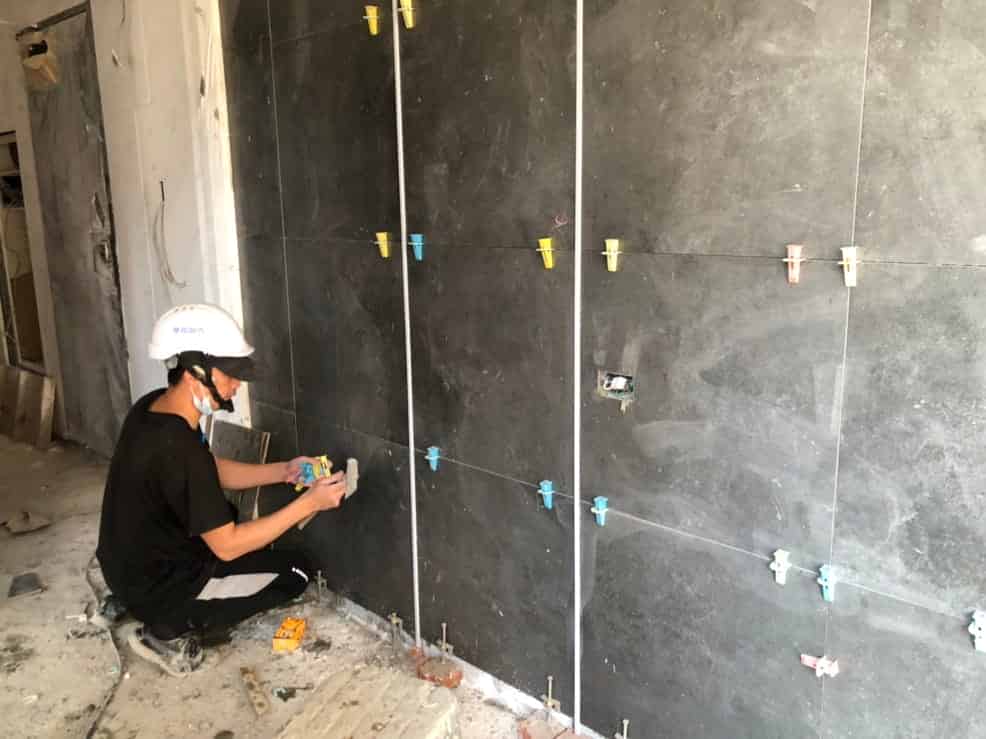

2023/12 1F Public wall tile installation
-

2023/12 Building B roof flower terrace construction
-
-
01
2024
-

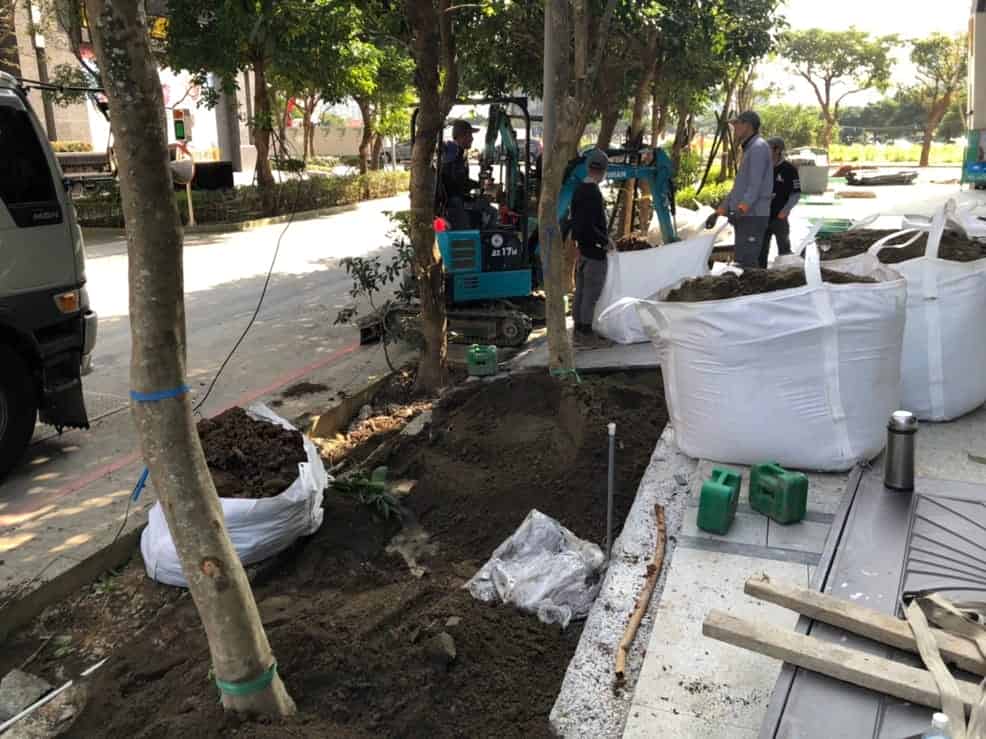

2024/01 1F surrounding tree cave landscaping construction
-

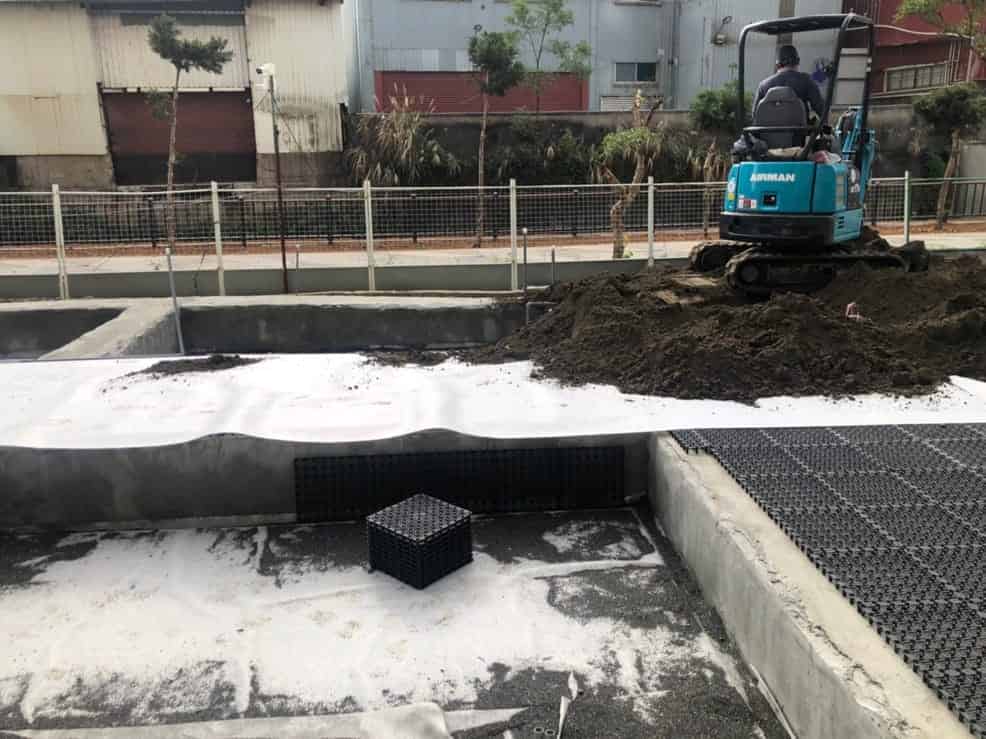

2024/01 Soil filling, drainage board and non-woven fabric laying in the tree hole in the atrium
-

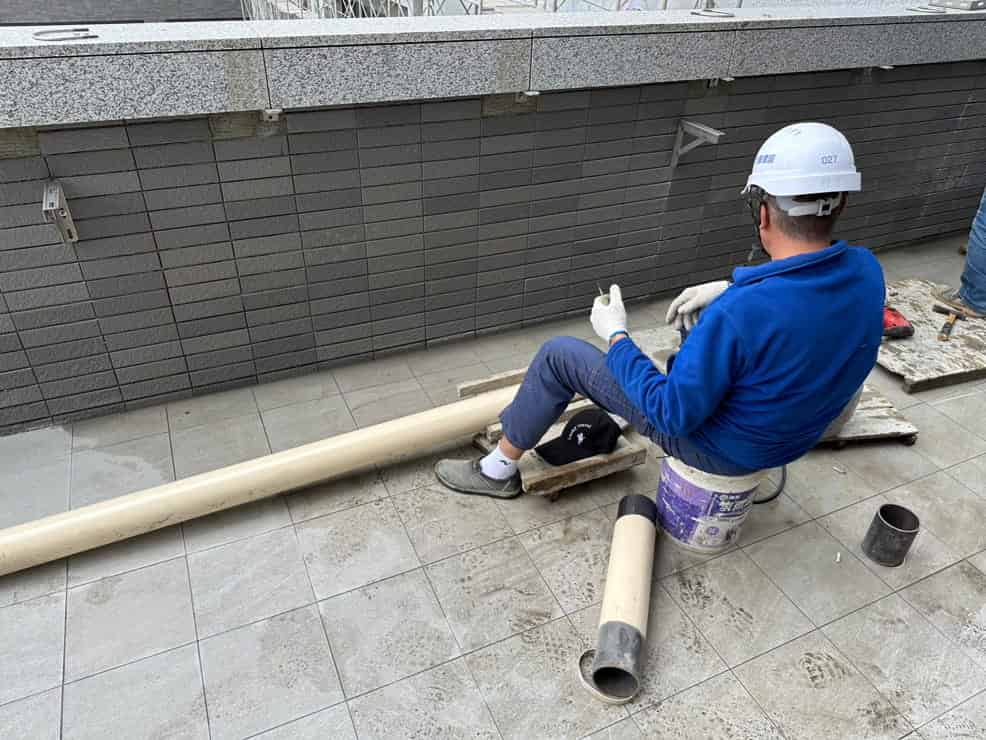

2024/01 External gas pipe construction
-
-
02
2024
-

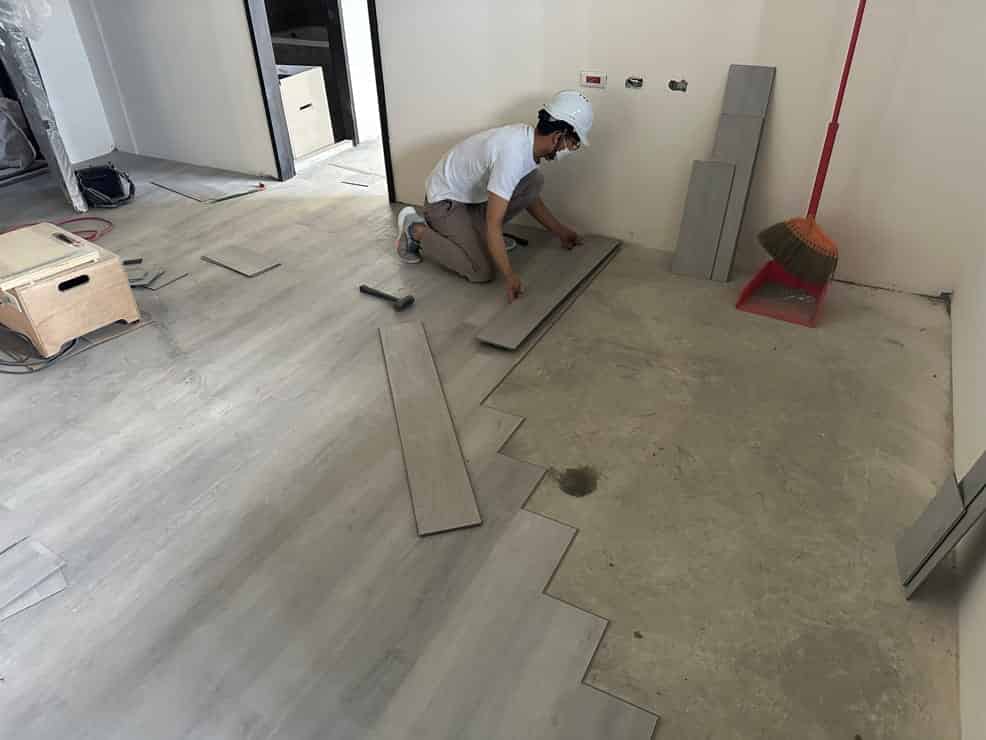

2024/02 Indoor SPC floor construction
-

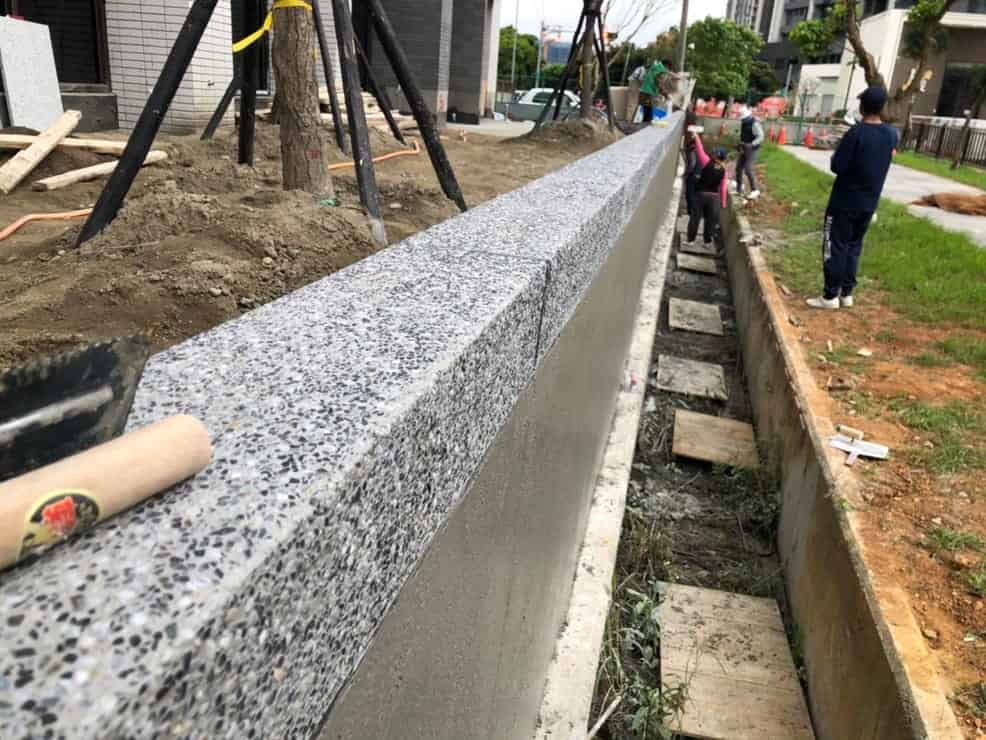

2024/02 Construction of walls with stones
-

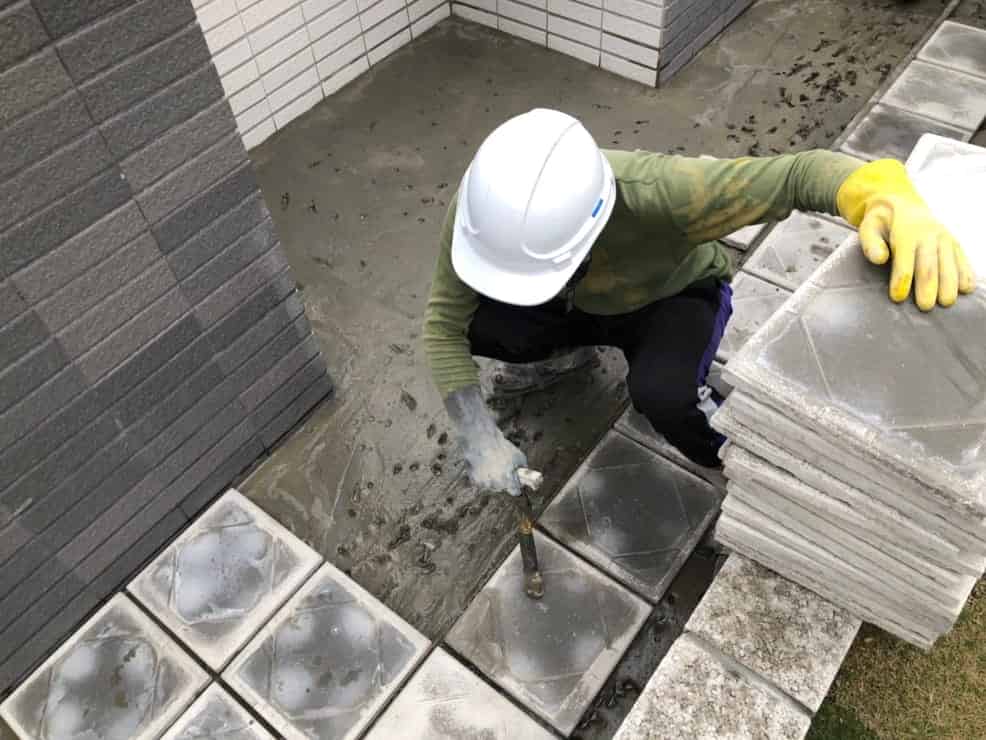

2024/02 Installation of roof insulation bricks
-
-
03
2024
-

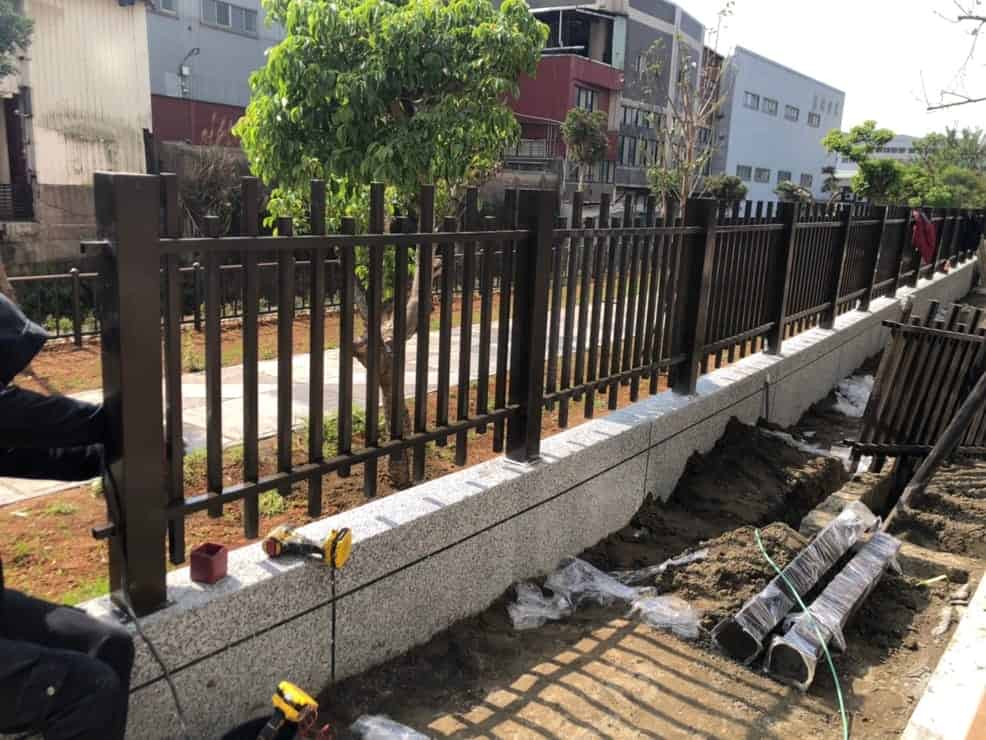

2024/03 1F fence iron parts construction
-
2024/03 Atrium landscape construction
-

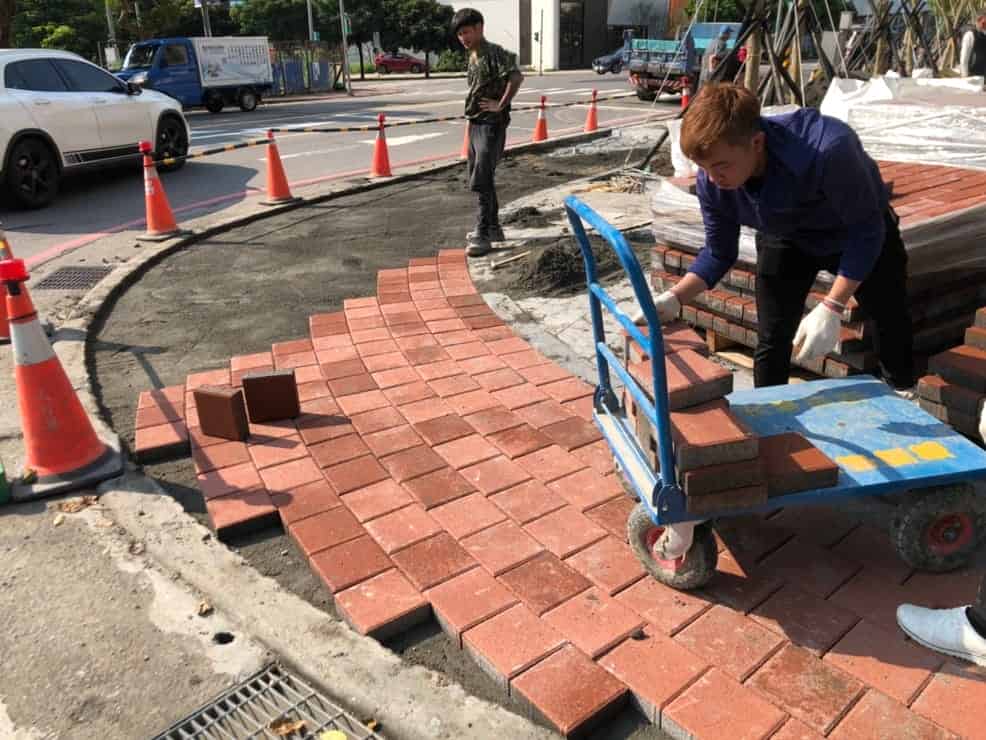

2024/03 sidewalk brick installation
-
-
04
2024
-

2024/04 Mirror construction in public halls
-

2024/04 Construction of public ironwork frames
-

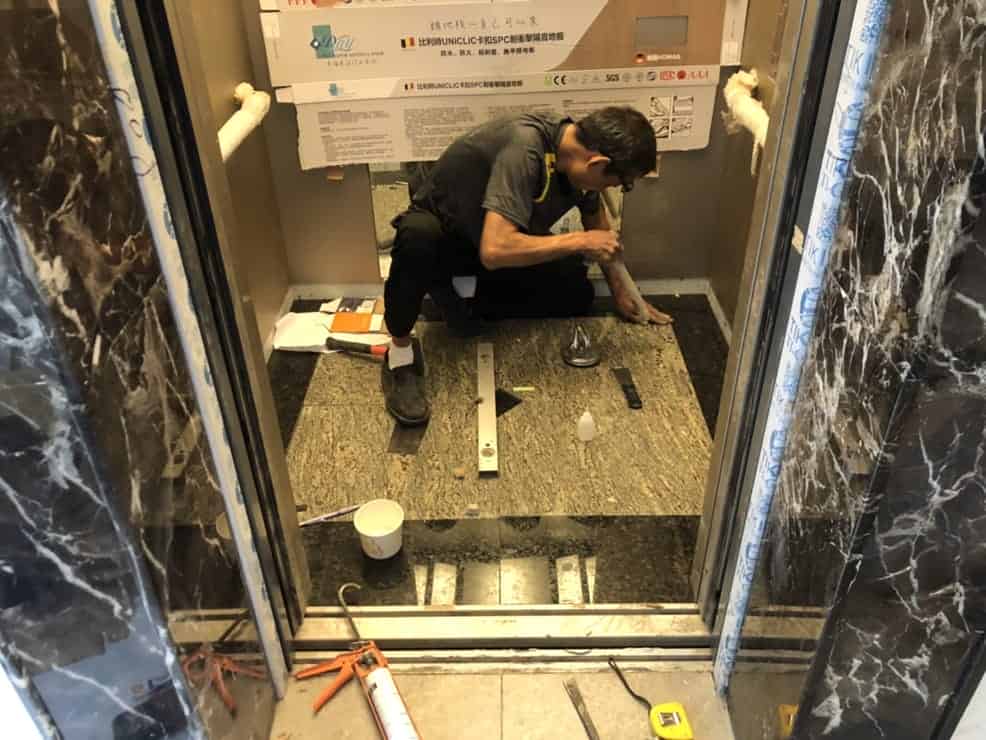

2024/04 Carriage stone floor construction
-
-
05
2024
-

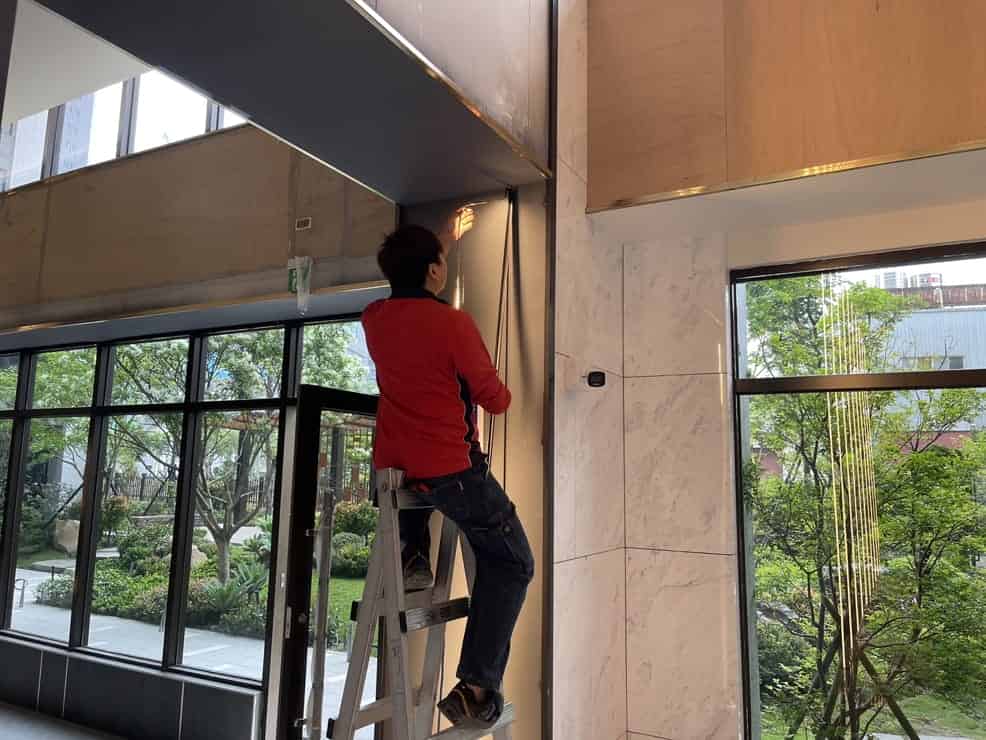

2024/05 Installation of public lighting fixtures in the lobby
-

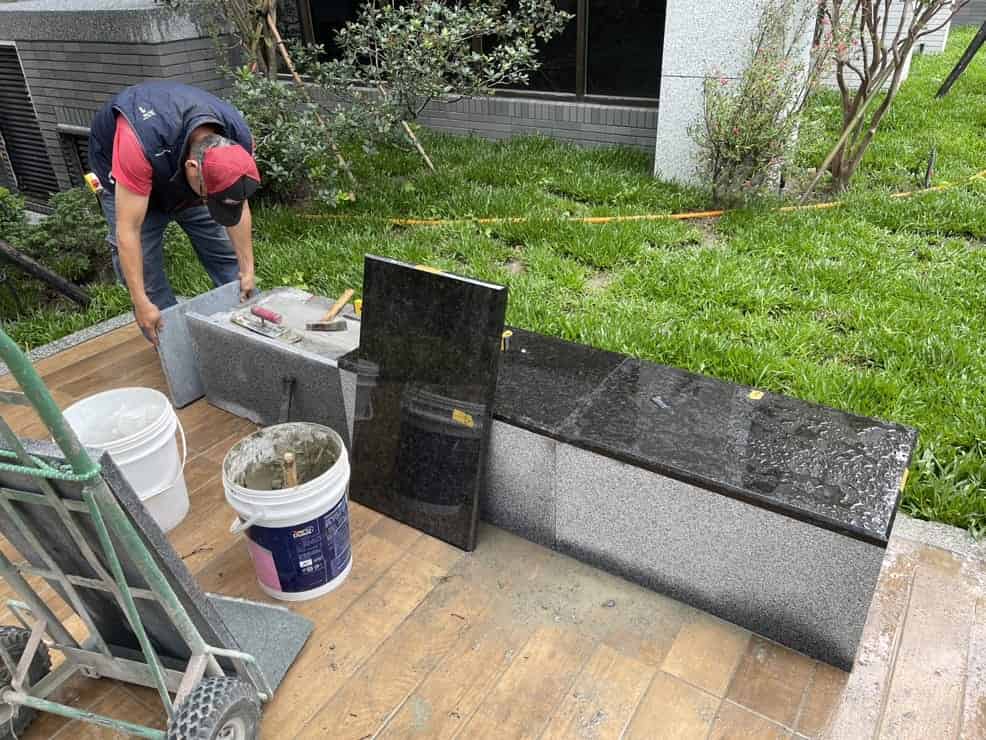

2024/05 Landscape stone seating construction
-

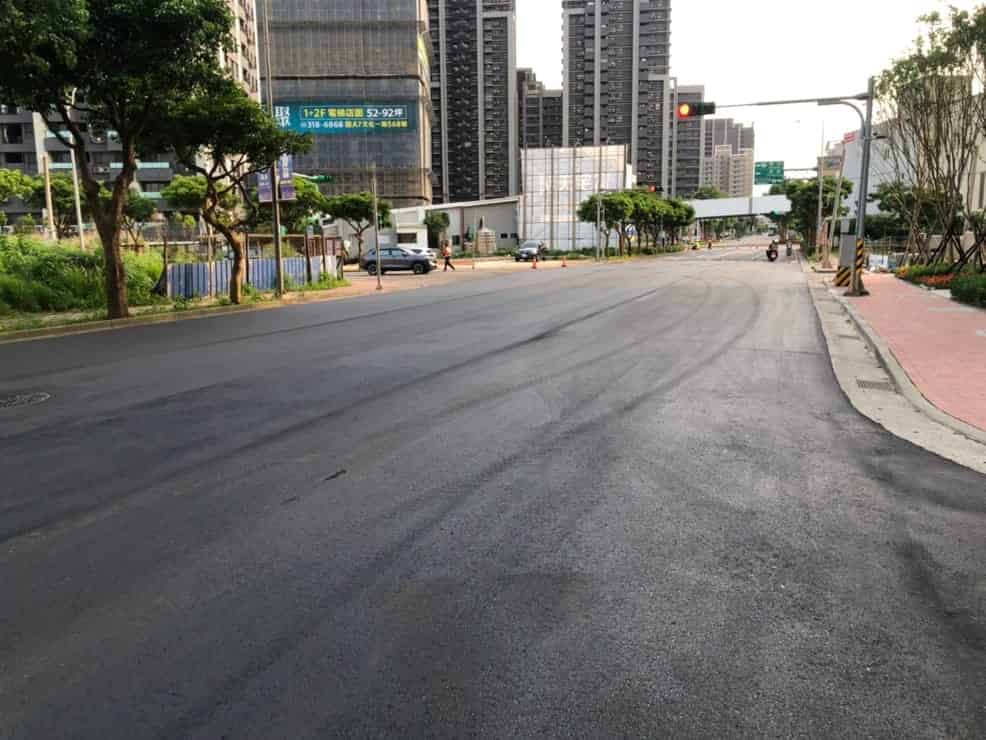

2024/05 Road AC construction
-
-
06
2024
-

2024/06 9F paint
-
-
07
2024
-

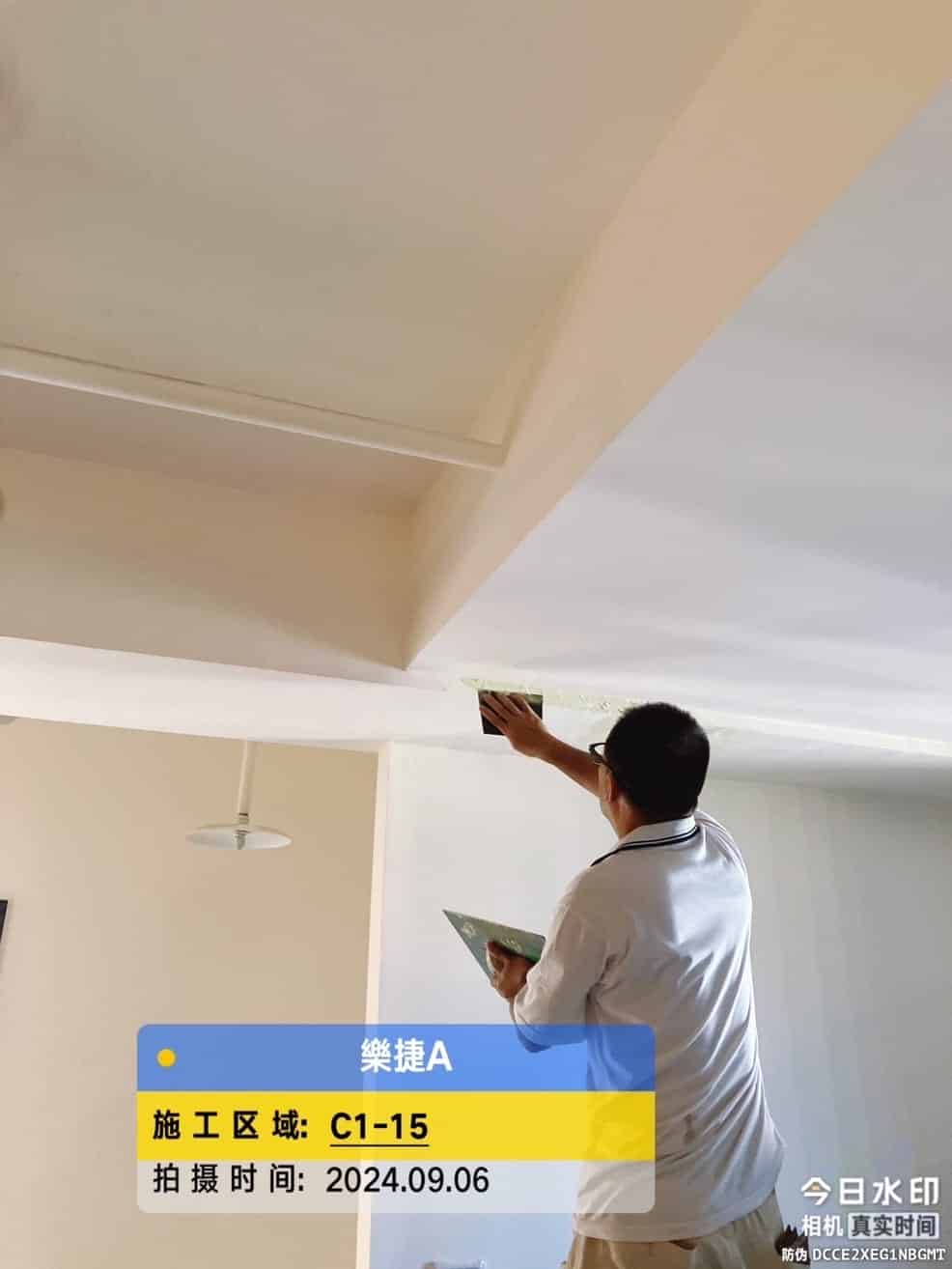

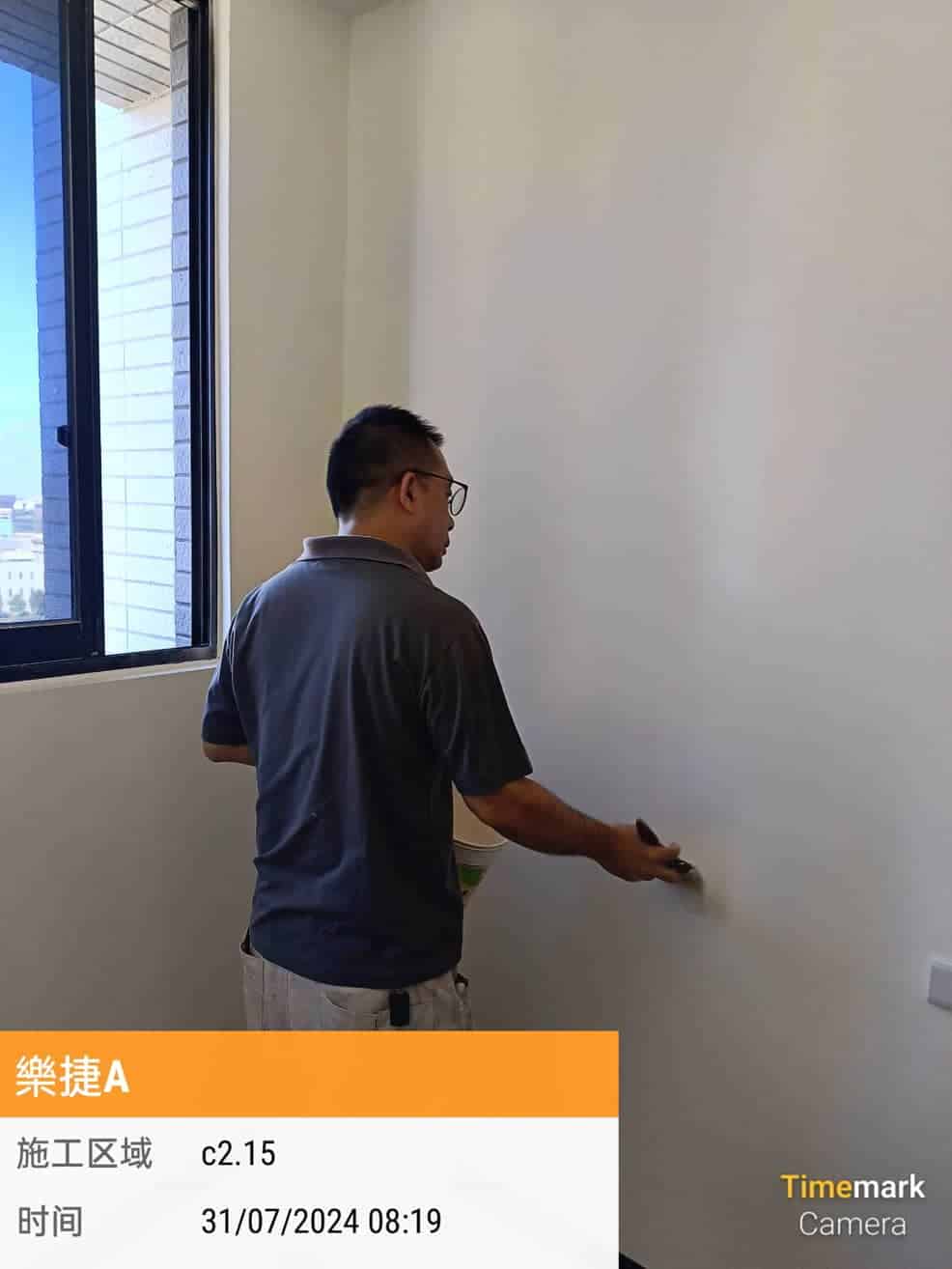

2024/07 15F paint
-
-
08
2024
-

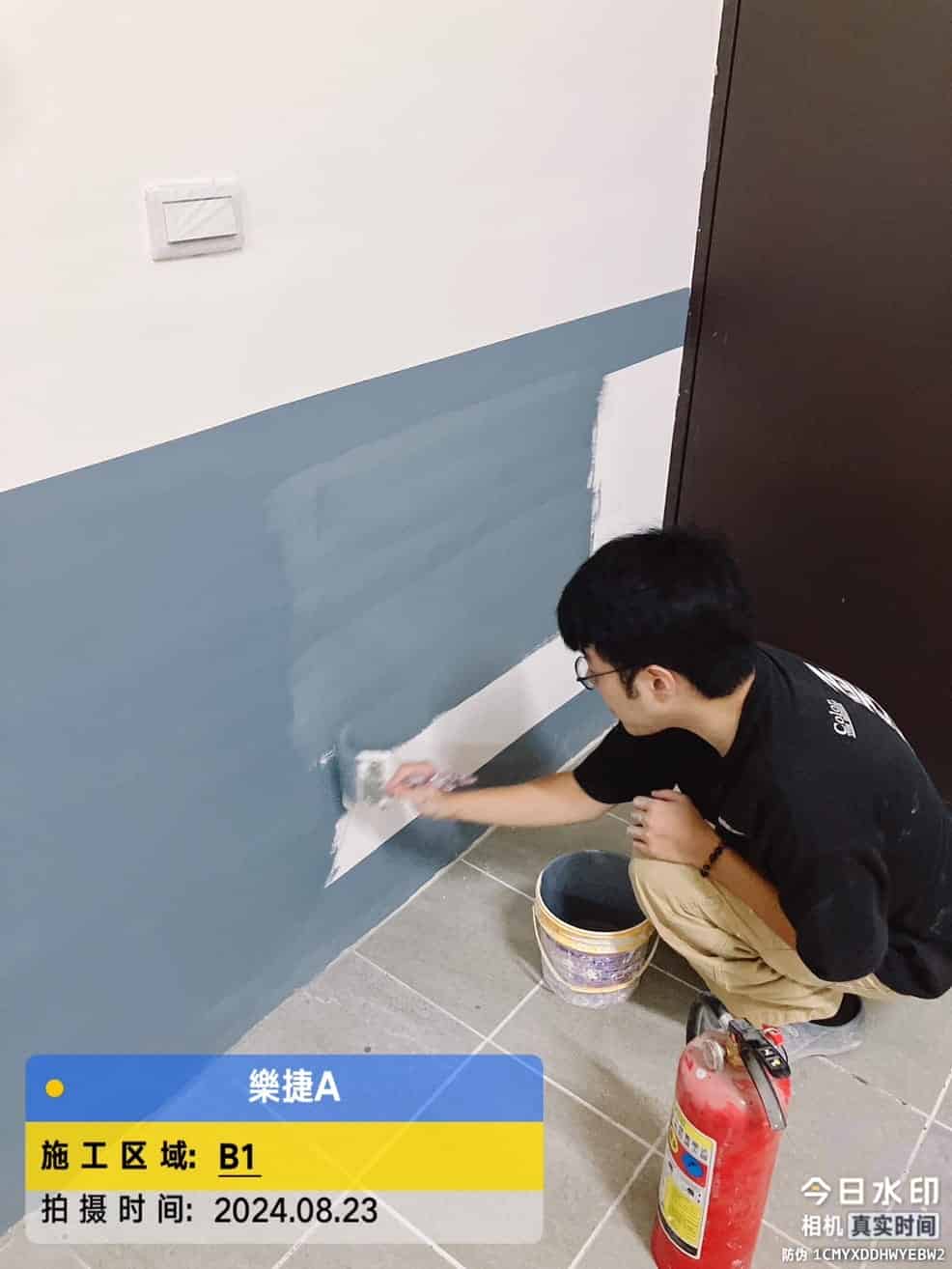

2024/08 B1F garbage disposal room paint
-

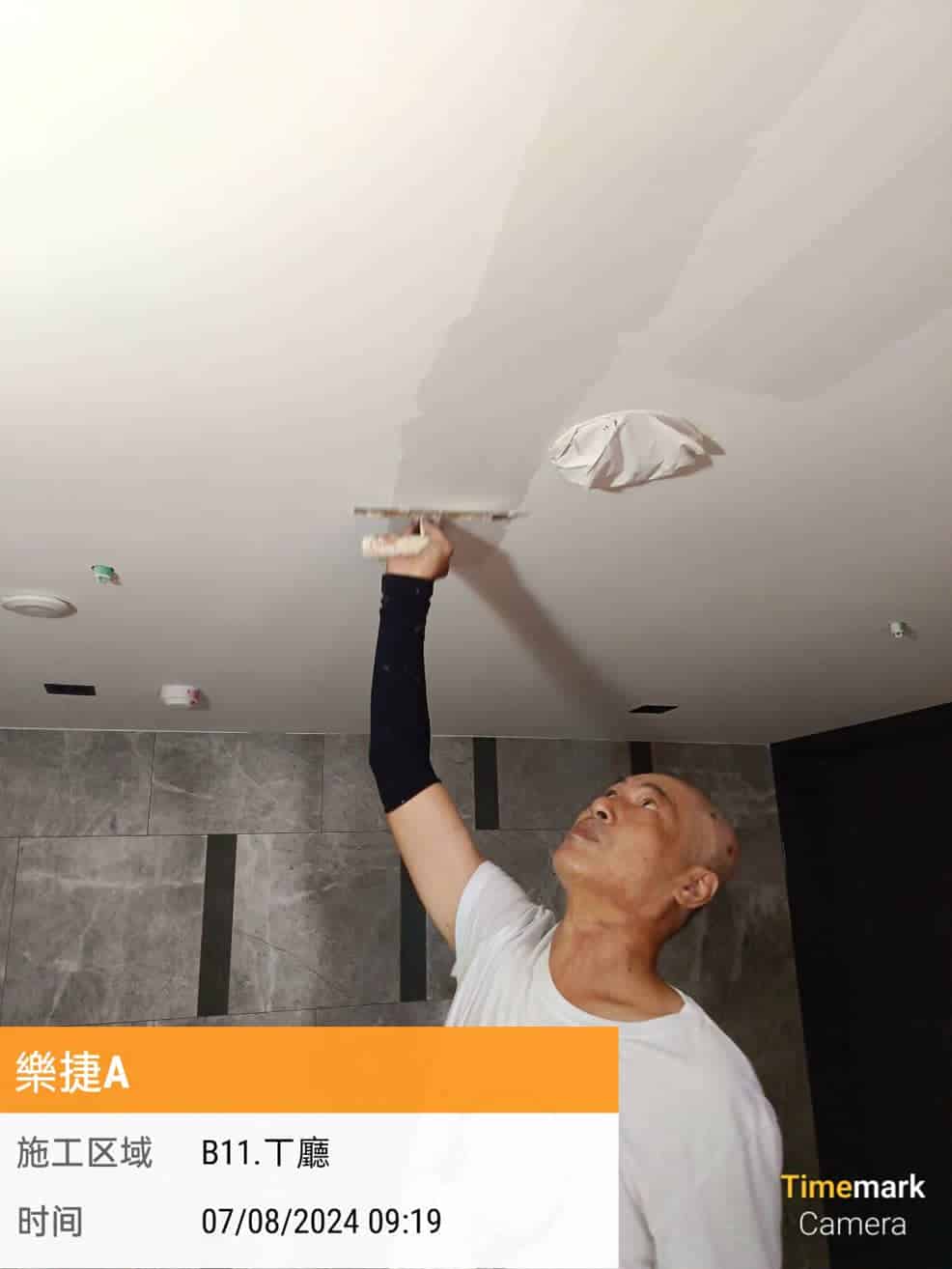

2024/08 Painting of the 11F elevator hall in Building B
-

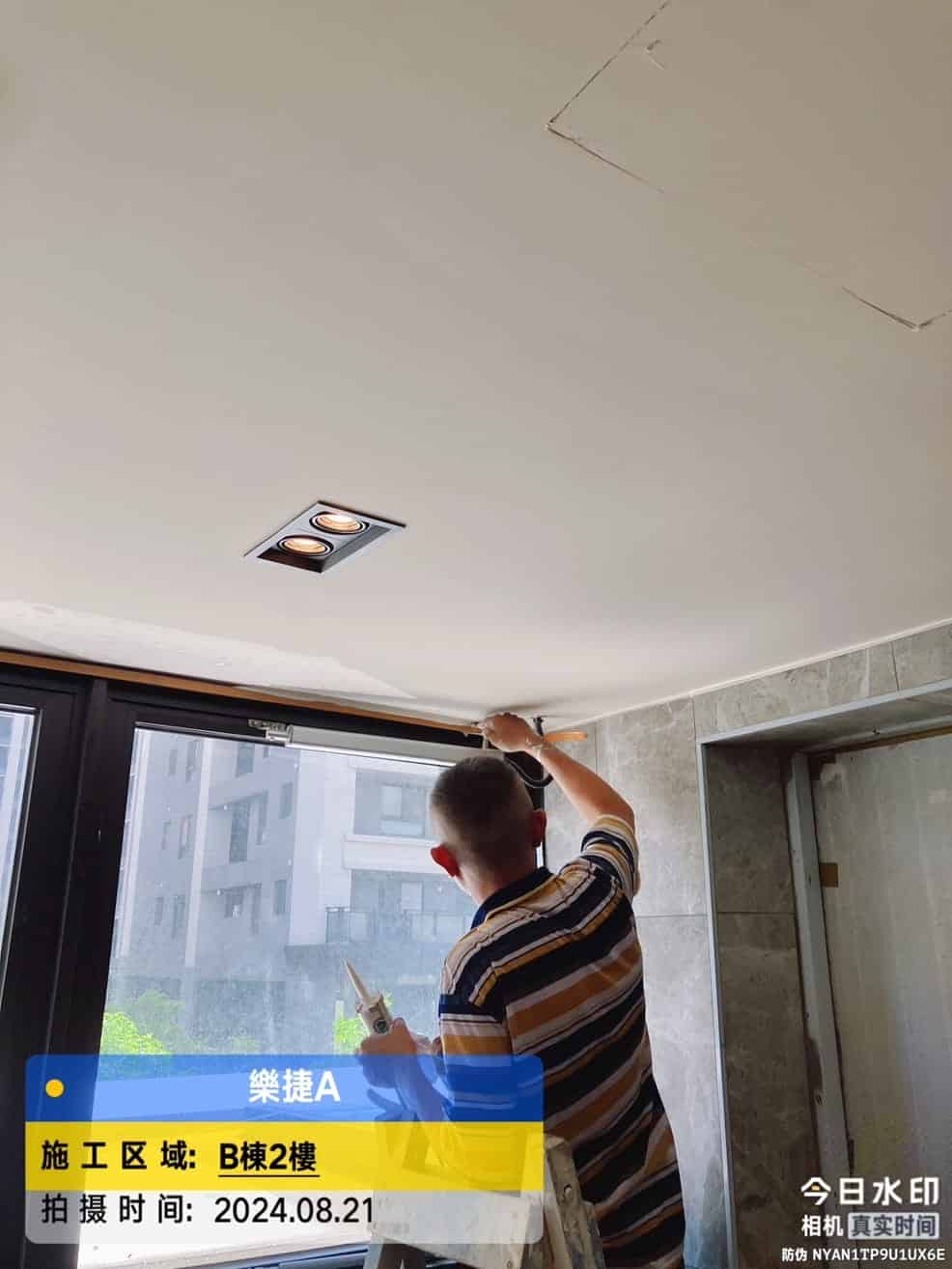

2024/08 Painting of elevator hall F in Building B
-
-
09
2024
-
2024/09 15F paint
-

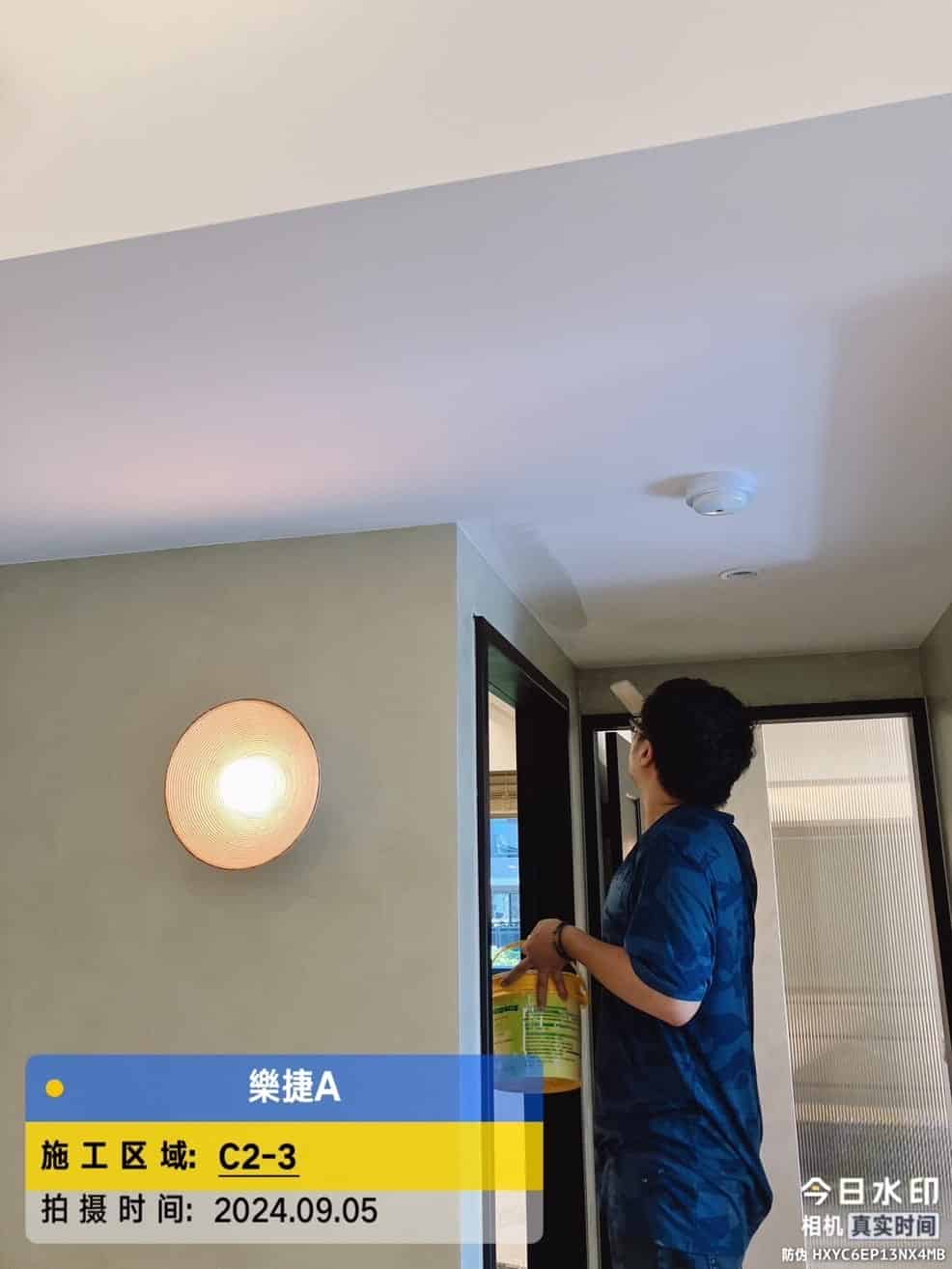

2024/09 3F paint
-
-
10
2024
-

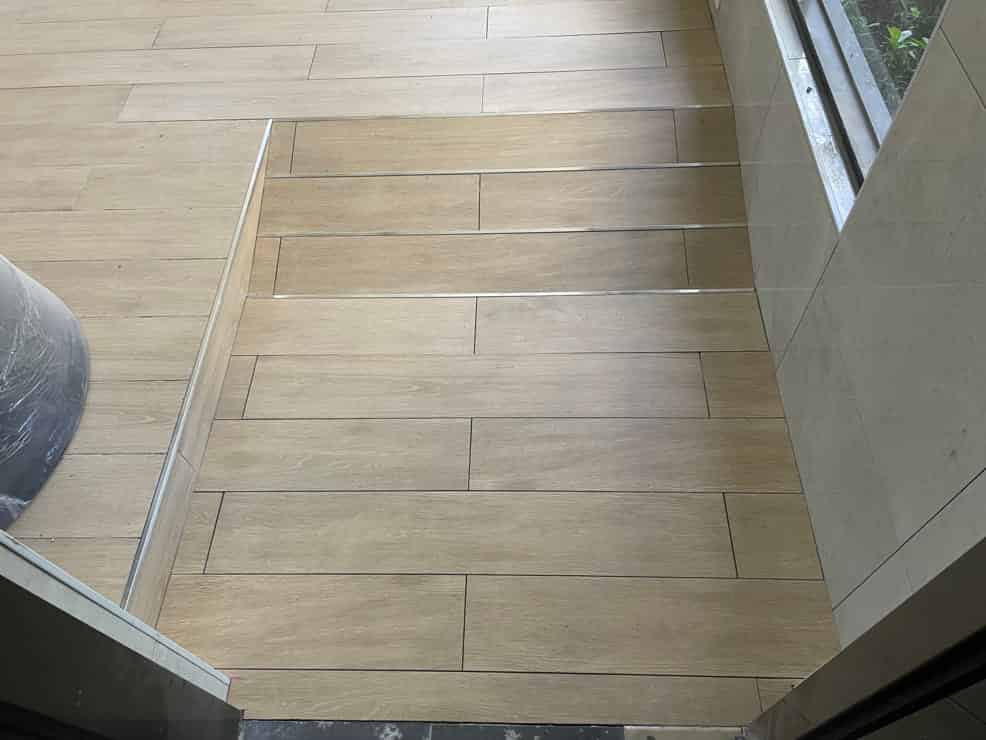

2024/10 Gym entrance slope floor tiles
-

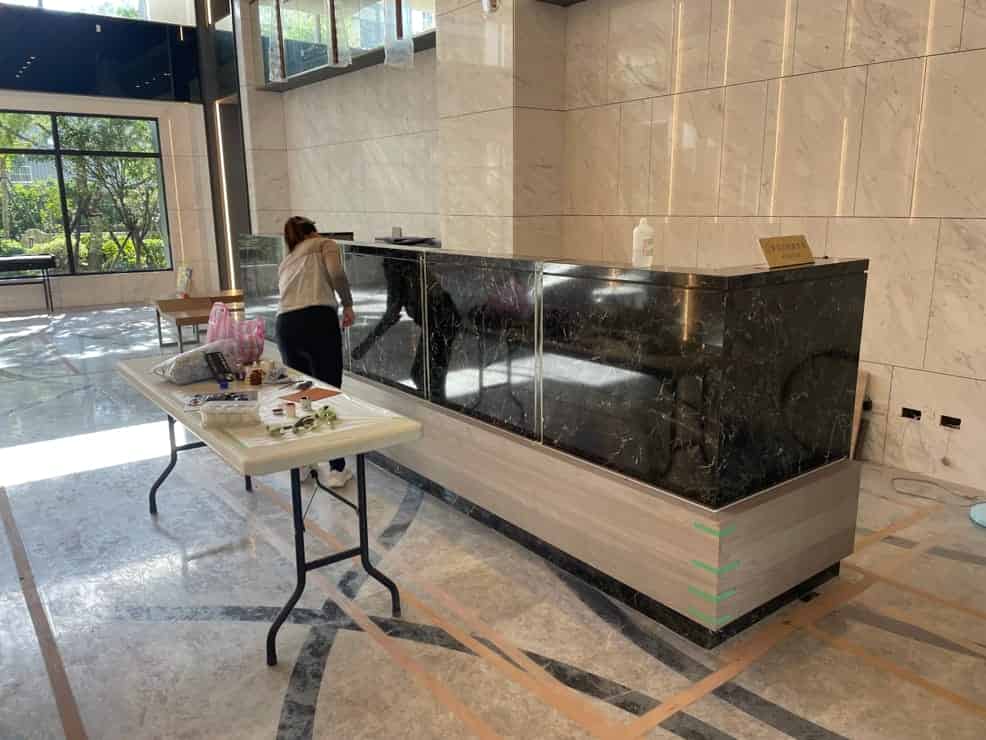

2024/10 Counter stone beauty in the lobby
-

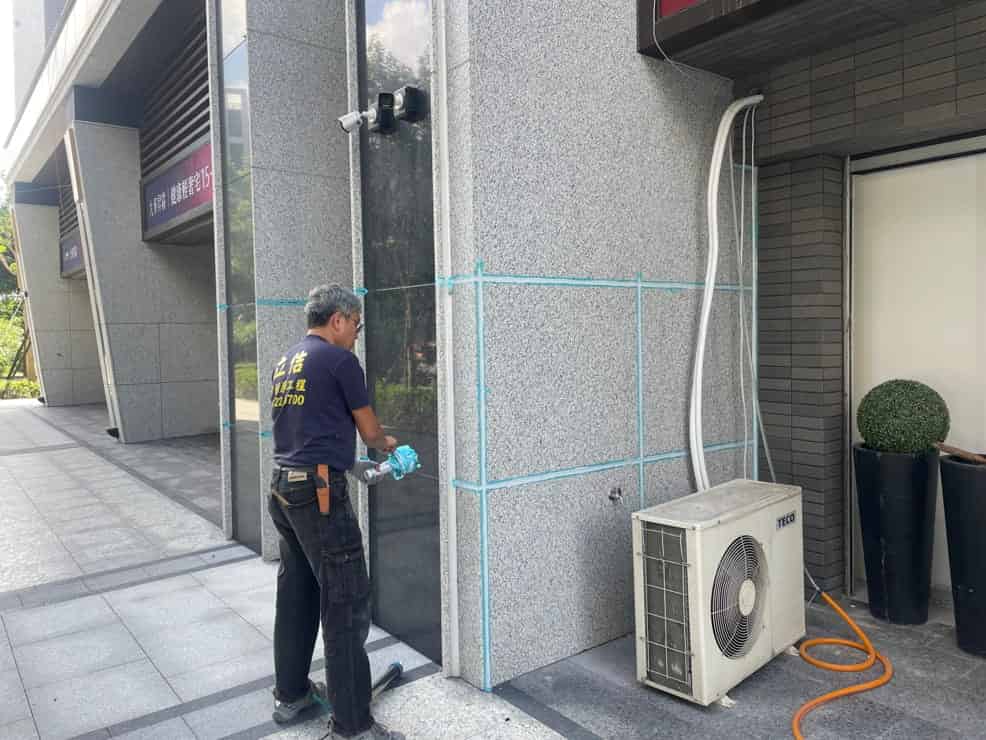

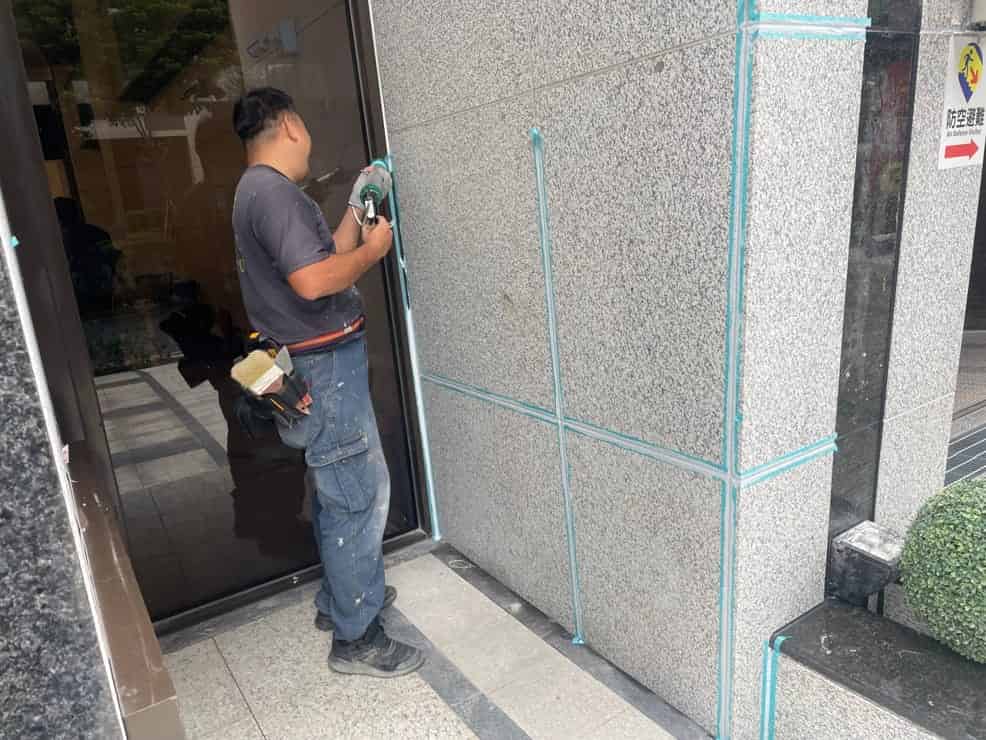

2024/10 Exterior wall stone silicone application
-
2024/10 Exterior wall stone silicone application
-
-
12
2024
-

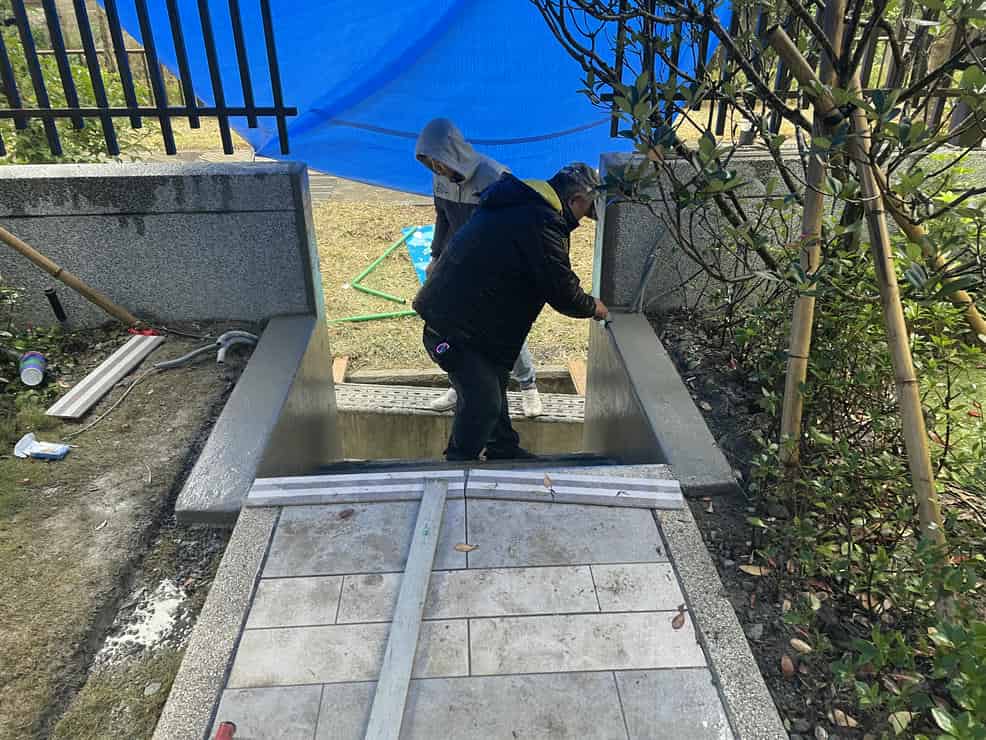

2024/12 The opening of the atrium is made of stone
-

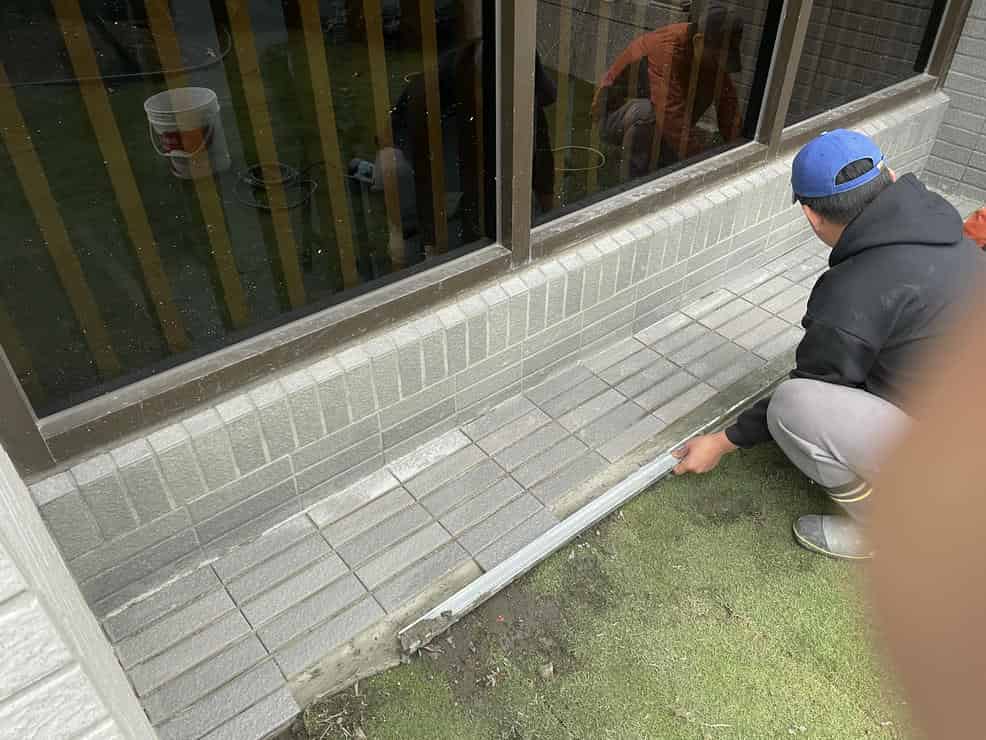

2024/12 Balcony tile installation
-

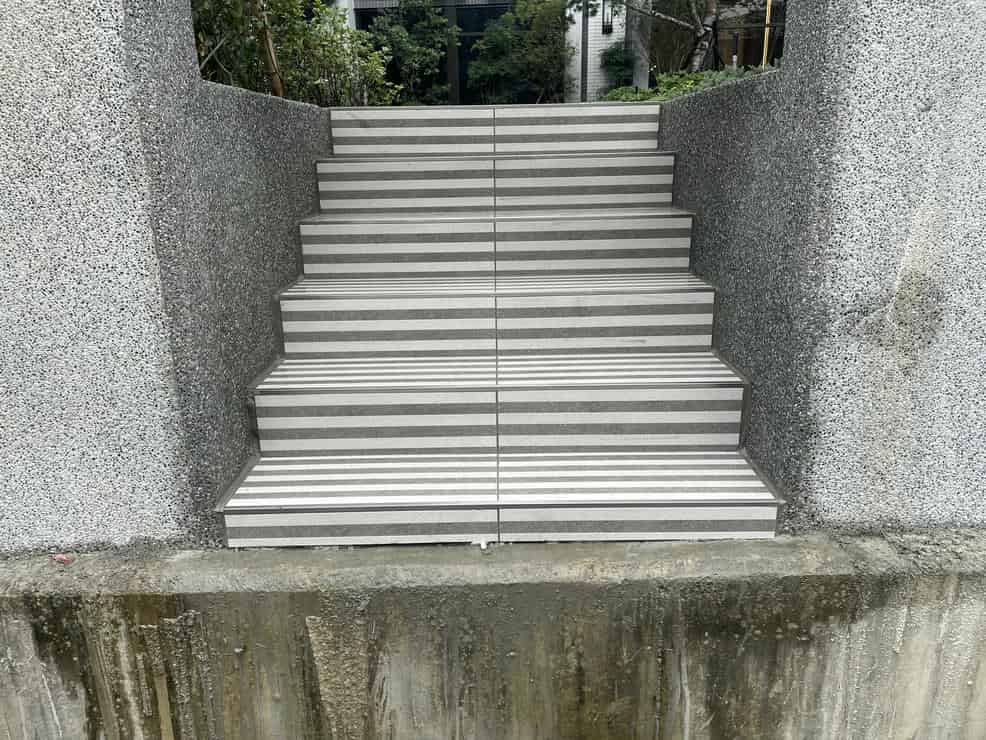

2024/12 Atrium opening floor tile installation
-

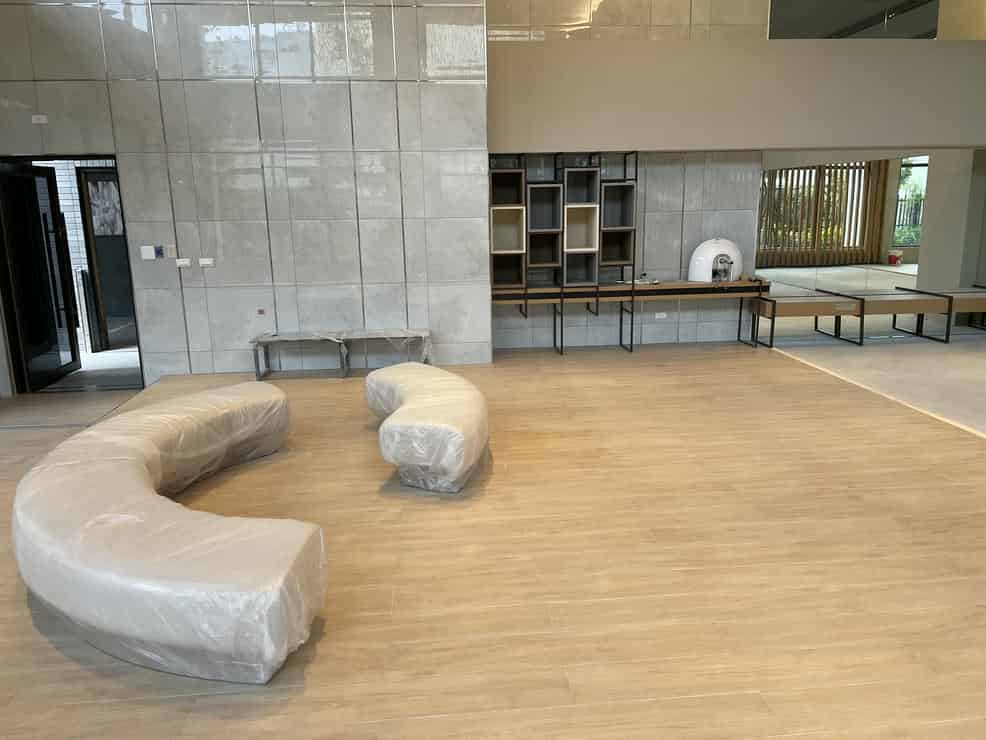

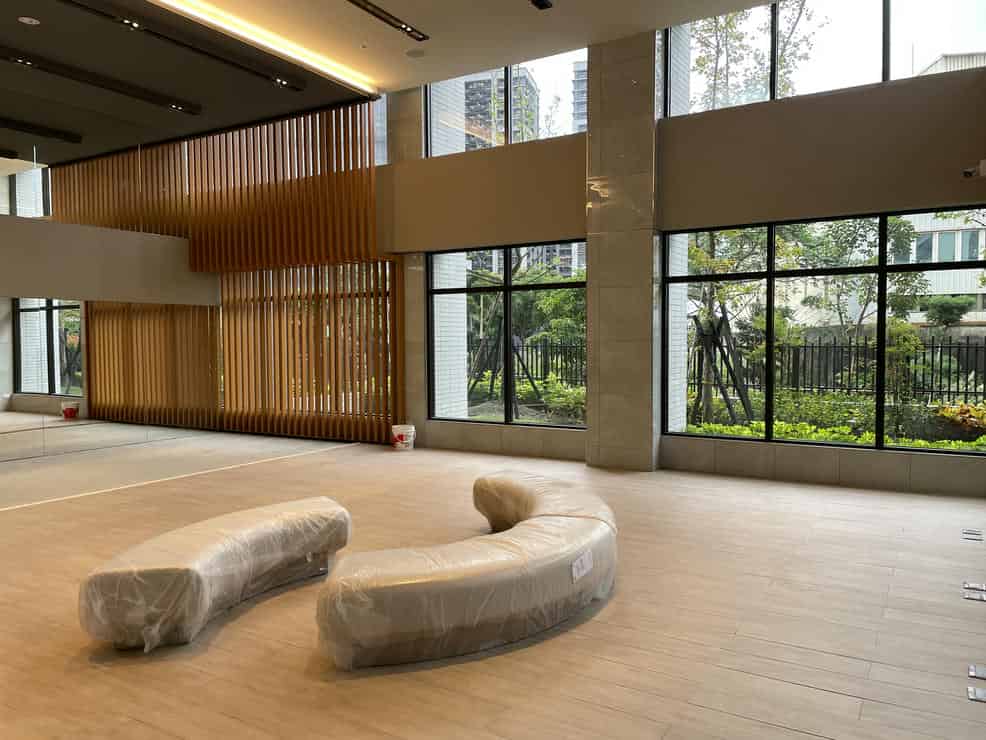

2024/12 Public gym furniture and furnishings
-
2024/12 Public gym furniture and furnishings
-
2024/12 Public gym furniture and furnishings
-
2024/12 Public gym furniture and furnishings
-

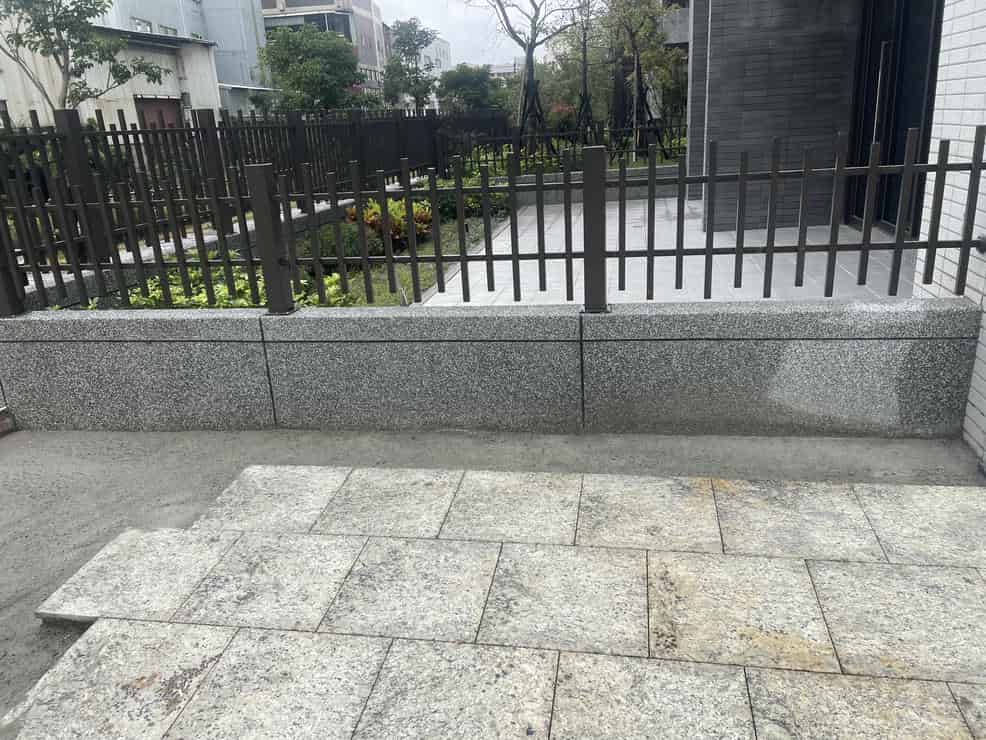

2024/12 Landscape floor primer construction
-

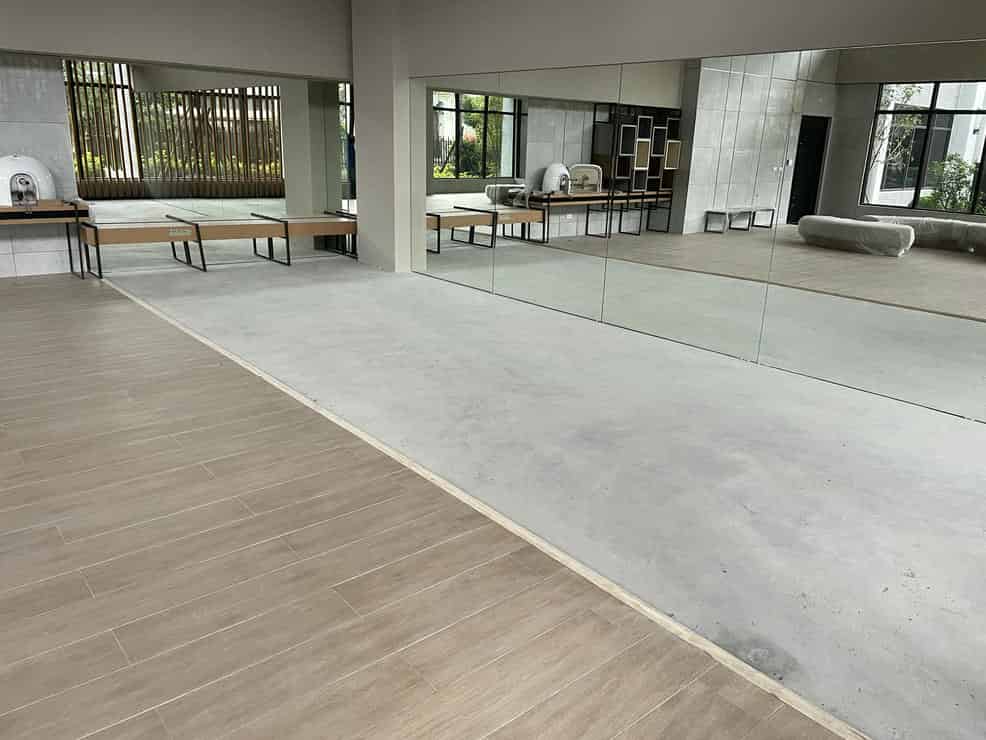

2024/12 Cleaning work in public gymnasium
-

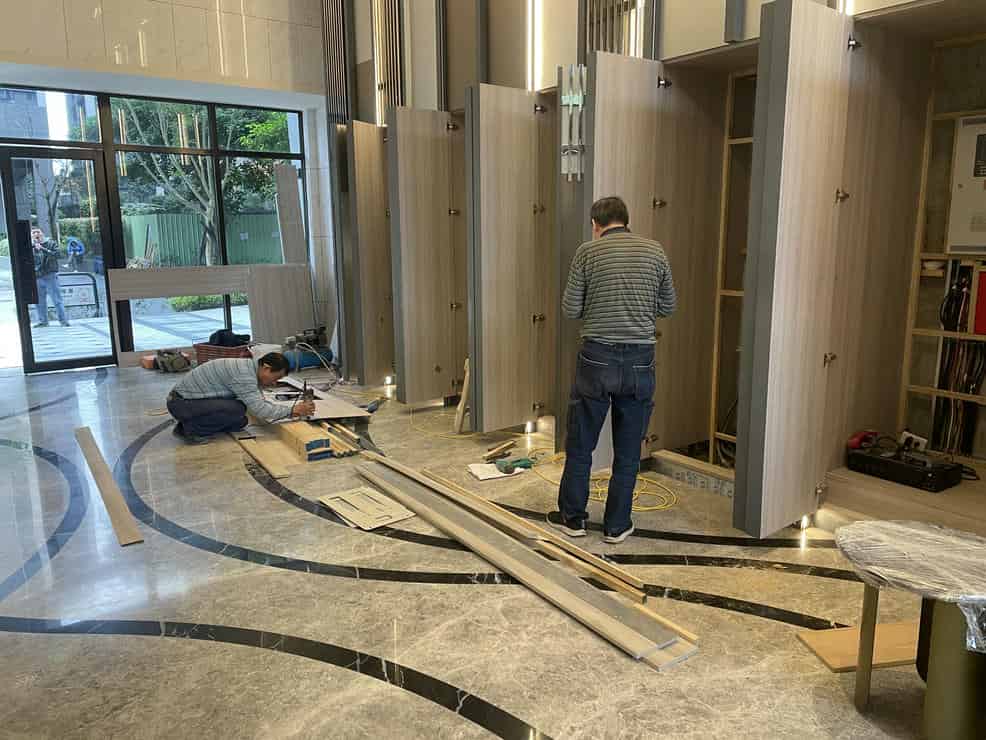

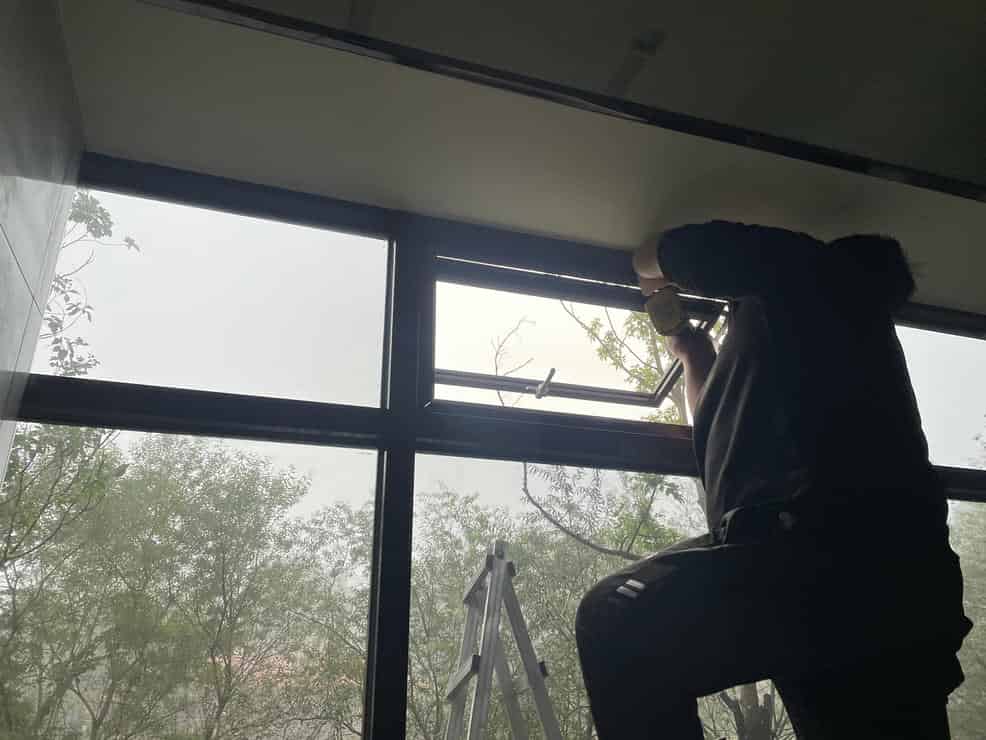

2024/12 Modification of iron fixed windows in public facilities
-

2024/12 Cabinet laminate construction in public hall
-

2024/12 Public bar iron fittings
-

2024/12 Public bar iron fittings
-

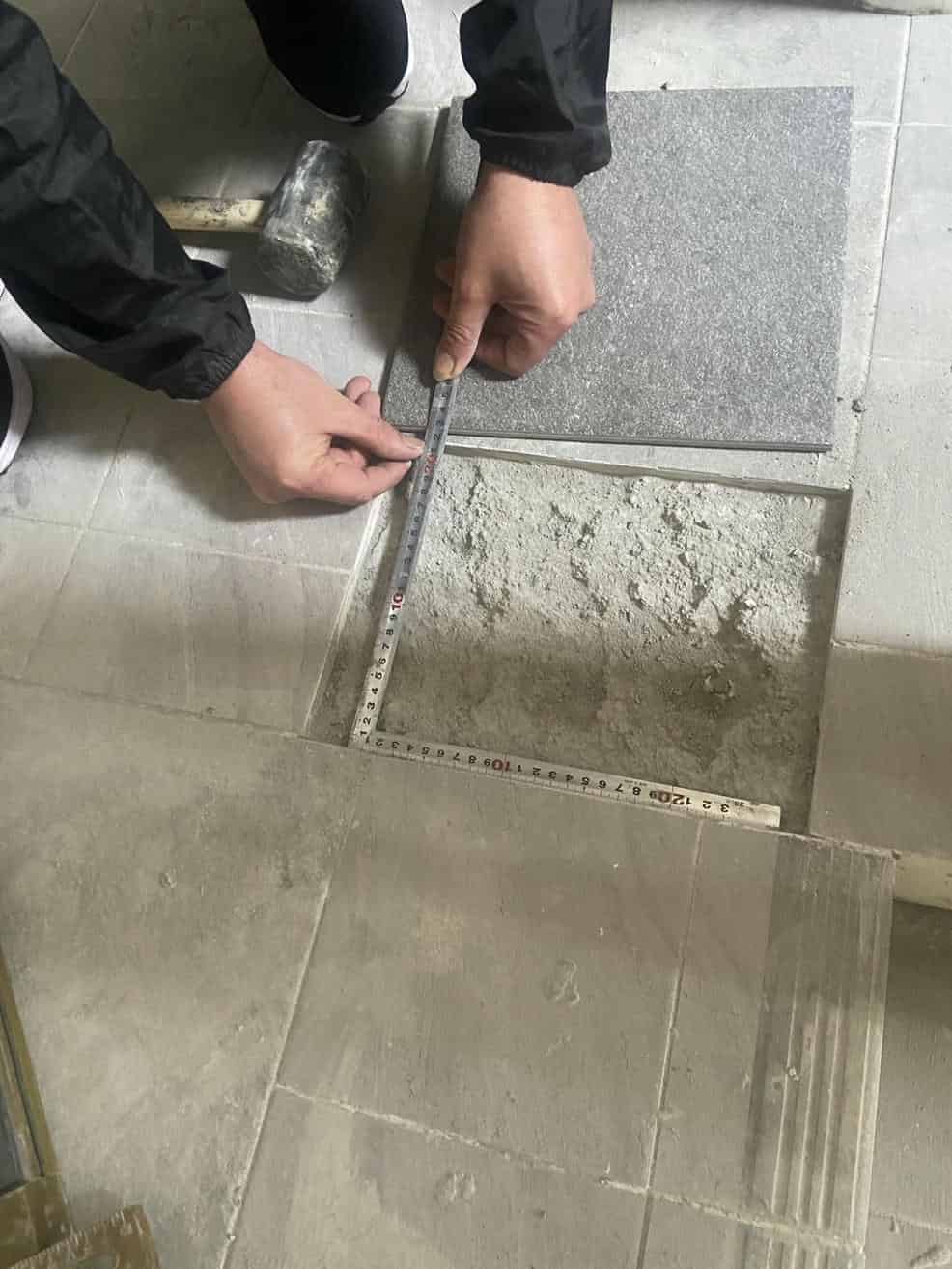

2024/12 Public bar iron fittings
-

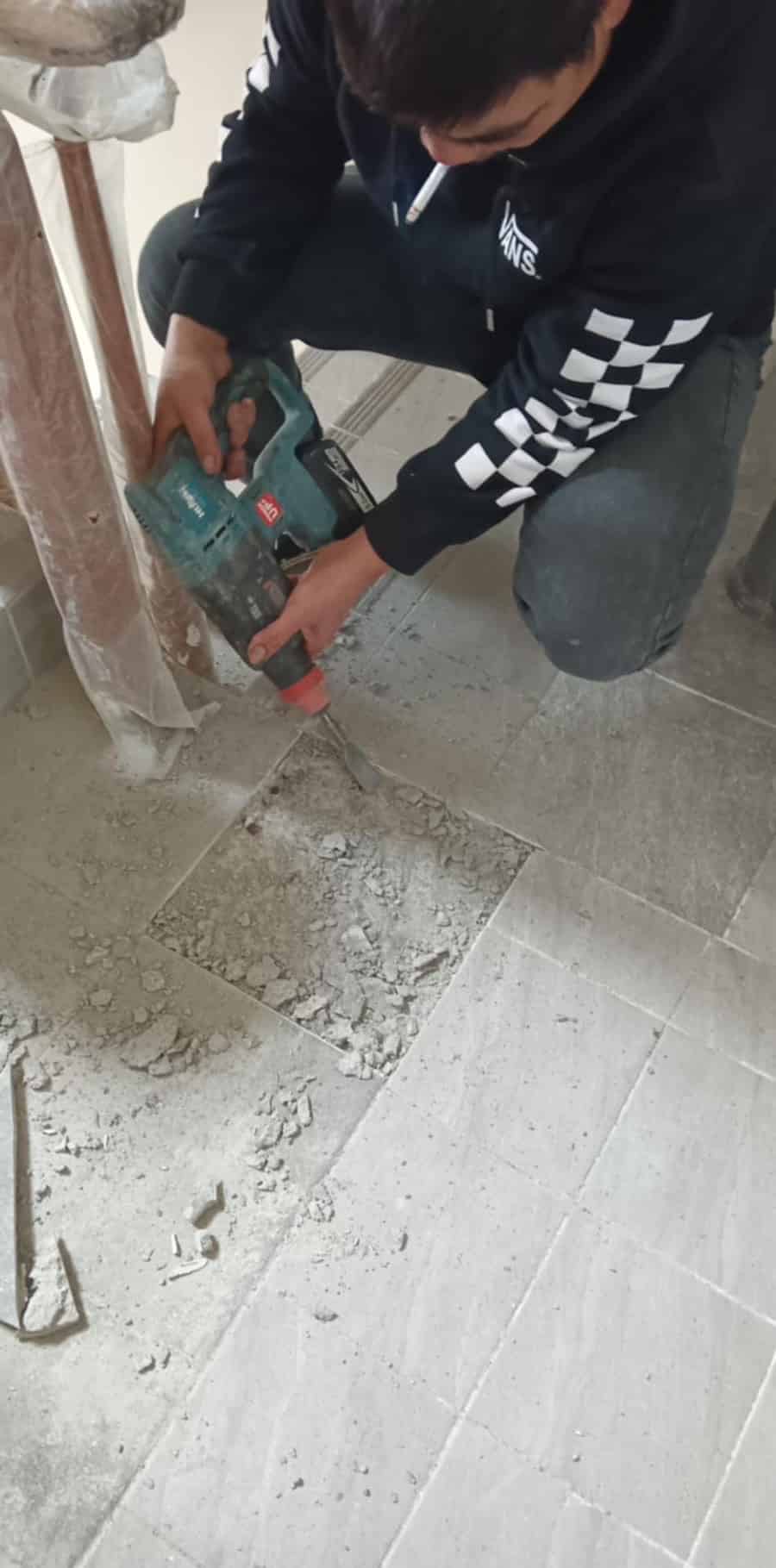

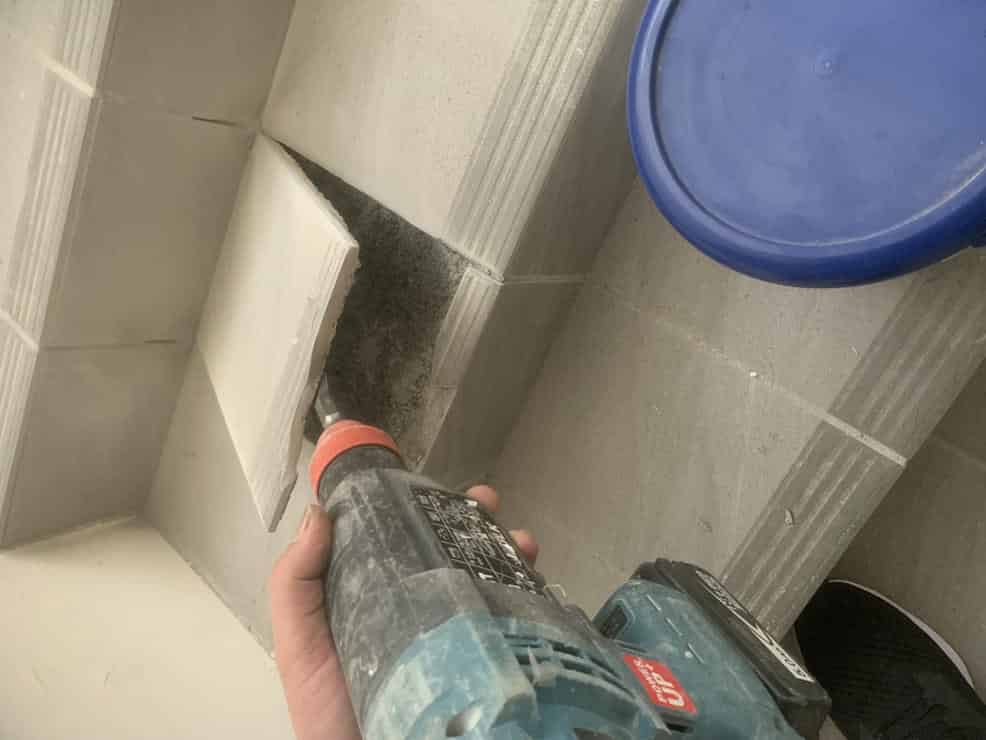

2024/12 Stair brick repair work
-
2024/12 Stair brick repair work
-
2024/12 Stair brick repair work
-

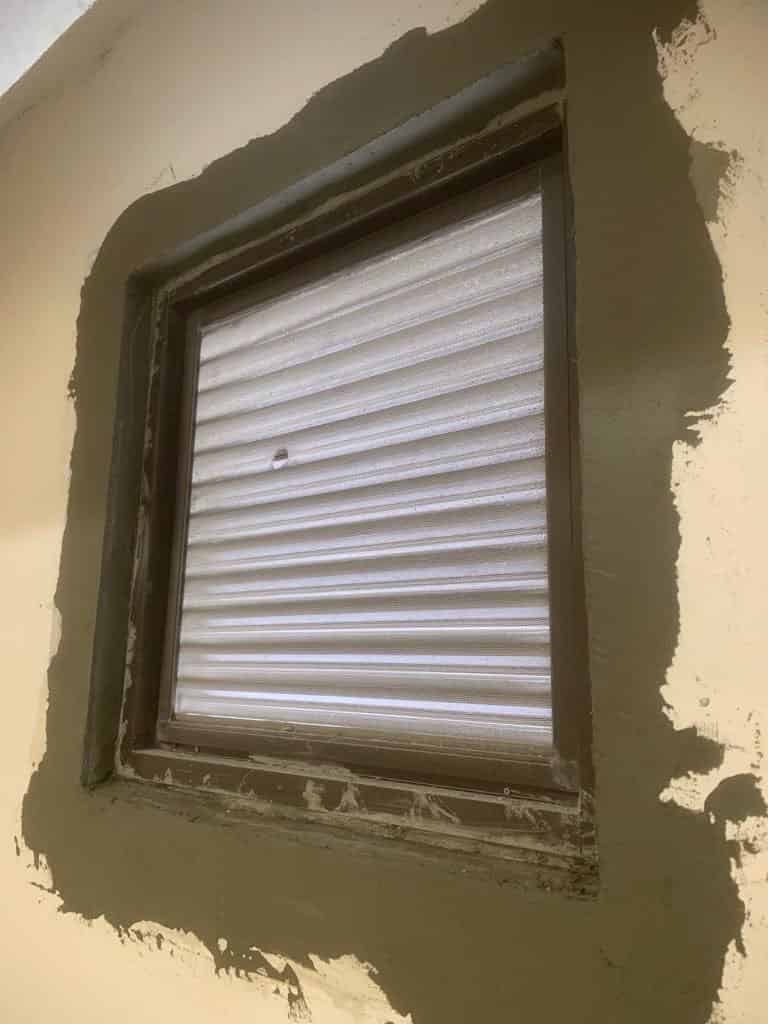

2024/12 Stair plaster repair
-
2024/12 Stair plaster repair
-
2024/12 Stair brick repair
-

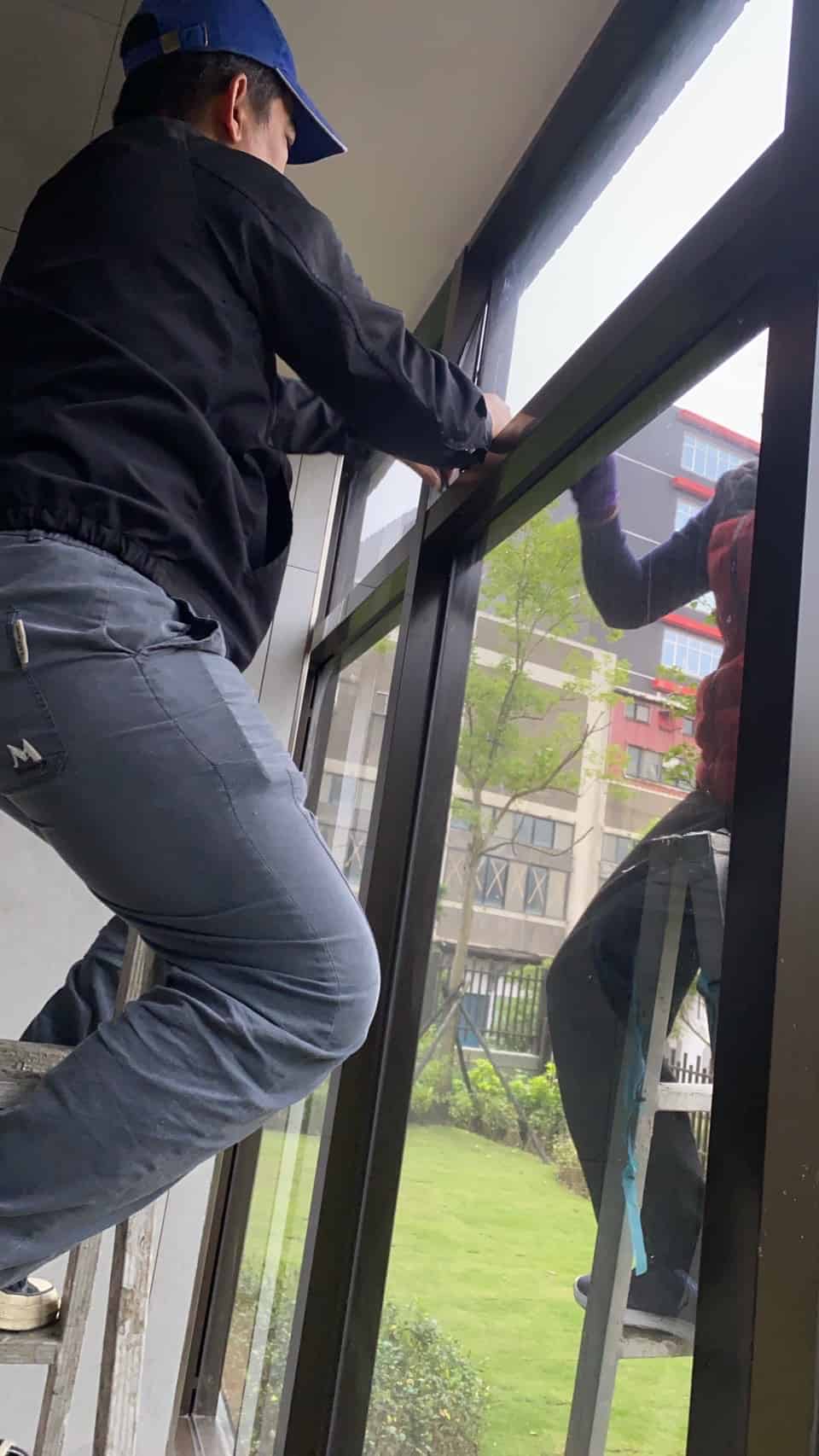

2024/12 Public fixed window cleaning work
-
